WEST BENGAL REAL ESTATE REGULATORY AUTHORITY

WBRERA

GRAND CASTLE PHASE - I

Project Status as on Quarter ending 31-03-2021
Updated as on 06-04-2021

Booking Status

  • Residential Apartments Booked
    148

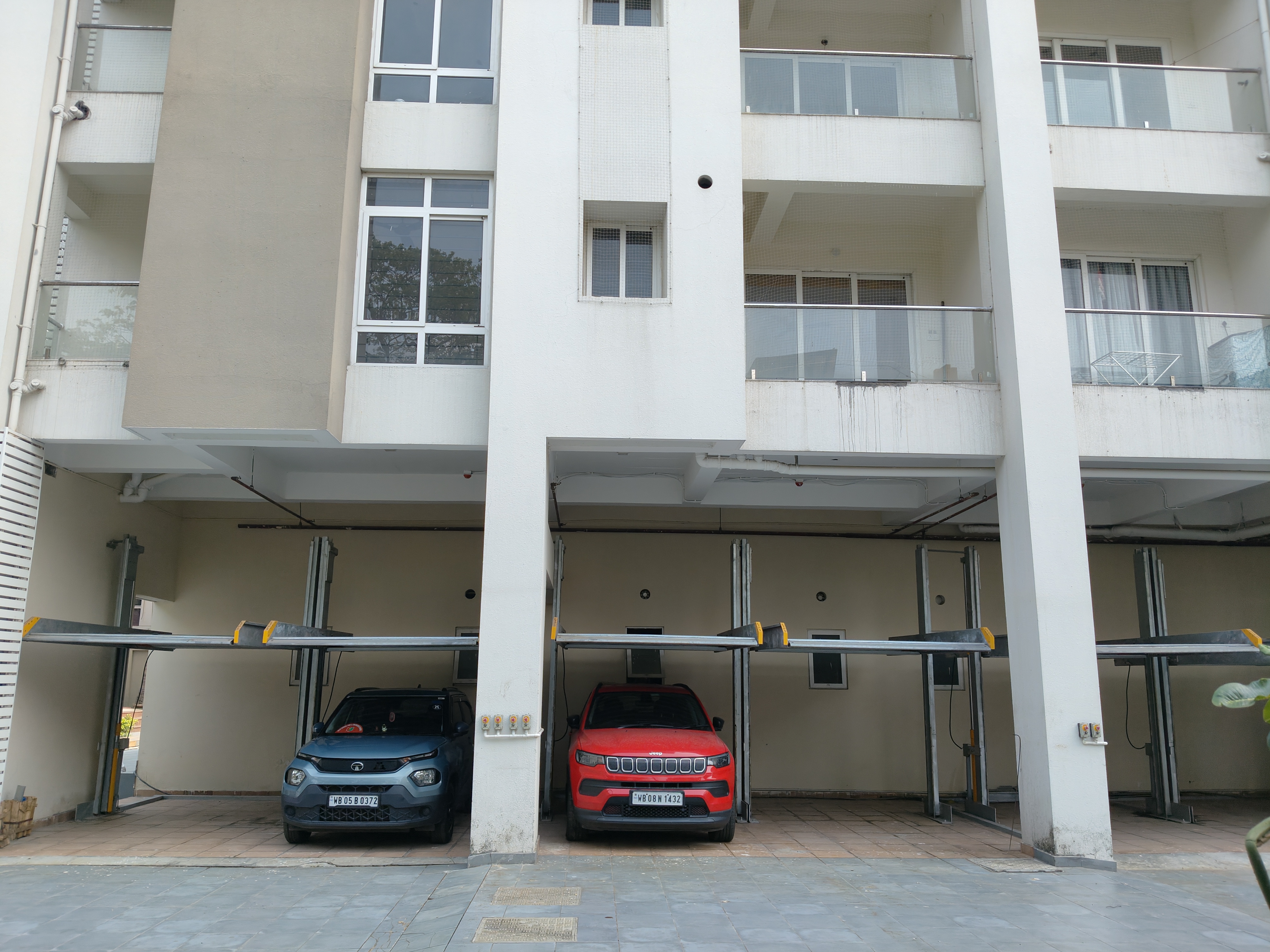

  • Basement Parking Booked
    Not mentioned

  • Covered Car Parking Booked
    73

  • Mechanical Parking Booked

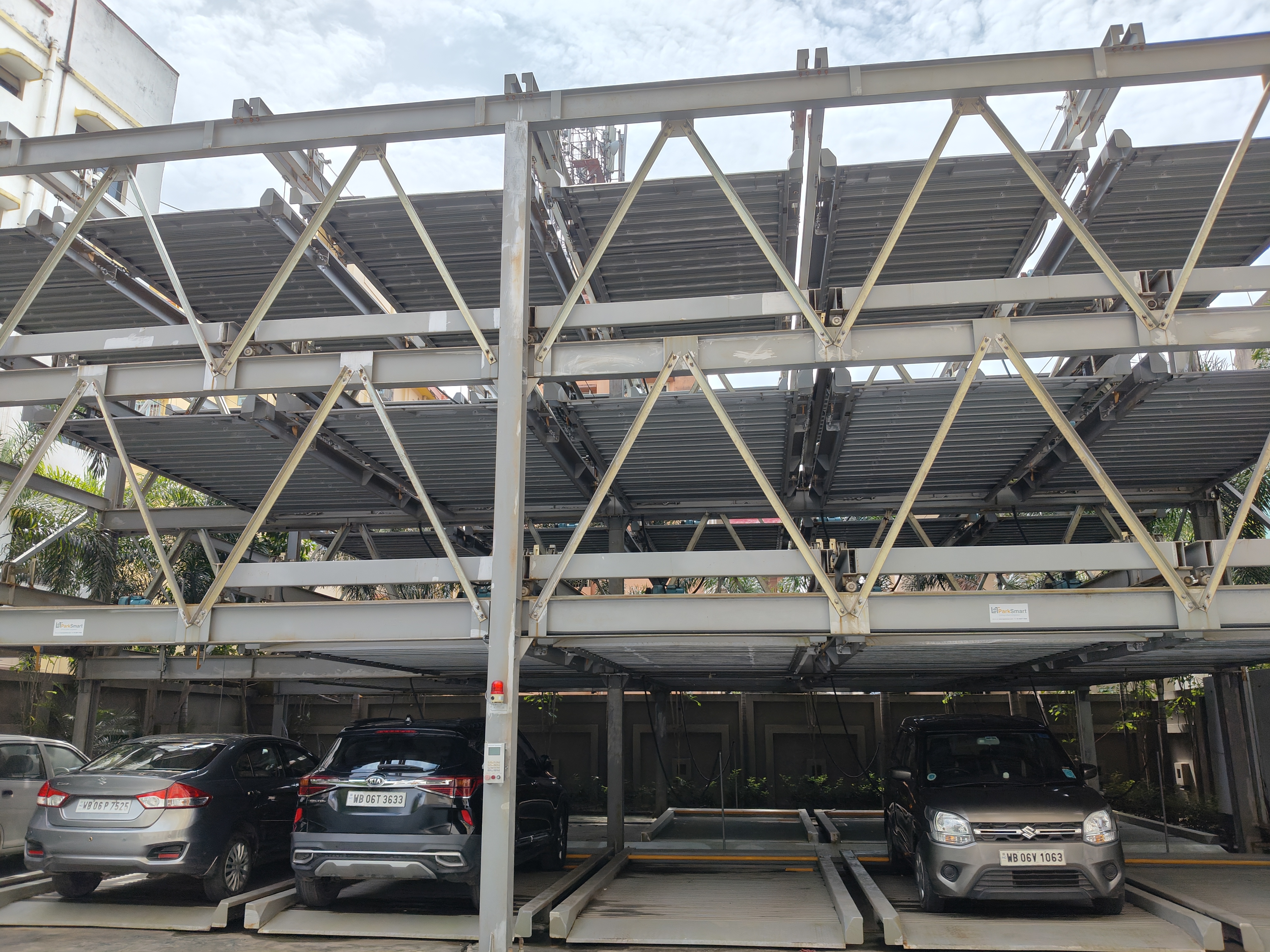

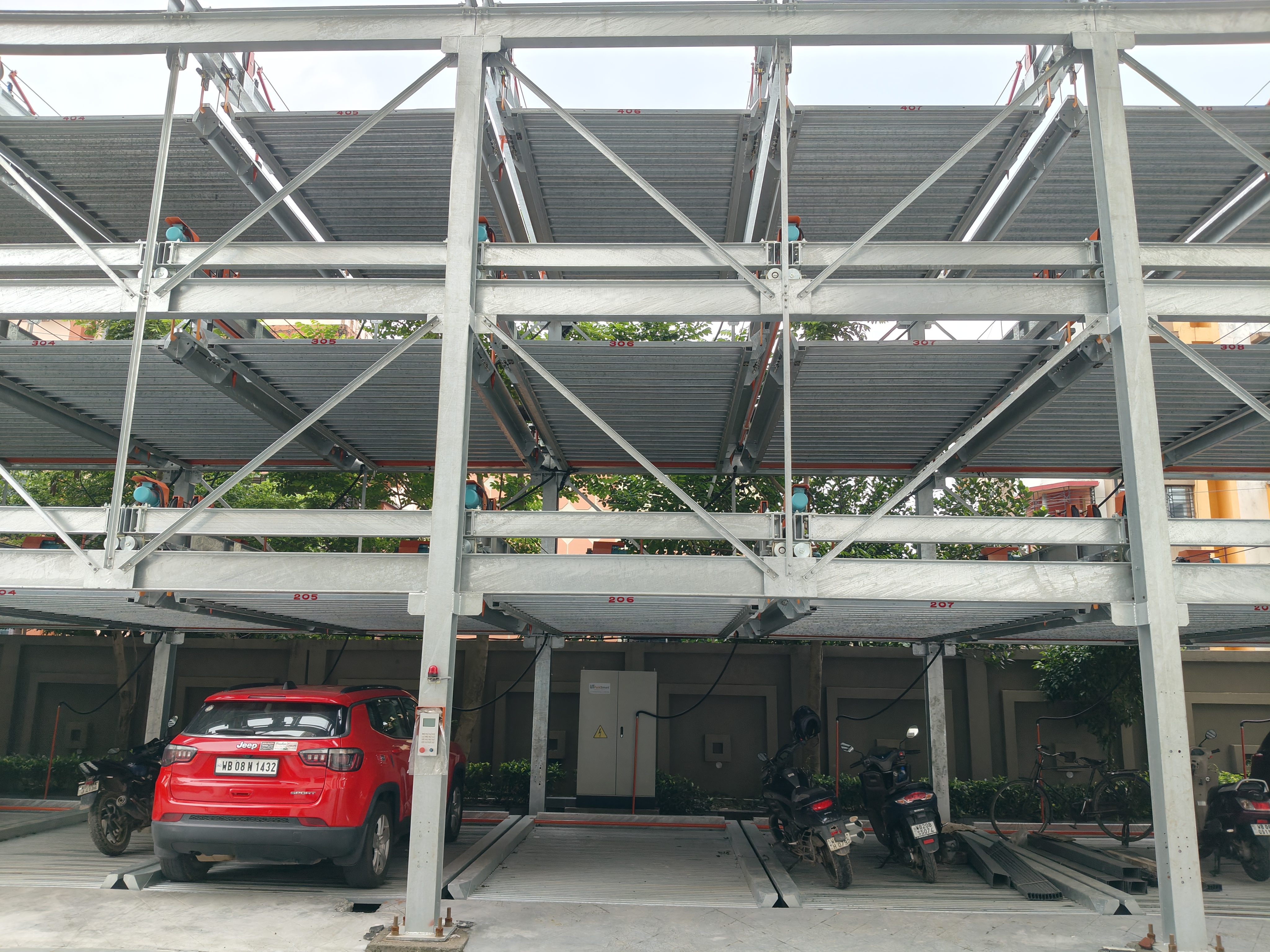

    33

Status of construction of each building/floor with photographs

Block/Building Floor Construction Status Download
BLOCK -1 1 Under Construction
BLOCK -1 2 Under Construction
BLOCK -1 3 Under Construction
BLOCK -1 4 Under Construction
BLOCK -1 5 Under Construction
BLOCK -1 6 Under Construction
BLOCK -1 7 Under Construction
BLOCK -1 8 Under Construction
BLOCK -1 9 Under Construction
BLOCK -1 10 Under Construction
BLOCK -2 1 Under Construction
BLOCK -2 2 Under Construction
BLOCK -2 3 Under Construction
BLOCK -2 4 Under Construction
BLOCK -2 5 Under Construction
BLOCK -2 6 Under Construction
BLOCK -2 7 Under Construction
BLOCK -2 8 Under Construction
BLOCK -2 9 Under Construction
BLOCK -2 10 Under Construction
BLOCK -2 11 Under Construction
BLOCK -2 12 Under Construction
BLOCK -2 13 Under Construction
BLOCK -2 14 Under Construction
BLOCK -2 15 Under Construction
BLOCK -2 16 Under Construction
BLOCK -3 1 Under Construction
BLOCK -3 2 Under Construction
BLOCK -3 3 Under Construction
BLOCK -3 4 Under Construction
BLOCK -3 5 Under Construction
BLOCK -3 6 Under Construction
BLOCK -3 7 Under Construction
BLOCK -3 8 Under Construction
BLOCK -3 9 Under Construction
BLOCK -3 10 Under Construction
BLOCK -3 11 Under Construction
BLOCK -3 12 Under Construction
BLOCK -3 13 Under Construction
BLOCK -3 14 Under Construction
BLOCK -3 15 Under Construction
BLOCK -3 16 Under Construction
BLOCK -4 1 Under Construction
BLOCK -4 2 Under Construction
BLOCK -4 3 Under Construction
BLOCK -4 4 Under Construction
BLOCK -4 5 Under Construction
BLOCK -4 6 Under Construction
BLOCK -4 7 Under Construction
BLOCK -4 8 Under Construction
BLOCK -4 9 Under Construction
BLOCK -4 10 Under Construction
BLOCK -1 1 Under Construction
BLOCK -1 2 Under Construction
BLOCK -1 3 Under Construction
BLOCK -1 4 Under Construction
BLOCK -1 5 Under Construction
BLOCK -1 6 Under Construction
BLOCK -1 7 Under Construction
BLOCK -1 8 Under Construction
BLOCK -1 9 Under Construction
BLOCK -1 1 Under Construction
BLOCK -2 1 Under Construction
BLOCK -2 2 Under Construction
BLOCK -2 3 Under Construction
BLOCK -2 4 Under Construction
BLOCK -2 5 Under Construction
BLOCK -2 6 Under Construction
BLOCK -2 7 Under Construction
BLOCK -2 8 Under Construction
BLOCK -2 9 Under Construction
BLOCK -2 10 Under Construction
BLOCK -2 11 Under Construction
BLOCK -2 12 Under Construction
BLOCK -2 13 Under Construction
BLOCK -2 14 Under Construction
BLOCK -2 15 Under Construction
BLOCK -2 16 Under Construction
BLOCK -3 1 Under Construction
BLOCK -3 2 Under Construction
BLOCK -3 3 Under Construction
BLOCK -3 4 Under Construction
BLOCK -3 5 Under Construction
BLOCK -3 6 Under Construction
BLOCK -3 7 Under Construction
BLOCK -3 8 Under Construction
BLOCK -3 9 Under Construction
BLOCK -3 10 Under Construction
BLOCK -3 11 Under Construction
BLOCK -3 12 Under Construction
BLOCK -3 14 Under Construction
BLOCK -3 15 Under Construction
BLOCK -3 16 Under Construction
BLOCK -4 1 Under Construction
BLOCK -4 2 Under Construction
BLOCK -4 3 Under Construction
BLOCK -4 4 Under Construction
BLOCK -4 5 Under Construction
BLOCK -4 6 Under Construction
BLOCK -4 7 Under Construction
BLOCK -4 8 Under Construction
BLOCK -4 9 Under Construction
BLOCK -4 10 Under Construction
BLOCK -1 1 Under Construction
BLOCK -1 2 Under Construction
BLOCK -1 3 Under Construction
BLOCK -1 4 Under Construction
BLOCK -1 5 Under Construction
BLOCK -1 6 Under Construction
BLOCK -1 7 Under Construction
BLOCK -1 8 Under Construction
BLOCK -1 9 Under Construction
BLOCK -1 10 Under Construction
BLOCK -2 1 Under Construction
BLOCK -2 2 Under Construction
BLOCK -2 3 Under Construction
BLOCK -2 4 Under Construction
BLOCK -2 5 Under Construction
BLOCK -2 6 Under Construction
BLOCK -2 7 Under Construction
BLOCK -2 8 Under Construction
BLOCK -2 9 Under Construction
BLOCK -2 10 Under Construction
BLOCK -2 11 Under Construction
BLOCK -2 12 Under Construction
BLOCK -2 13 Under Construction
BLOCK -2 14 Not Started
BLOCK -2 15 Not Started
BLOCK -2 16 Not Started
BLOCK -3 1 Under Construction
BLOCK -3 2 Under Construction
BLOCK -3 3 Under Construction
BLOCK -3 4 Under Construction
BLOCK -3 5 Under Construction
BLOCK -3 6 Under Construction
BLOCK -3 7 Under Construction
BLOCK -3 8 Under Construction
BLOCK -3 9 Under Construction
BLOCK -3 10 Under Construction
BLOCK -3 11 Under Construction
BLOCK -3 12 Under Construction
BLOCK -3 13 Under Construction
BLOCK -3 14 Under Construction
BLOCK -3 15 Not Started
BLOCK -3 16 Not Started
BLOCK -4 1 Under Construction
BLOCK -4 2 Under Construction
BLOCK -4 3 Under Construction
BLOCK -4 4 Under Construction
BLOCK -4 5 Not Started
BLOCK -4 6 Not Started
BLOCK -4 7 Not Started
BLOCK -4 8 Not Started
BLOCK -4 9 Not Started
BLOCK -4 10 Not Started

Status of Construction of Internal Infrastructure with photographs

Sl No. Title Download

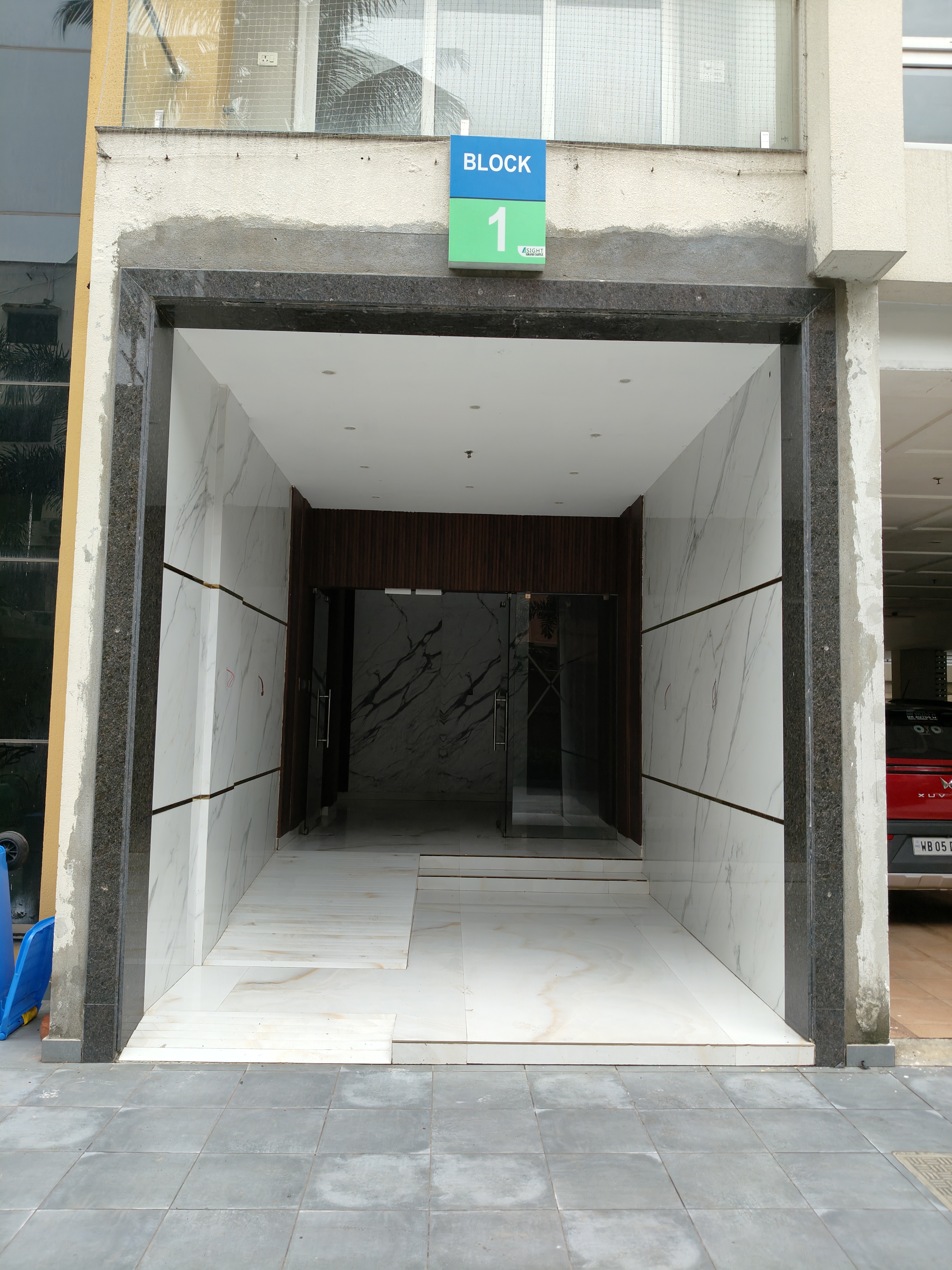

1 BLOCK -I, ALL STRUCTURE COMPLETED UPTO ABOVE ROOF , UGF TO 9TH FLOOR INTERNAL PLASTER COMPLETED, UGF TO 7TH FLOOR INTERNAL PUTTY COMPLETED.

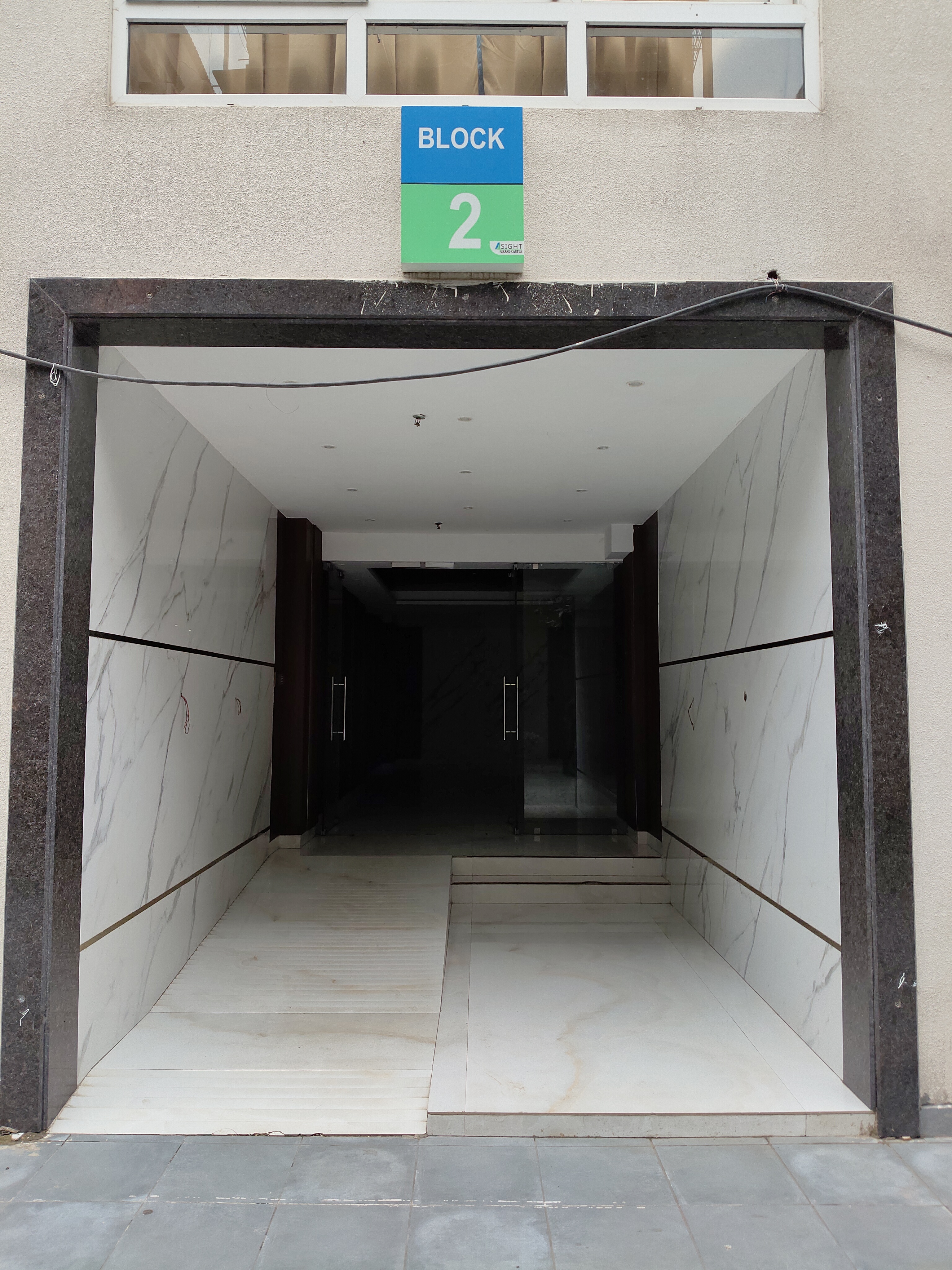

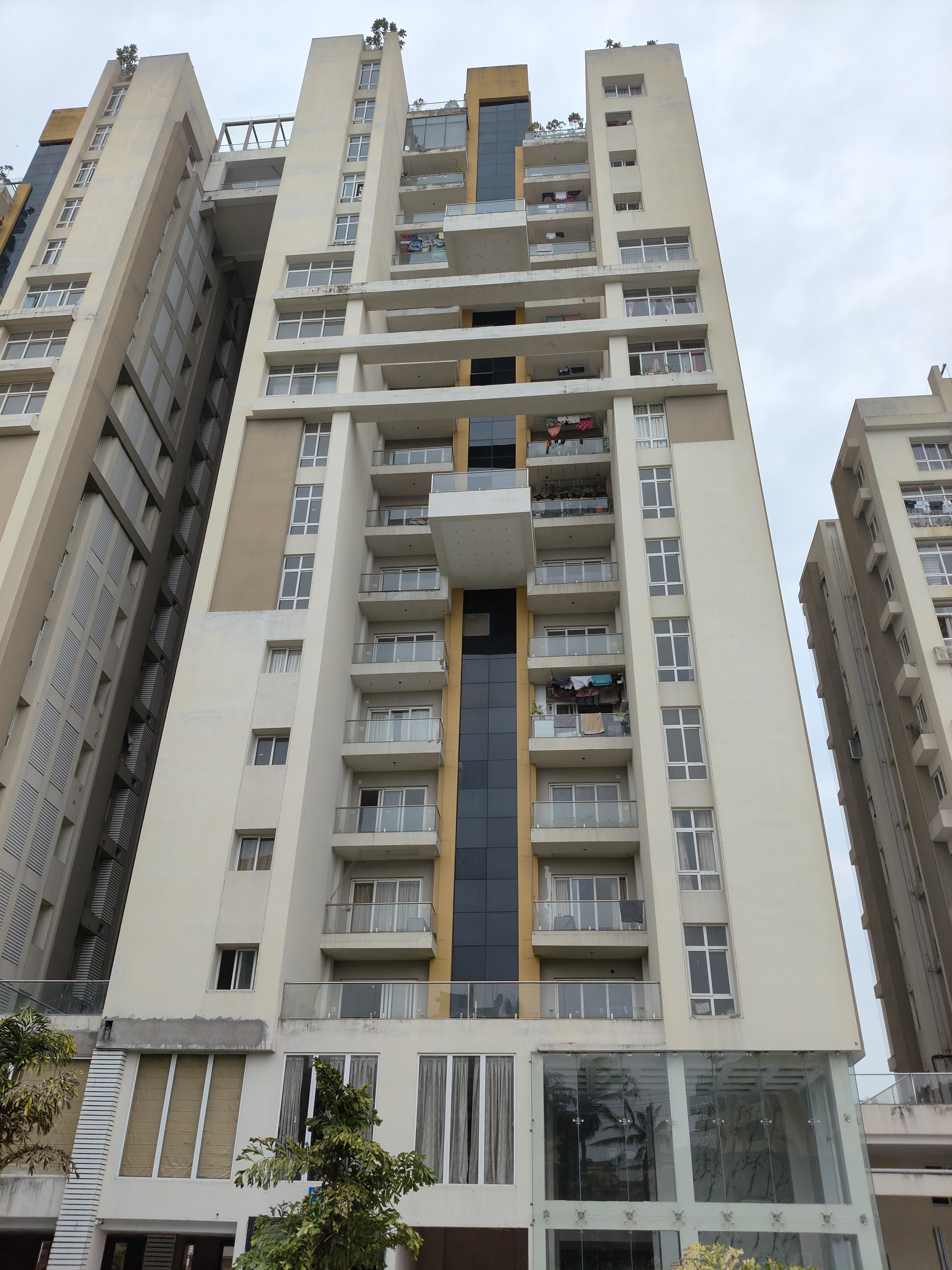

2 BLOCK -II, ALL STRUCTURE COMPLETED UPTO ABOVE ROOF , 1ST TO 15TH FLOOR AAC BLOCK WORK COMPLETED, 1ST TO 8TH FLOOR INTERNAL PLASTER WORK COMPLETED.

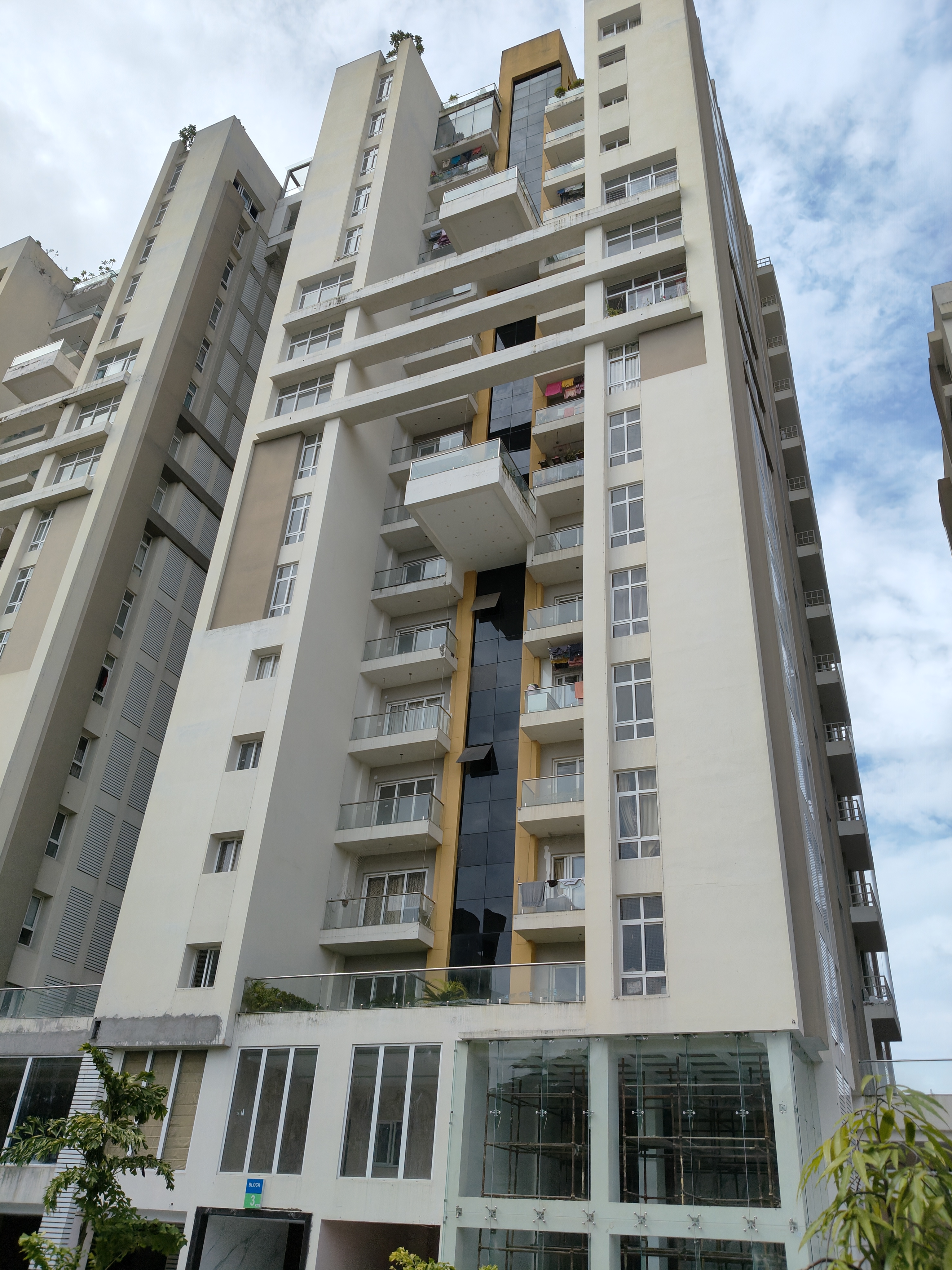

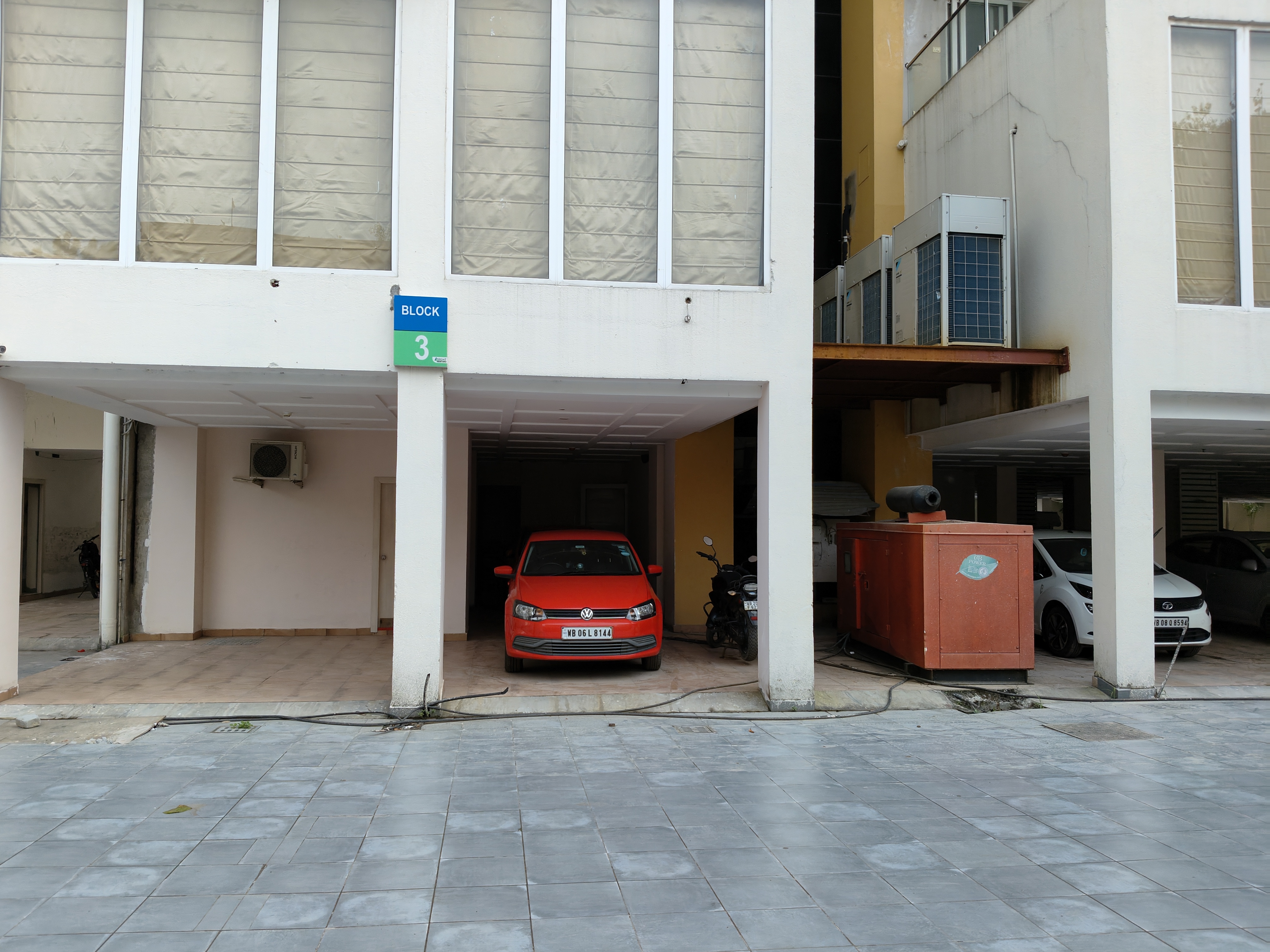

3 BLOCK-III, ALL STRUCTURE COMPLETED UP TO ABOVE ROOF, 1ST TO 15TH FLOOR AAC BLOCK WORK COMPLETED, 1ST TO 15TH INTERNAL PLASTER WORK COMPLETED, 70% OF 4 SIDES EXTERNAL PLASTER WORK COMPLETED

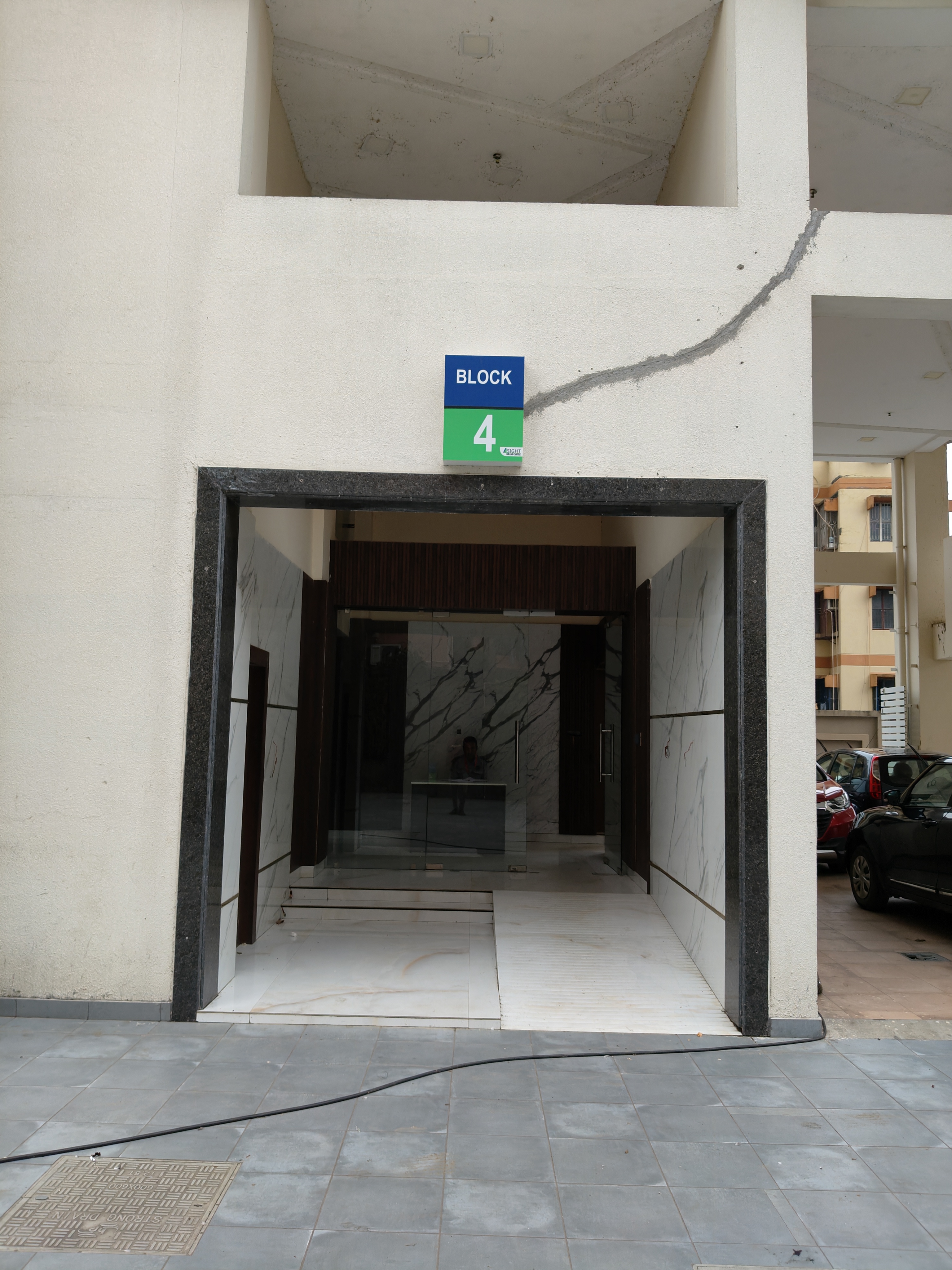

4 BLOCK - IV , UPTO 9TH FLOOR STRUCTURE COMPLETED , UGF TO 3RD FLOOR AAC BLOCK WORK COMPLETED
5 Block - 1, up to above roof - All Structure completed except overhead water tank wall & Top Slab
6 Block- 2, Up to above Roof - All Structures completed except Overhead water tank wall & Top Slab
7 Block-3, Up to above roof - All Structures completed except overhead water tank wall & top slab
8 Block-4, Up to 7th floor - Structure completed
9 BLOCK - I , AAC BLOCK WORK ( UGF TO 9TH FLOOR COMPLETED )
10 BLOCK - I , INTERNAL PLASTER ( UGF TO 3RD FLOOR COMPLETED )

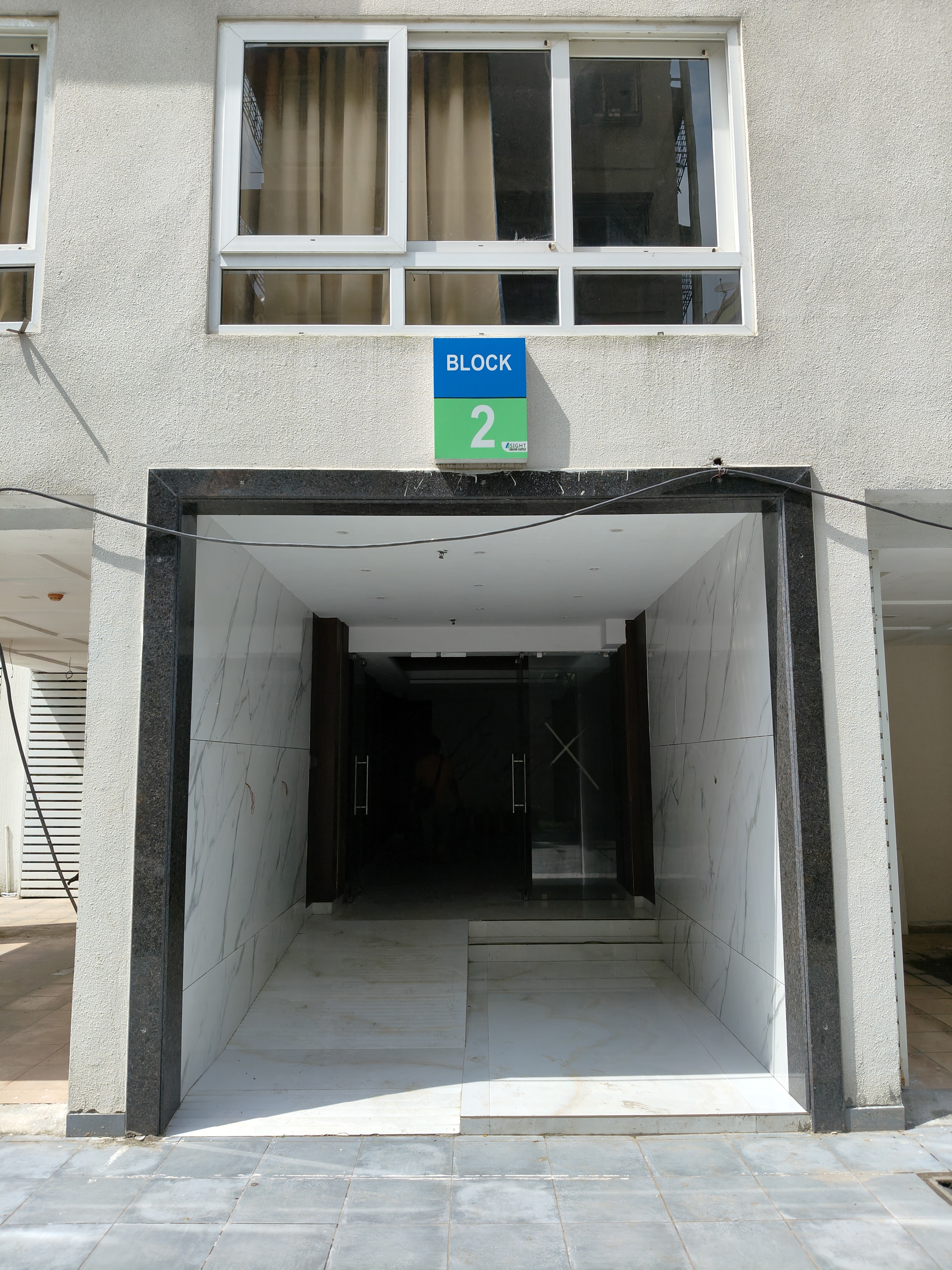

11 BLOCK - II , AAC BLOCK WORK ( 1ST TO 8TH FLOOR COMPLETED )
12 BLOCK II , INTERNAL PLASTER
13 BLOCK -III , AAC BLOCK WORK ( 1ST TO 13TH FLOOR COMPLETED )
14 BLOCK - III , INTERNAL PLASTER ( 1ST & 4TH FLOOR COMPLETED )
15 BLOCK - IV , AAC BLOCK WORK ( UGF TO 1ST FLOOR COMPLETED )
16 BLOCK - IV , INTERNAL PLASTER

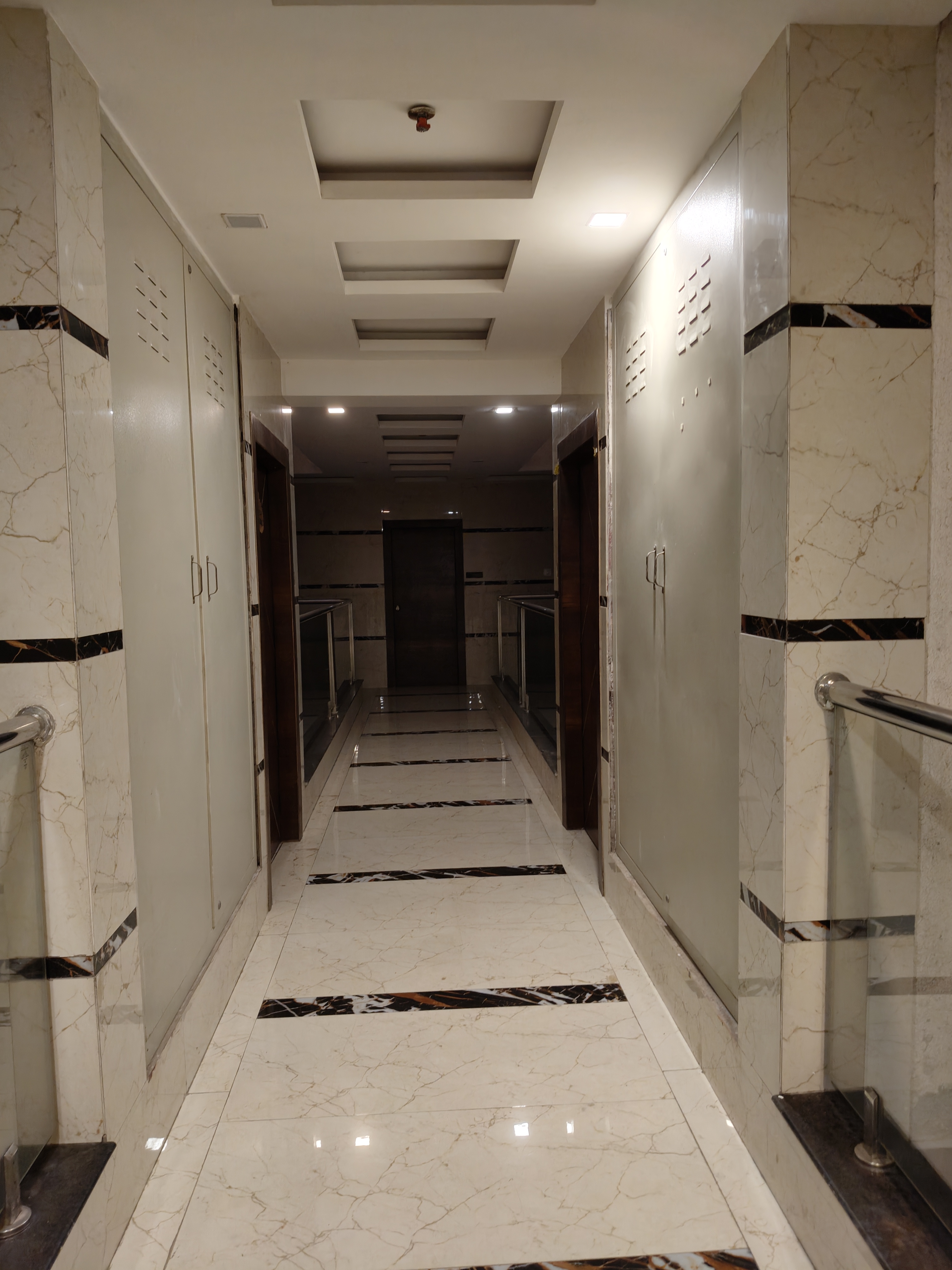

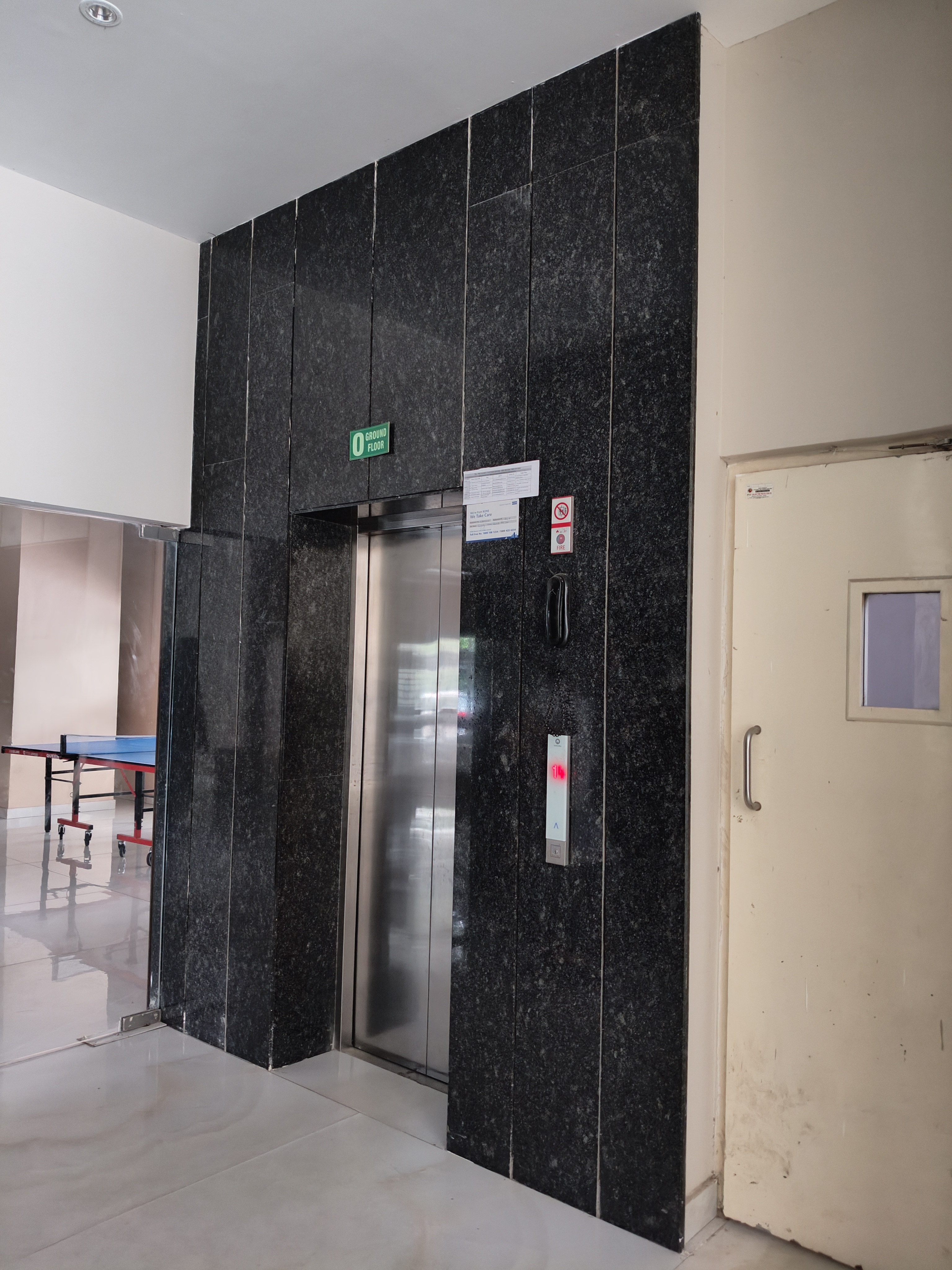

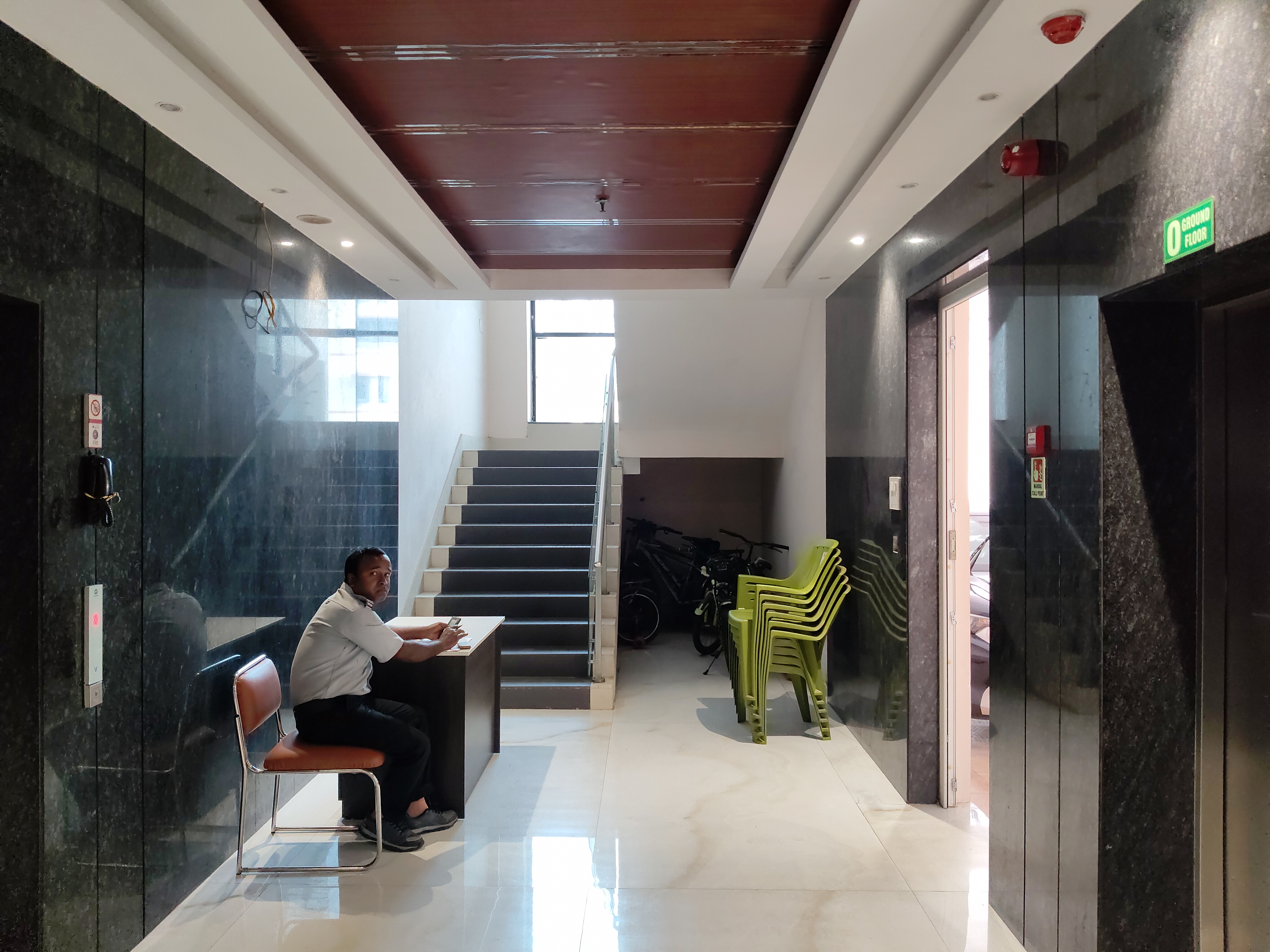

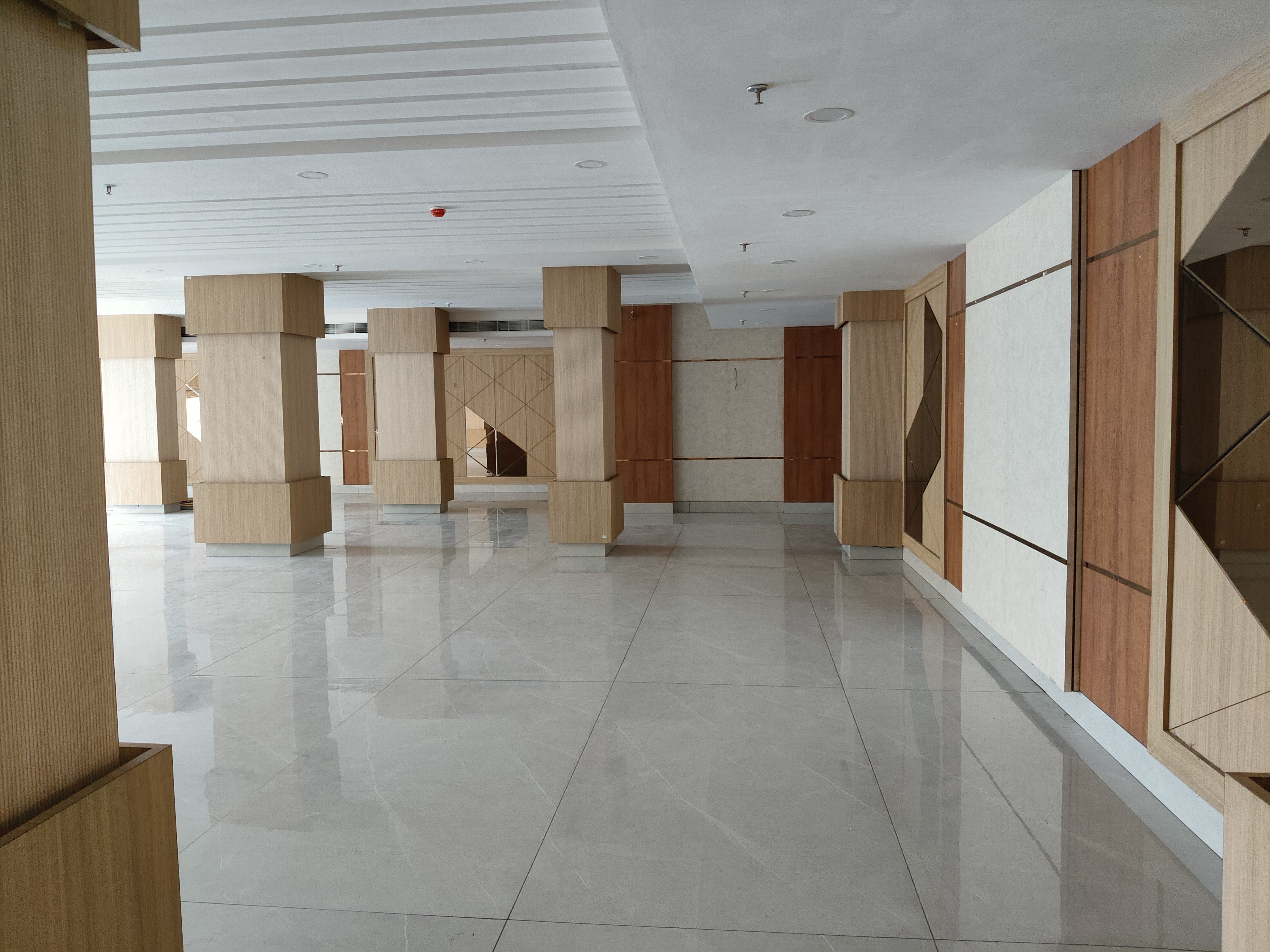

Status of Construction of Common Areas with photographs

Sl No. Construction Status Description Download
1 Under Construction STP RAFT COMPLETED, WALL IS UNDER CONSTRUCTION , RAIN WATER HARVESTING TANK - RAFT COMPLETED, WALL IS UNDER CONSTRUCTION
2 Under Construction Block- 1, Brick work - UGF to Roof , Internal Plaster - UGF to 9th Floor Completed, Internal Putty - UGF & 7th Floor Complted, External Plaster - 90% of 4 sides Completed
3 Under Construction Block -2, Brick work - 1st to 15th floor completed, Internal Plaster - 1st to 3rd floor completed
4 Under Construction Block - 3, Brick work - 1st to 15th floor completed, Internal Plaster - 1st 14th floor completed, External Plaster - 50% of 4 sides completed
5 Under Construction Block - 4, Brick work - UGF to 3rd floor Completed

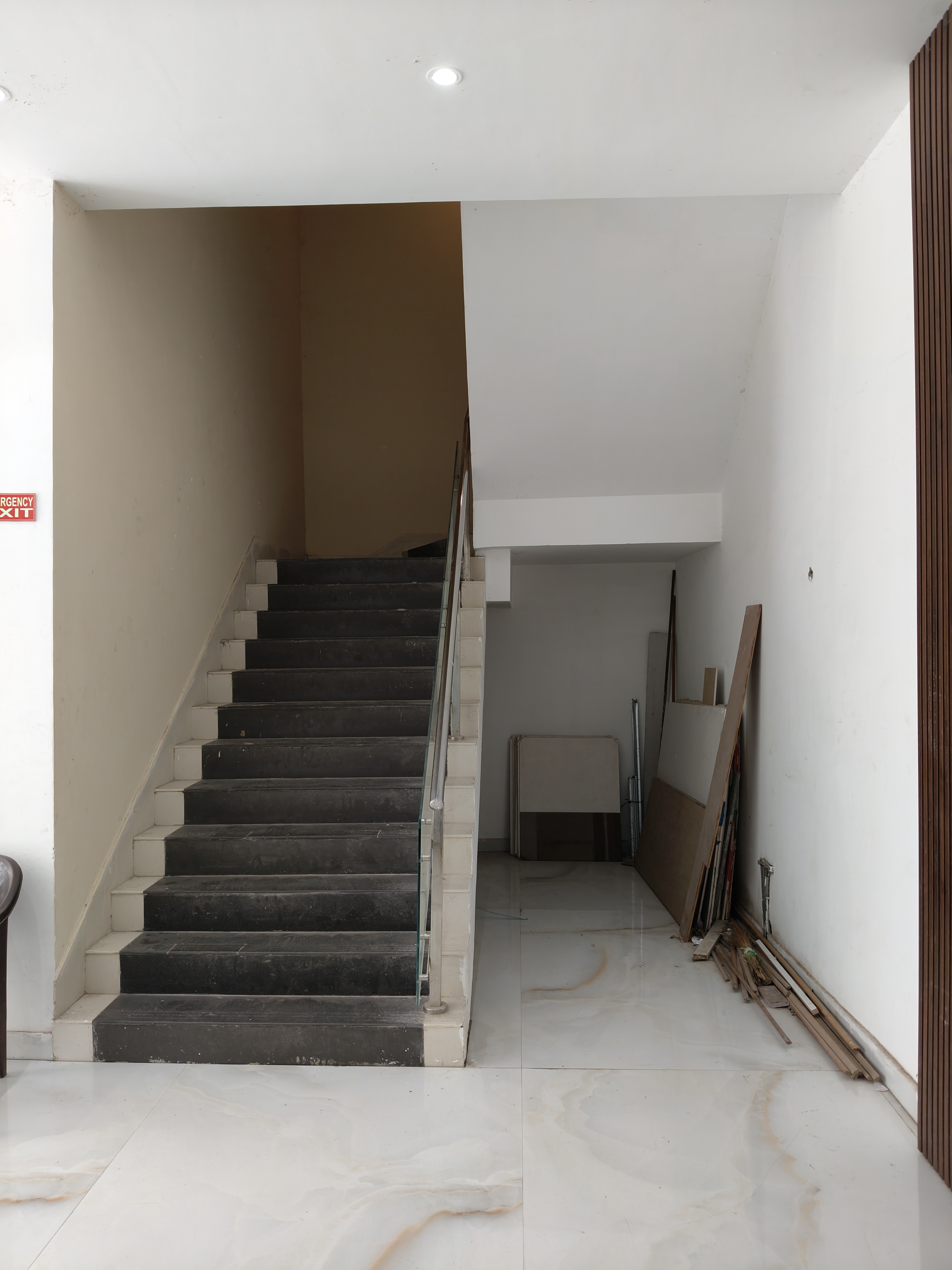

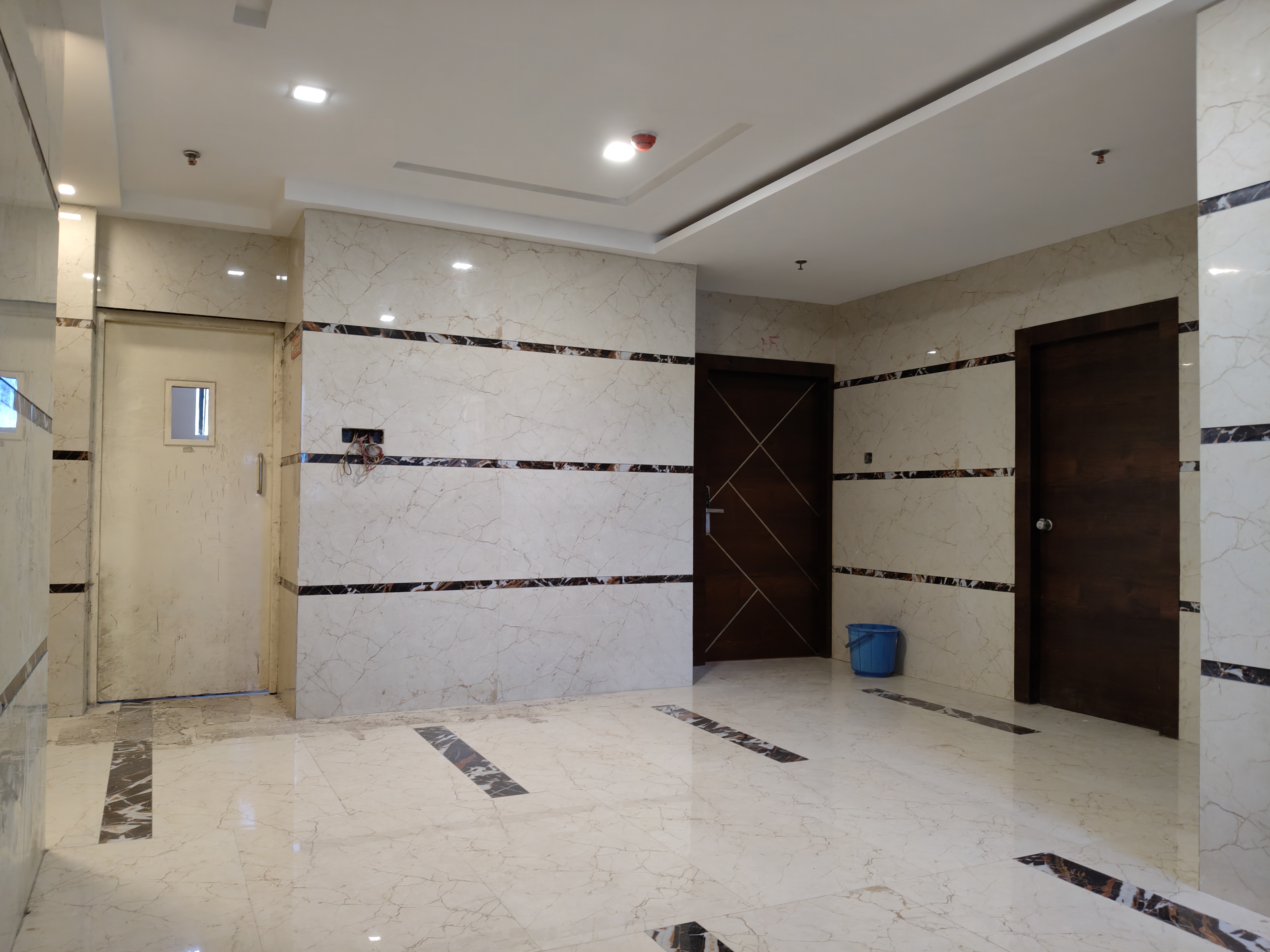

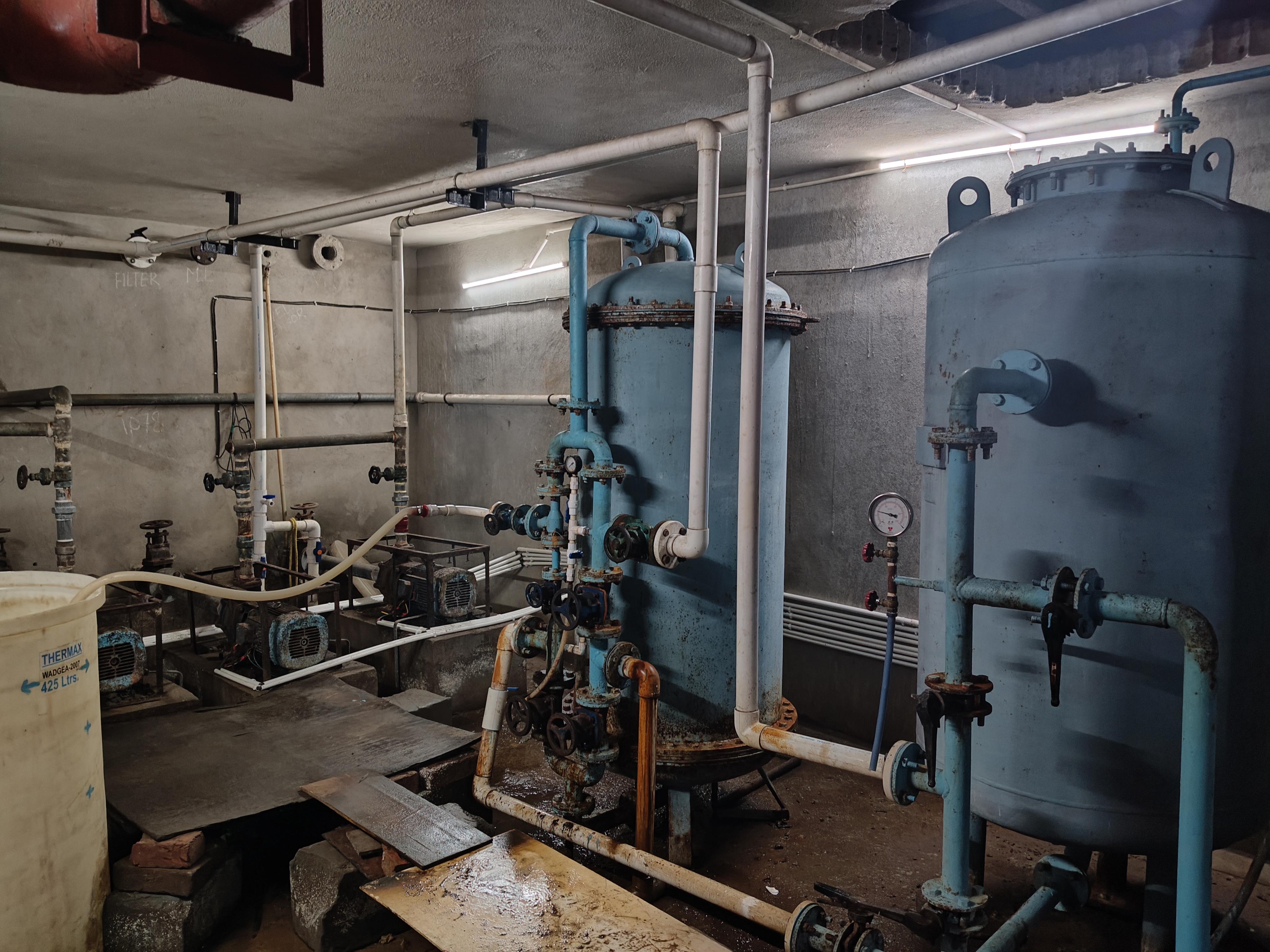

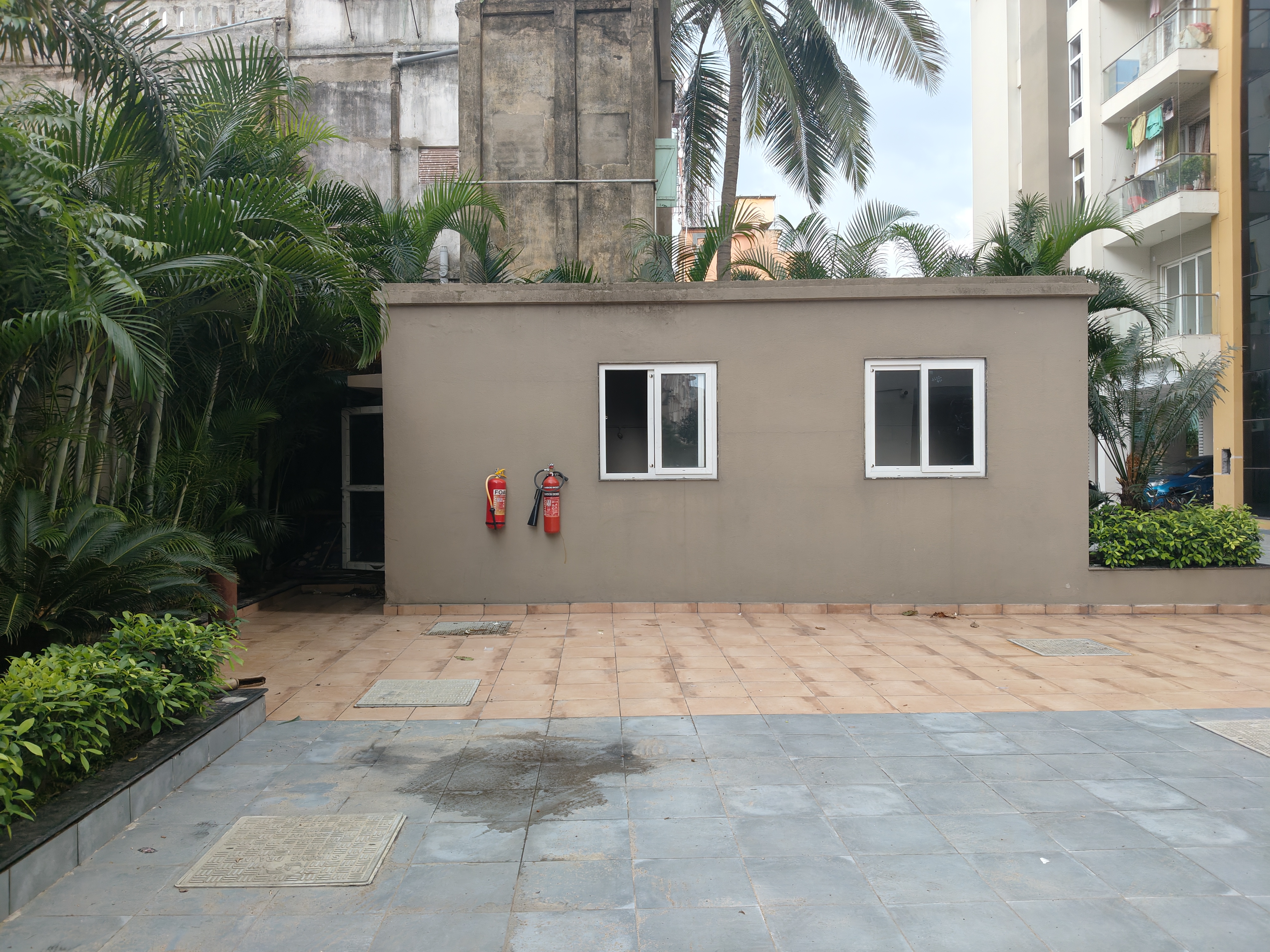

6 Under Construction STP & Part raft casting done

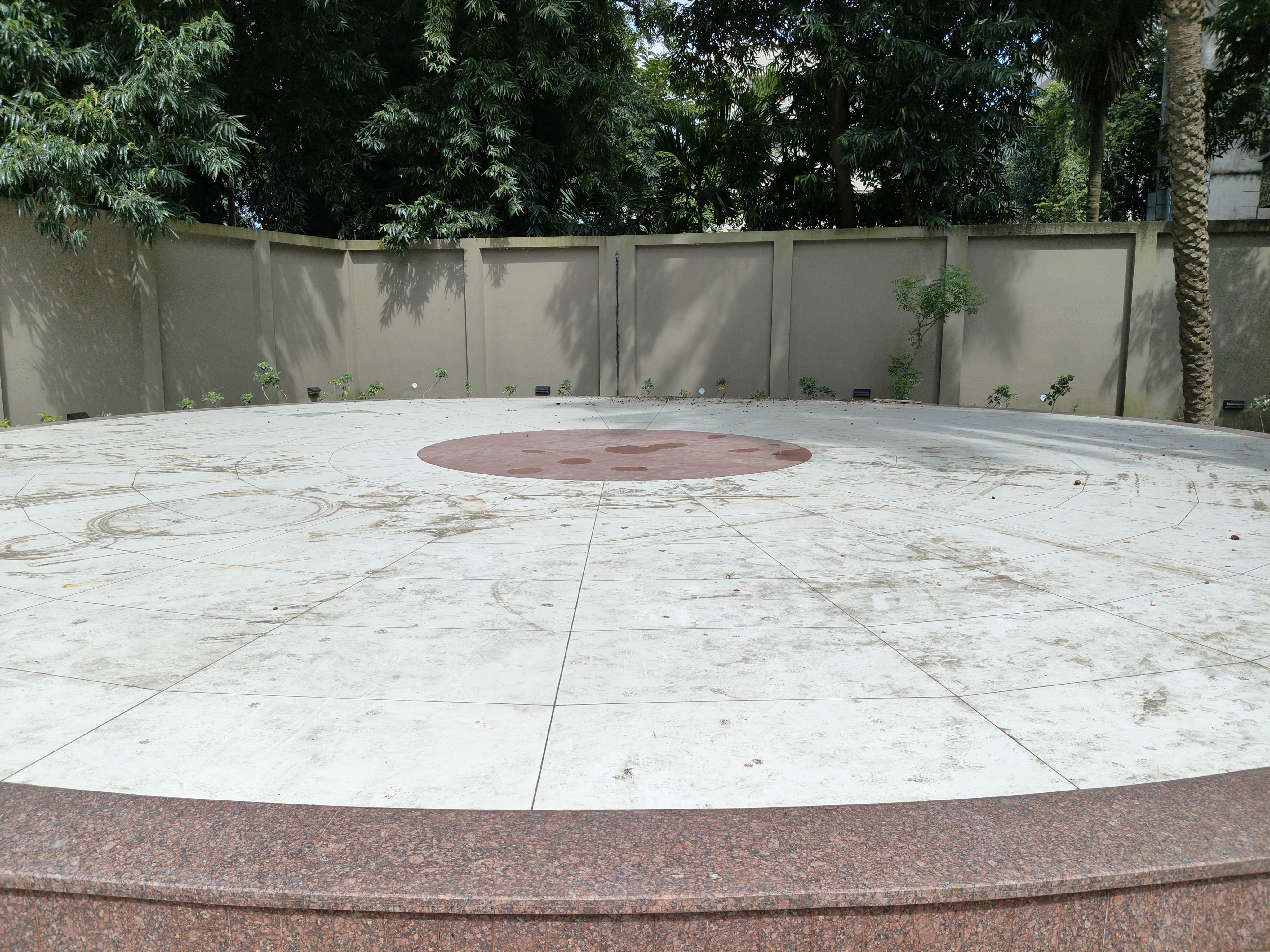

7 Not Started COMMON AREA WORK NOT STARTED

Approval for NOC

Approved Document Approval Applied Approval Expected Approval Received Modifications Download
