| 1 |

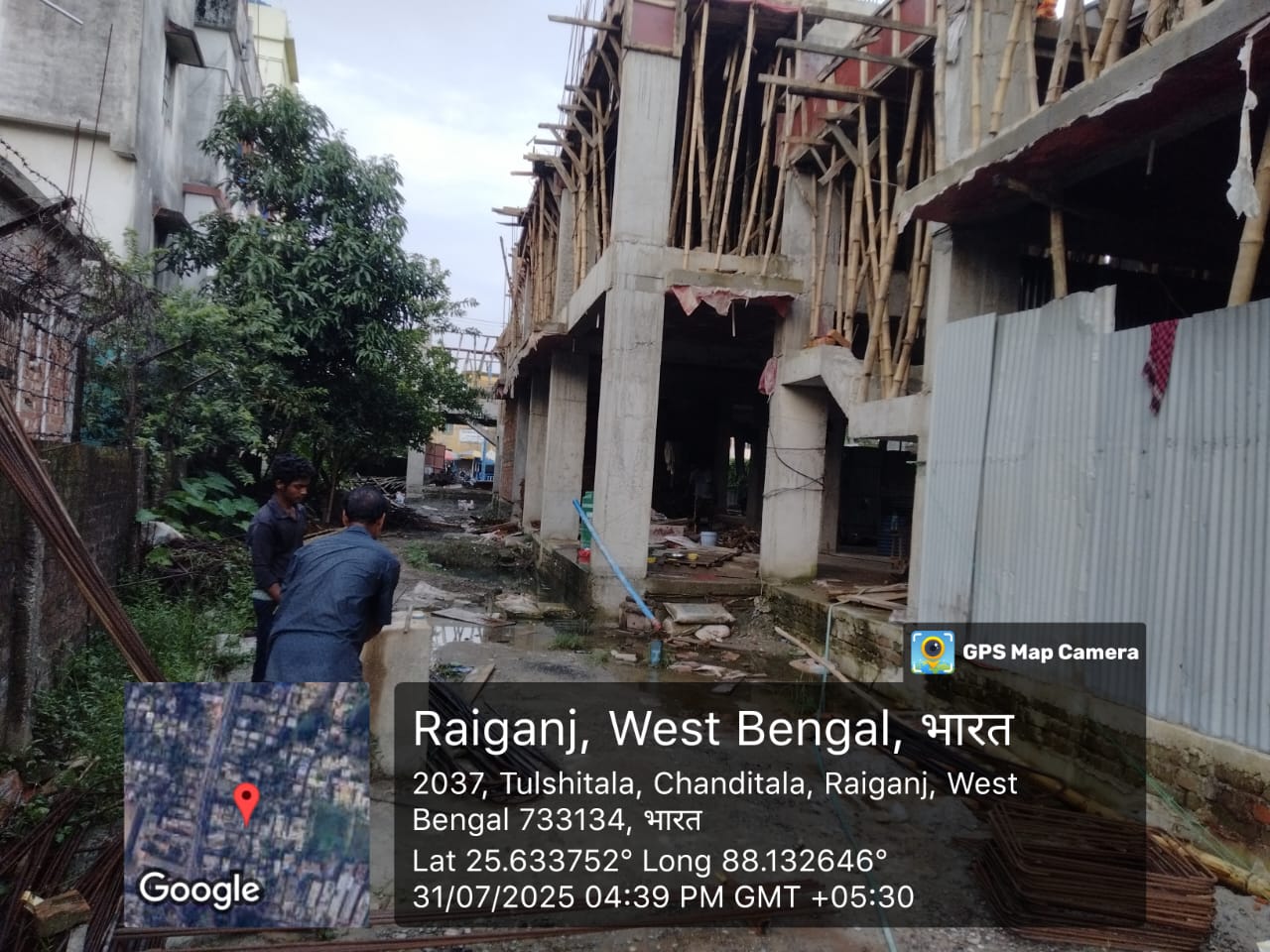

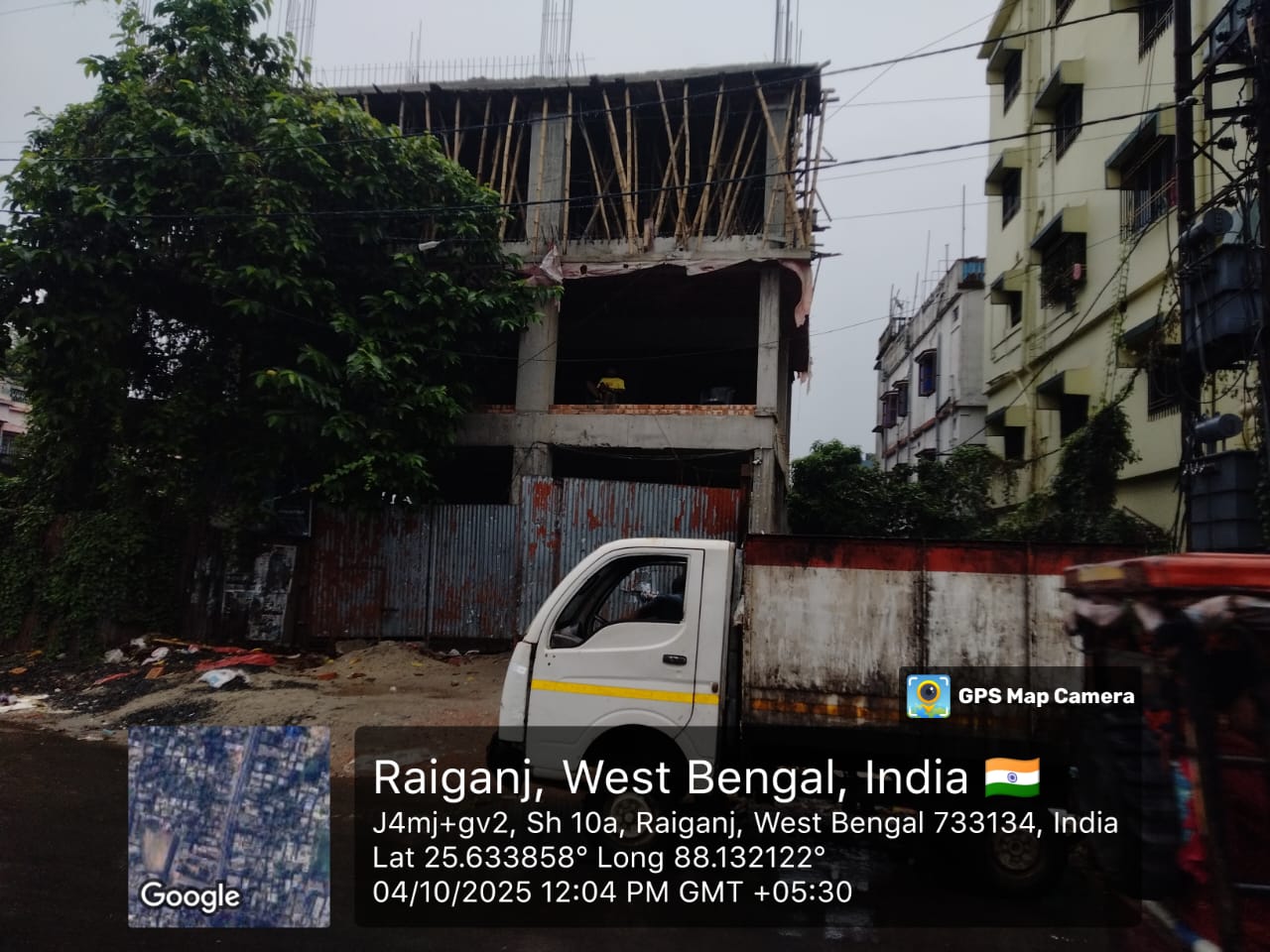

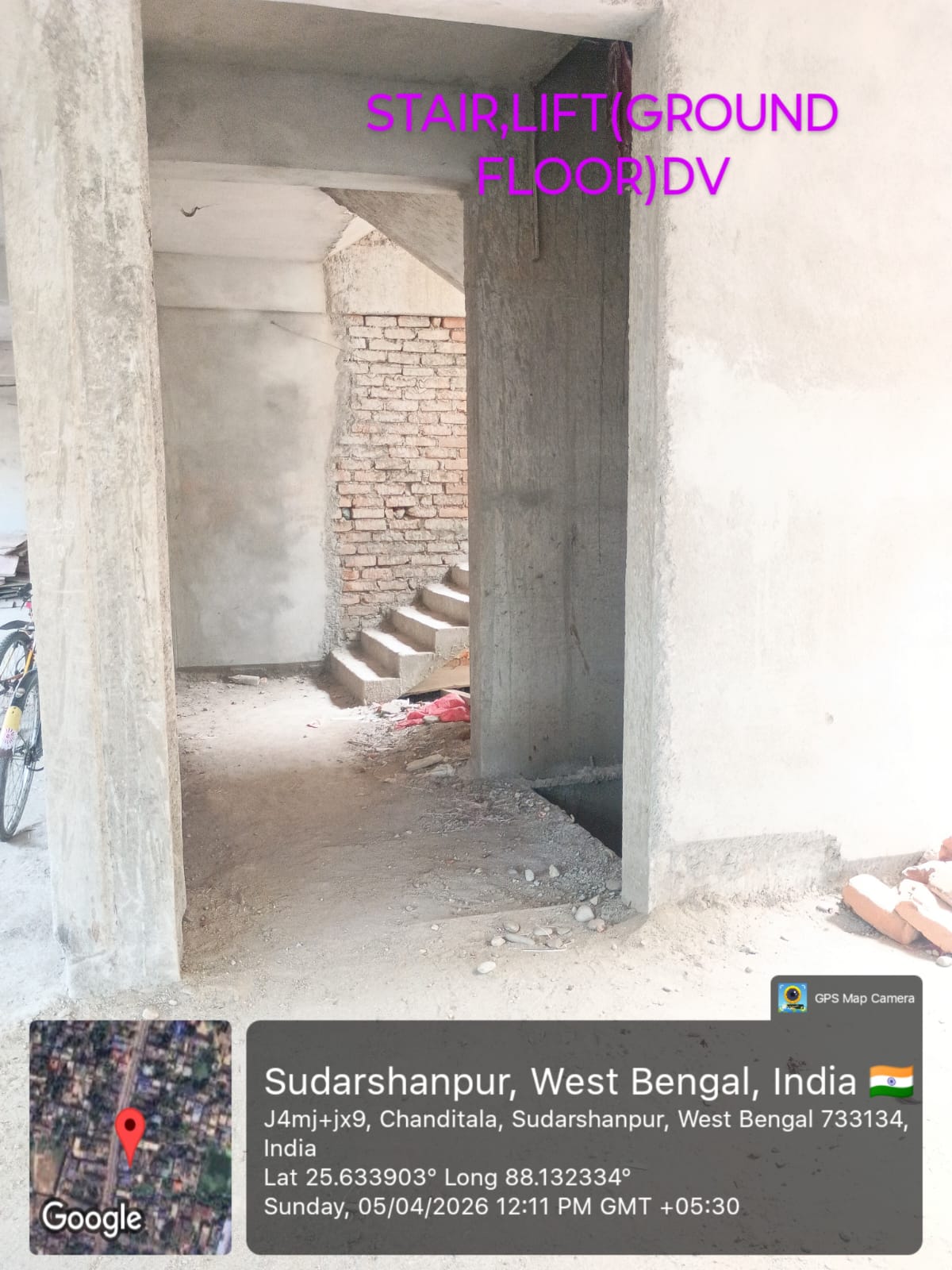

Under Construction |

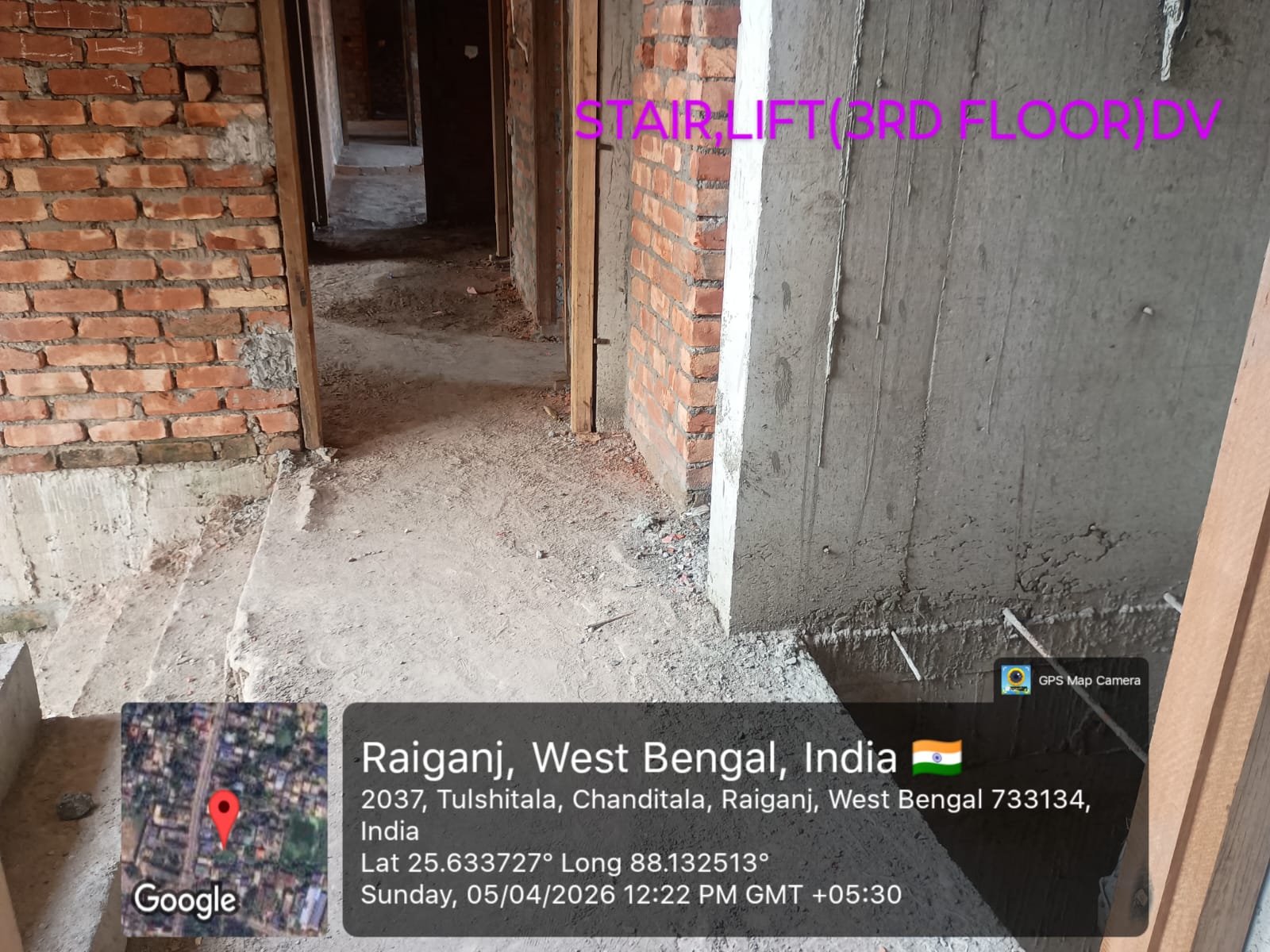

4th Quarter - Stairs & Lift- Casting of 2 stairs & 2 Lift completed |
|
| 2 |
Completed With CC |

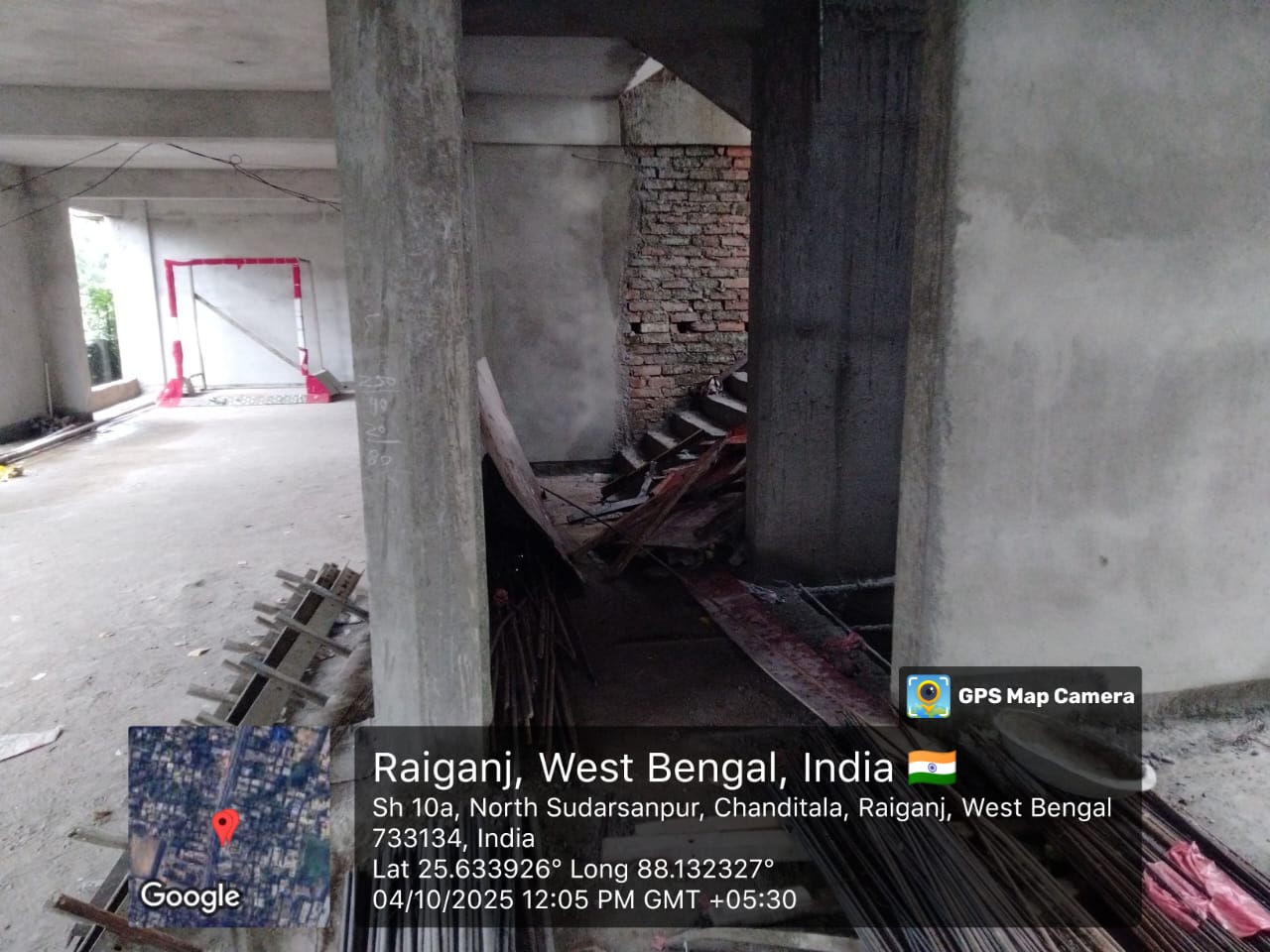

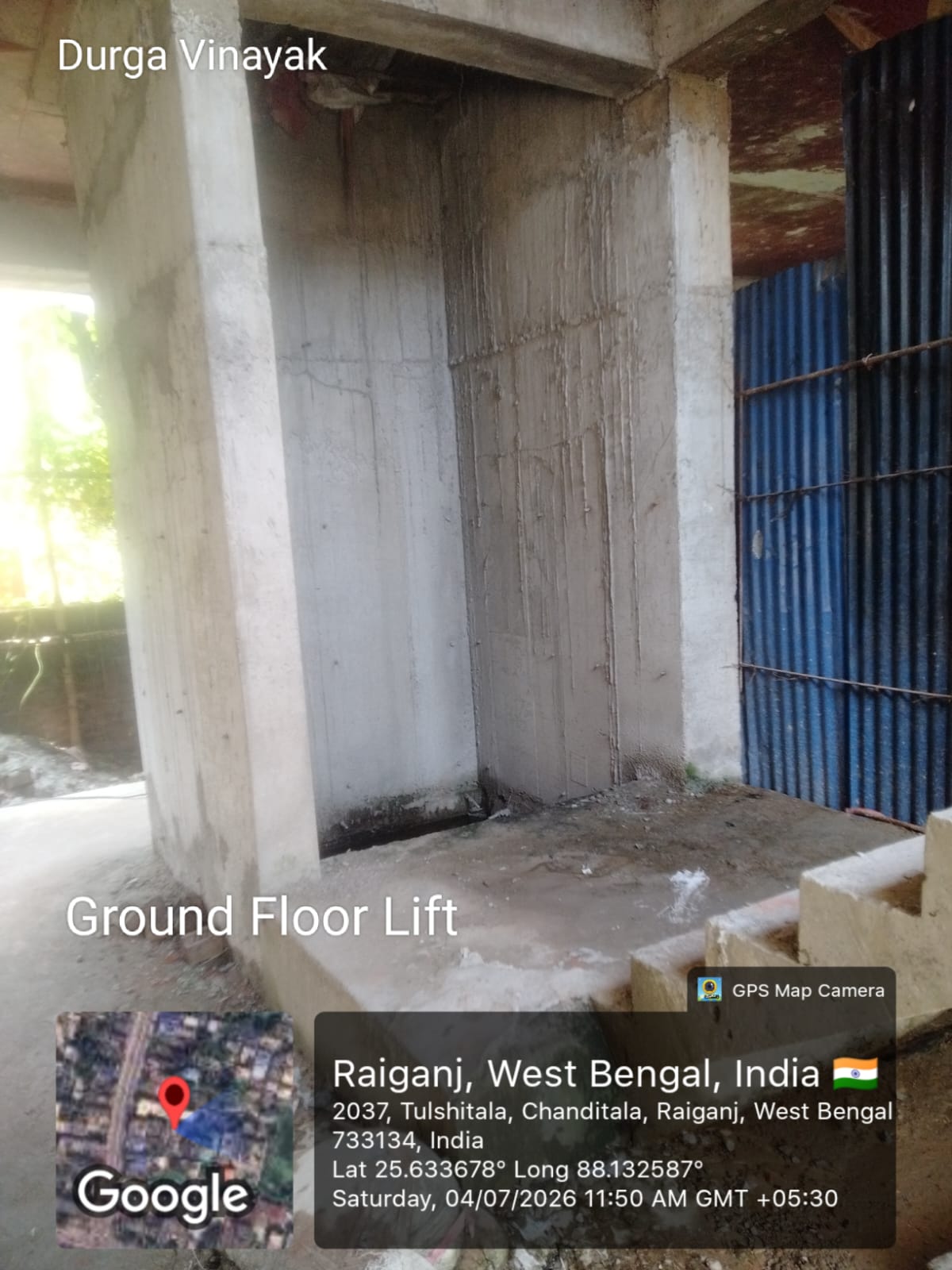

LIFT/LOBBY |
|
| 3 |
Completed With CC |

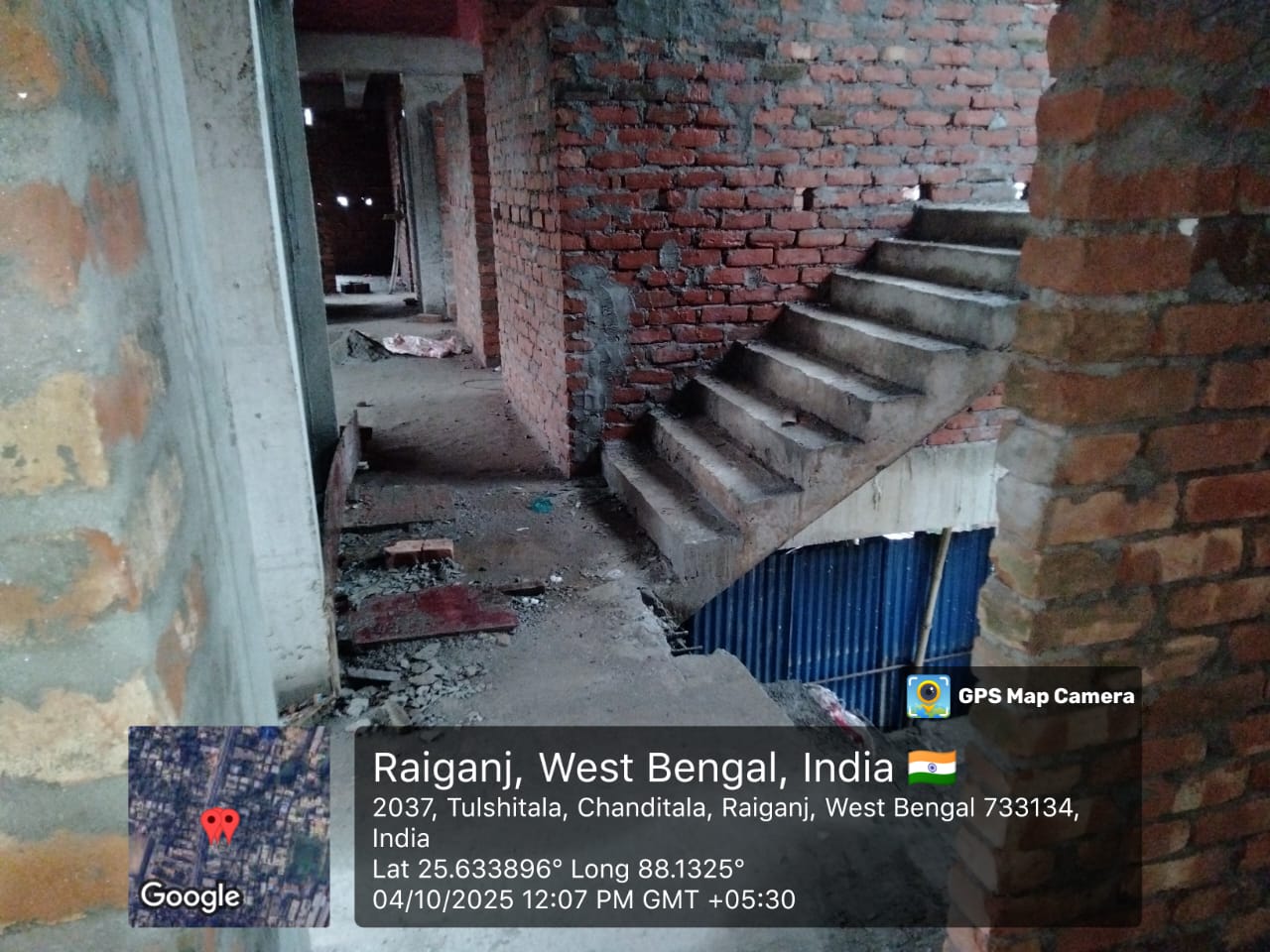

STAIRS |
|

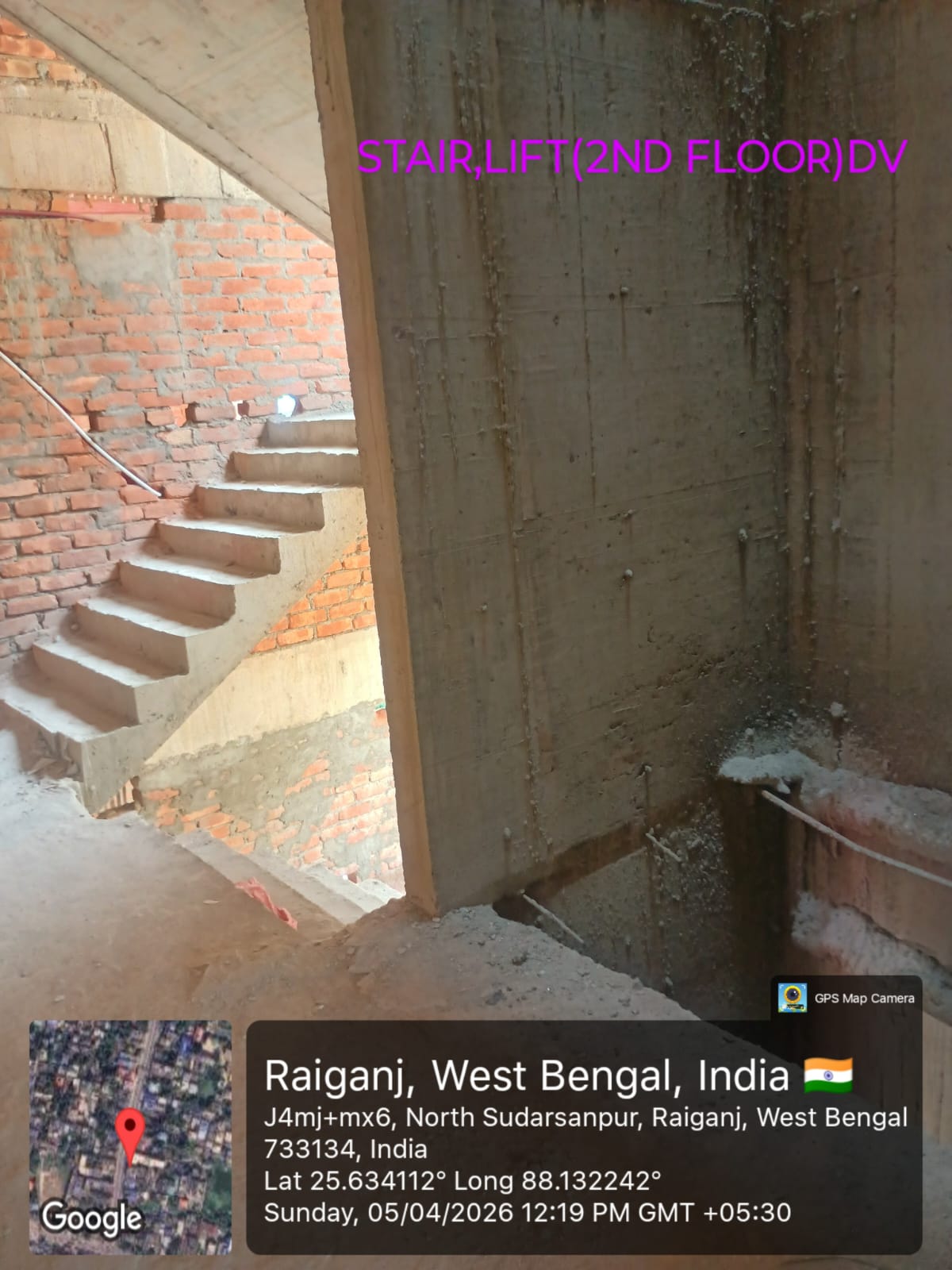

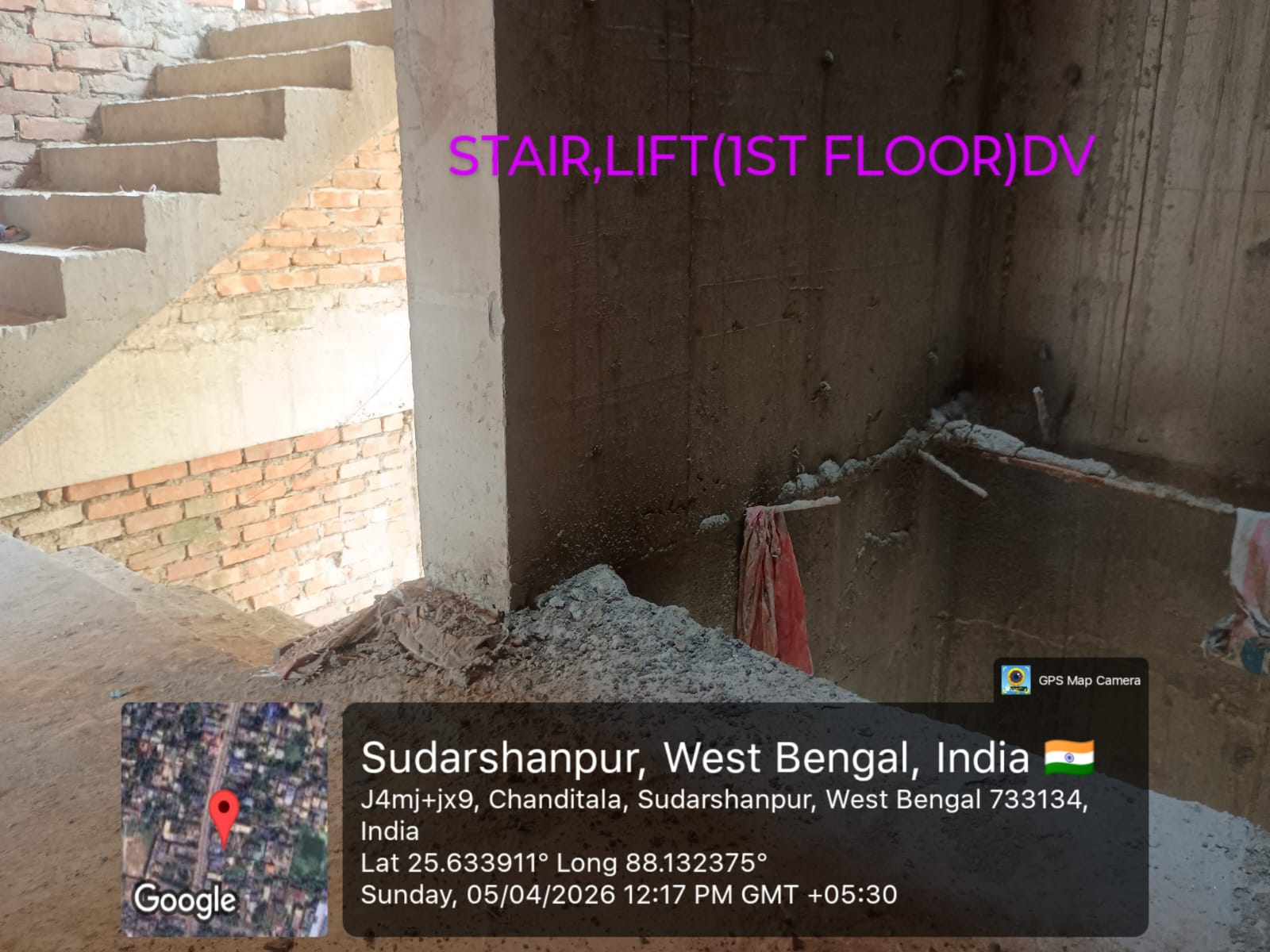

| 4 |
Under Construction |

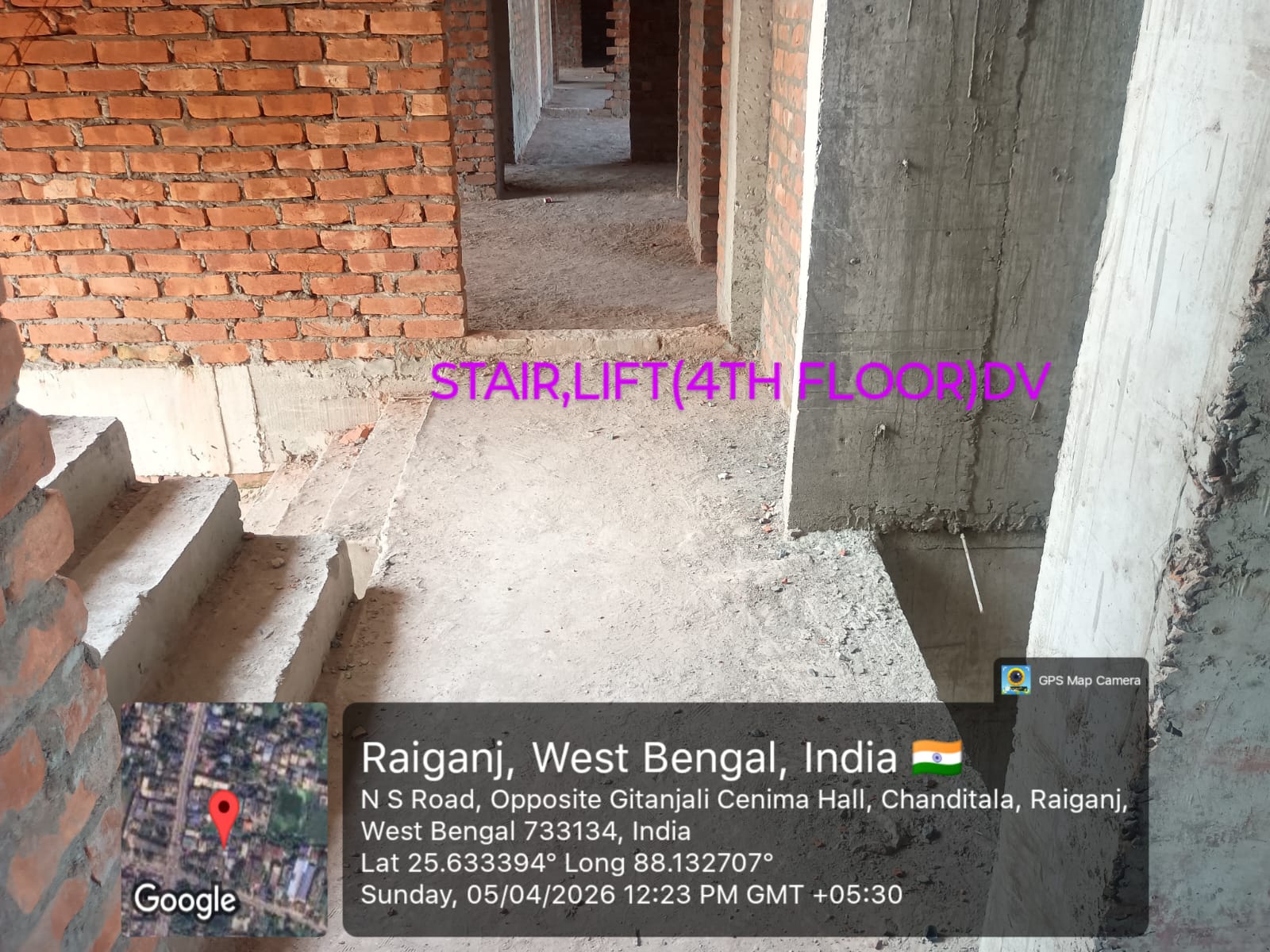

LIFT STAIRS - |
|

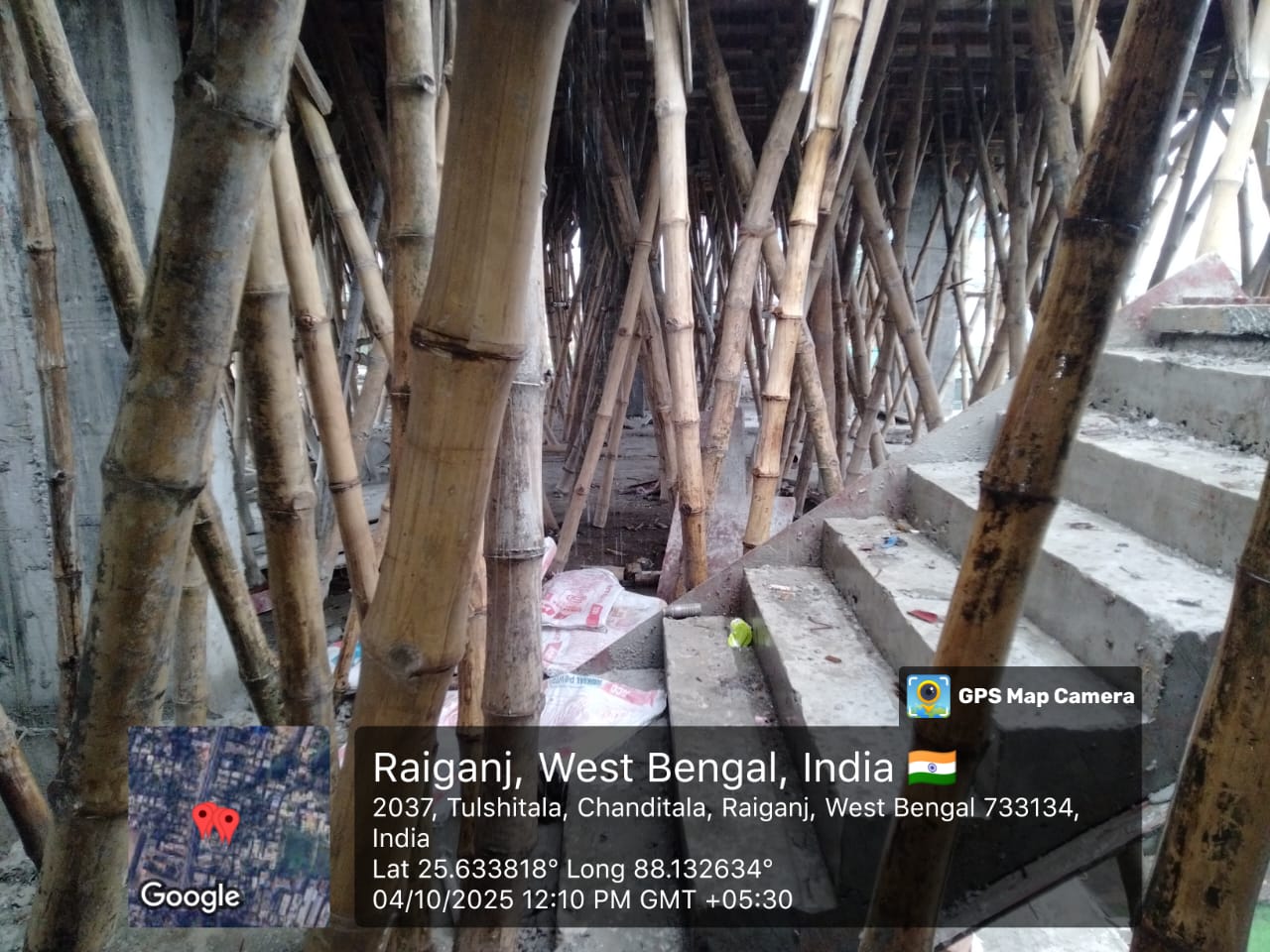

| 5 |
Under Construction |

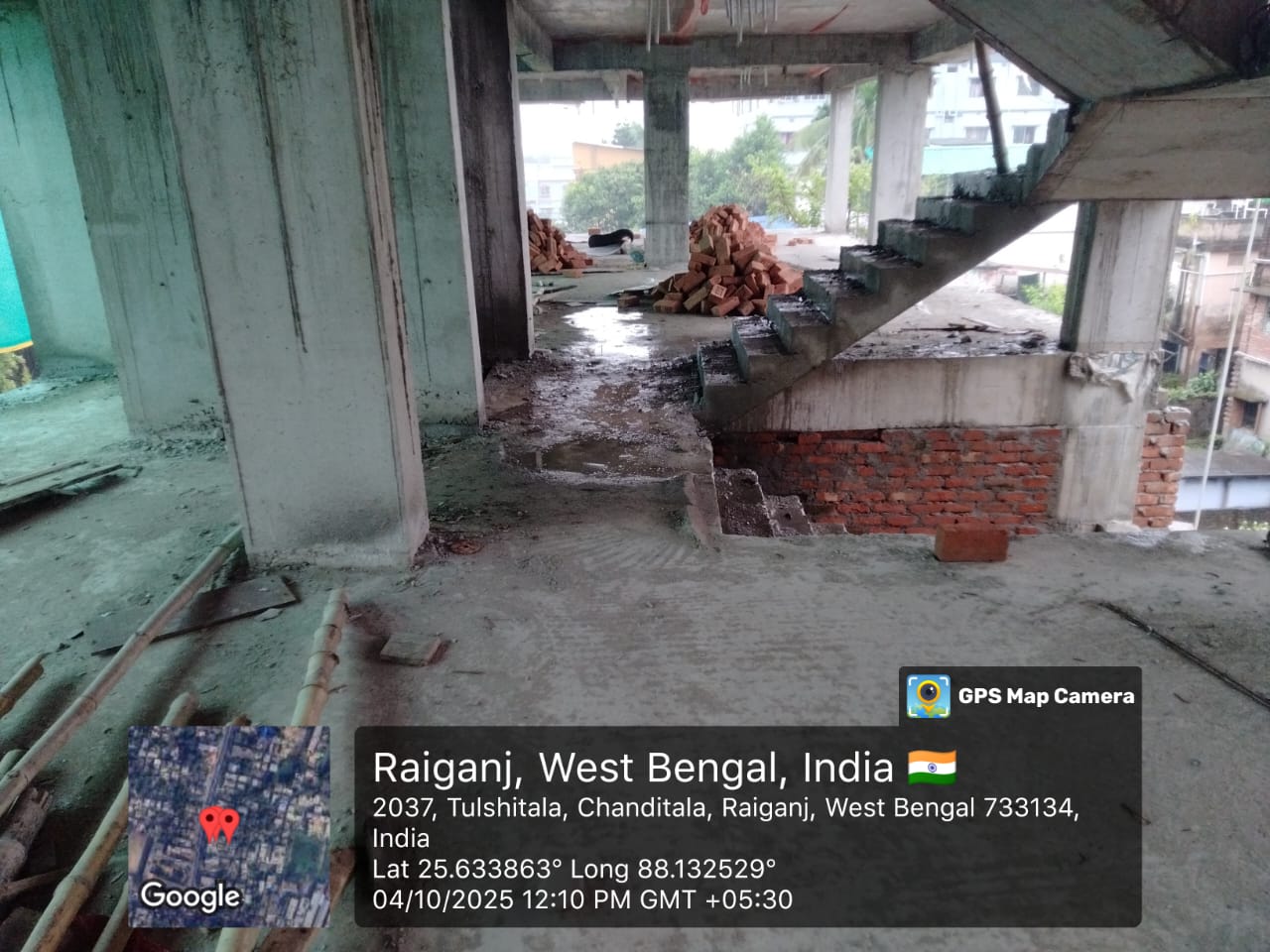

STAIRS- CASTING OF 4 STAIRS COMPLETED |
|
| 6 |
Not Started |
ROOFTANK |
|
| 7 |
Not Started |
POWER BACK UP |
|
| 8 |
Under Construction |

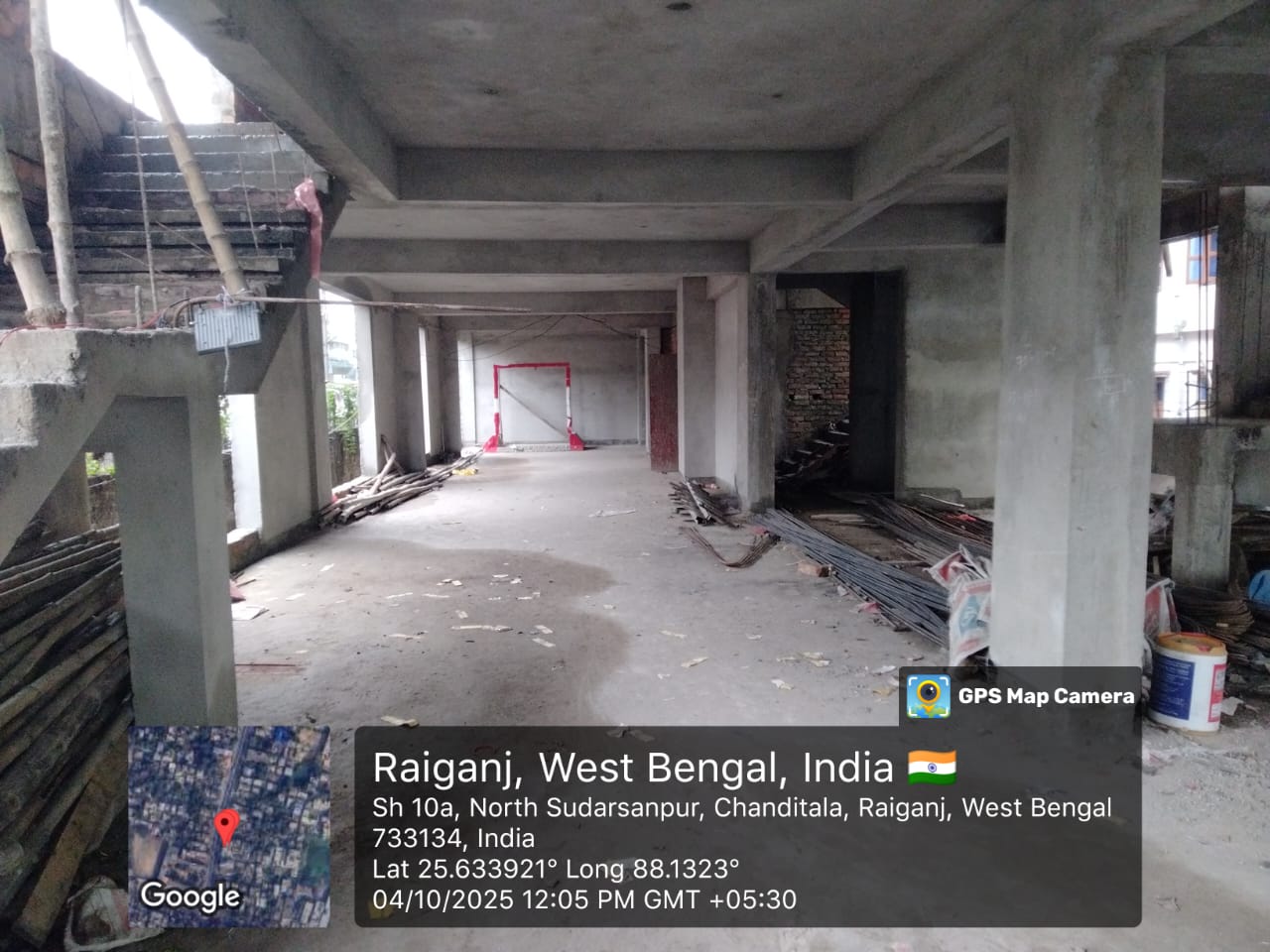

LOBBY |
|

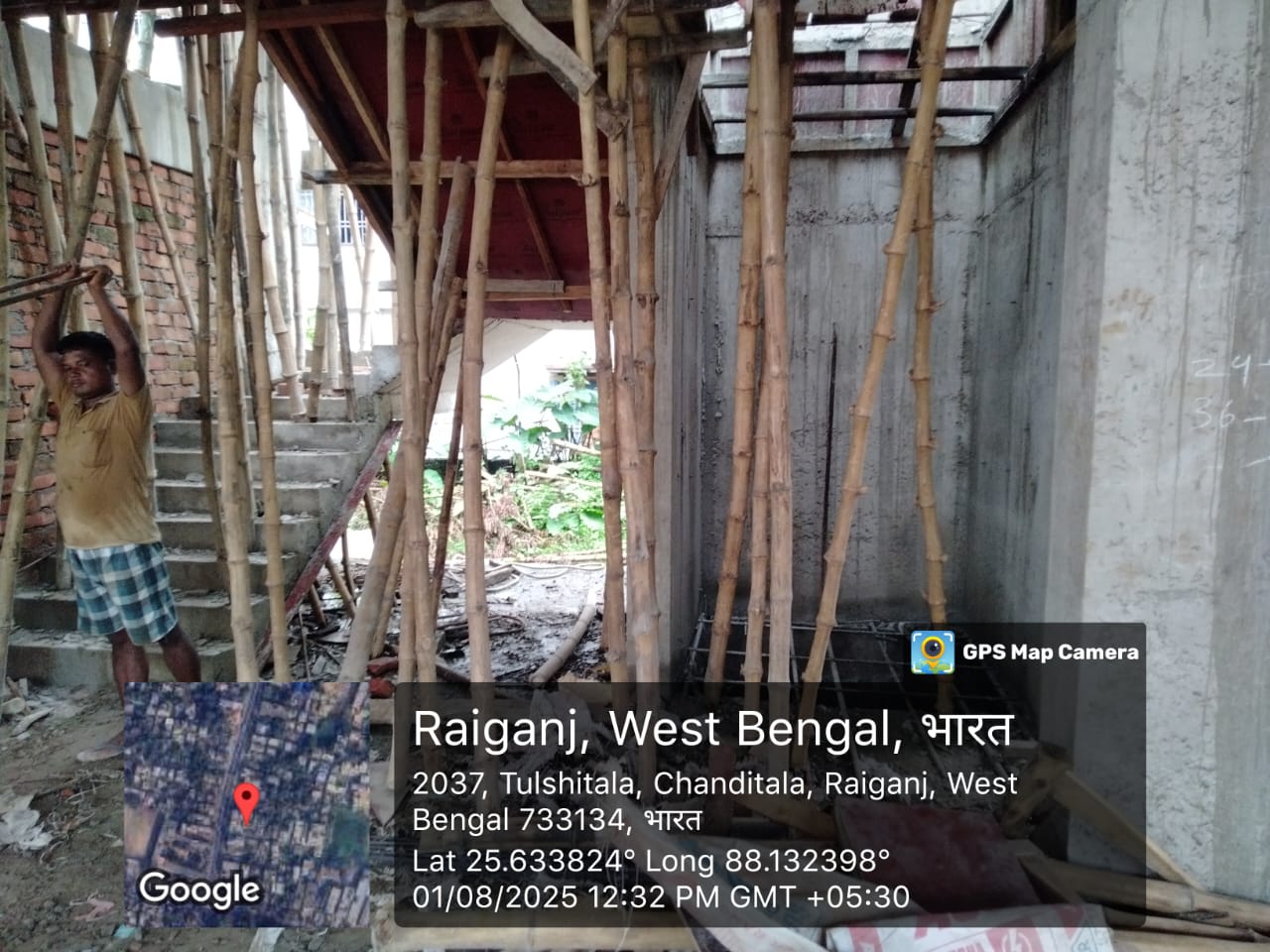

| 9 |
Completed With CC |
LIFT - Casting of 2 liifts completed |
|
| 10 |
Under Construction |
Stairs- casting of 2 stairs completed |
|

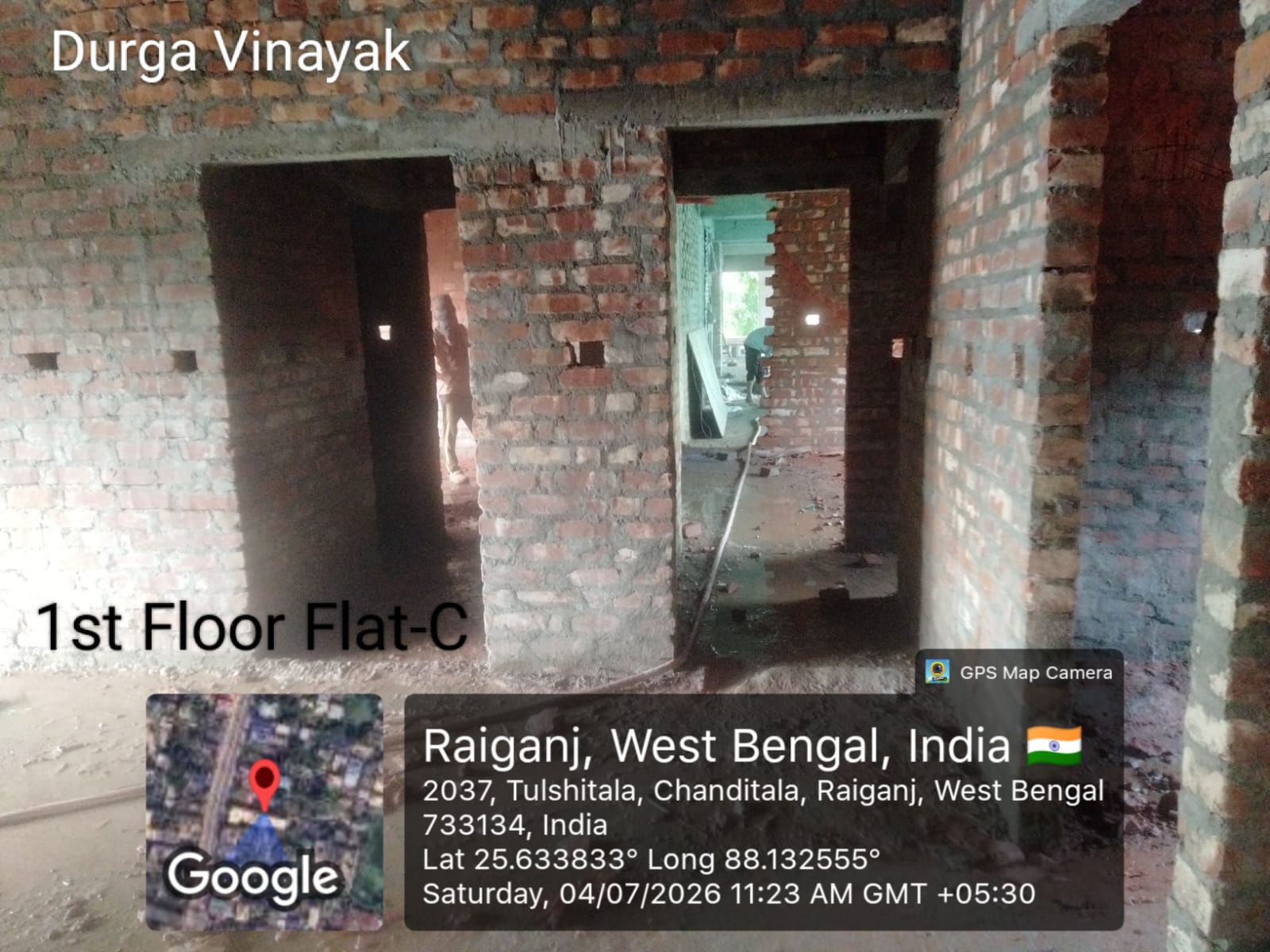

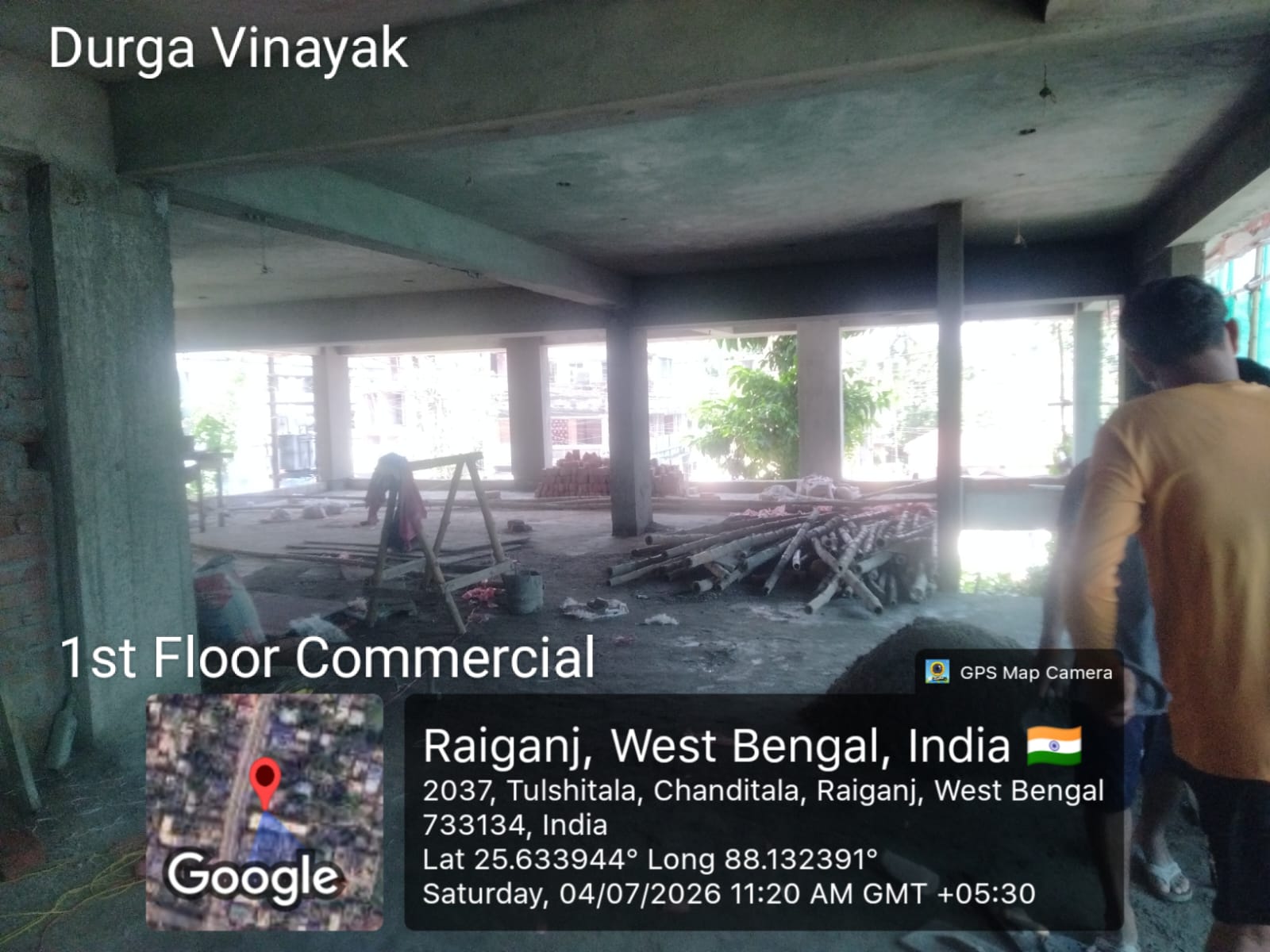

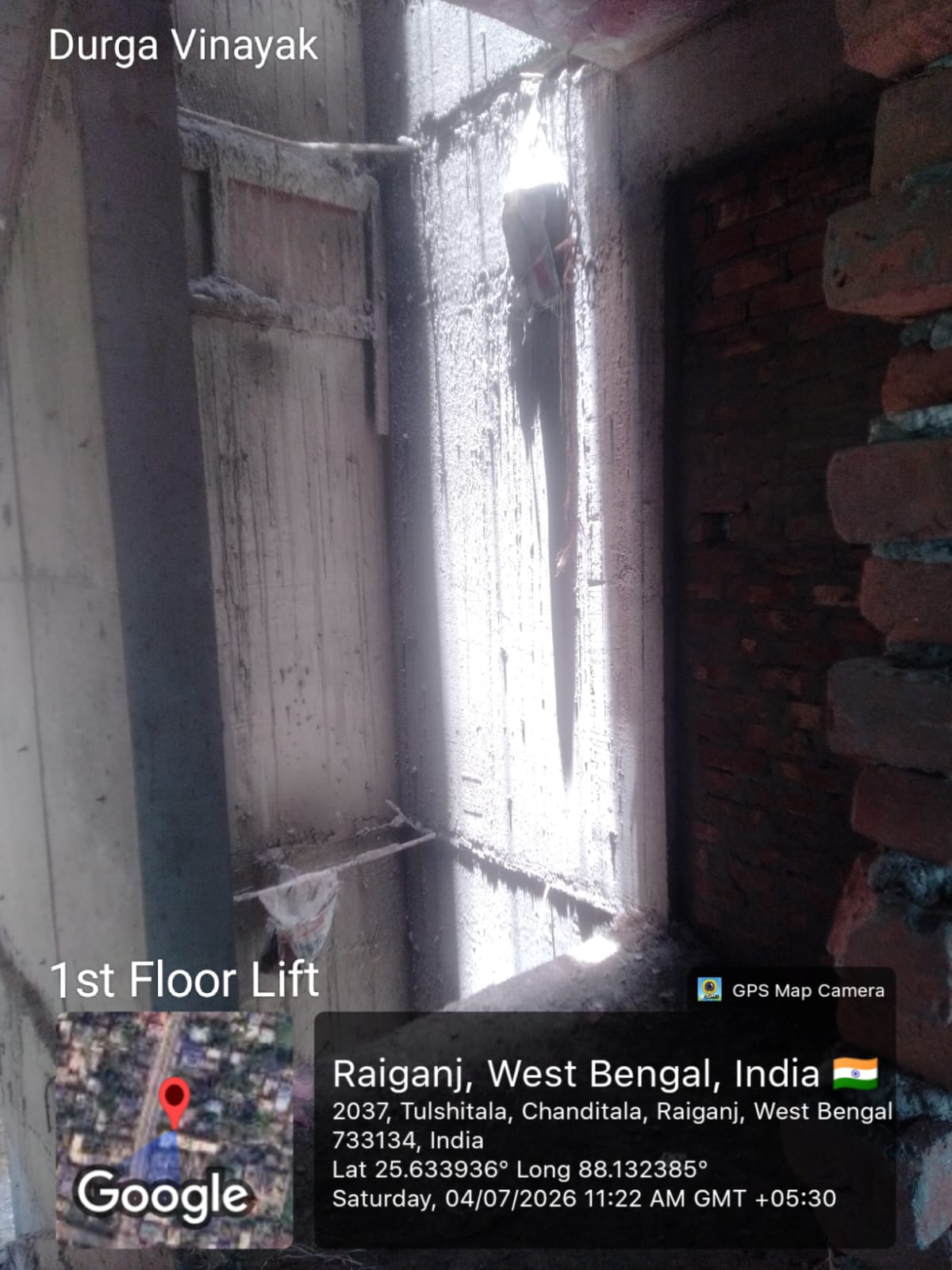

| 11 |

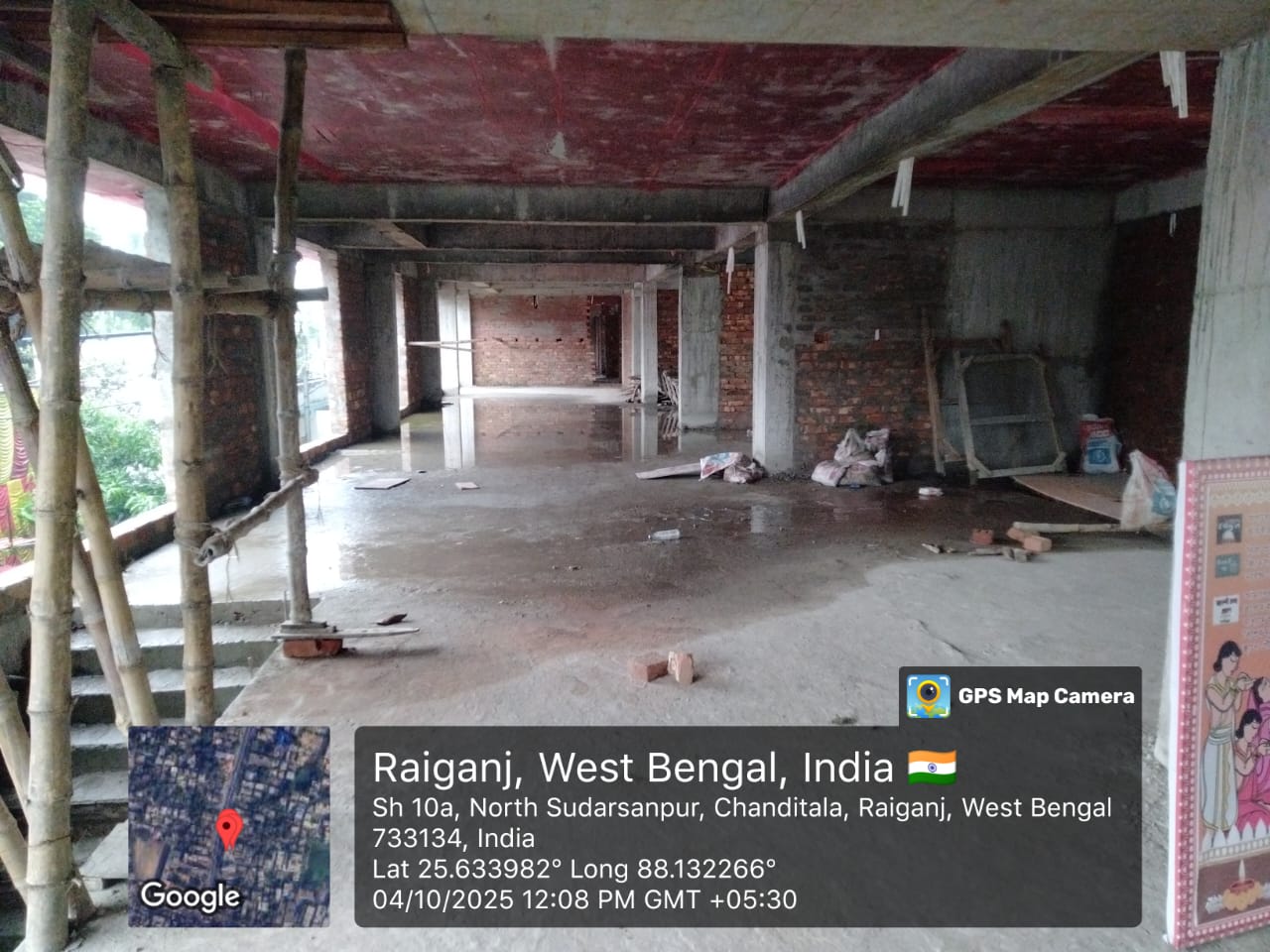

Completed Without CC |

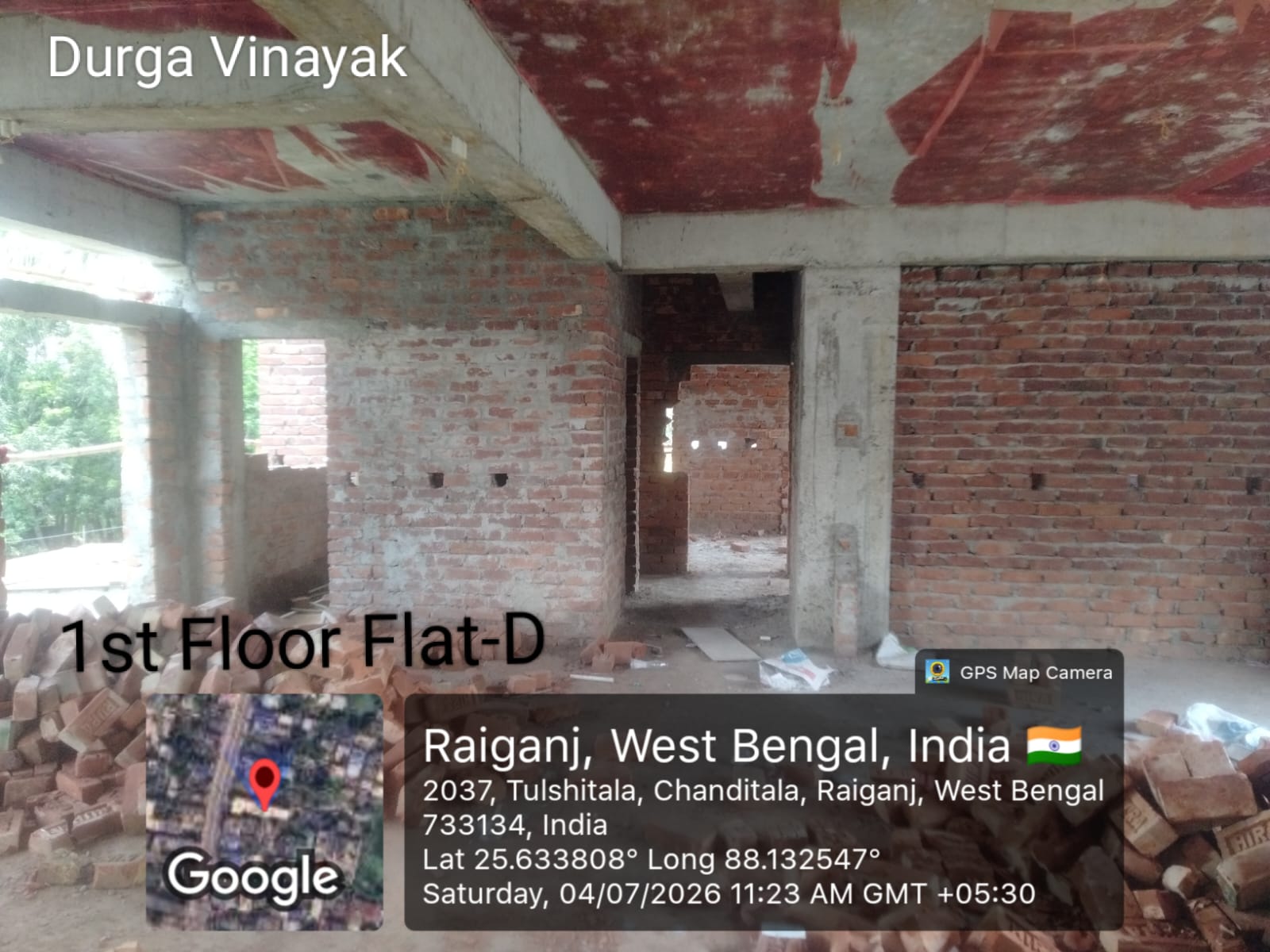

Quarter [April-March 2026] 1st FLOOR |
|
| 12 |
Completed With CC |

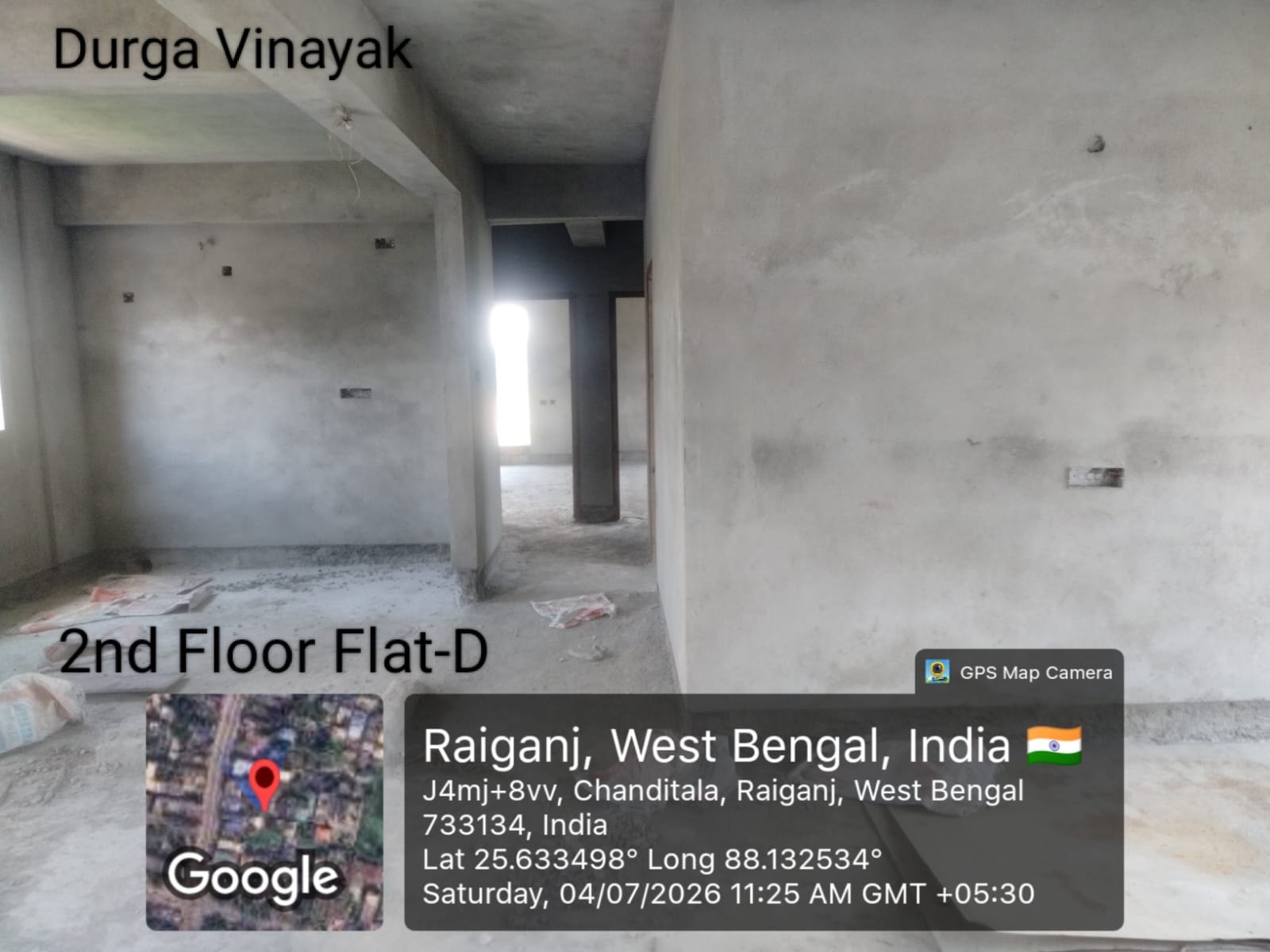

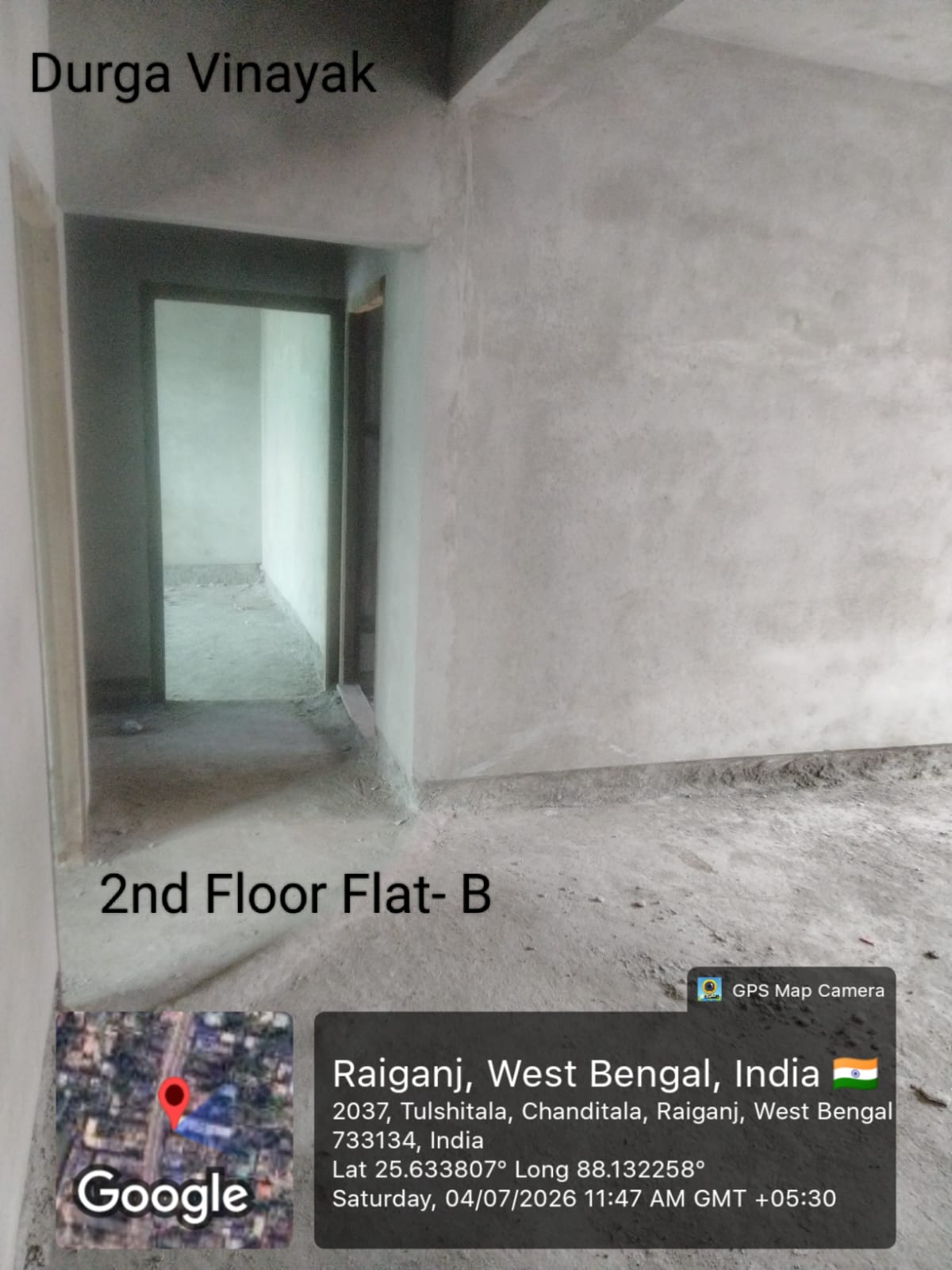

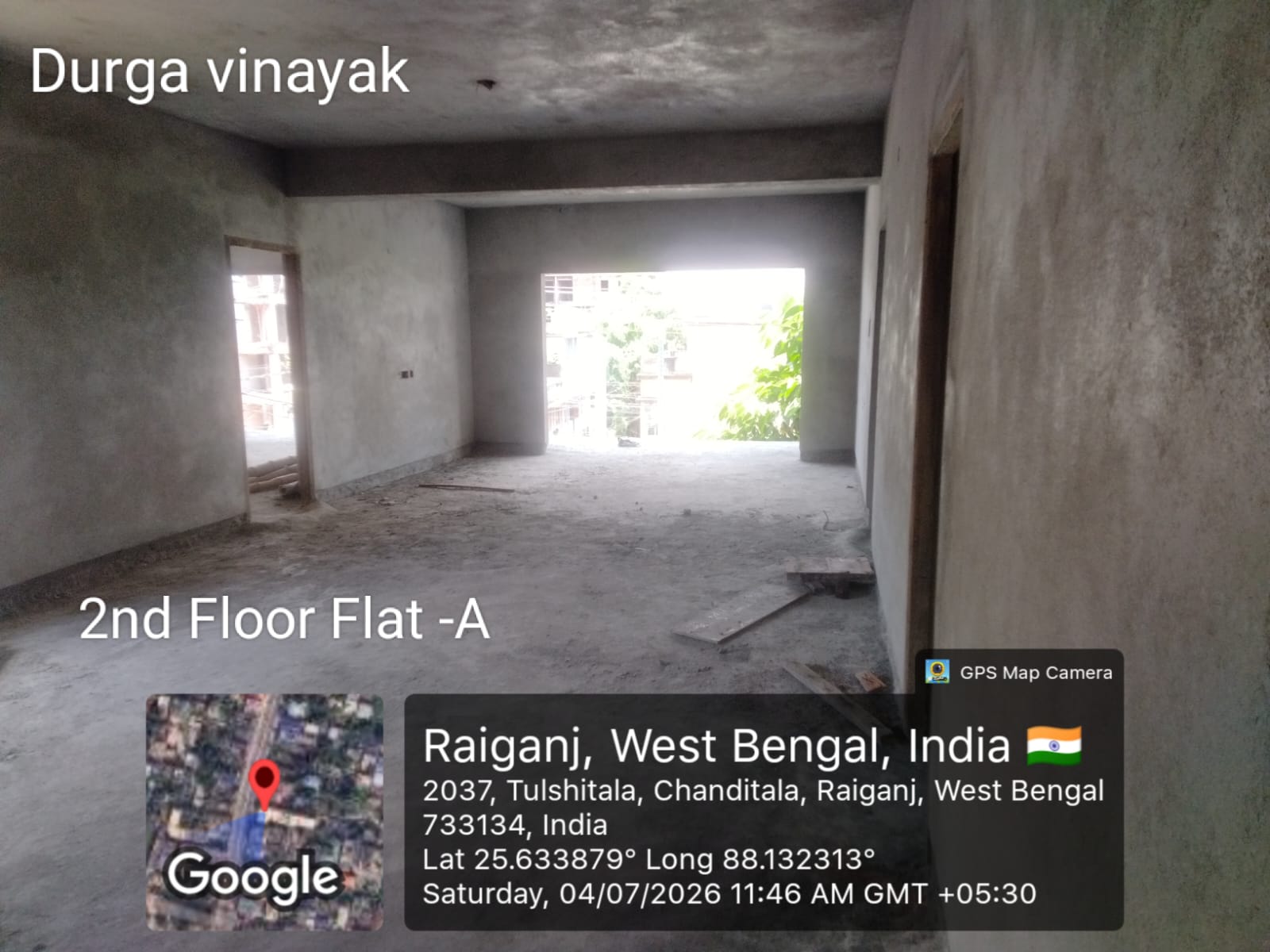

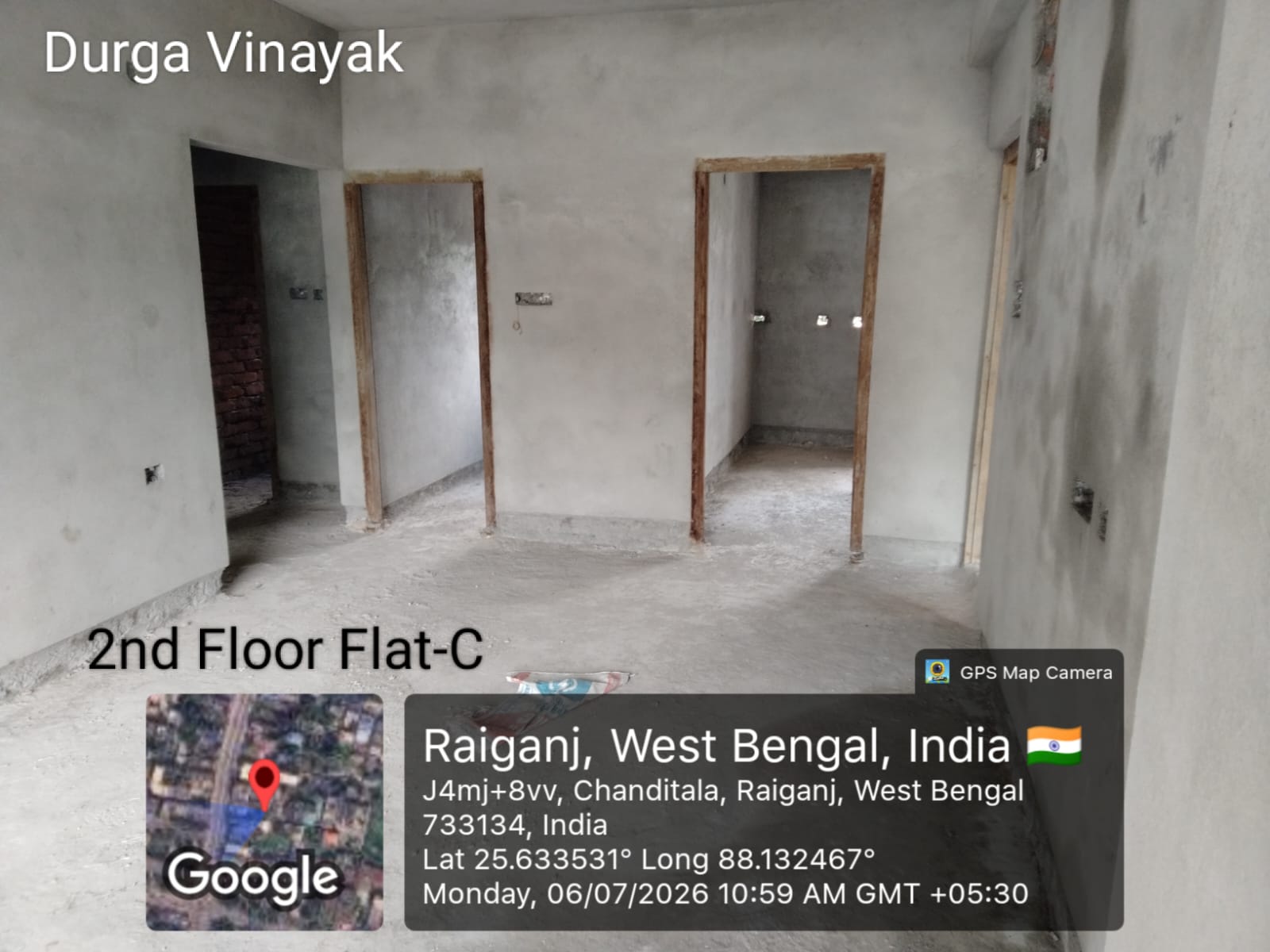

QUARTER [APRIL- JUNE 2026] 2ND FLOOR |
|
| 13 |

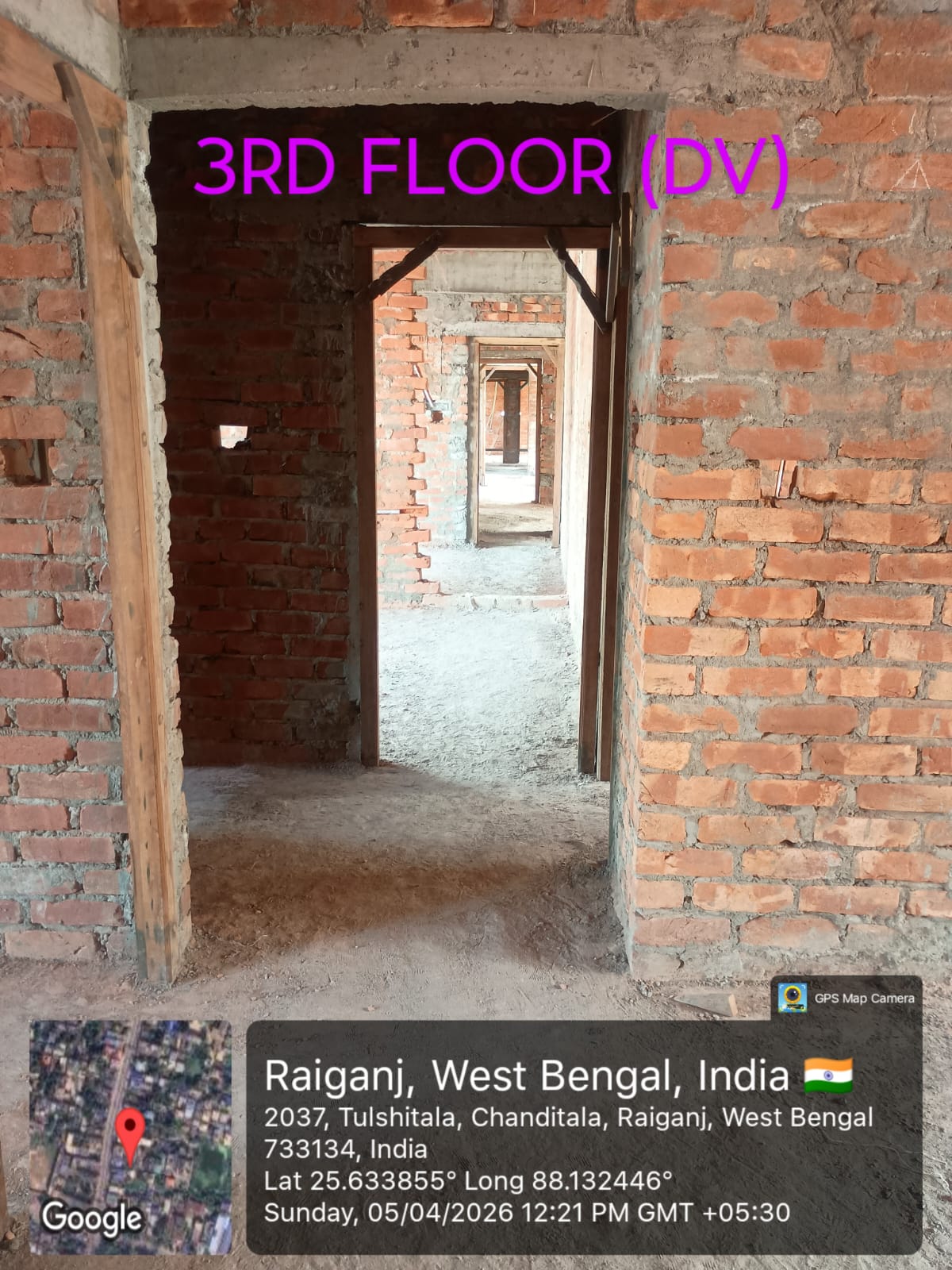

Completed With CC |

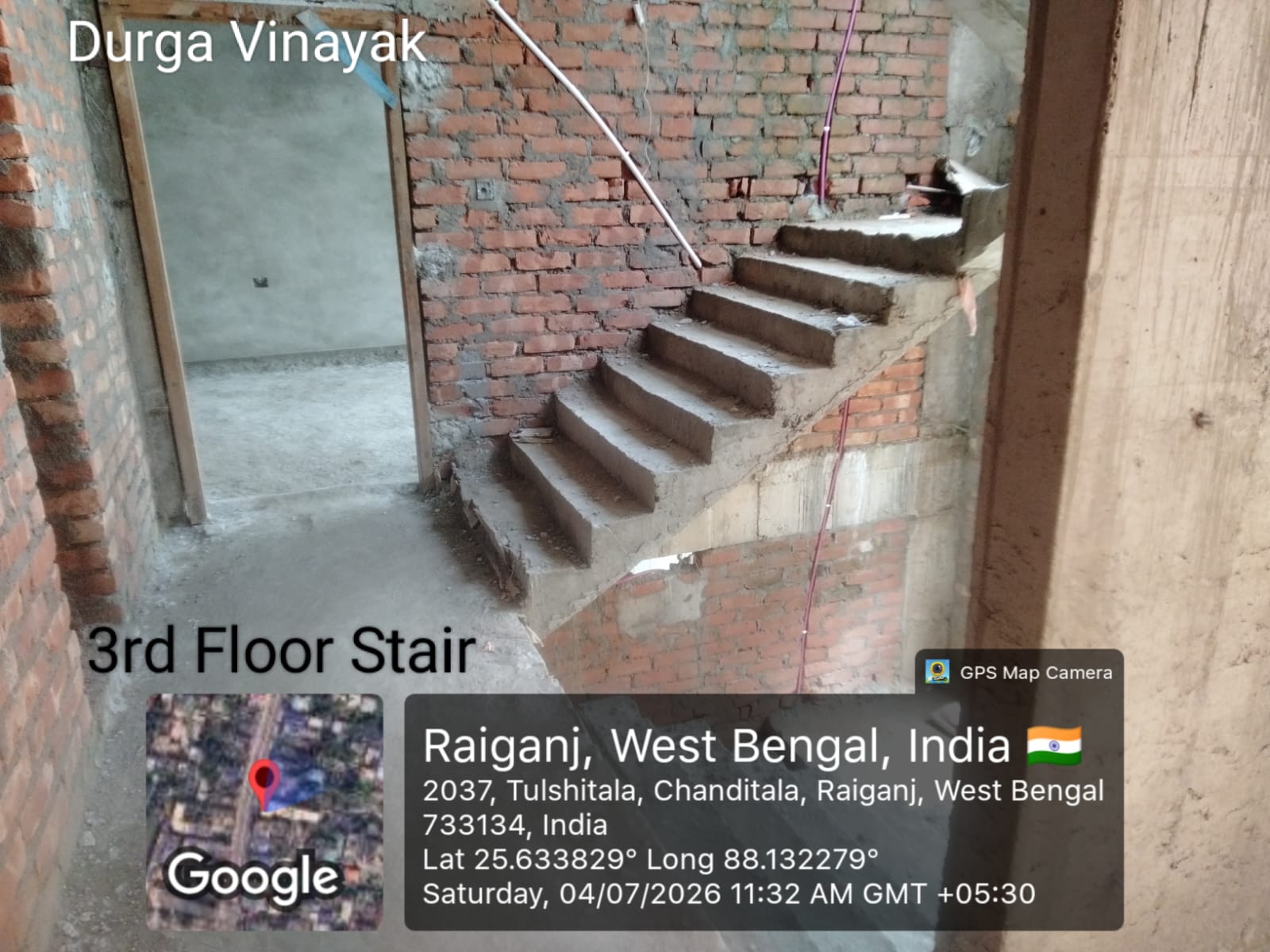

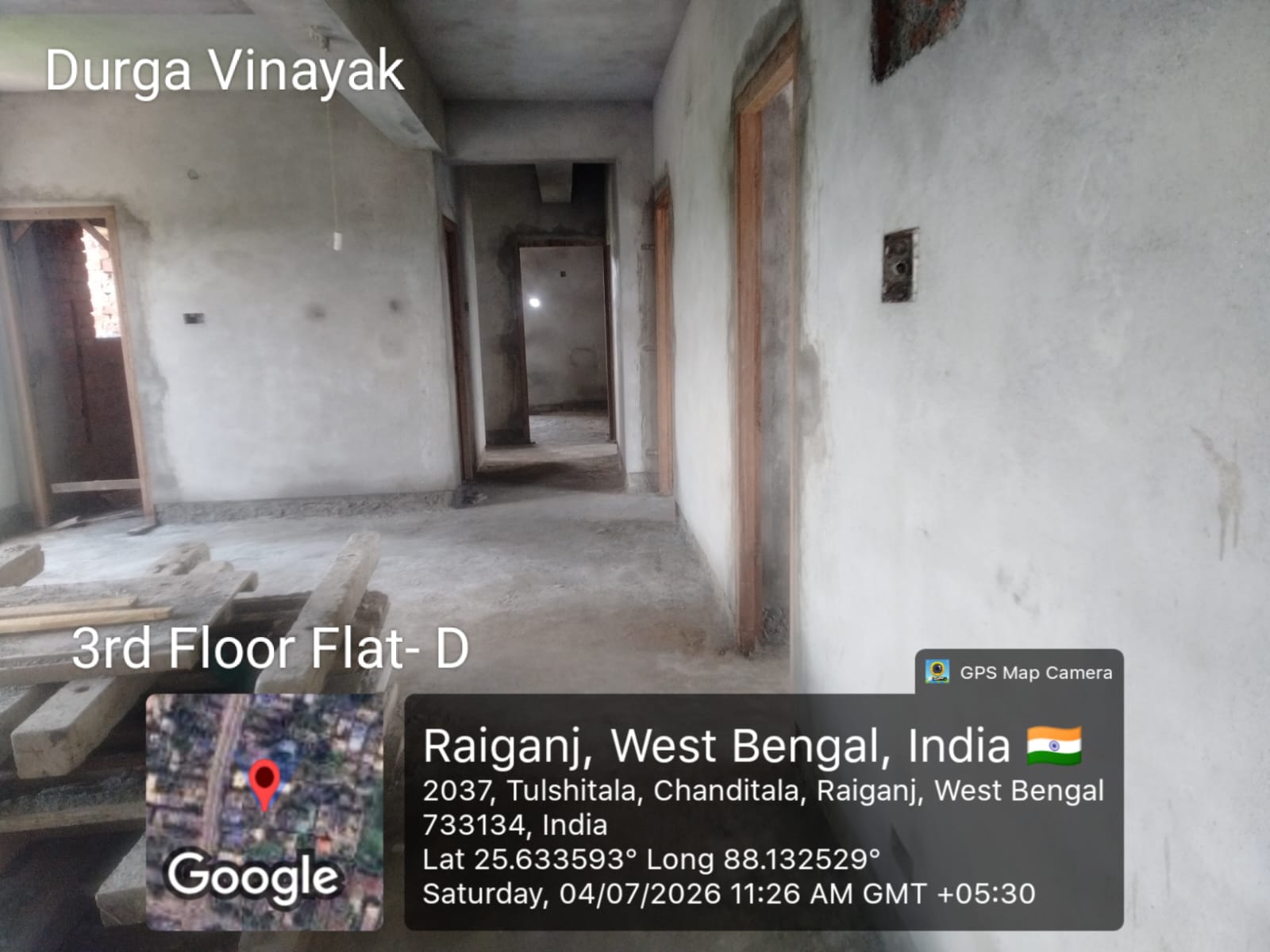

QUARTER [APRIL-JUNE 2026] 3RD FLOOR |
|
| 14 |

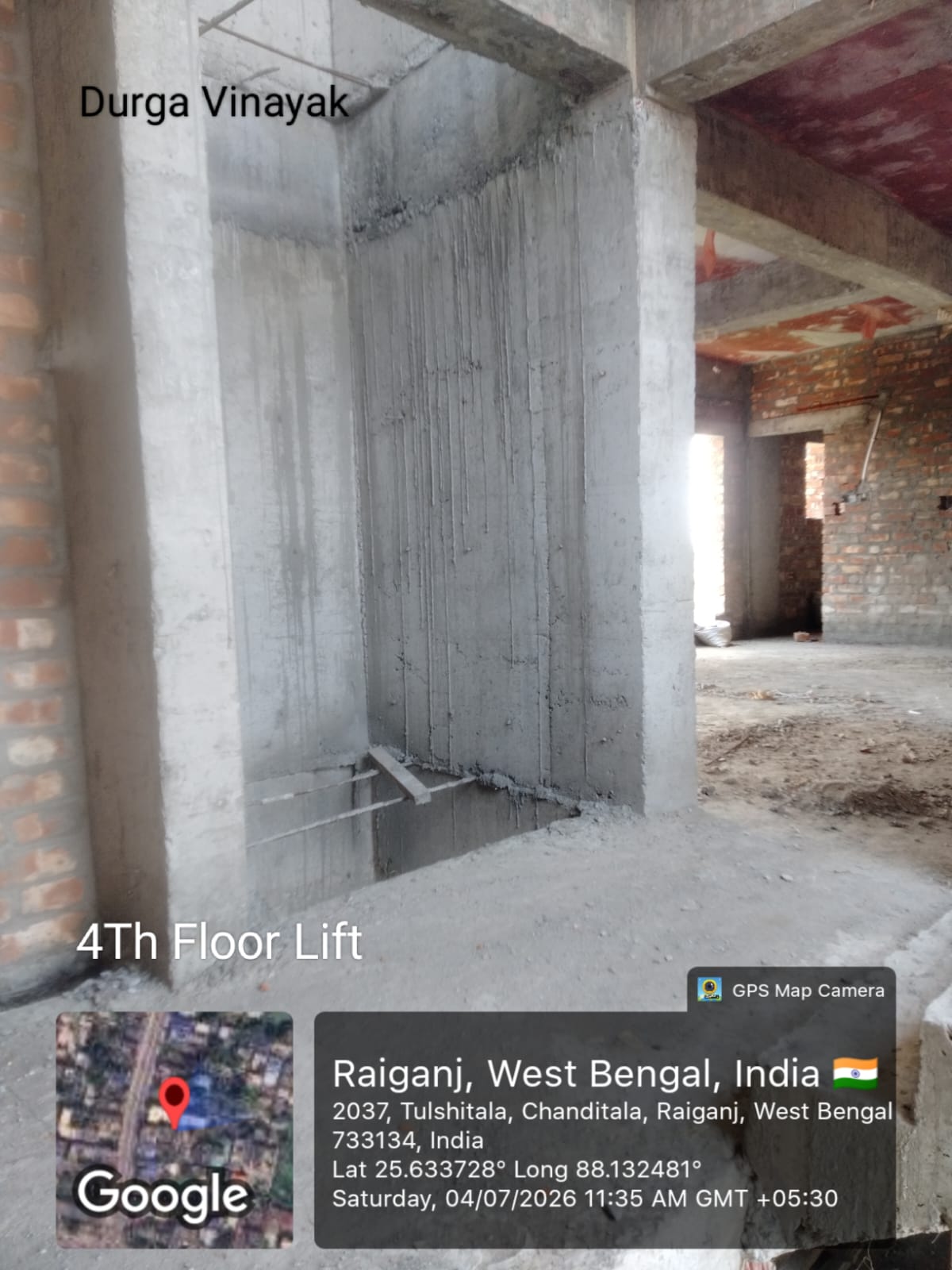

Completed With CC |

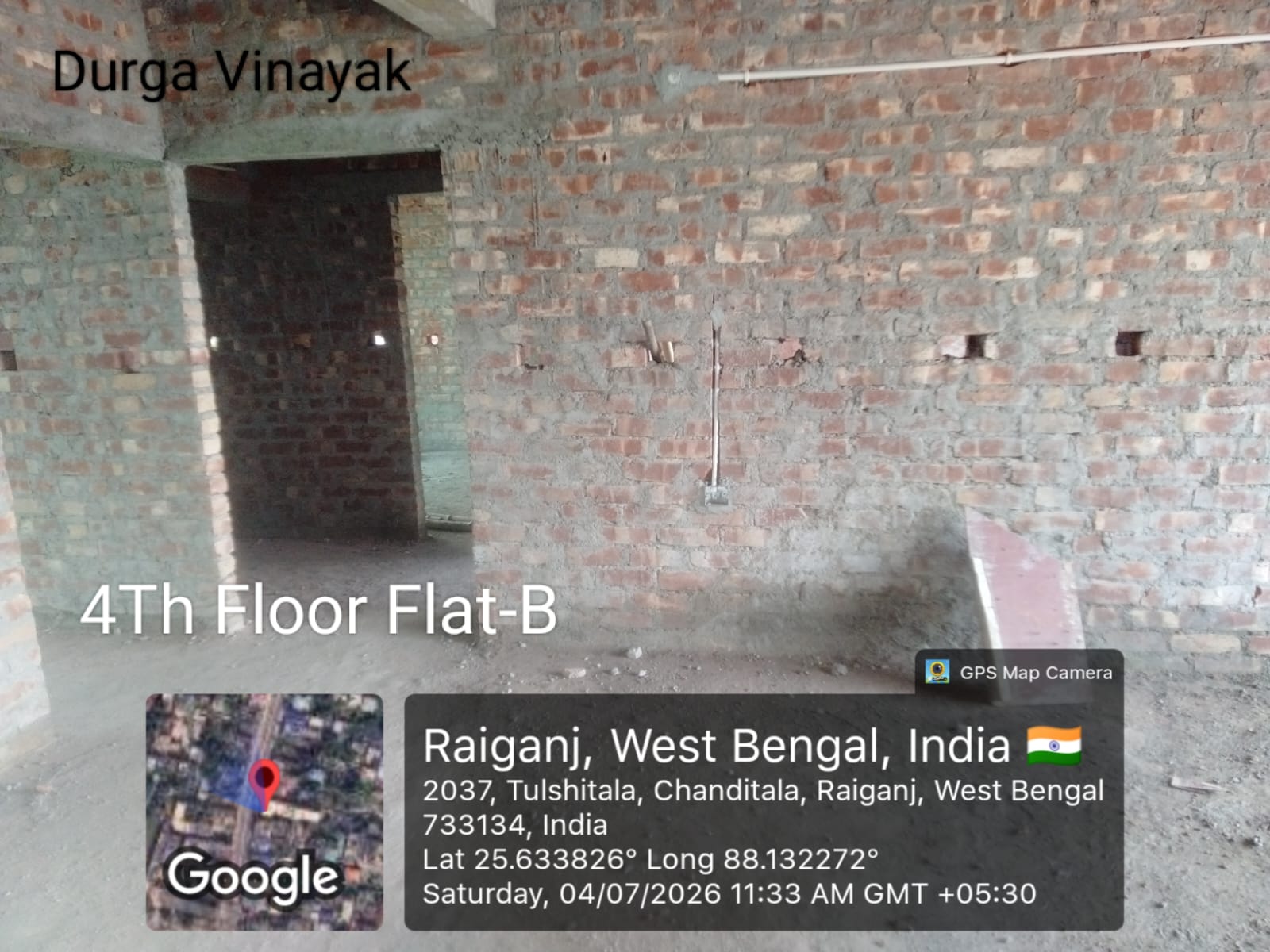

QUARTER [APRIL-JUNE 2026] 4TH FLOOR |
|
| 15 |
Completed With CC |

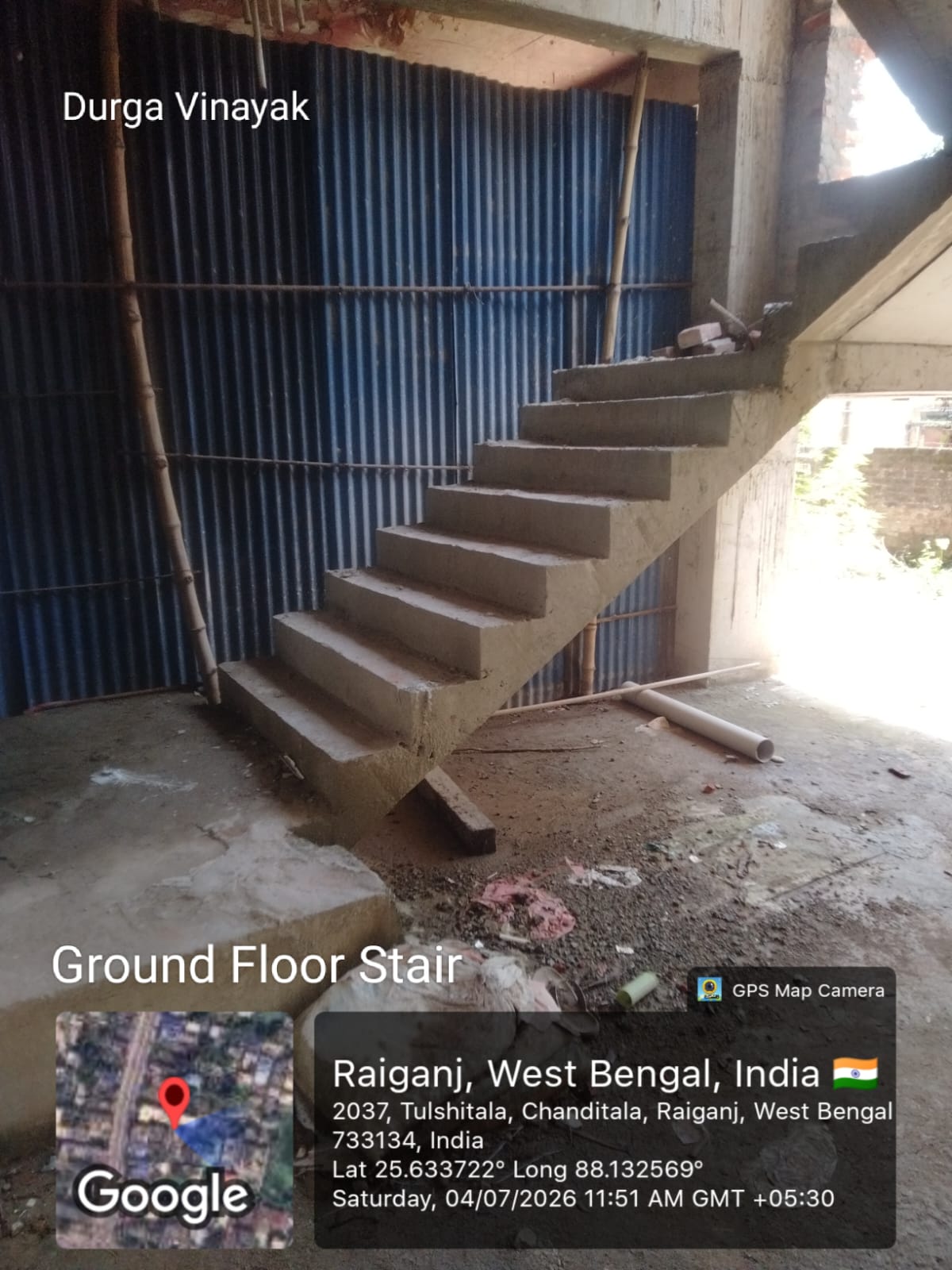

QUARTER [APRIL-JUNE 2026] GROUND FLOOR |
|

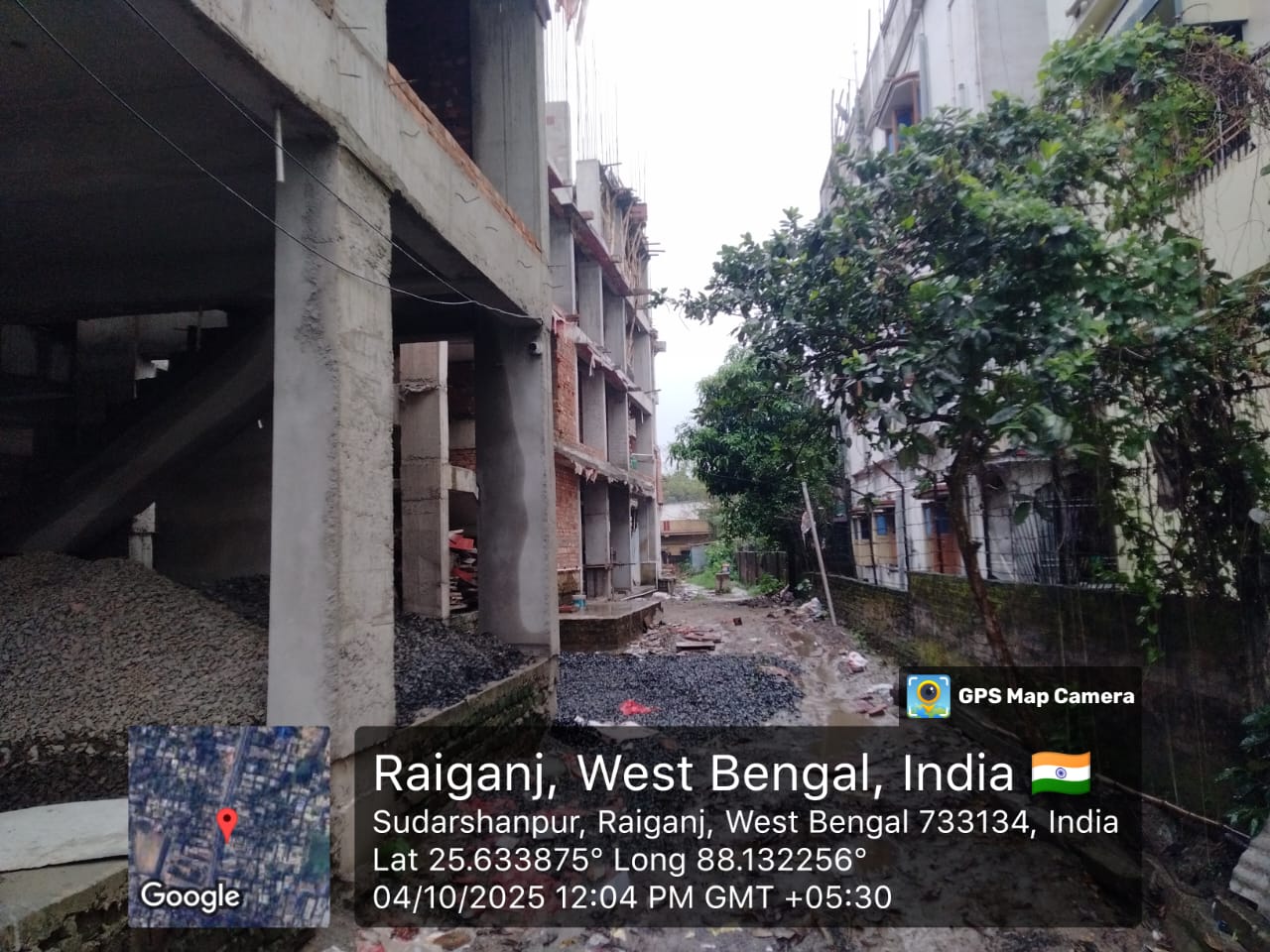

| 16 |

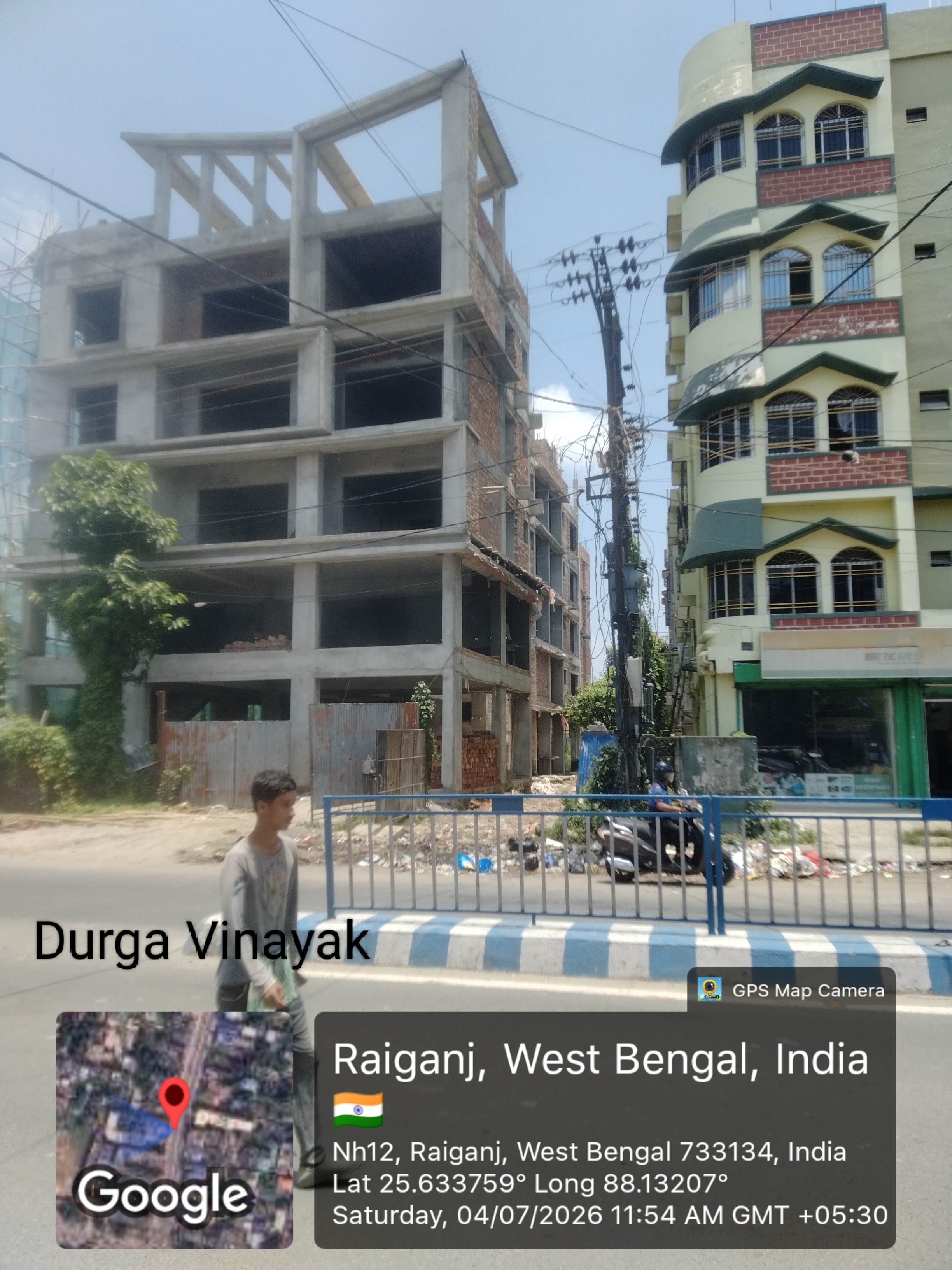

Under Construction |
OVERALL CONSTRUCTION PHOTO |
|
