WEST BENGAL REAL ESTATE REGULATORY AUTHORITY

WBRERA

New Please be informed that the last date for Quarterly Update of Registered Projects has been extended as per the order enclosed herewith. Click here to view the order ;  All promoters are directed to comply with the order of WBRERA vide no. 1986-RERA/L-01/2023 dated 06.12.2024 regarding Quarterly Update of Registered Projects and other instructions mentioned in the said order. Click here to view the order

ASHAVARI ESTATE PHASE I

Project Status as on Quarter ending 31-12-2024
Updated as on 18-01-2025

Booking Status

  • Residential Apartments Booked
    59

  • Basement Parking Booked
    Not mentioned

  • Covered Car Parking Booked
    Not mentioned

  • Mechanical Parking Booked
    Not mentioned

Status of construction of each building/floor with photographs

Block/Building Floor Construction Status Download
Tower A 1 Under Construction
Tower A 2 Not Started
Tower A 3 Under Construction
Tower A 4 Not Started
Tower A 5 Not Started
Tower A 6 Not Started
Tower A 7 Not Started
Tower A 8 Not Started
Tower A 9 Not Started
Tower A 10 Not Started
Tower A 11 Not Started
Tower A 12 Not Started
Tower A 13 Not Started
Tower B 1 Under Construction
Tower B 2 Under Construction
Tower B 3 Under Construction
Tower B 4 Under Construction
Tower B 5 Not Started
Tower B 6 Not Started
Tower B 7 Not Started
Tower B 8 Not Started
Tower B 9 Not Started
Tower B 10 Not Started
Tower B 11 Not Started
Tower B 12 Not Started
Tower B 13 Not Started
Tower C 1 Not Started
Tower C 2 Not Started
Tower C 3 Not Started
Tower C 4 Not Started
Tower C 5 Not Started
Tower C 6 Not Started
Tower C 7 Not Started
Tower C 8 Not Started
Tower C 9 Not Started
Tower C 10 Not Started
Tower C 11 Not Started
Tower C 12 Not Started
Tower C 13 Not Started
Tower D 1 Not Started
Tower D 2 Not Started
Tower D 3 Not Started
Tower D 4 Not Started
Tower D 5 Not Started
Tower D 6 Not Started
Tower D 7 Not Started
Tower D 8 Not Started
Tower D 9 Not Started
Tower D 10 Not Started
Tower D 11 Not Started
Tower D 12 Not Started
Tower D 13 Not Started

Status of Construction of Internal Infrastructure with photographs

Sl No. Title Download
1 Fire Fighting Facilities
2 Emergency Evacuations
3 Water Facility

4 Boundary Wall, Main Gate & Guard Room

Status of Construction of Common Areas with photographs

Sl No. Construction Status Description Download
1 Not Started POWER BACKUP

2 Not Started STAIRS

3 Not Started LIFT

4 Not Started LOBBY
5 Not Started ROOF
6 Not Started SEPTIC TANK
7 Not Started UNDER-GROUND WATER RESERVOIR
8 Not Started OVERHEAD TANK

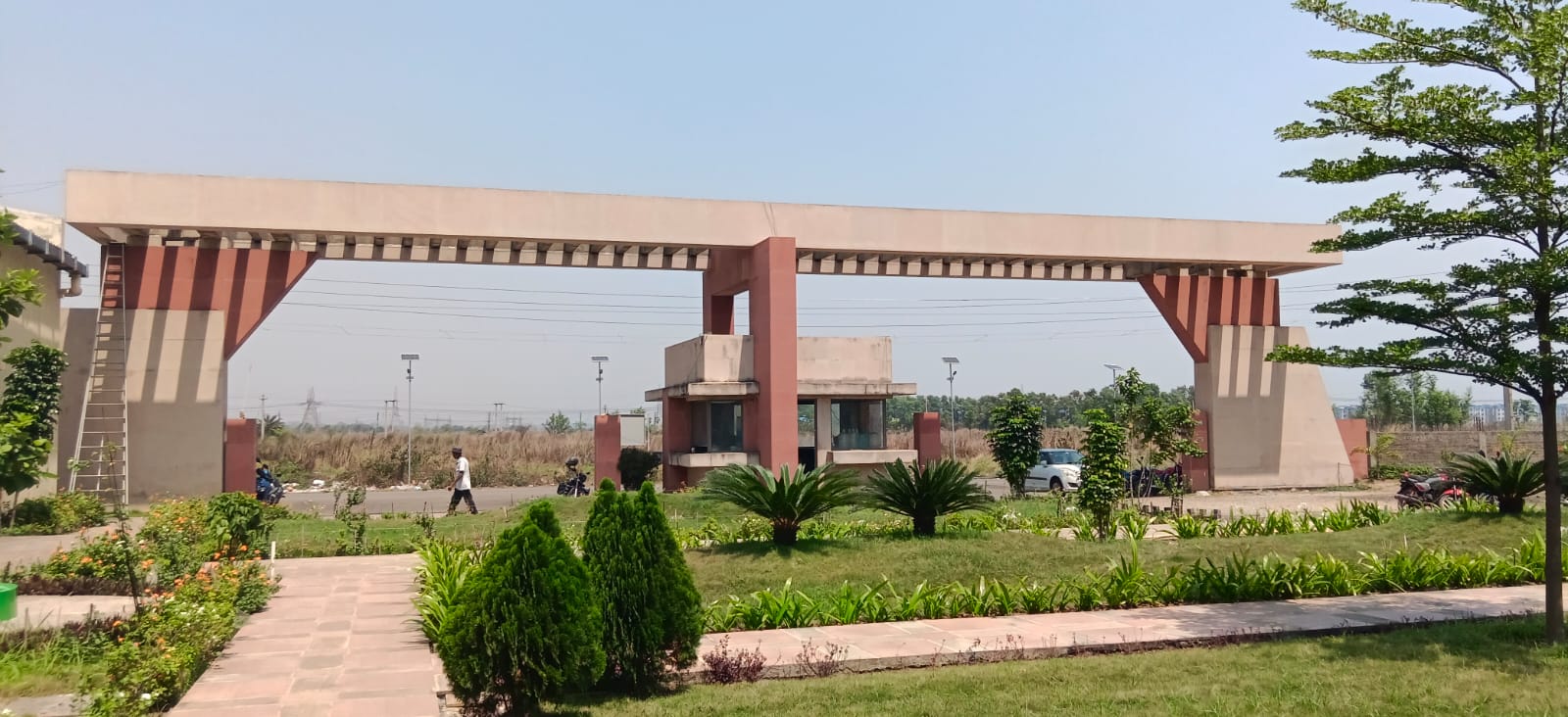

9 Under Construction MAIN GATE AND BOUNDARY WALL
10 Not Started CLUB
11 Not Started SKYWALK
12 Not Started SOLAR LIGHTING

Approval for NOC

Approved Document Approval Applied Approval Expected Approval Received Modifications Download
