New Please be informed that the The last date for submission of Quarterly Update of Registered Real Estate Projects is hereby extended tillĀ 28.02.2025 as per the order enclosed herewith. Click here to view the order ;  All promoters are directed to comply with the order of WBRERA vide no. 1986-RERA/L-01/2023 dated 06.12.2024 regarding Quarterly Update of Registered Projects and other instructions mentioned in the said order. Click here to view the order

RISHI PRANAYA PHASE II

Project Status as on Quarter ending 31-12-2024
Updated as on 16-01-2025

Booking Status

  • Residential Apartments Booked
    263

  • Basement Parking Booked
    177

  • Covered Car Parking Booked
    40

  • Mechanical Parking Booked
    Not mentioned

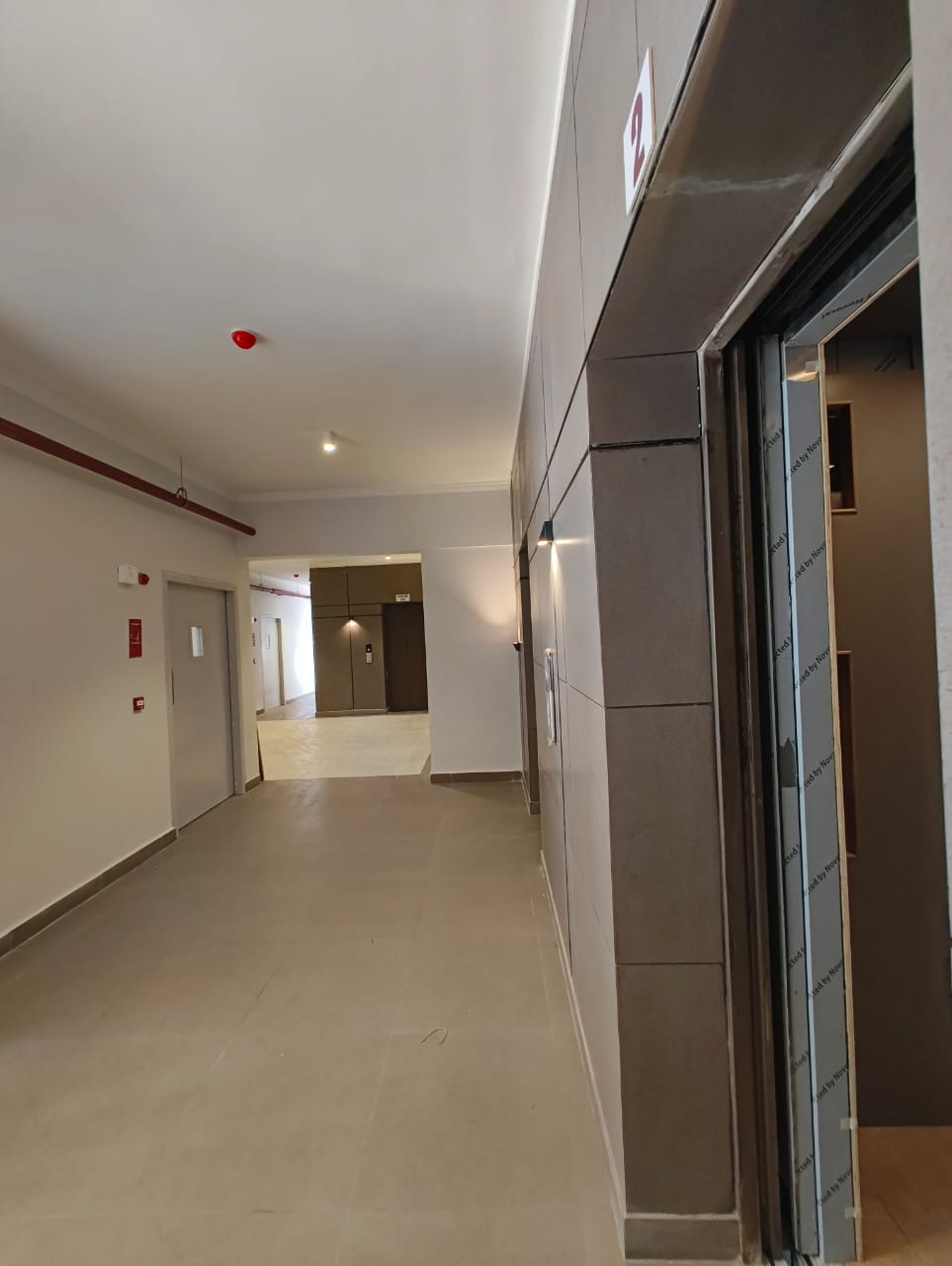

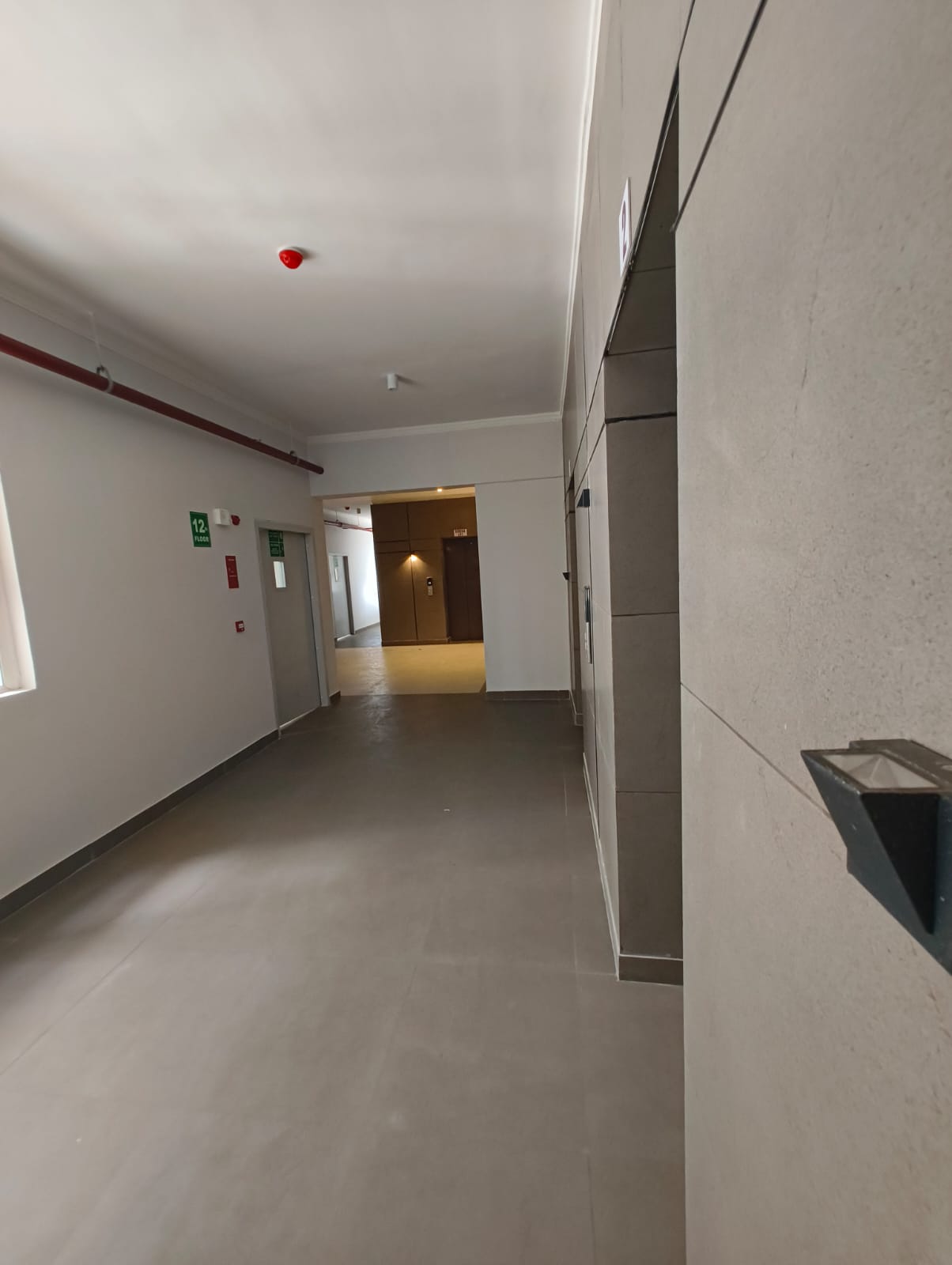

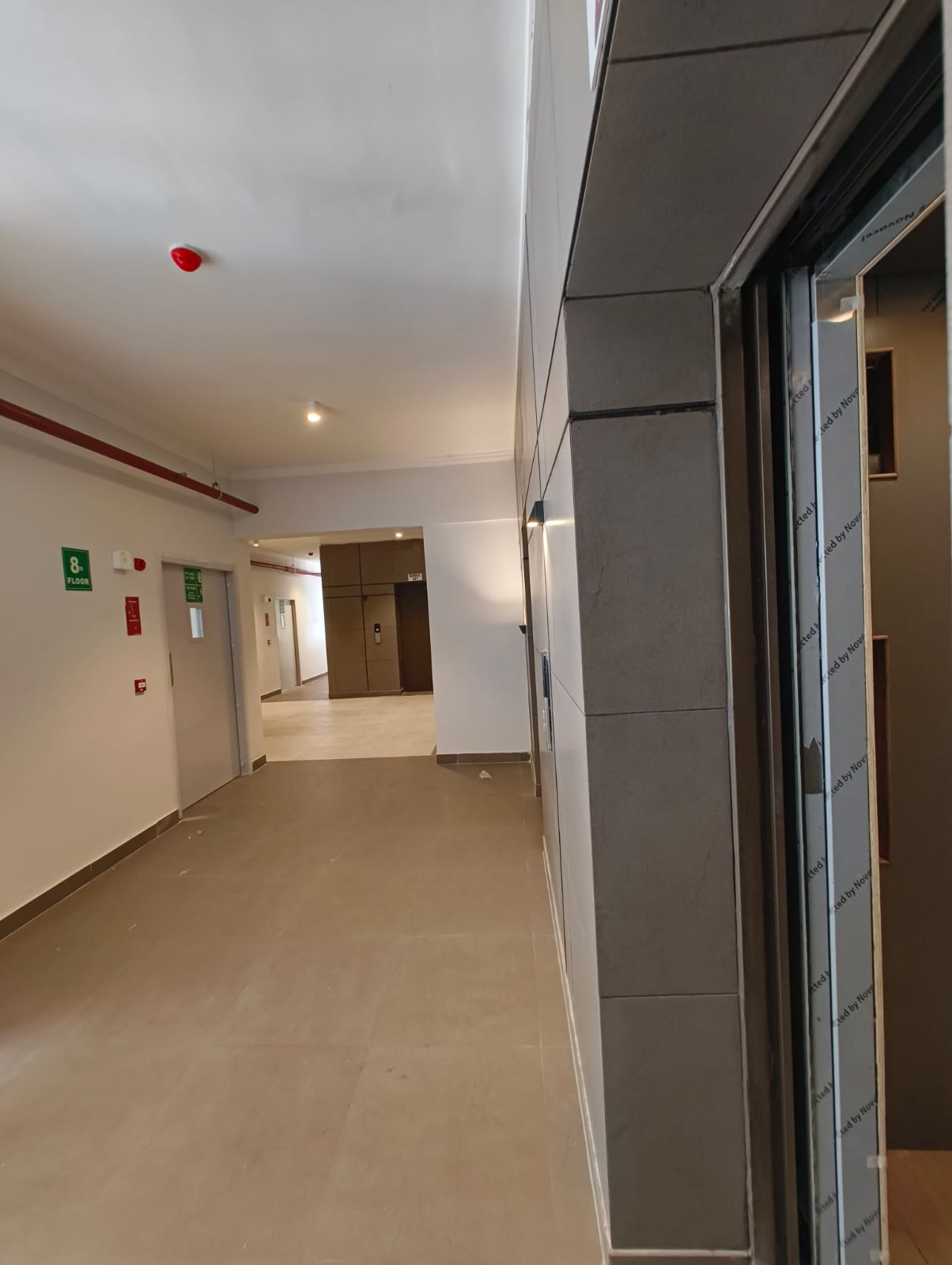

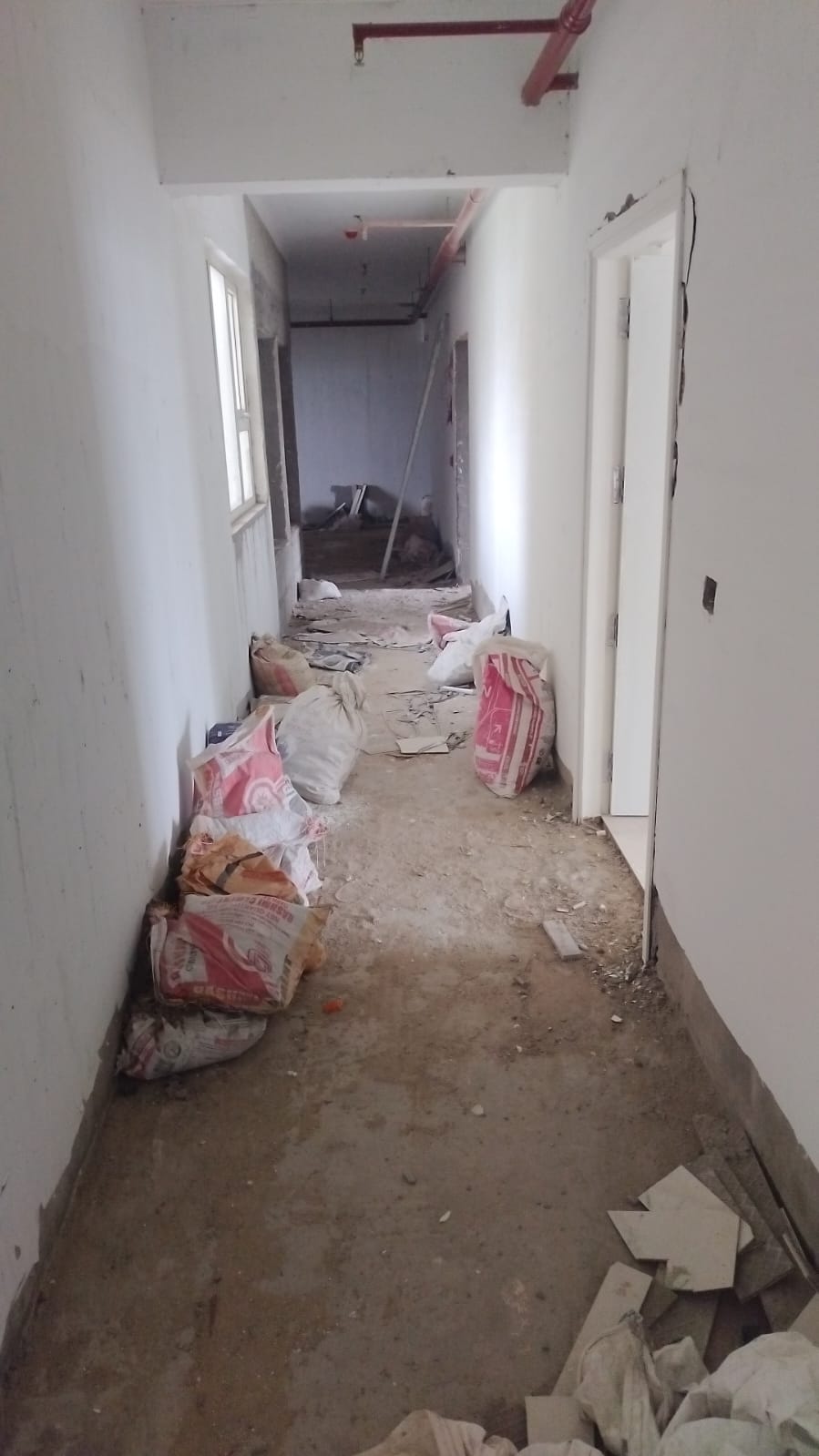

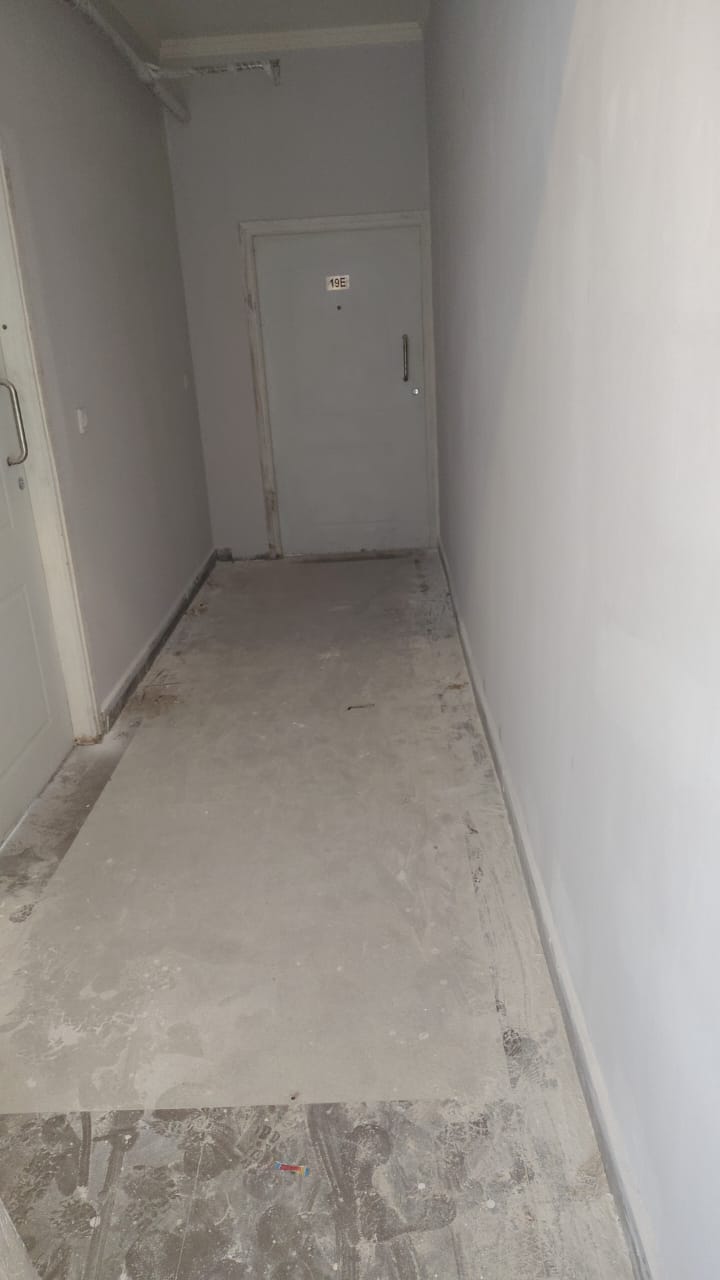

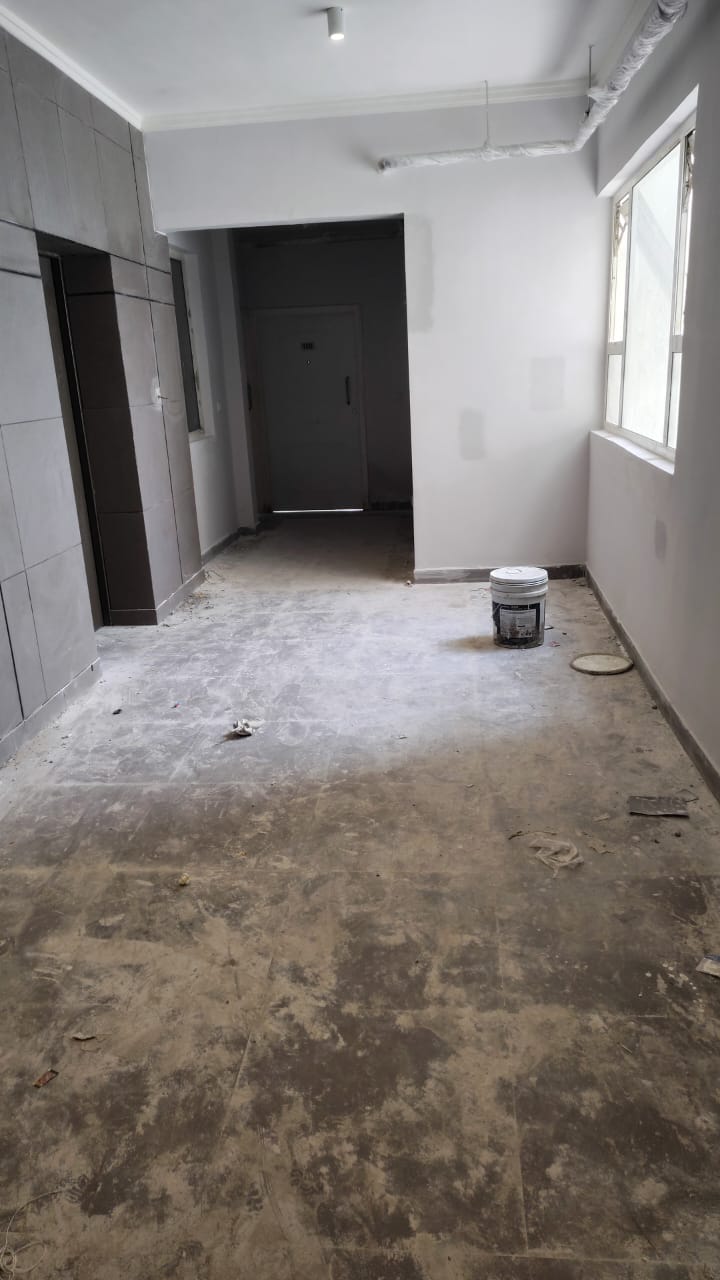

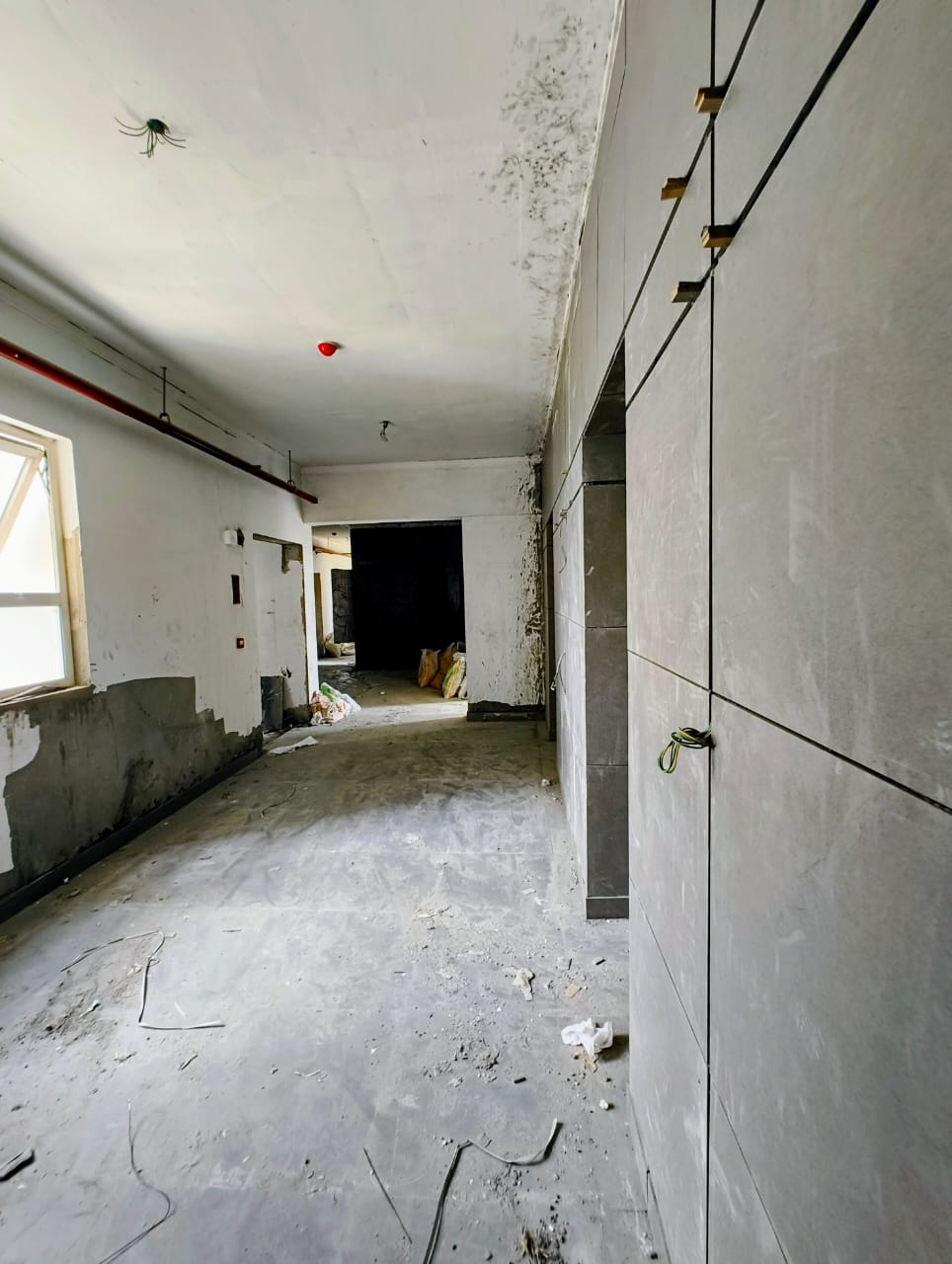

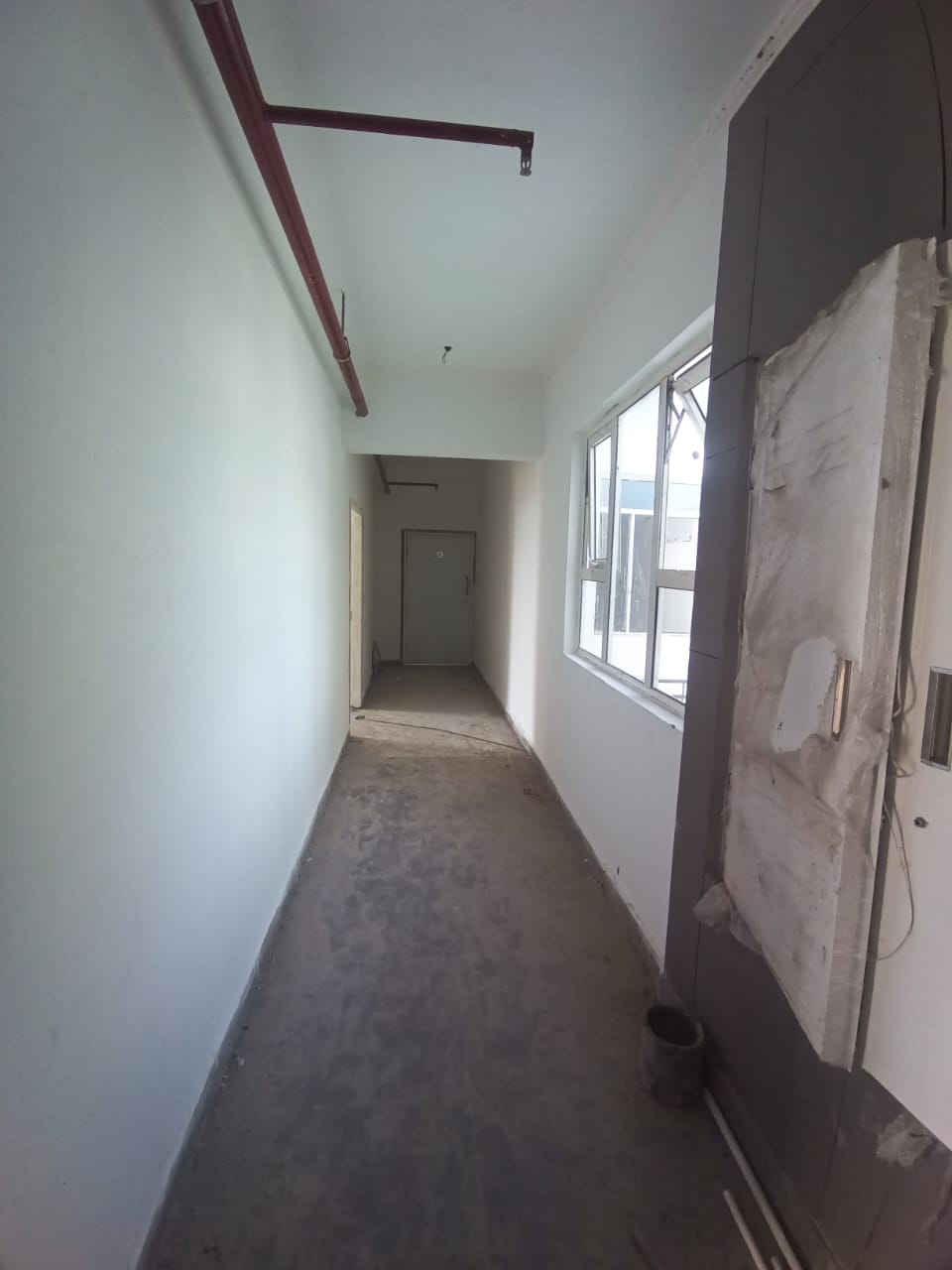

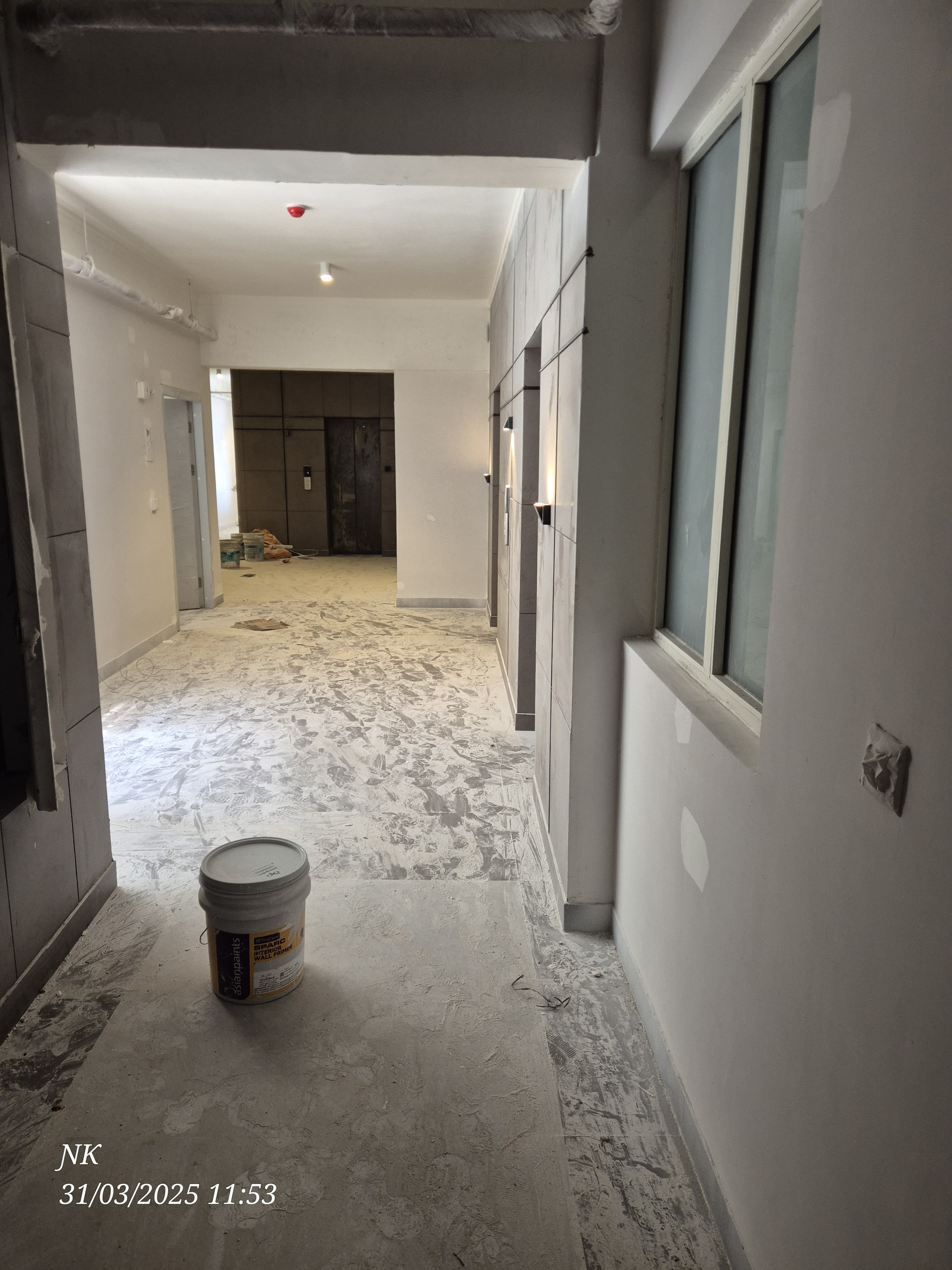

Status of construction of each building/floor with photographs

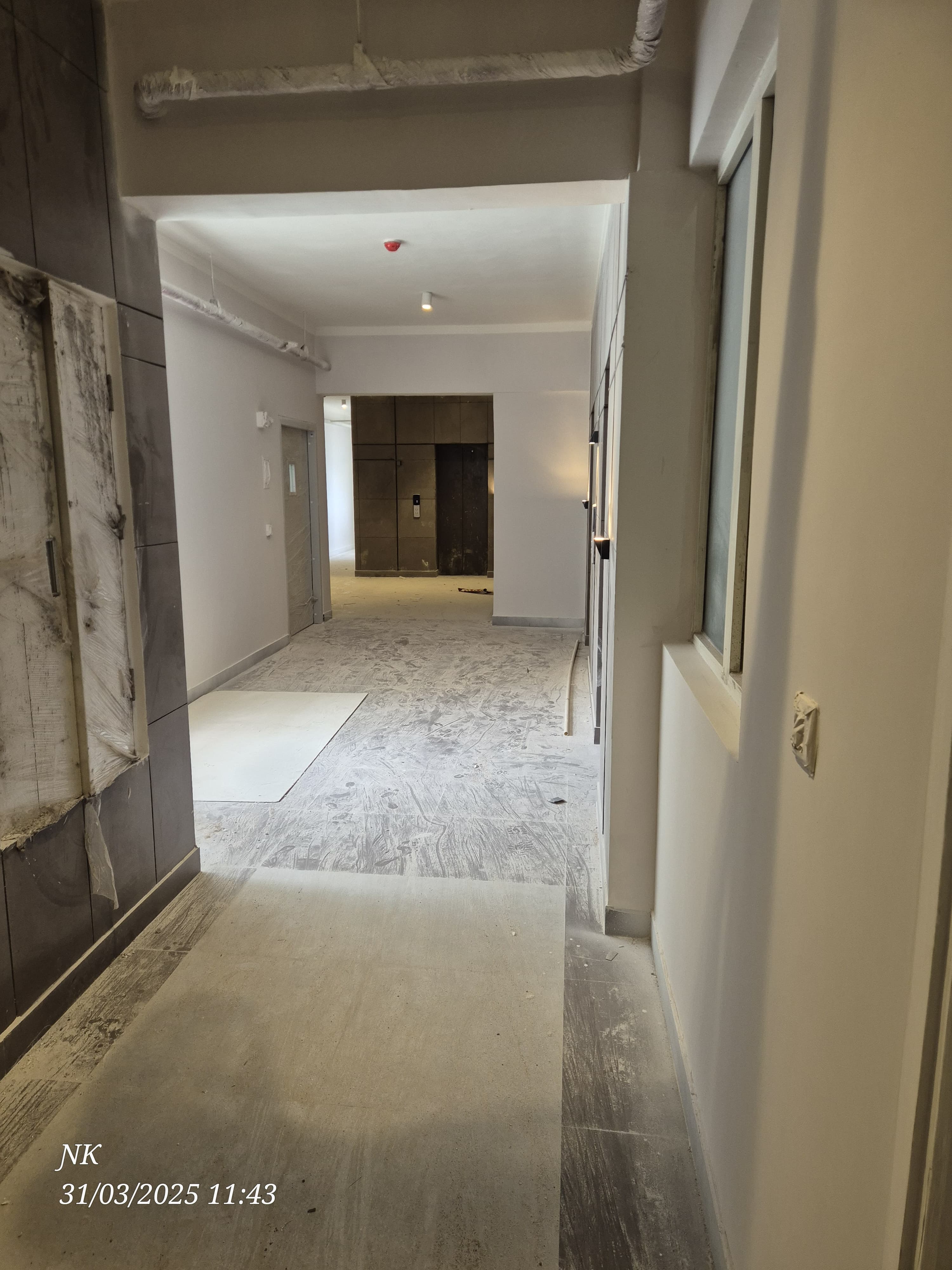

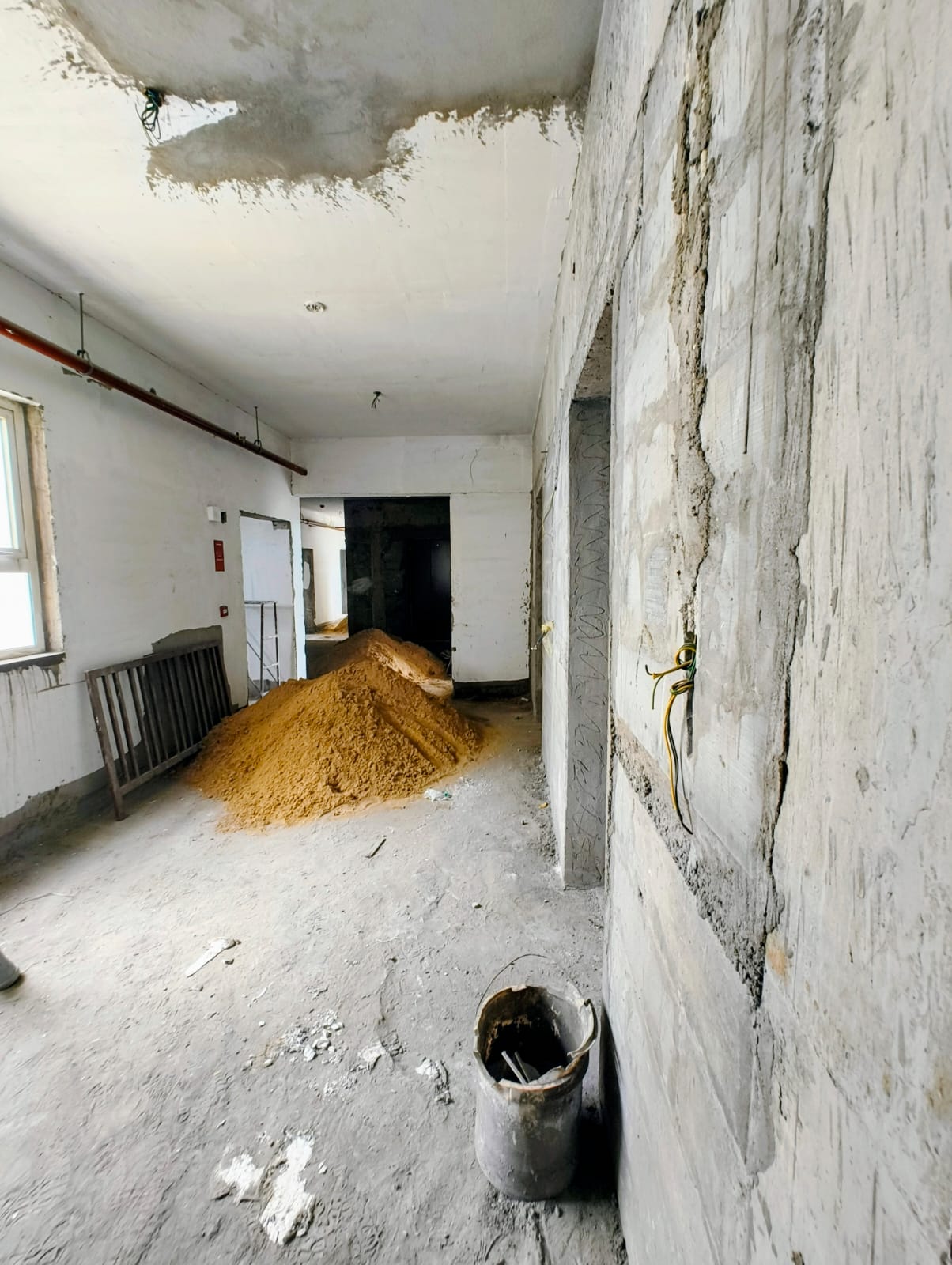

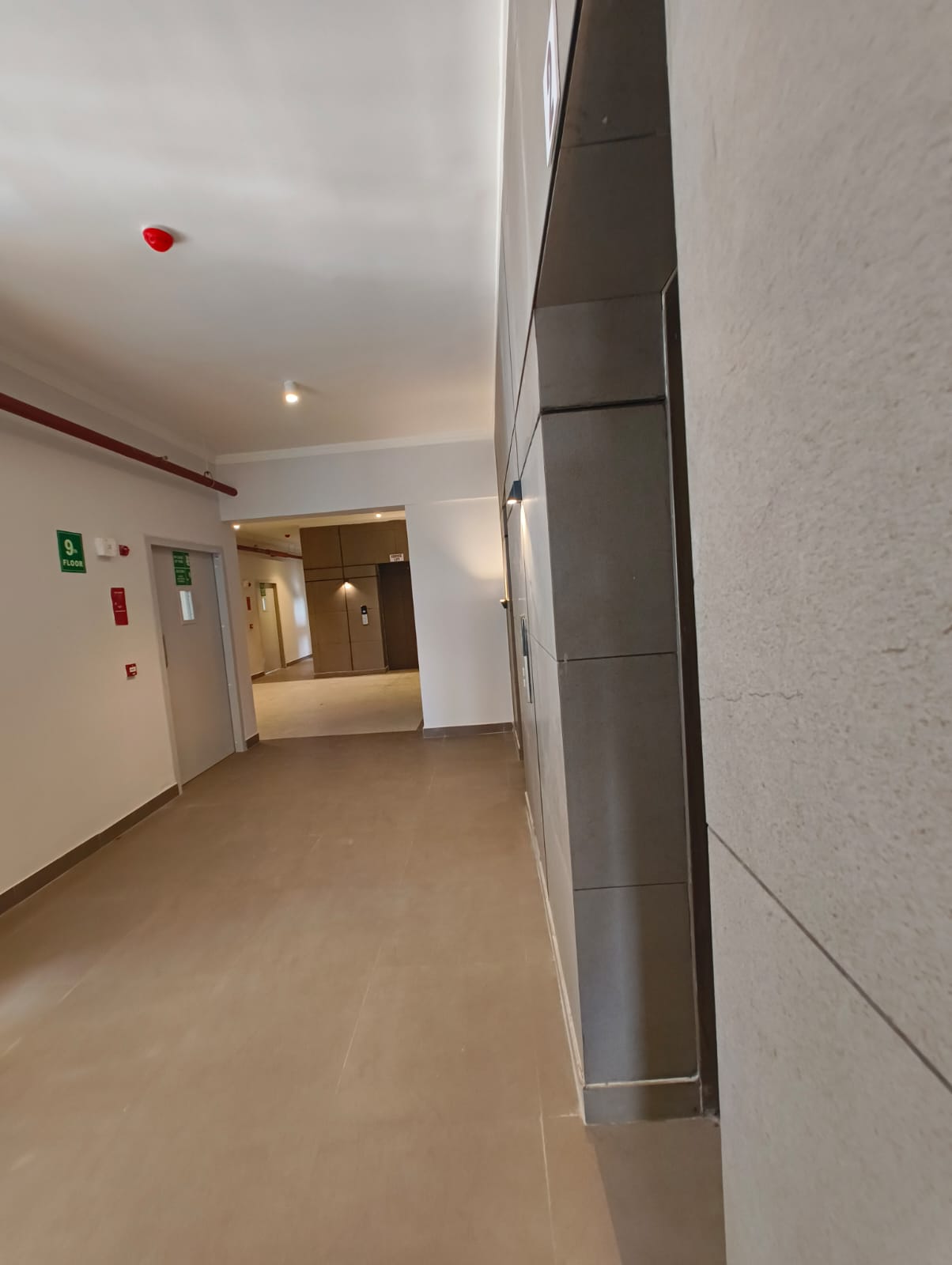

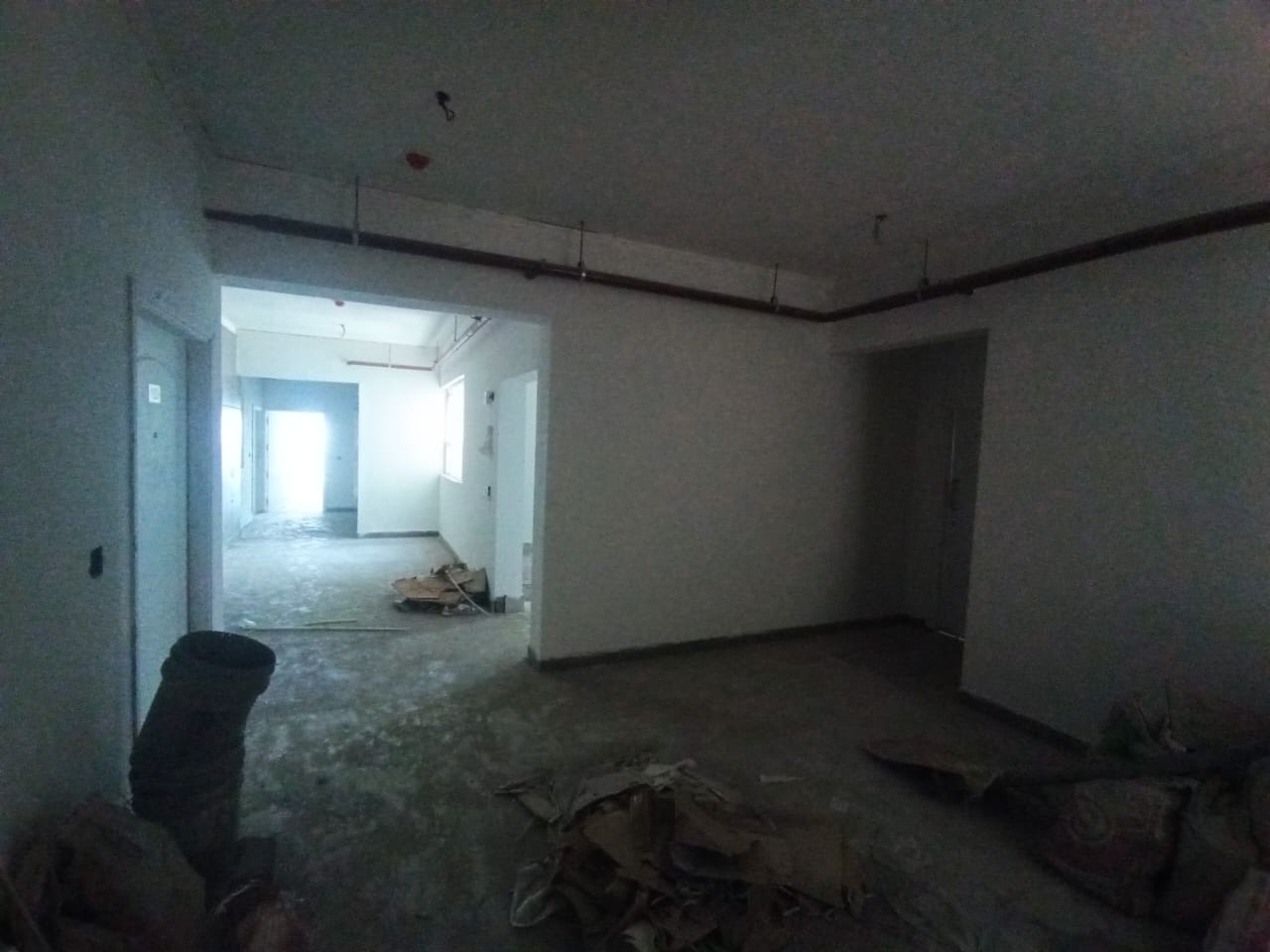

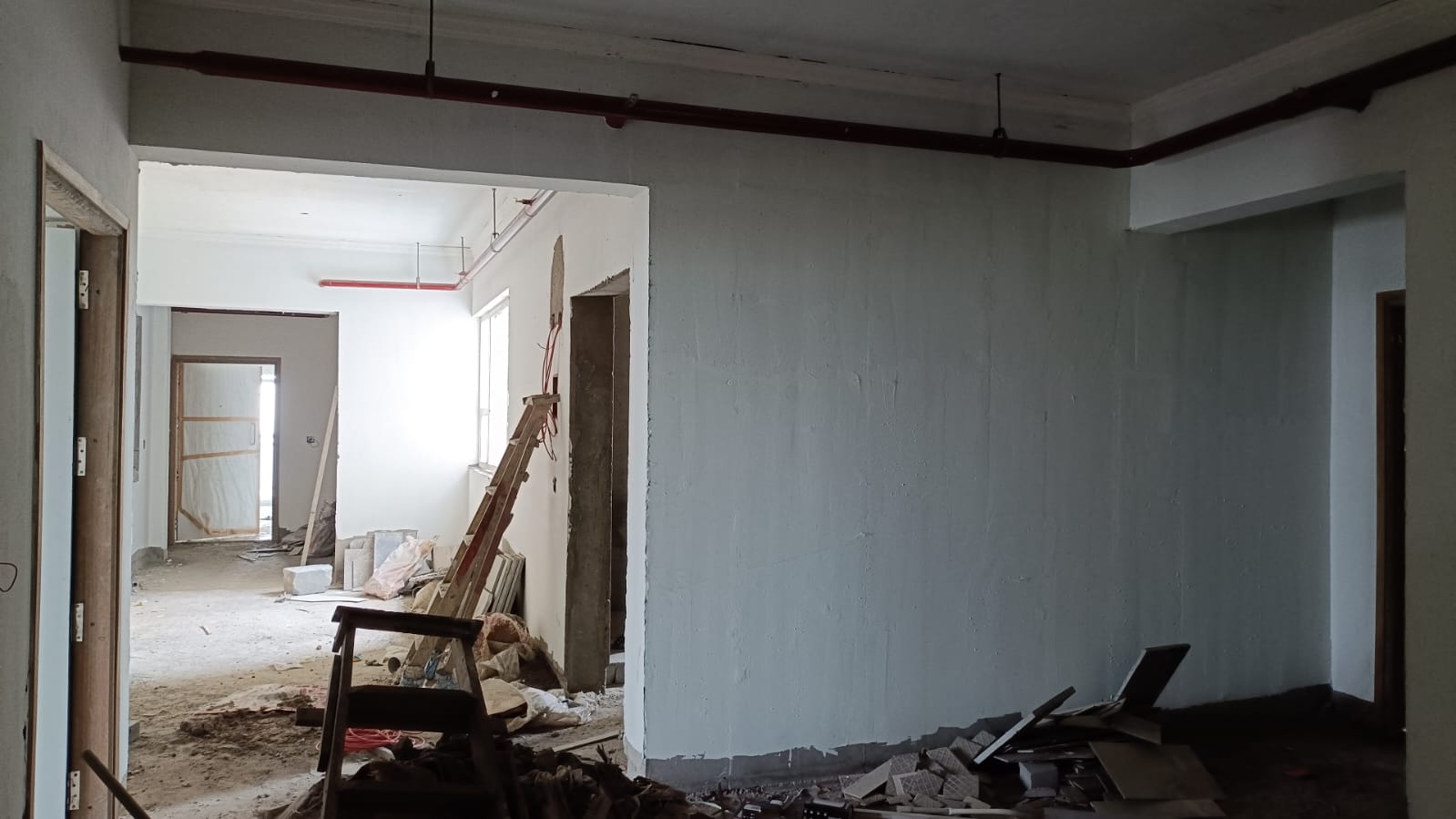

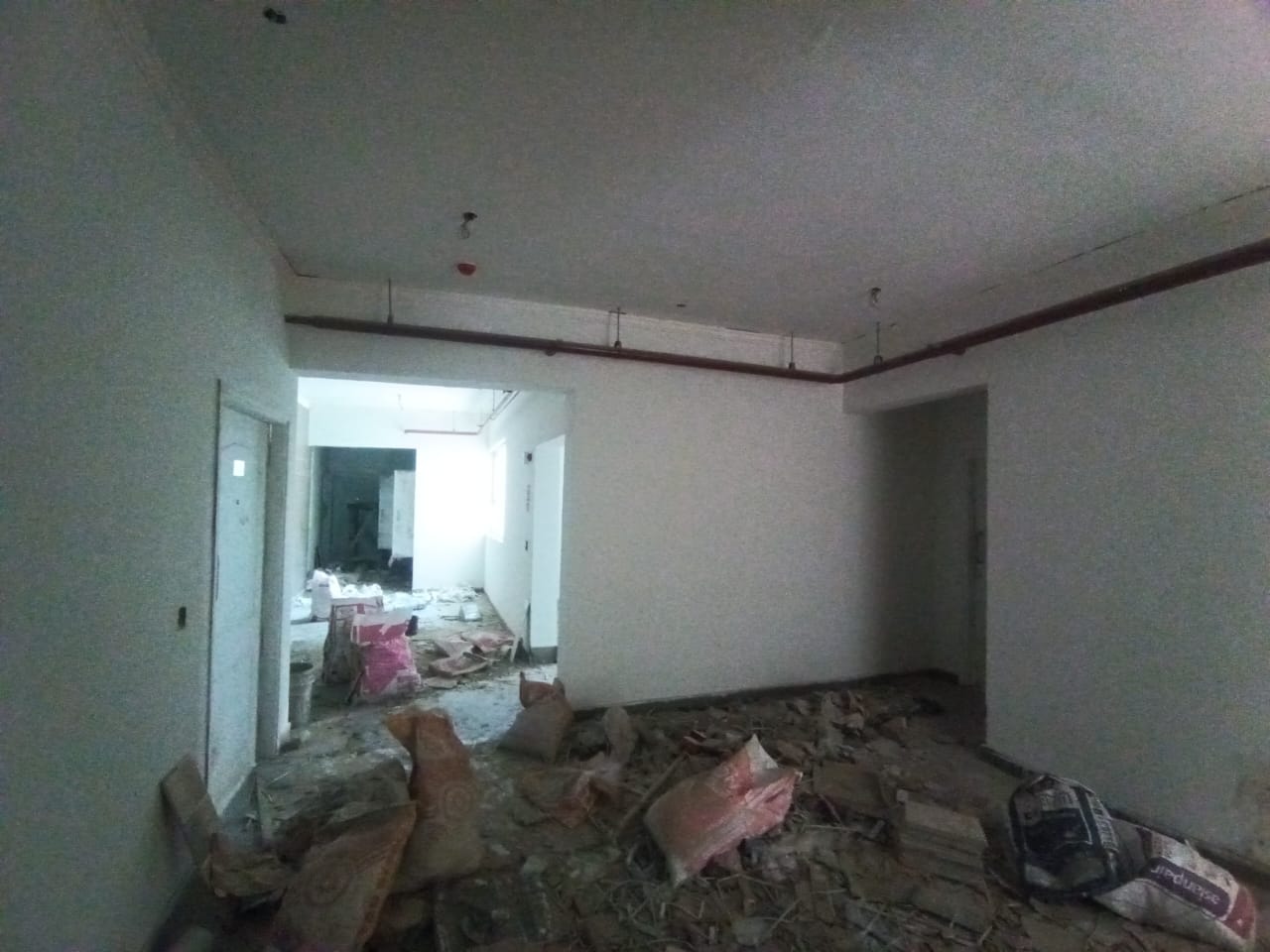

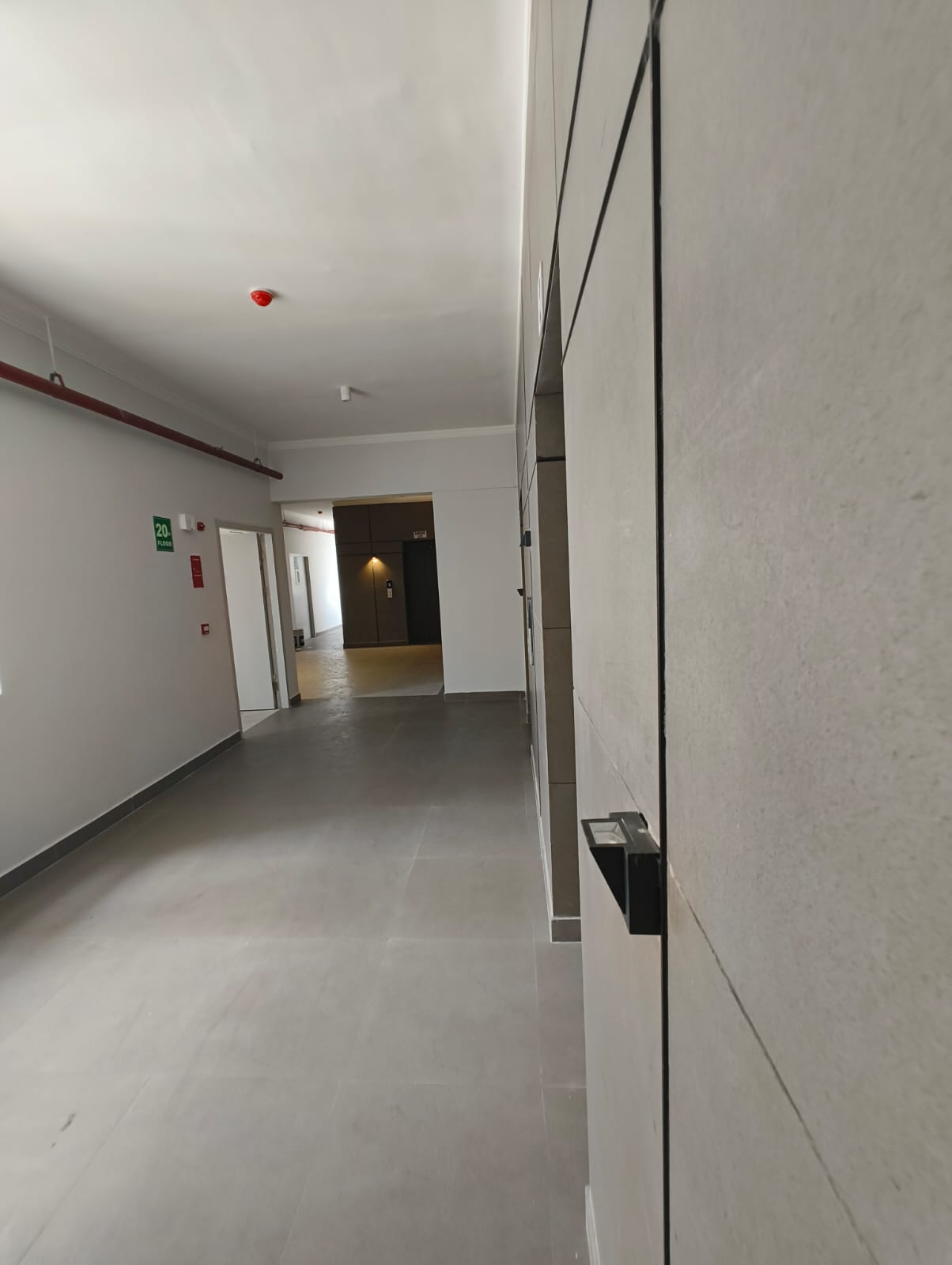

Block/Building Floor Construction Status Download

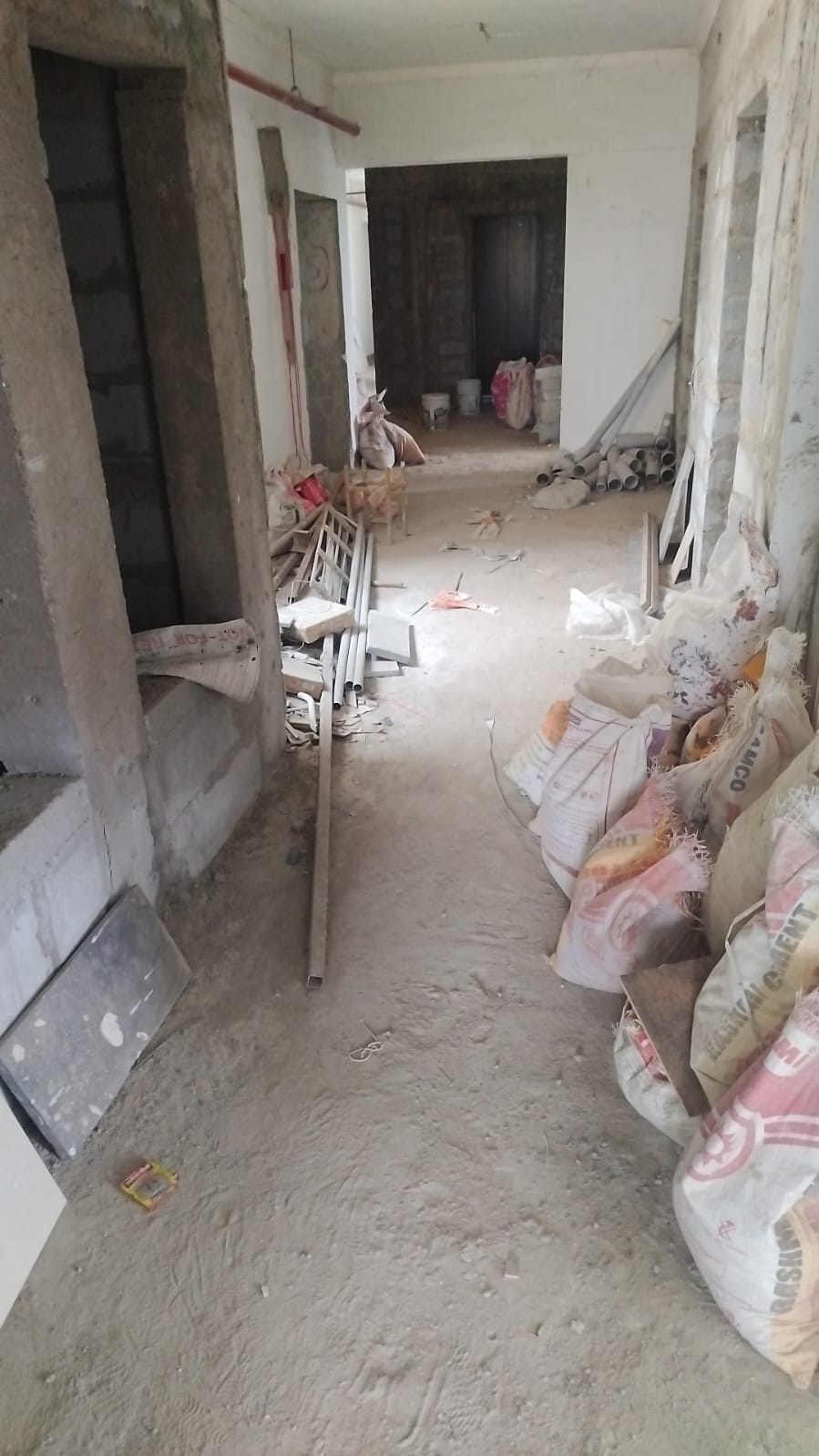

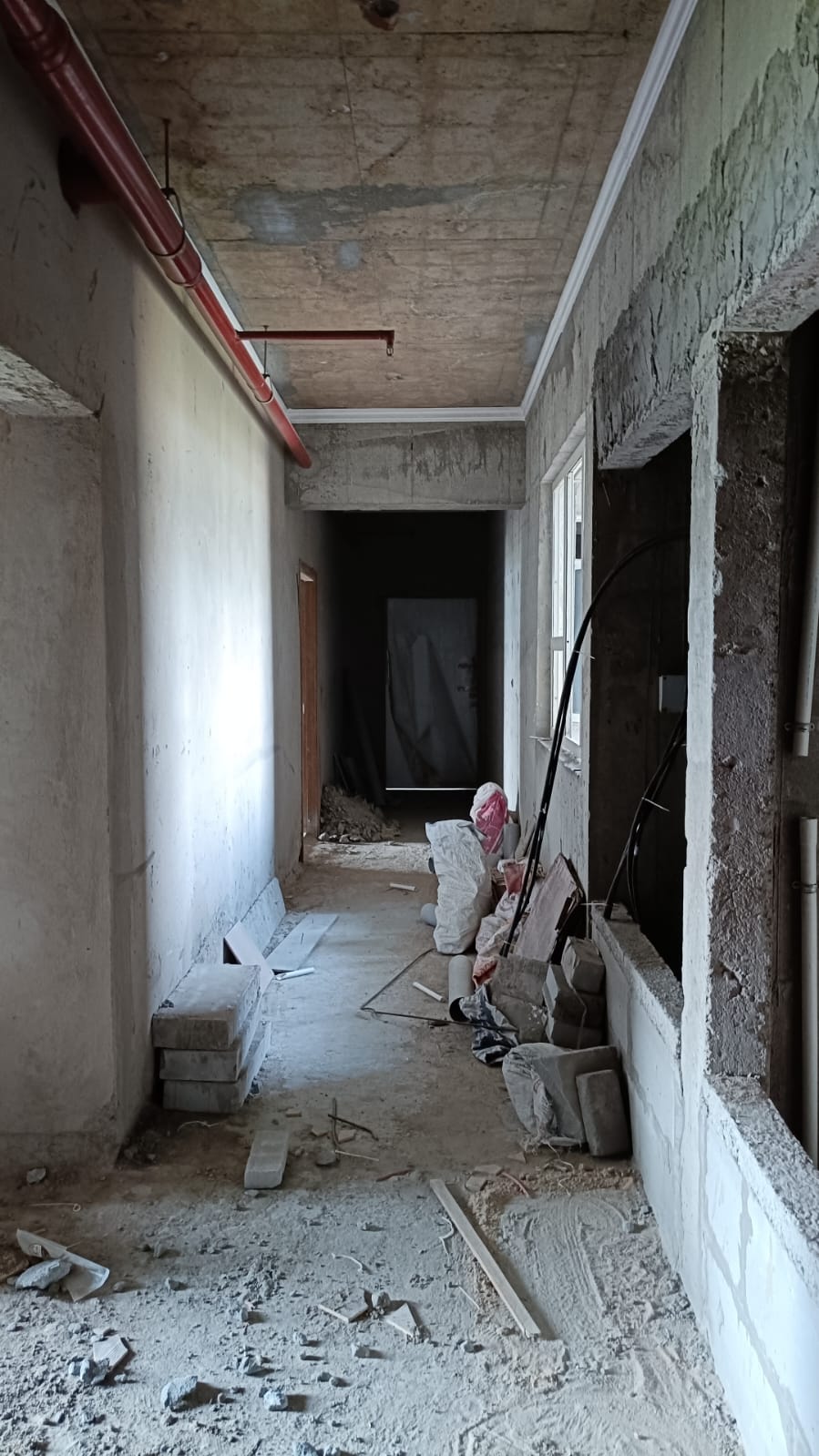

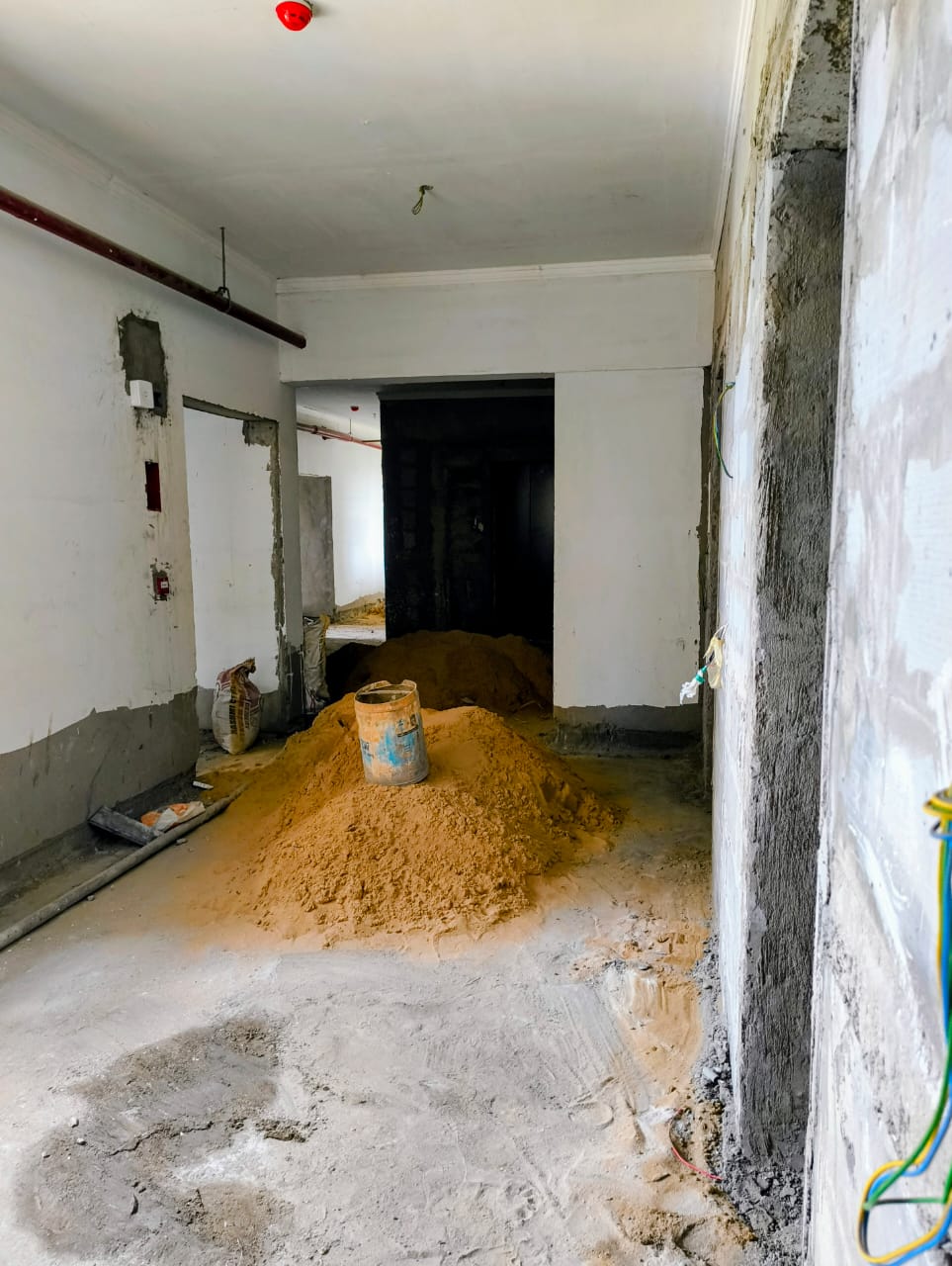

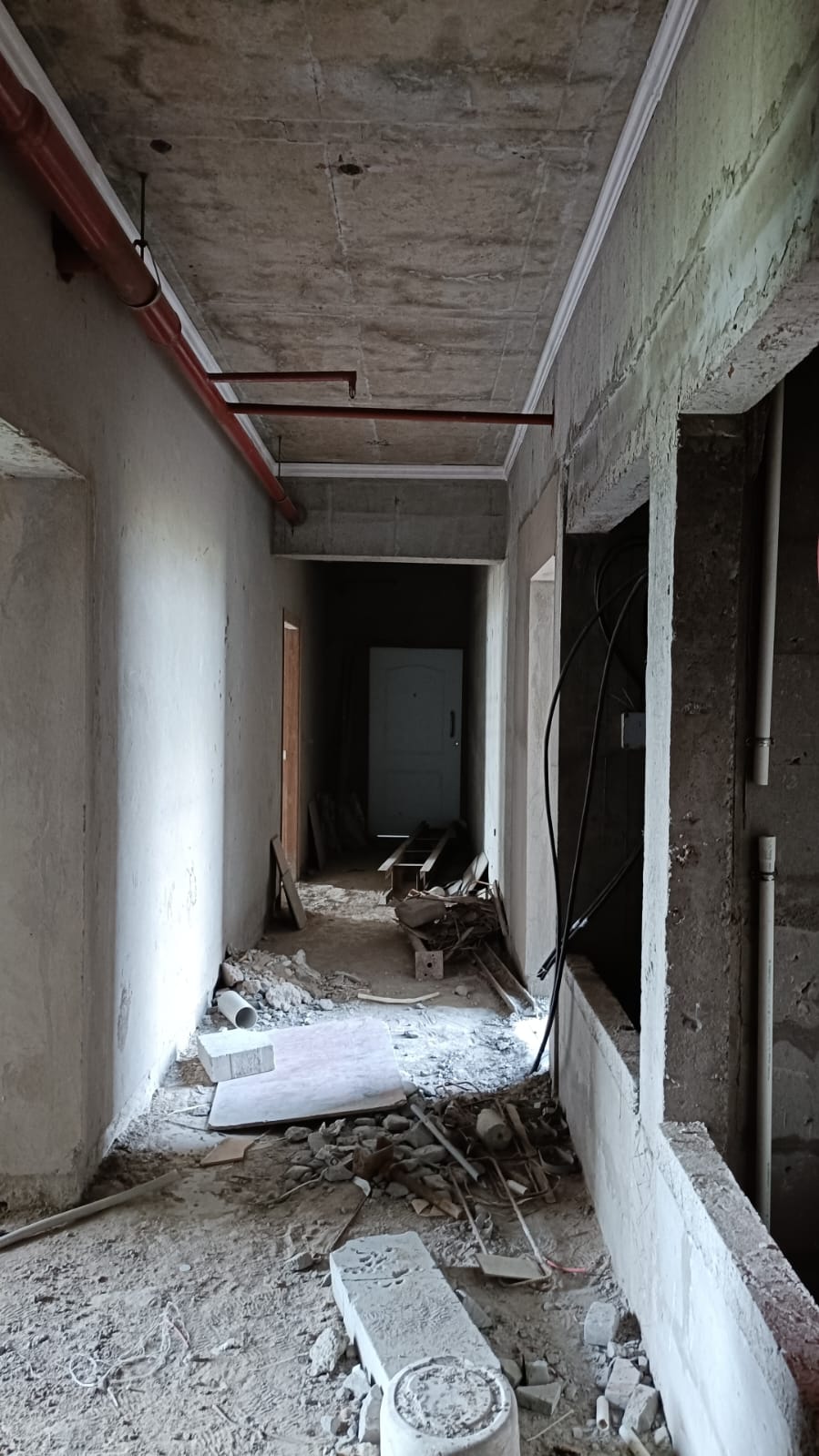

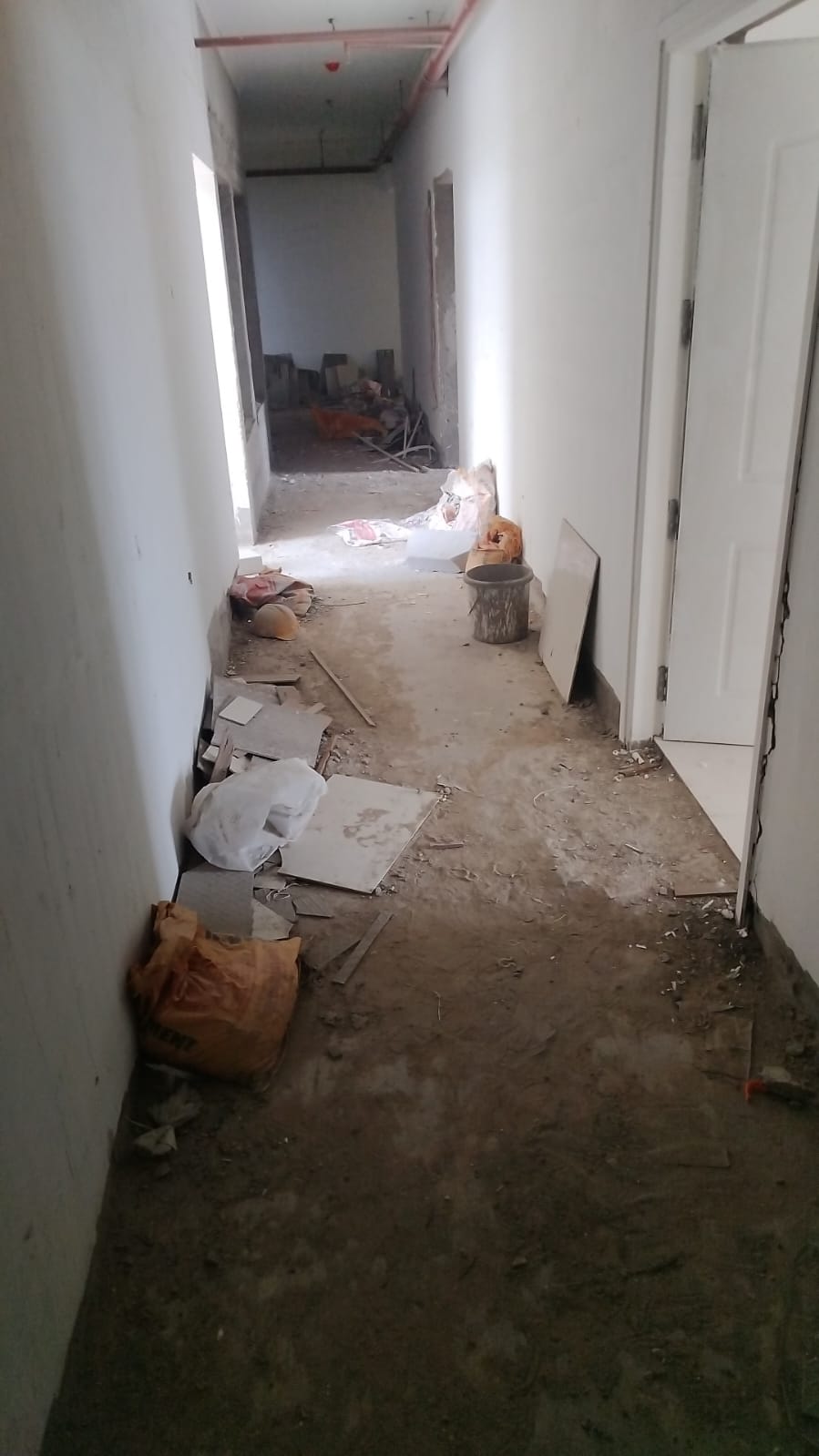

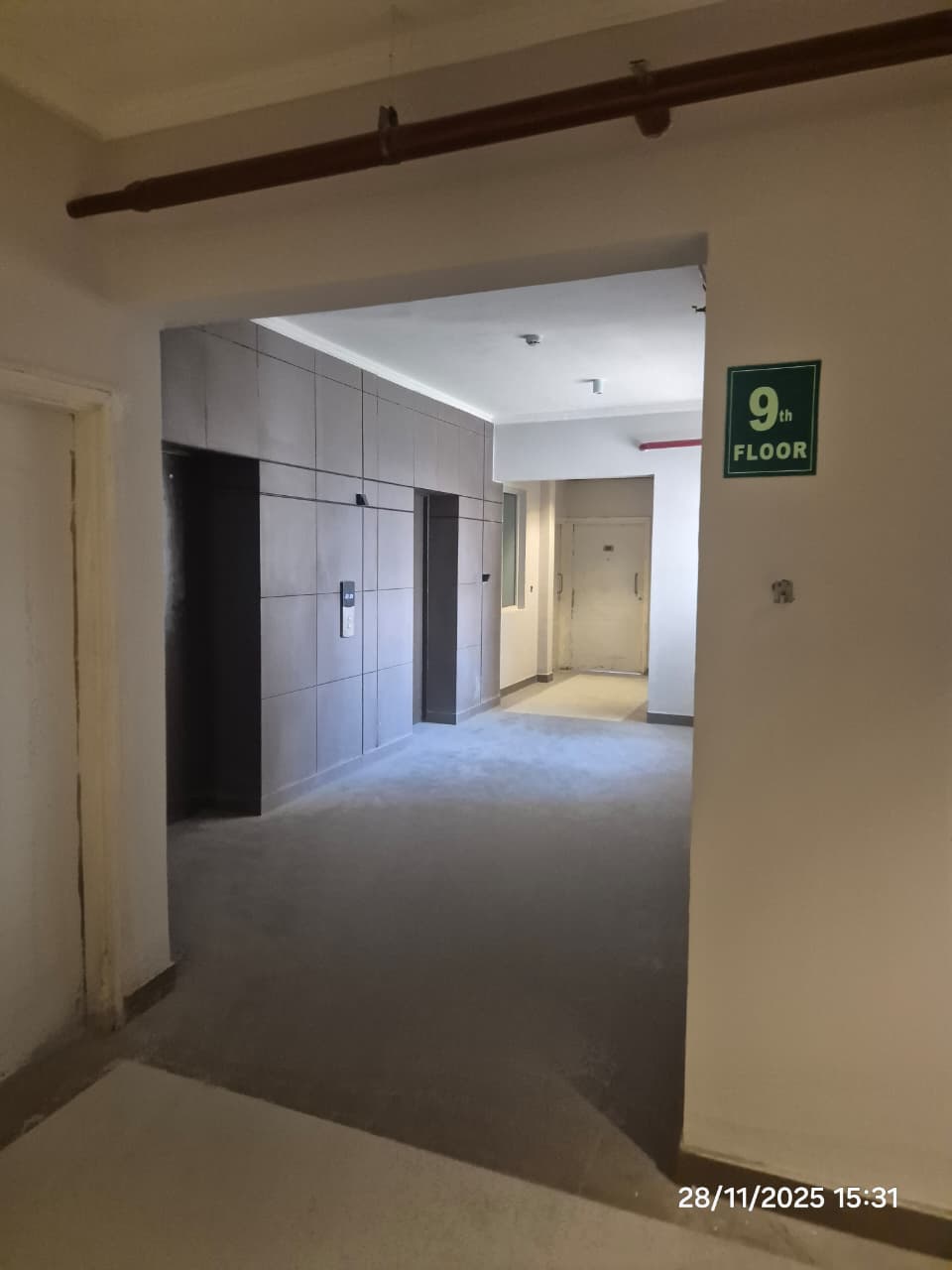

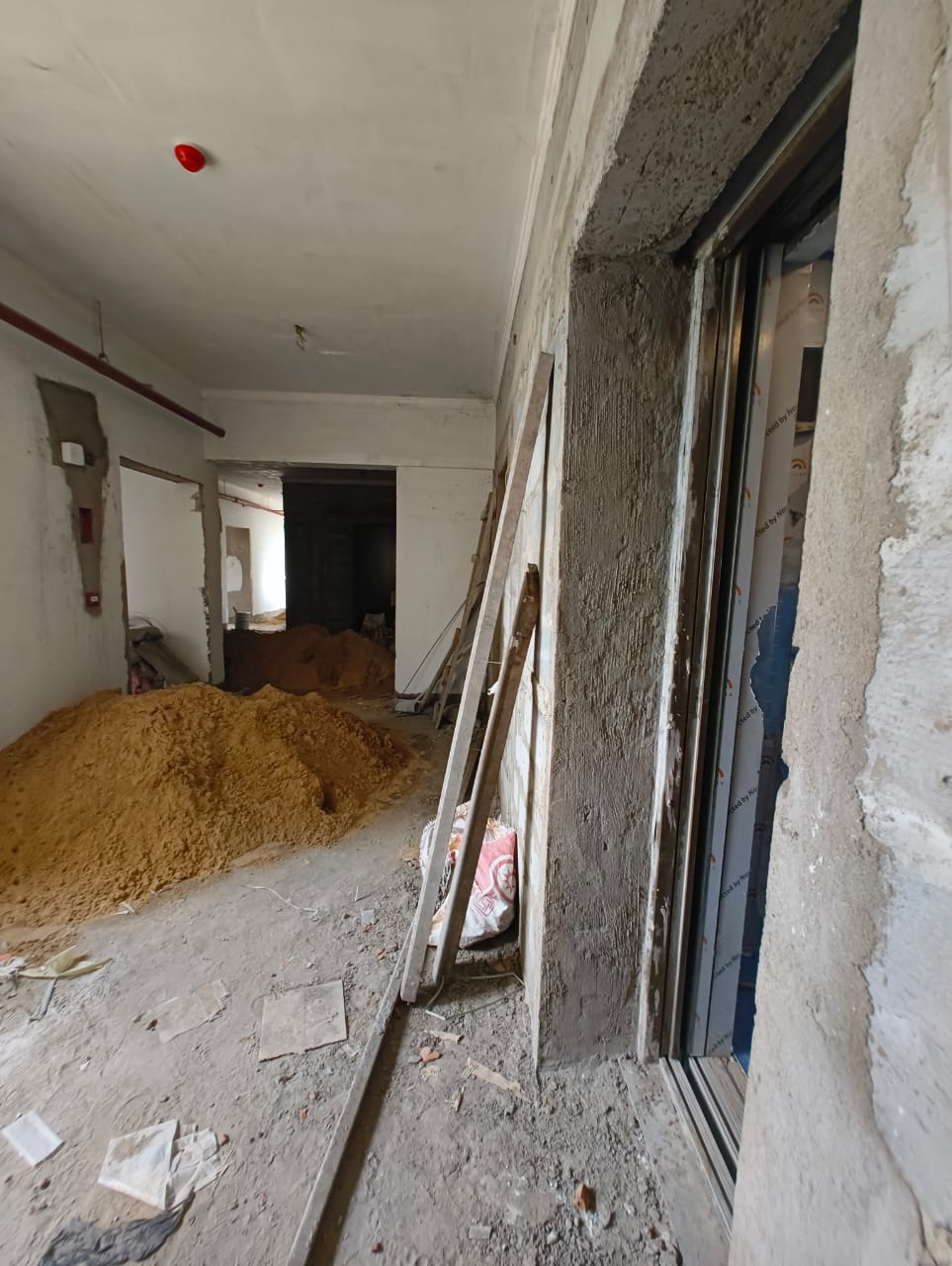

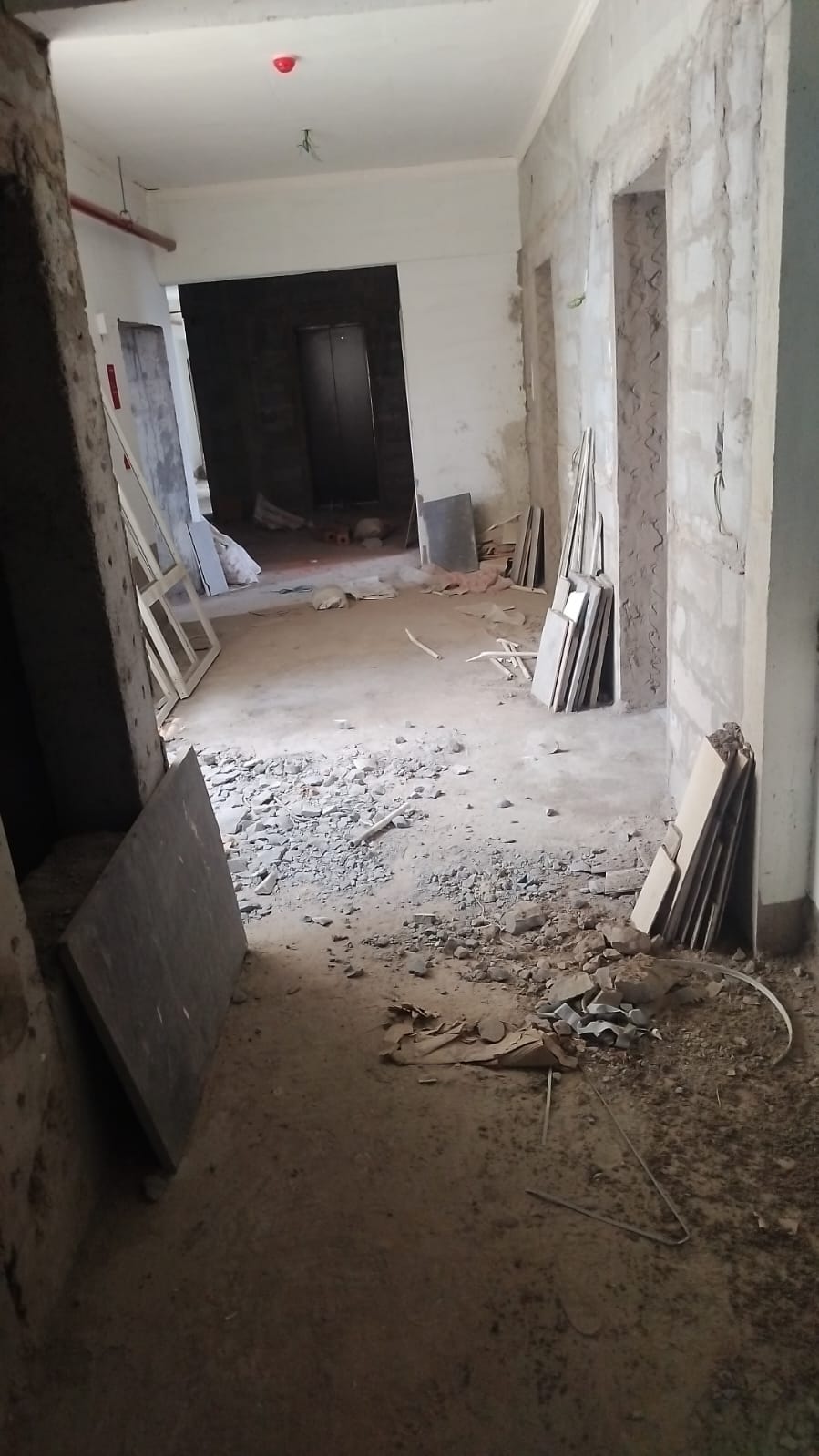

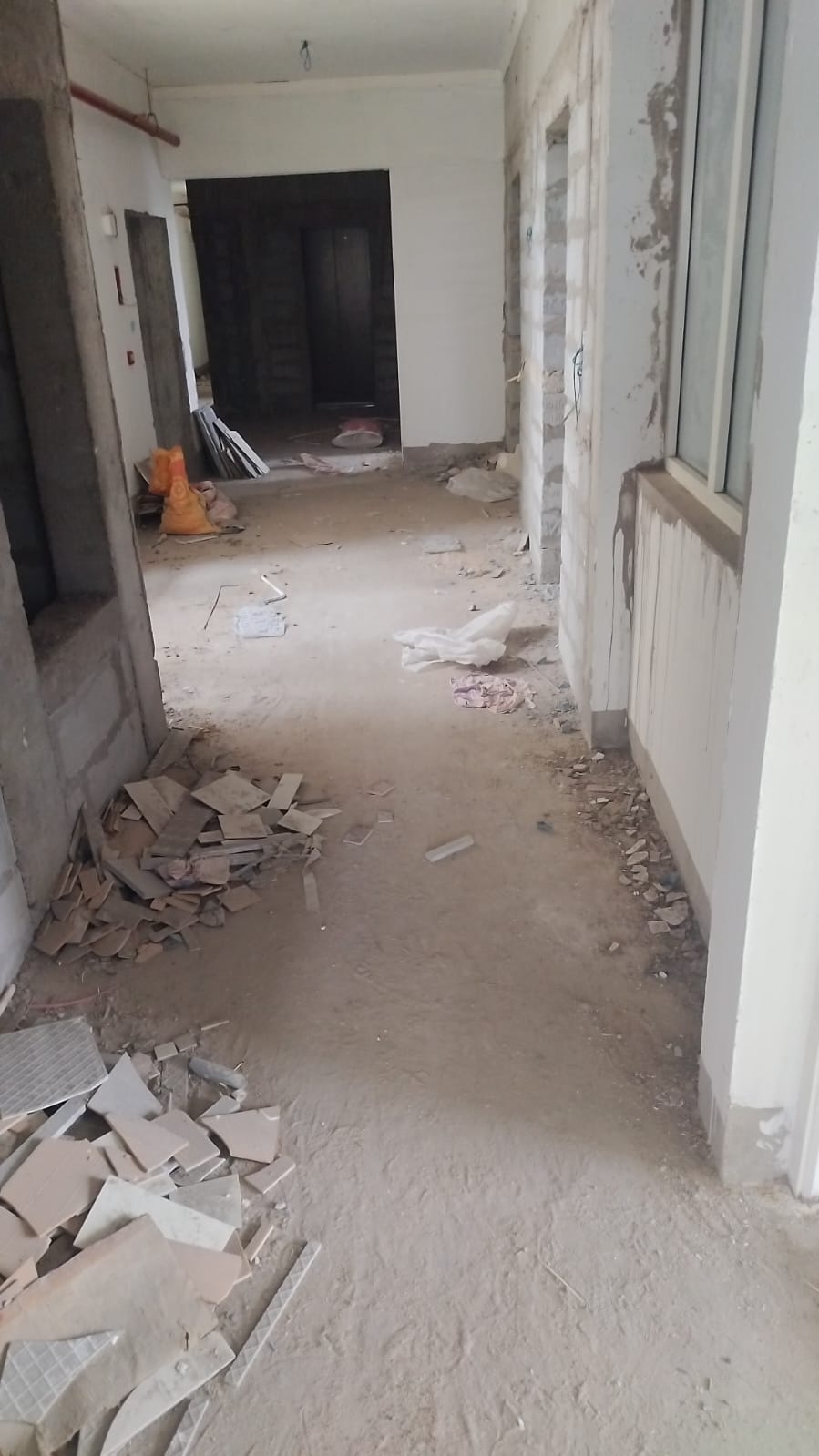

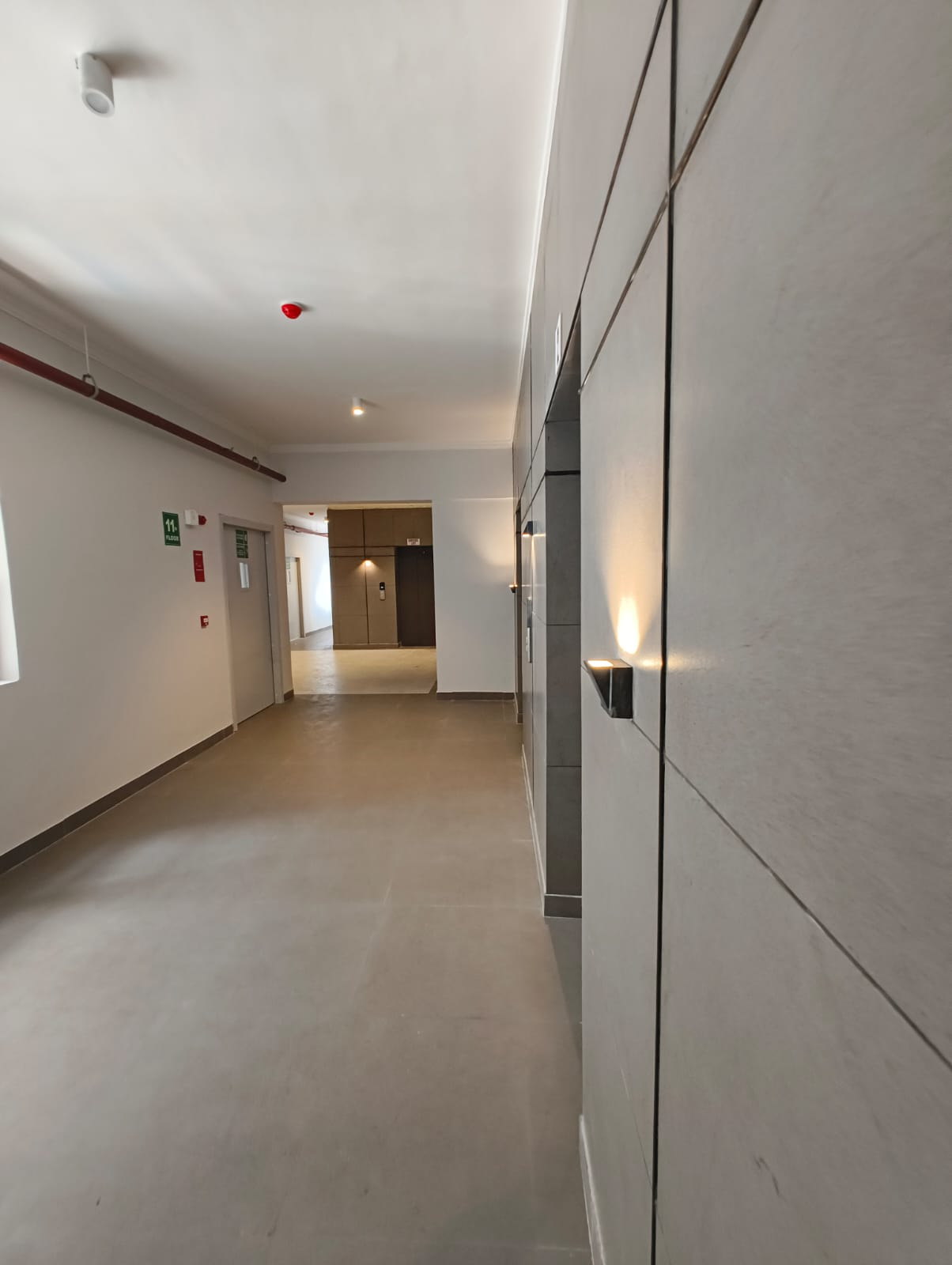

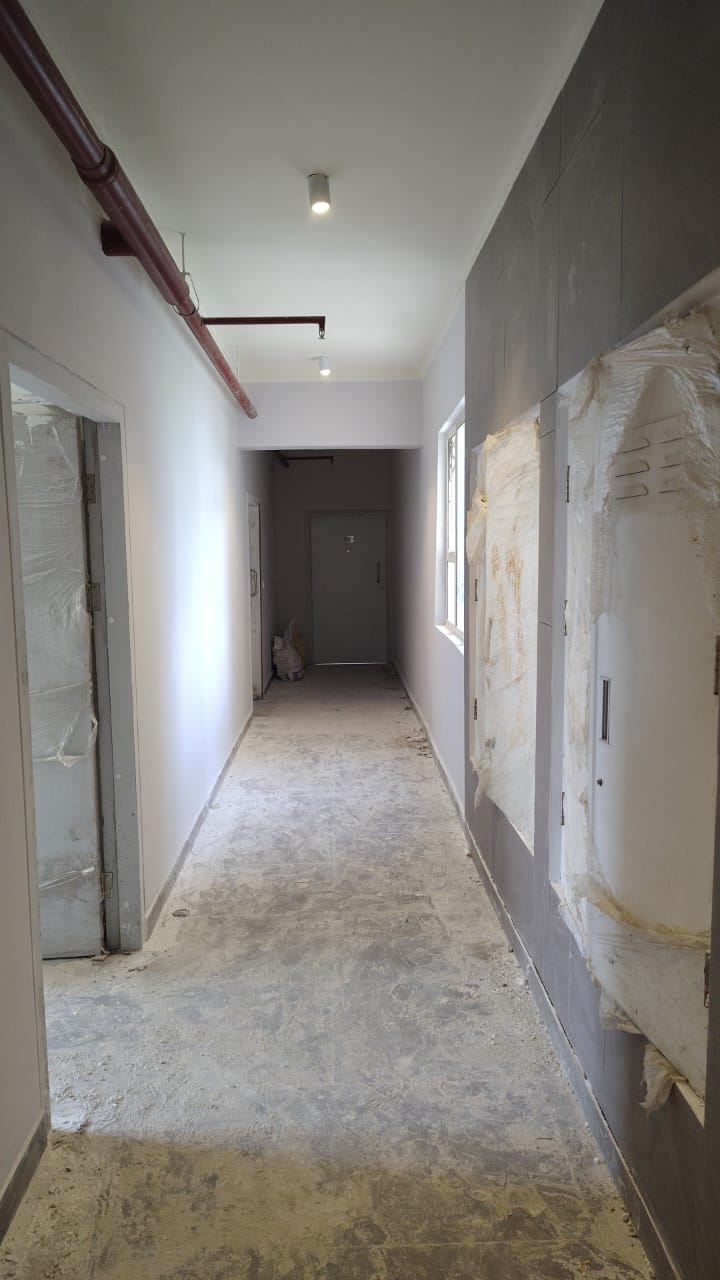

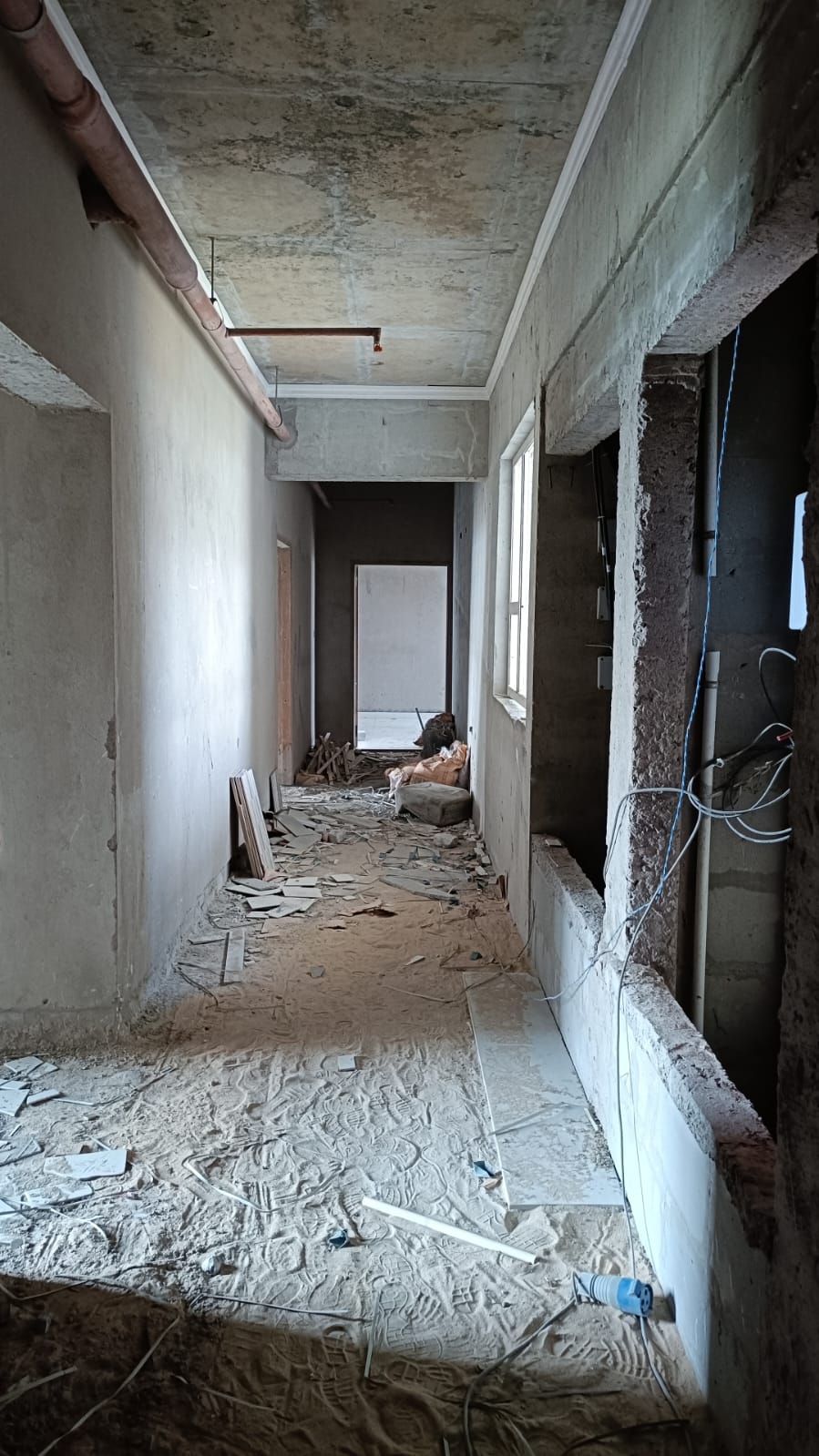

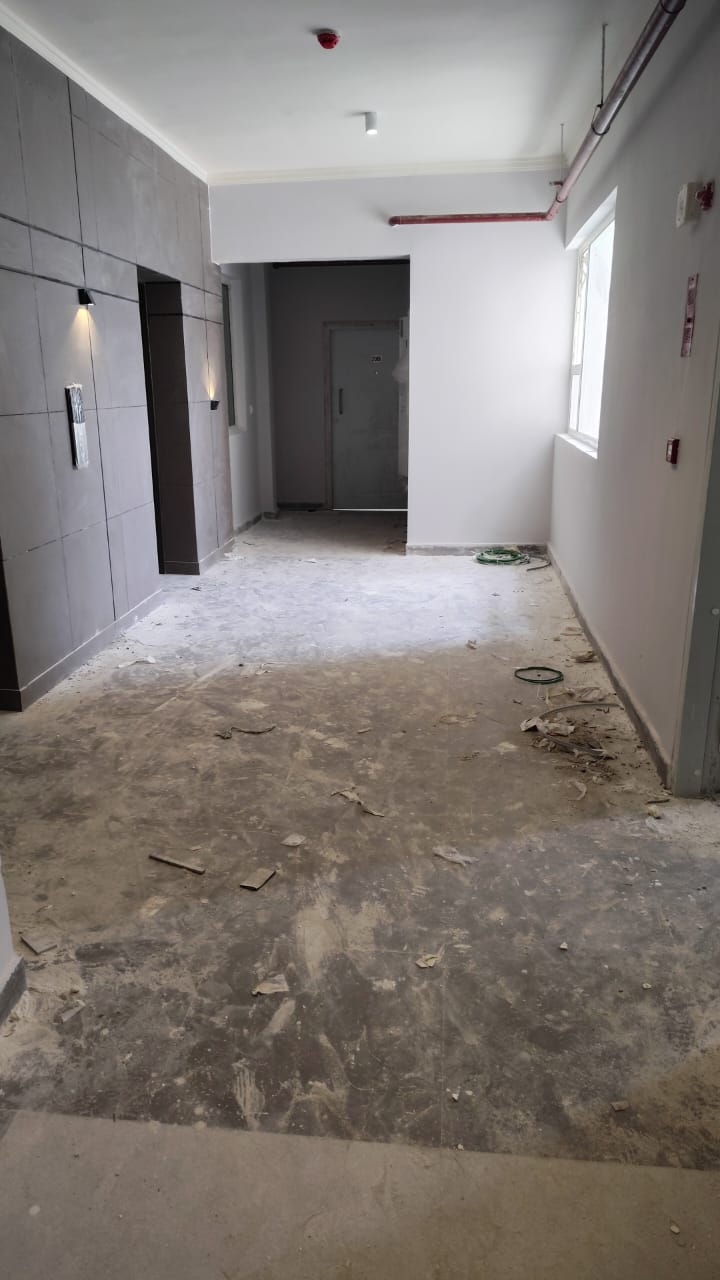

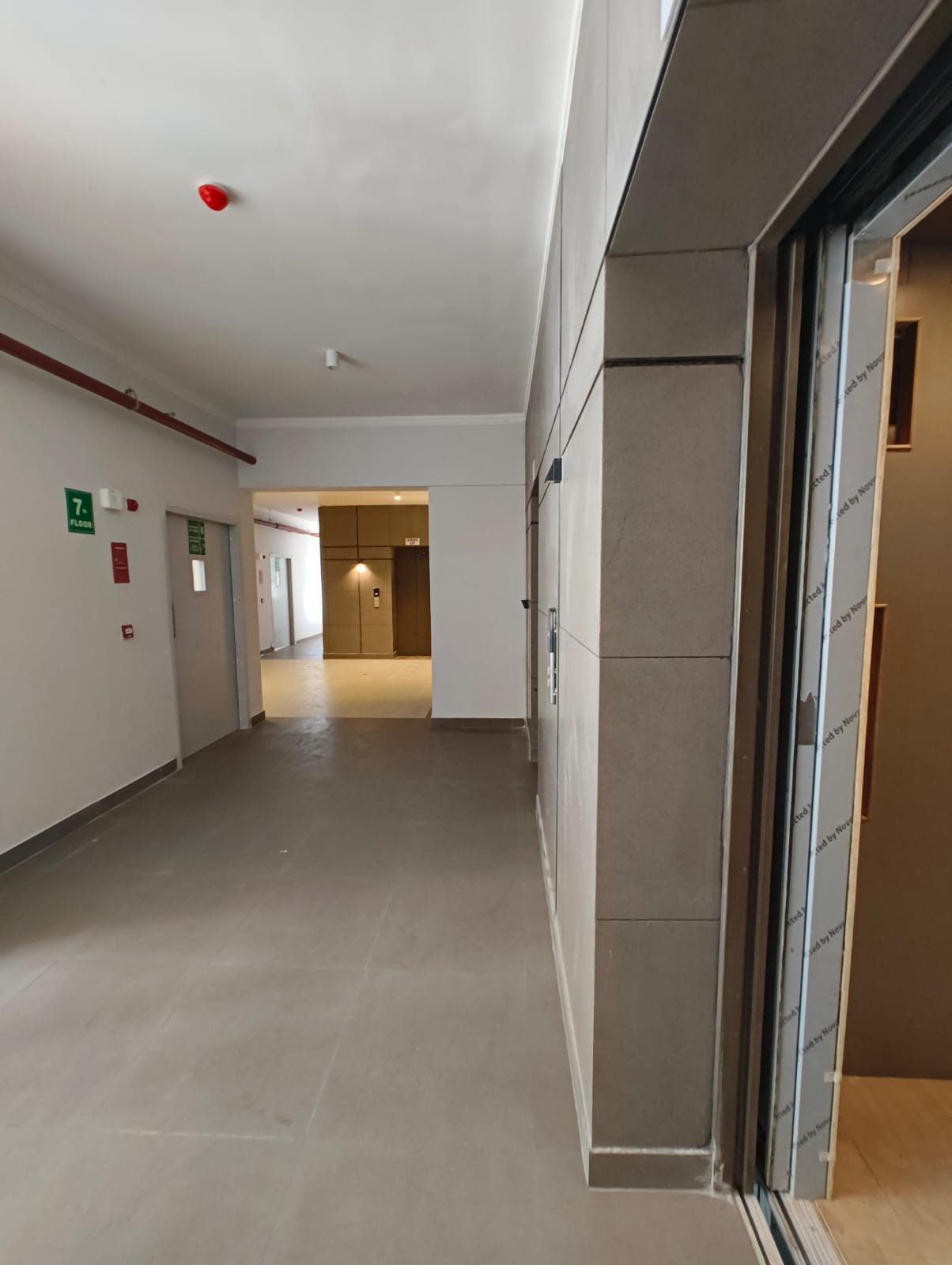

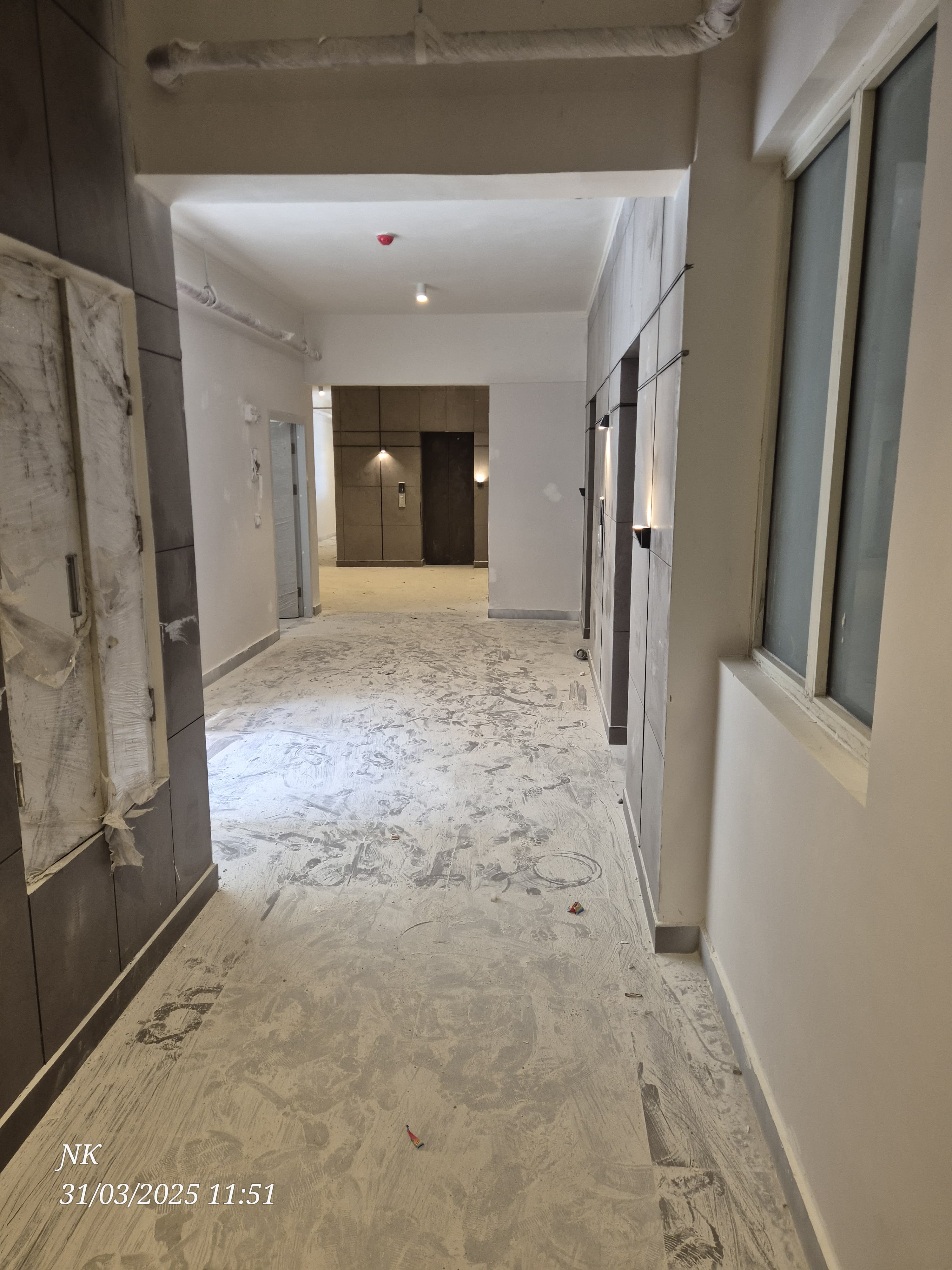

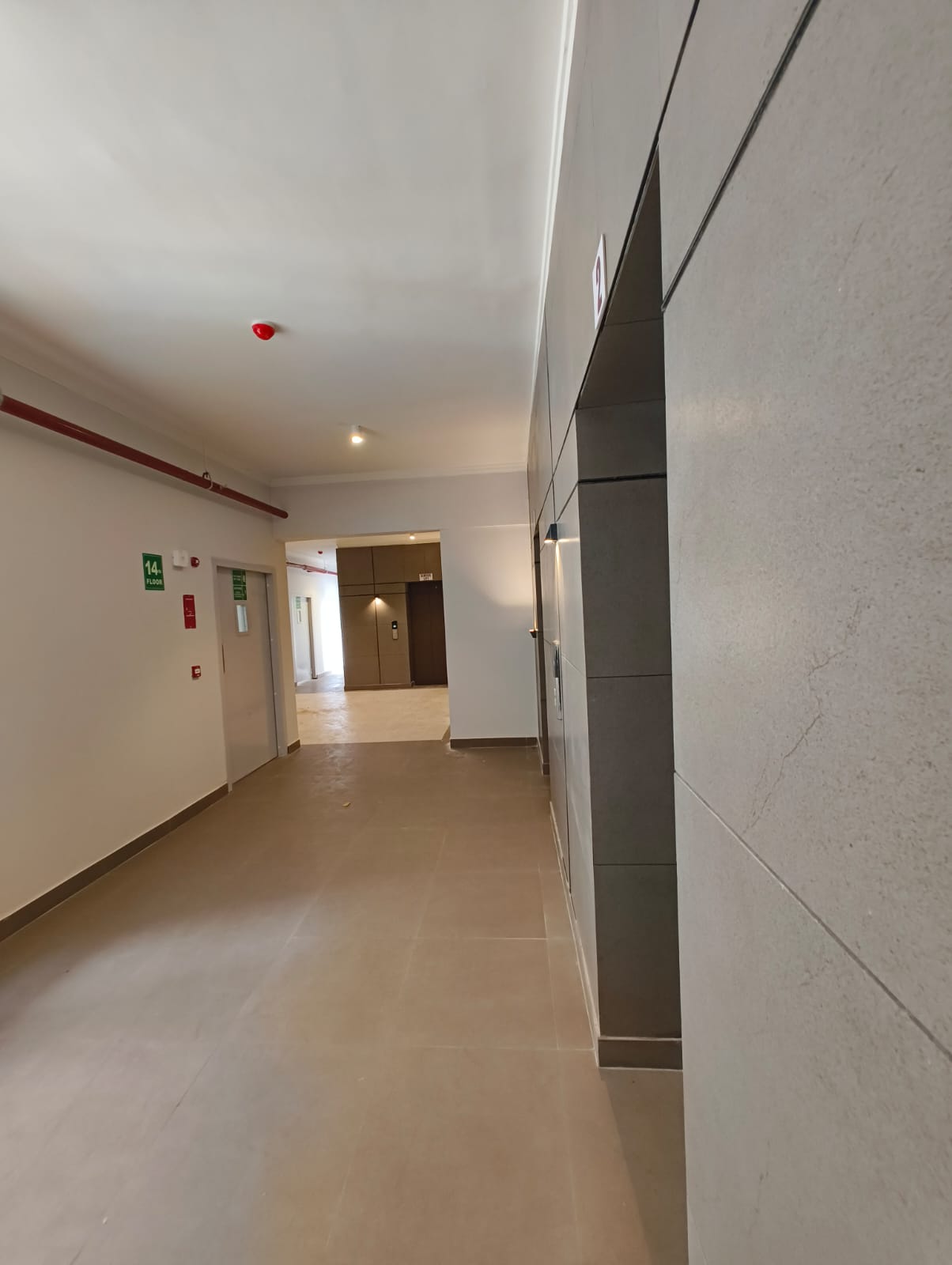

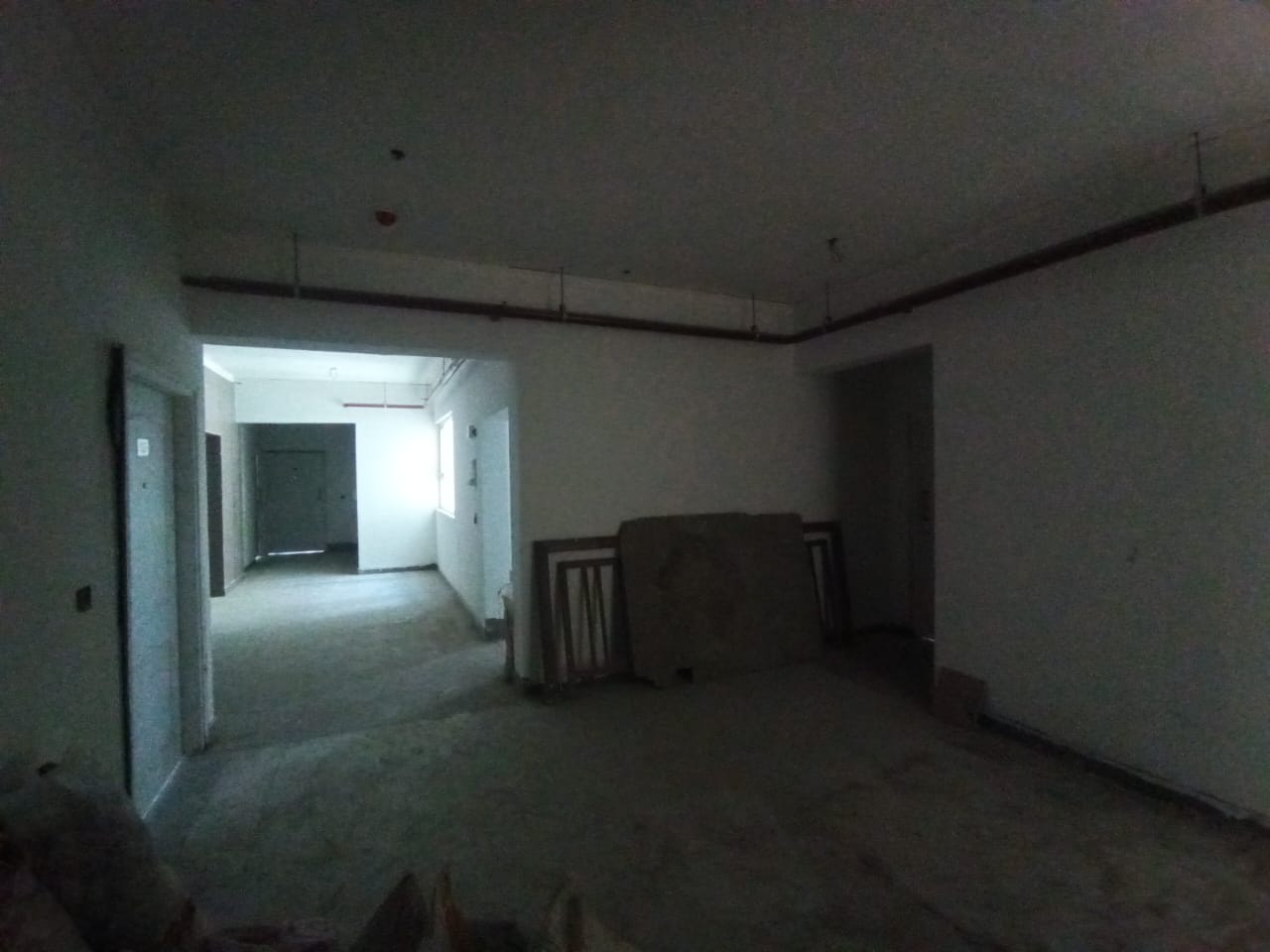

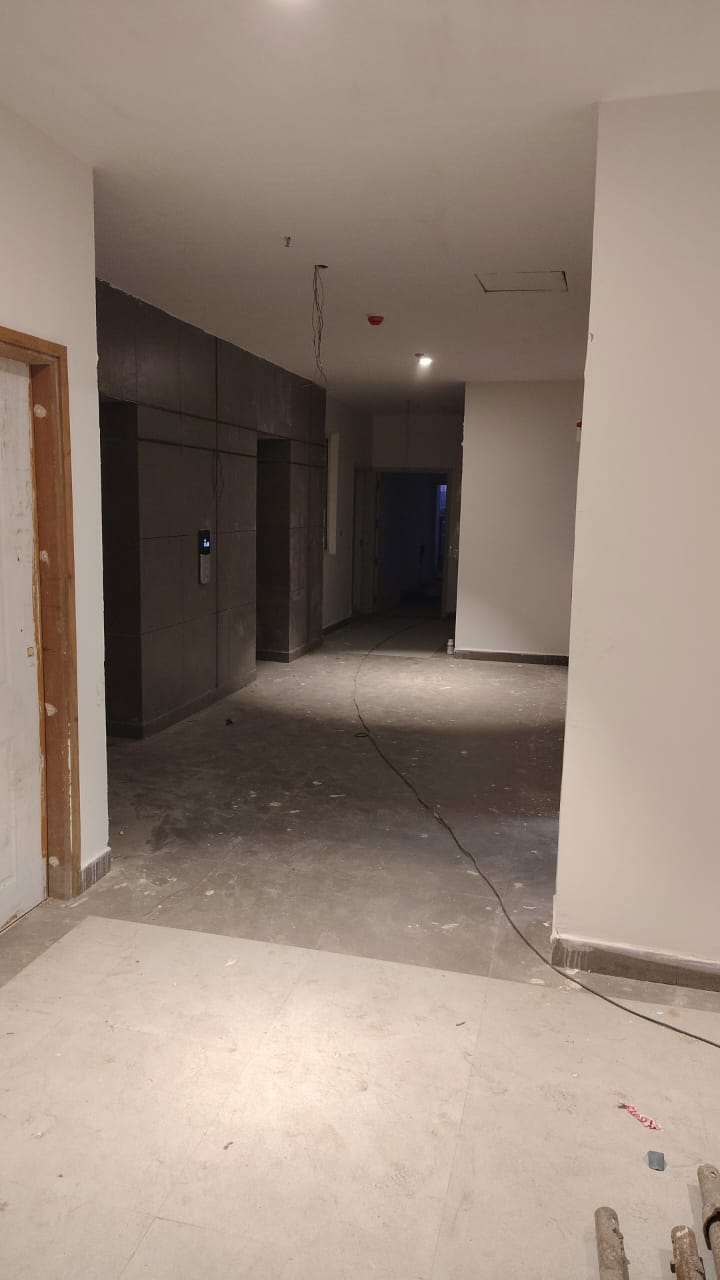

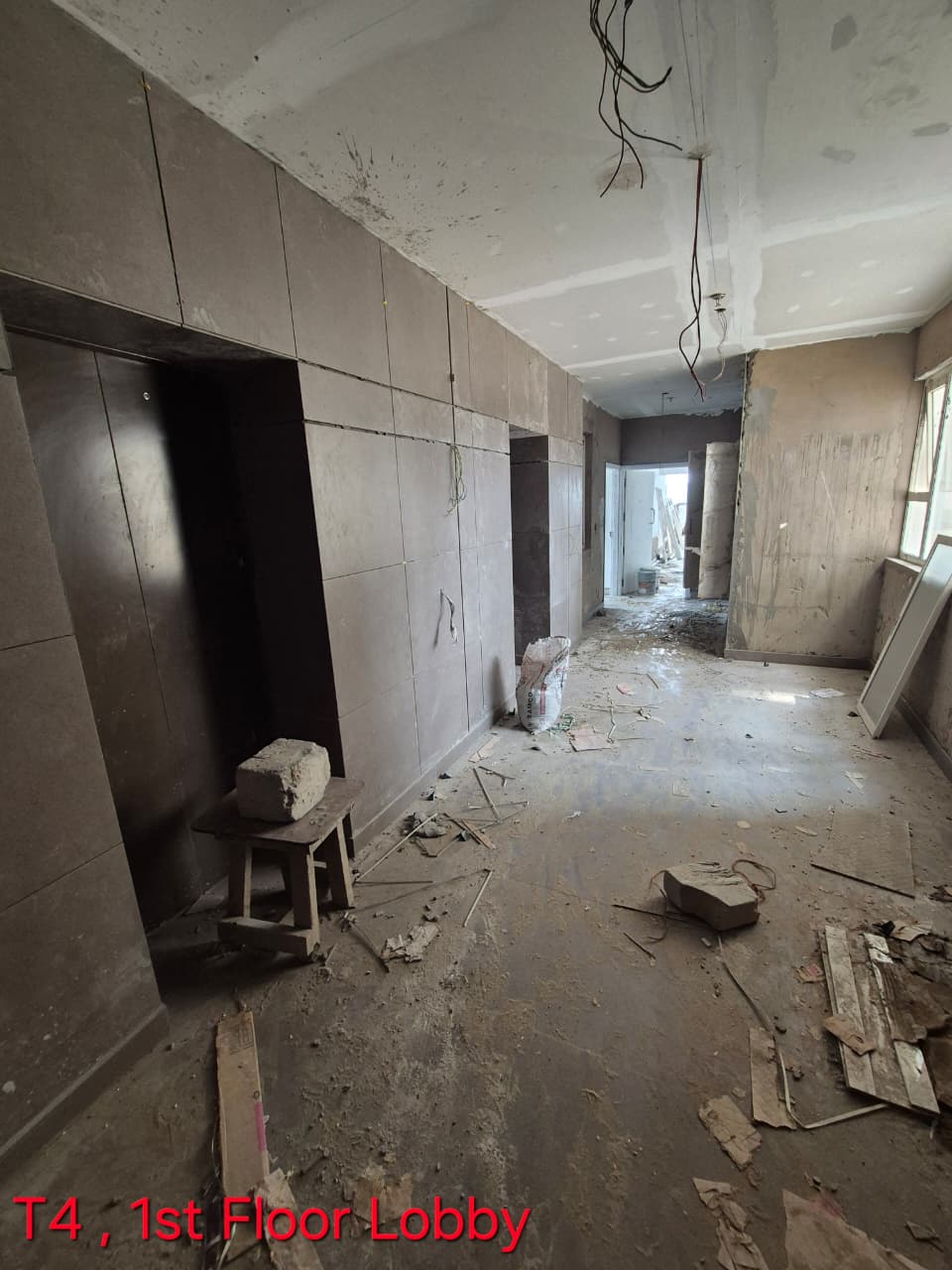

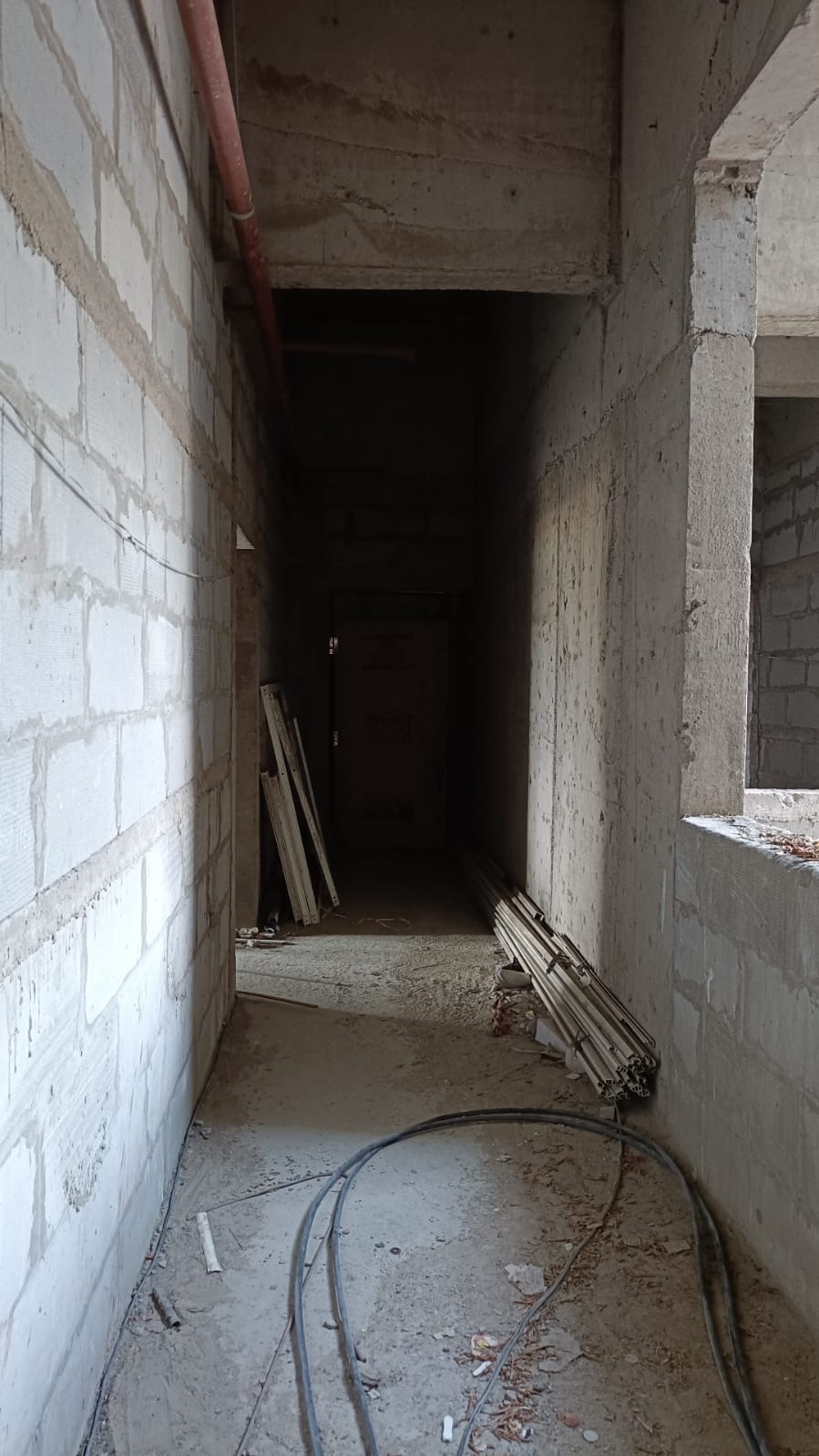

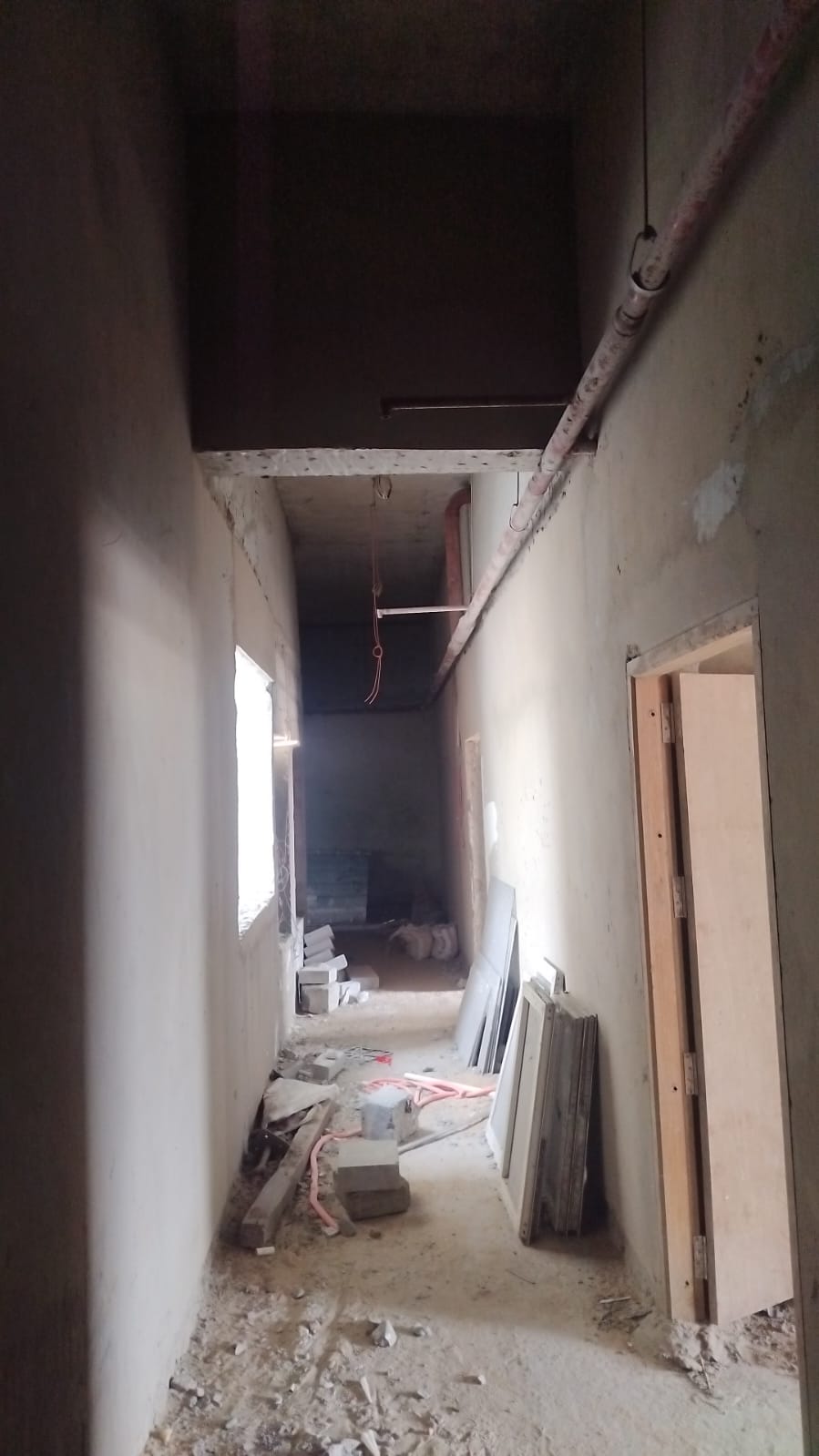

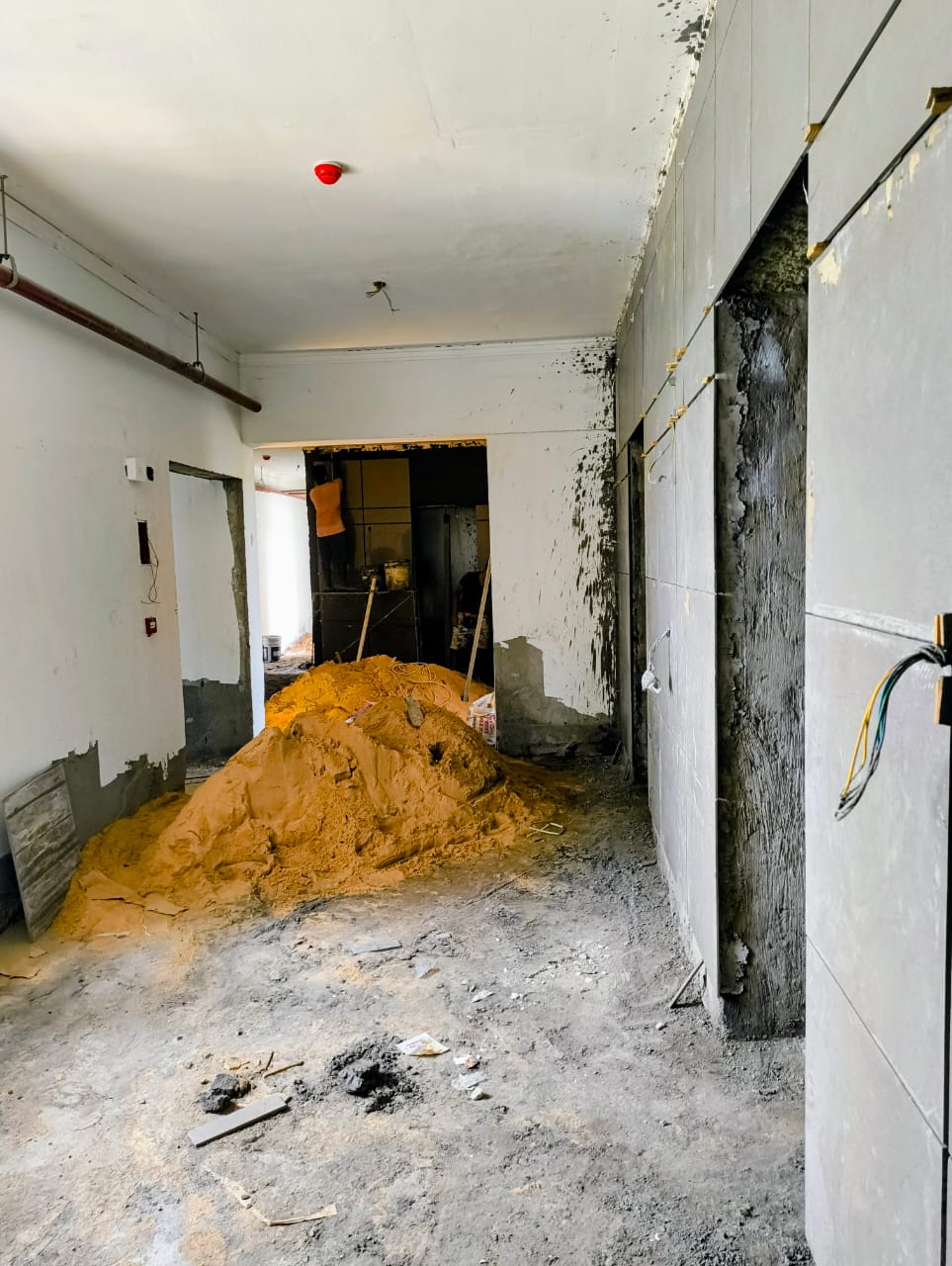

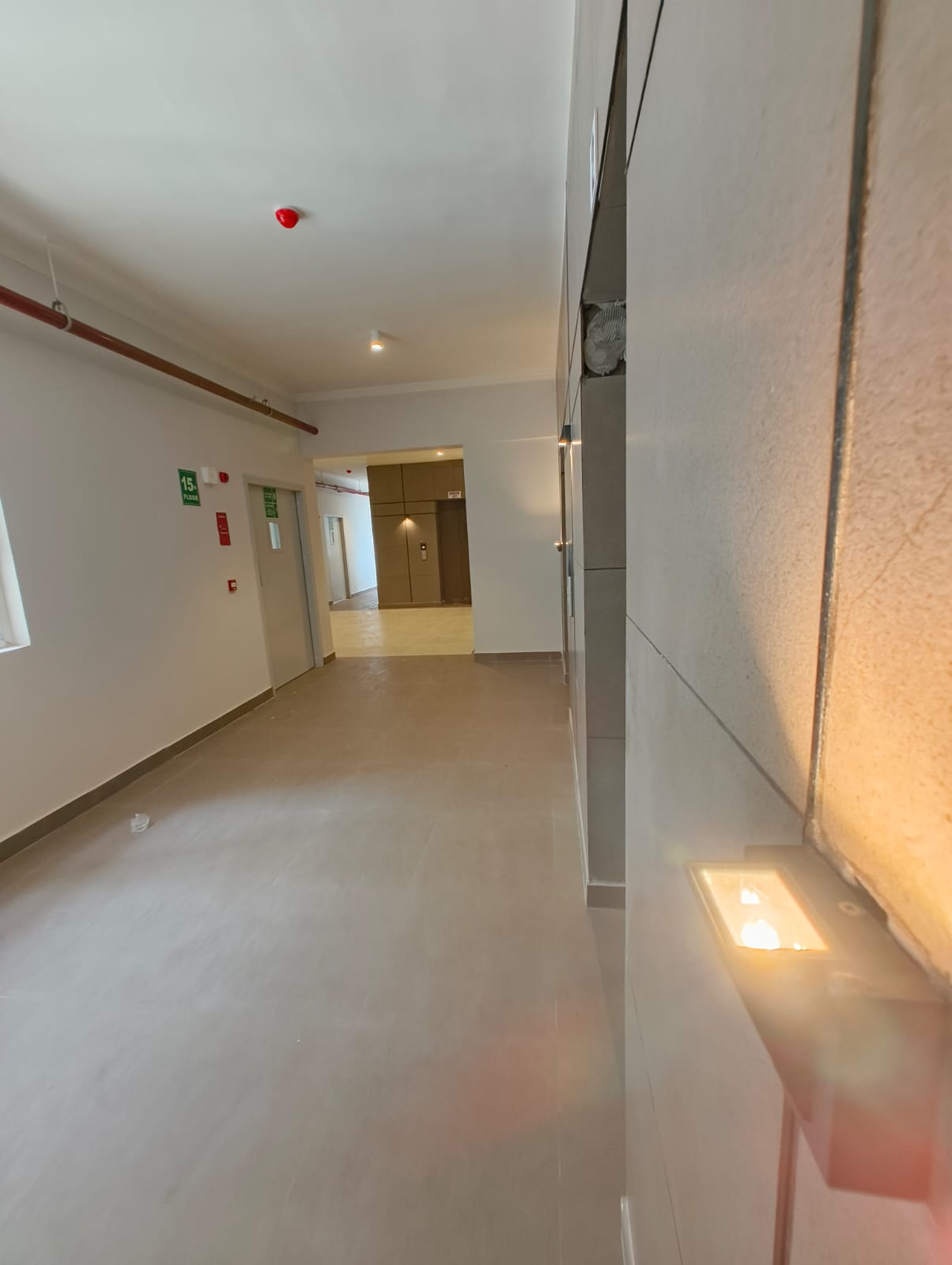

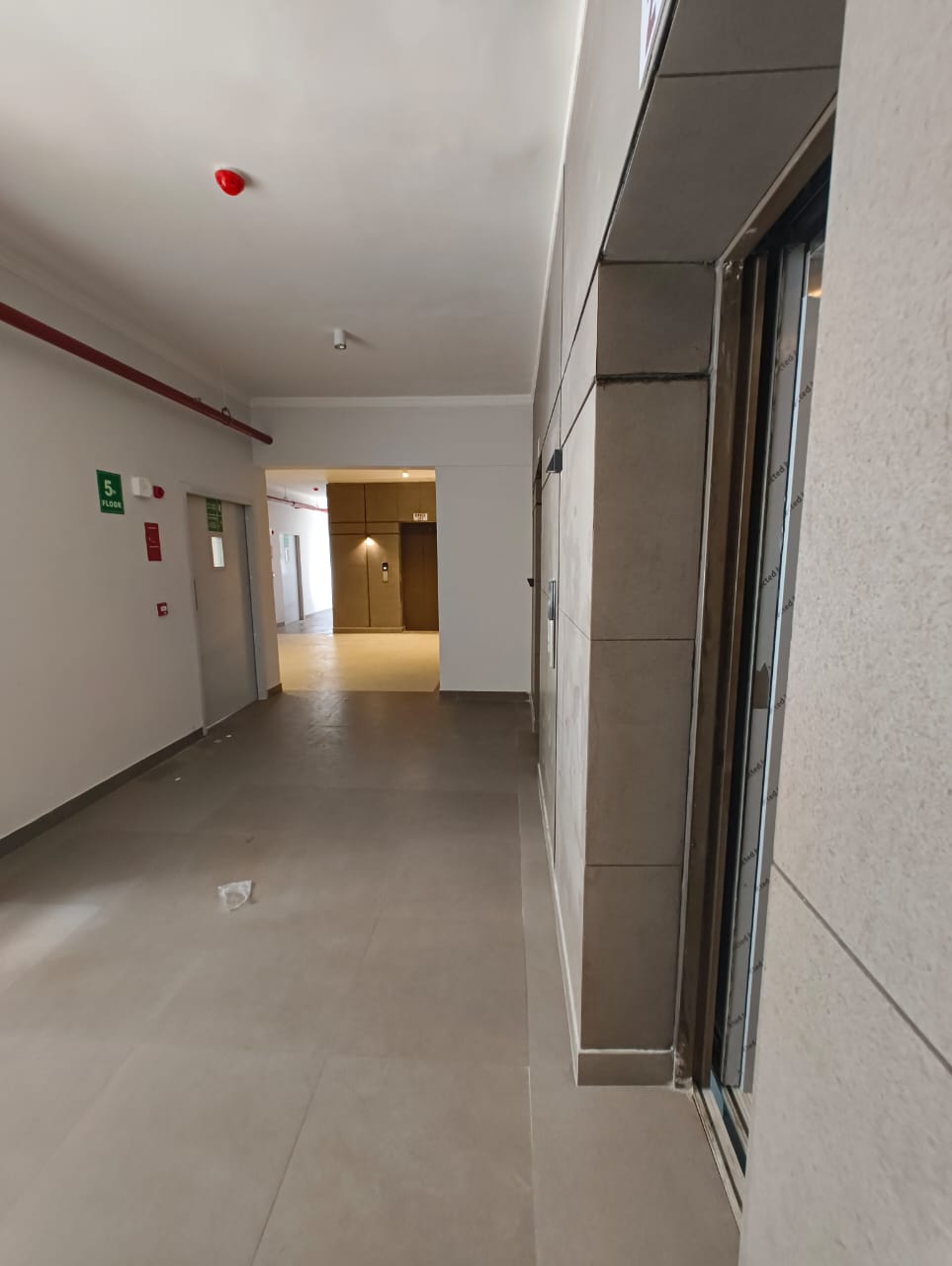

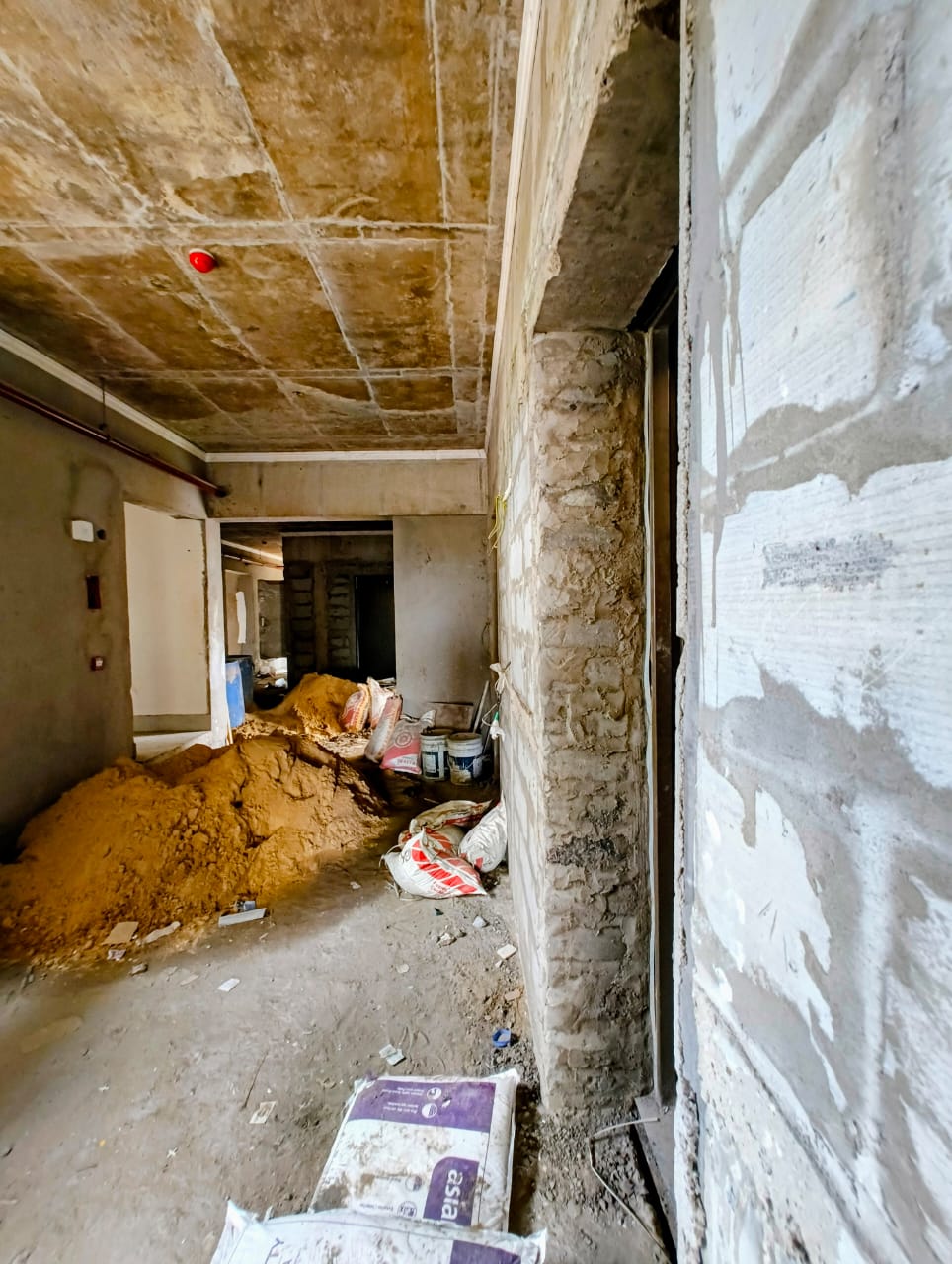

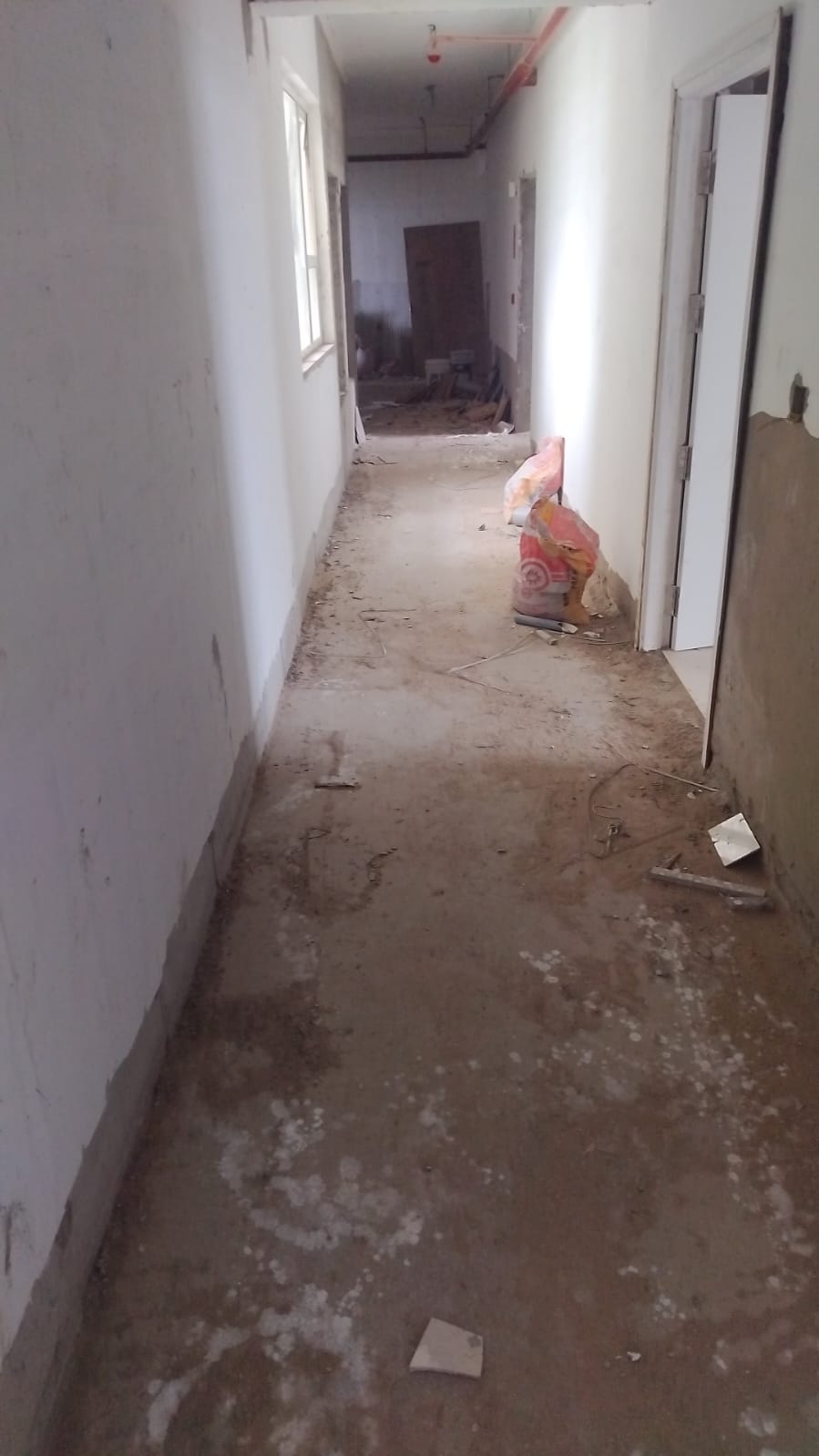

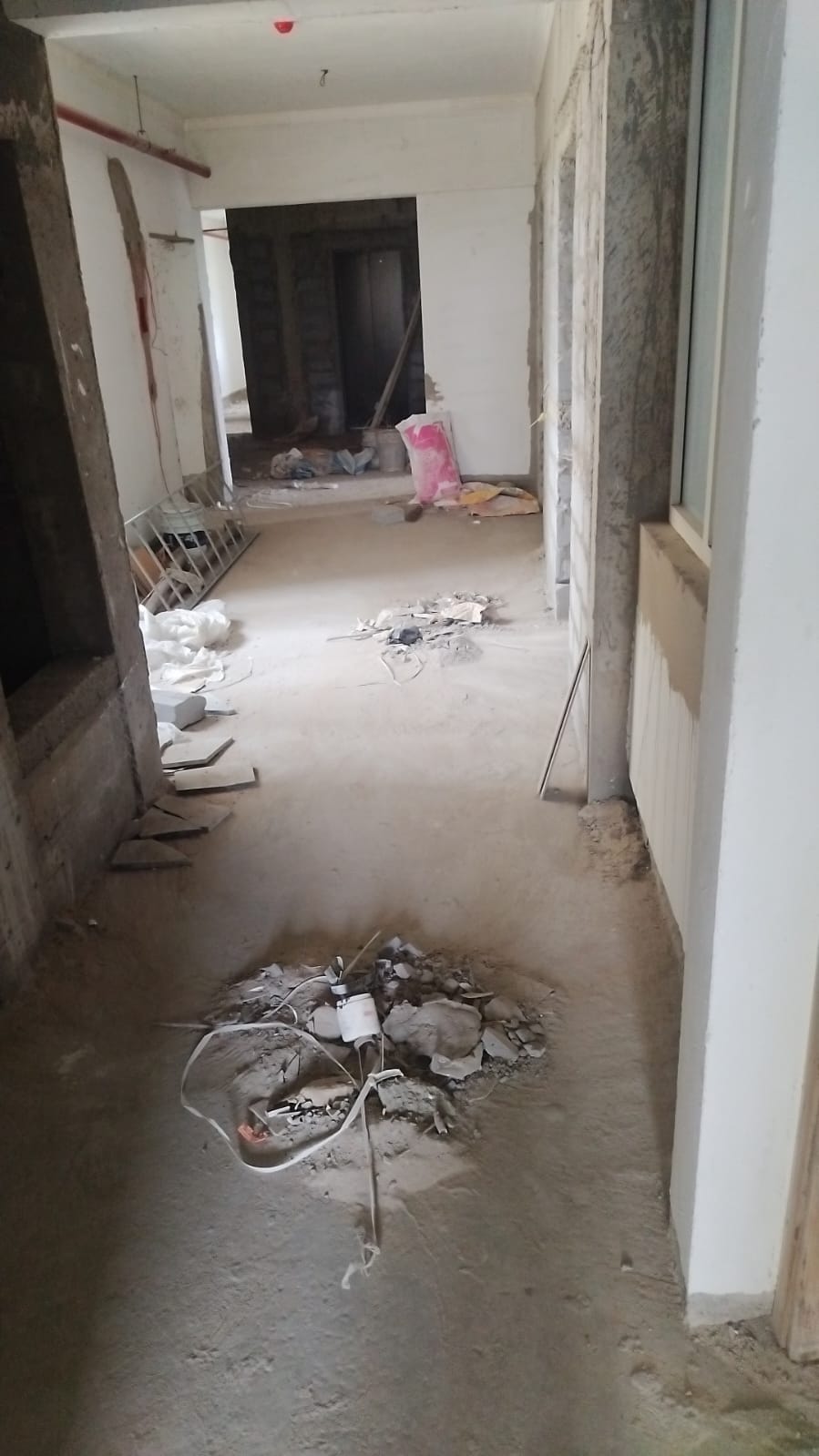

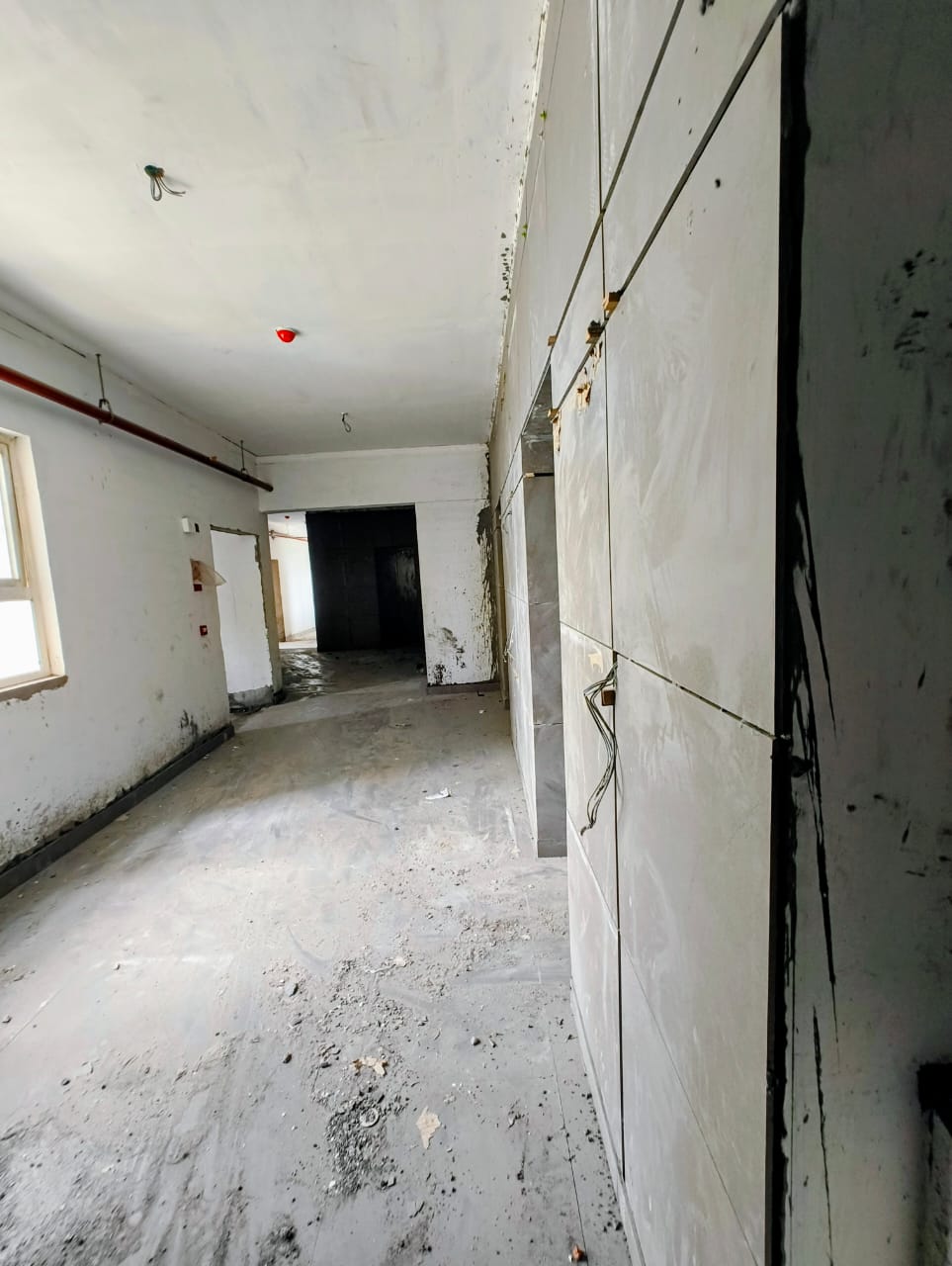

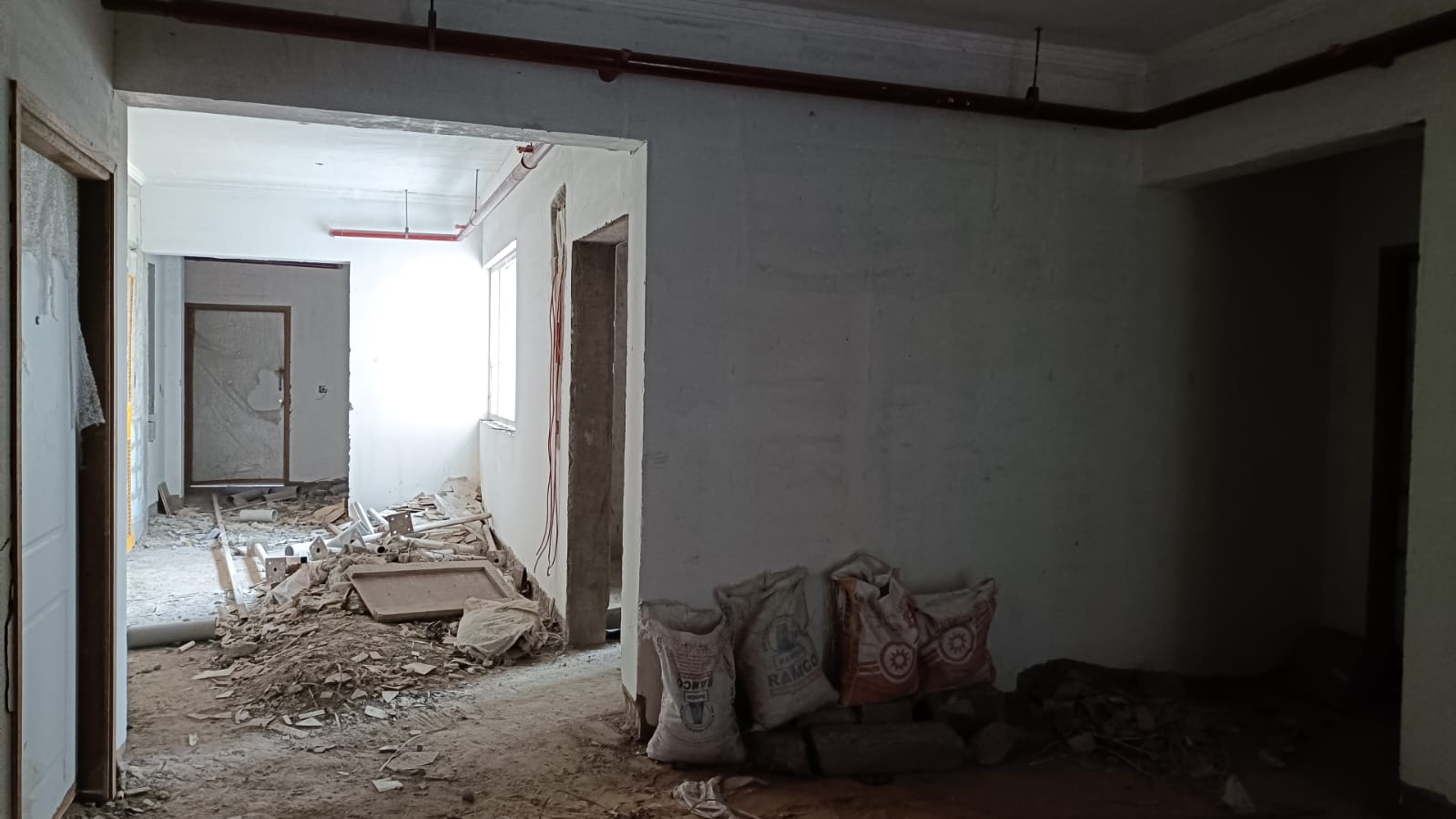

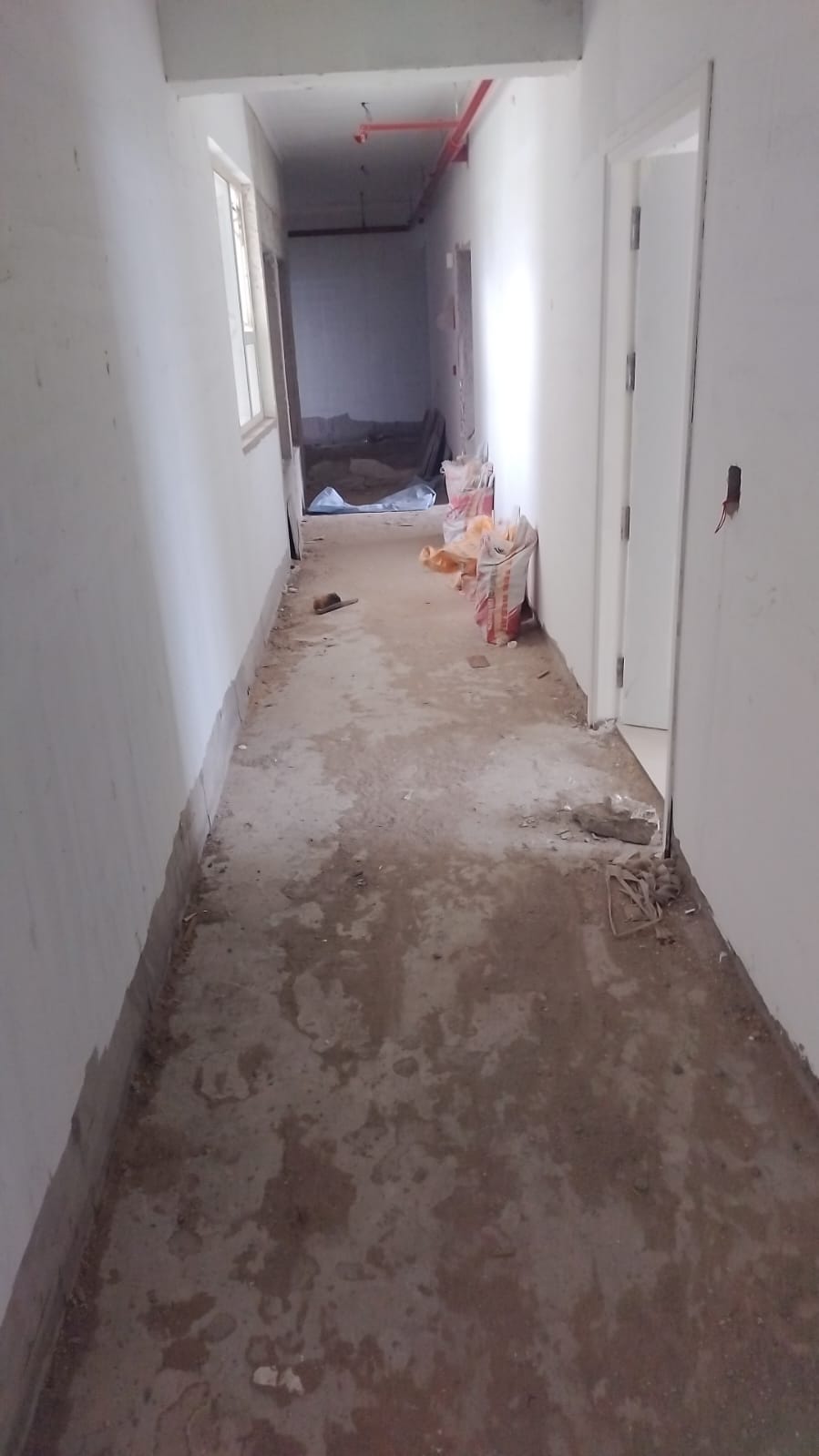

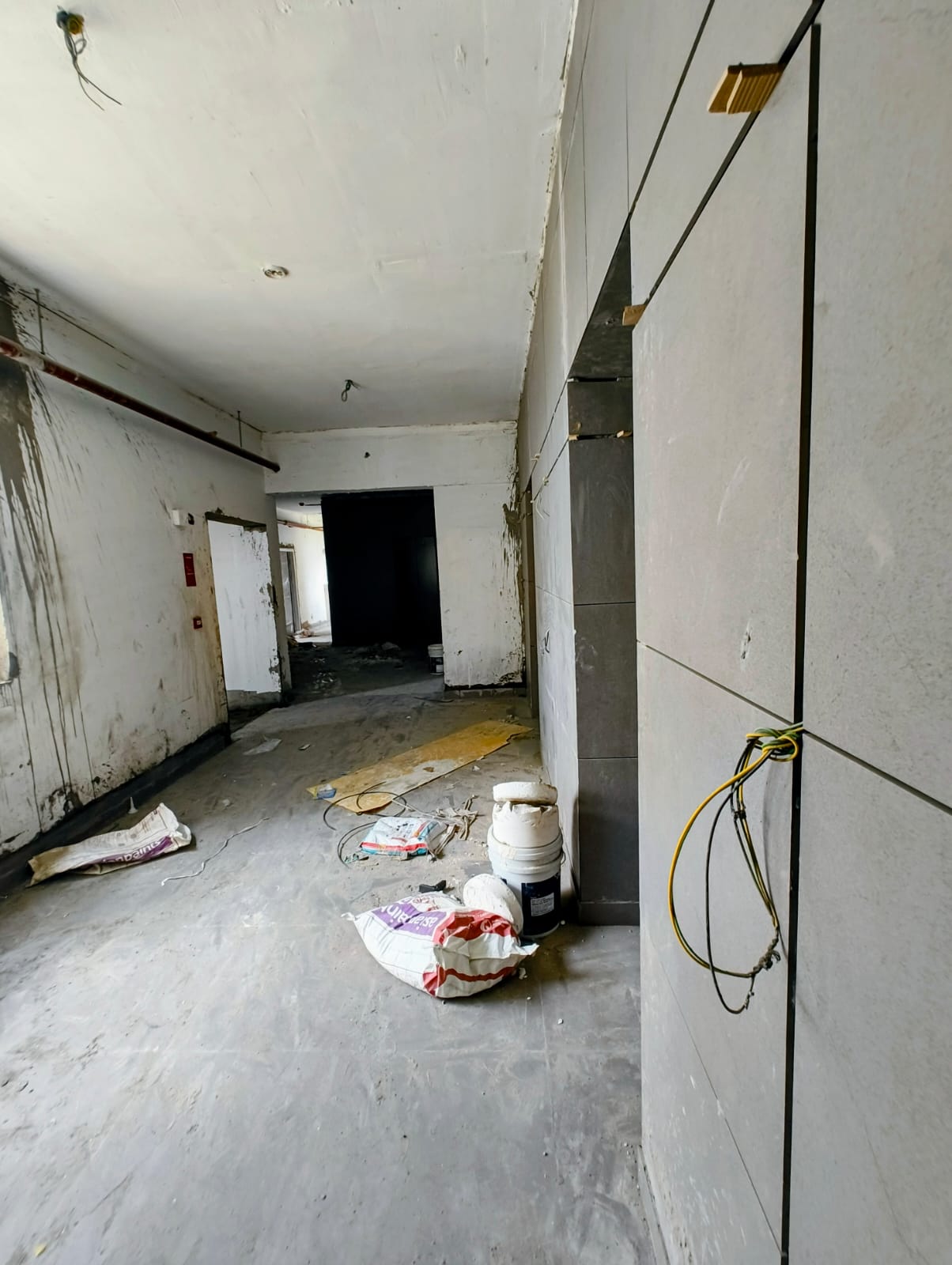

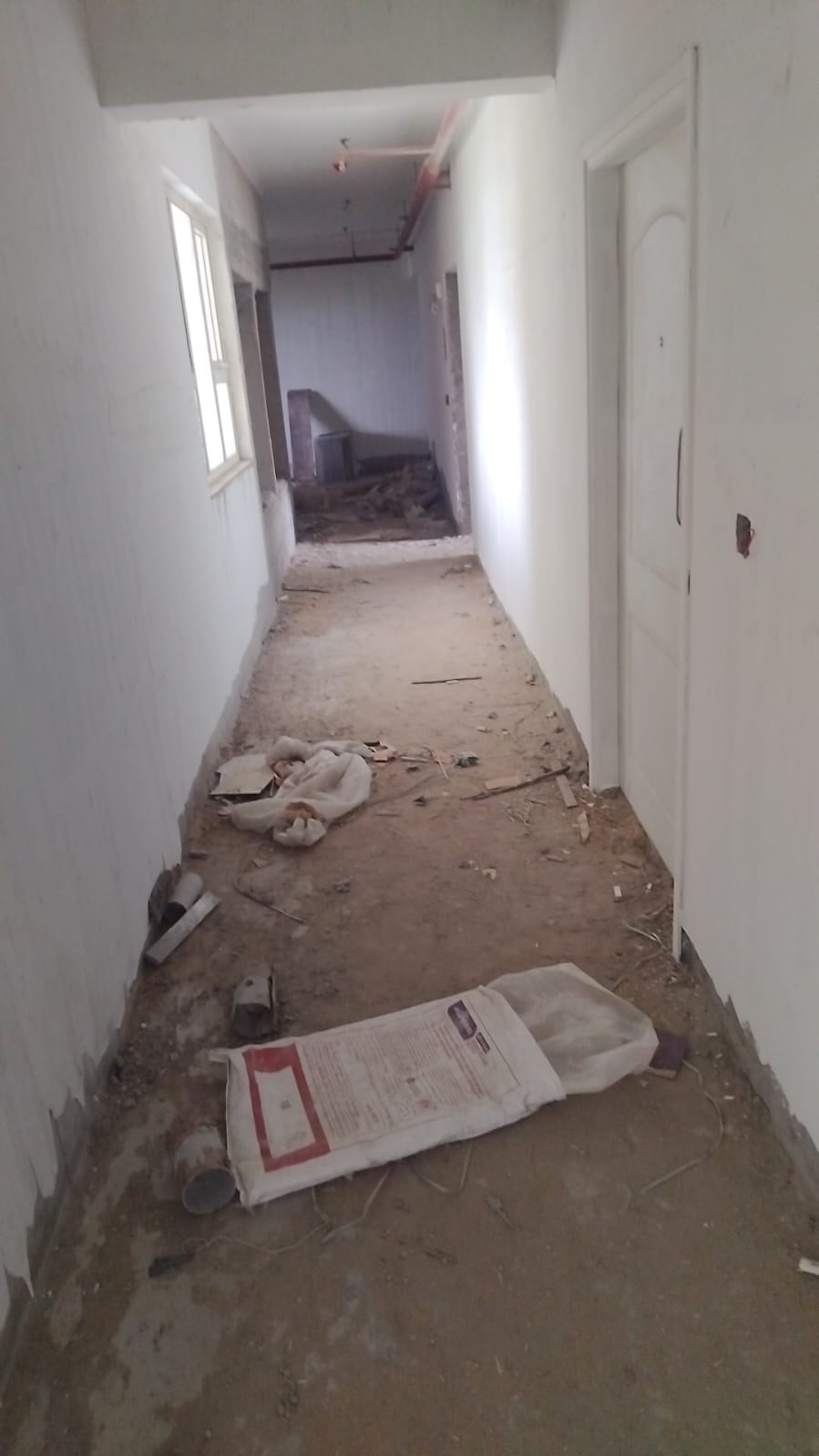

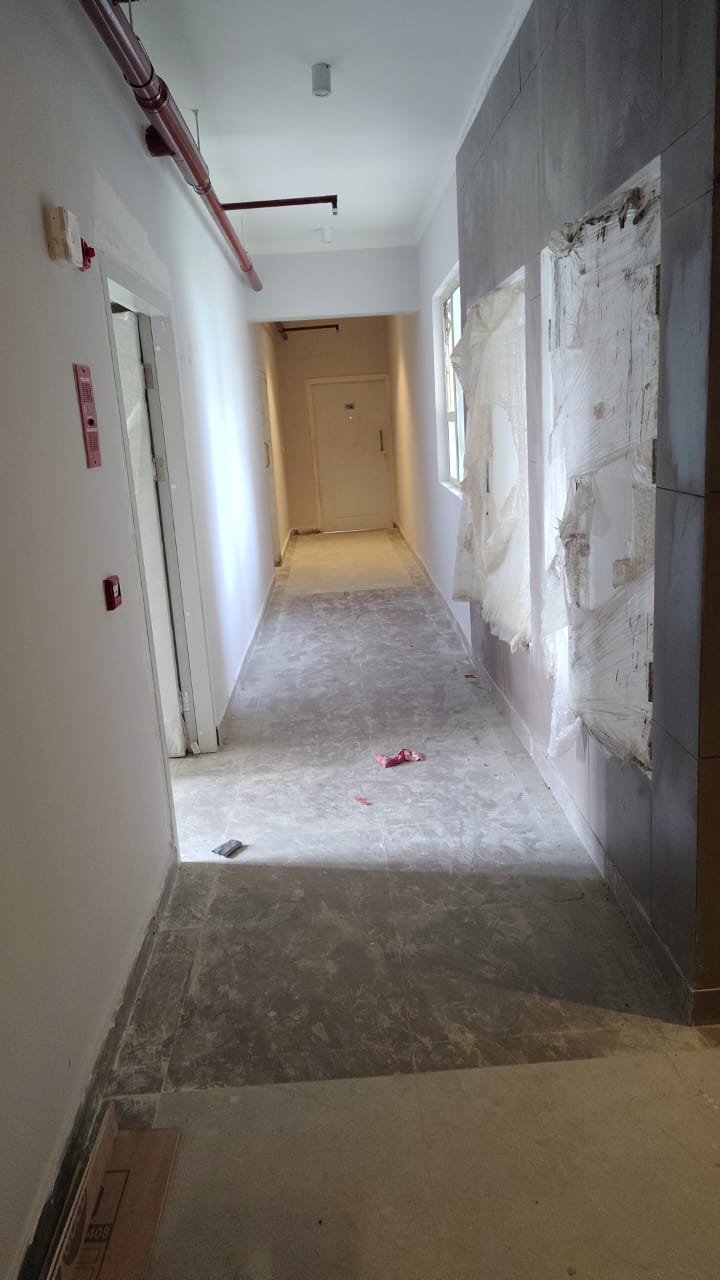

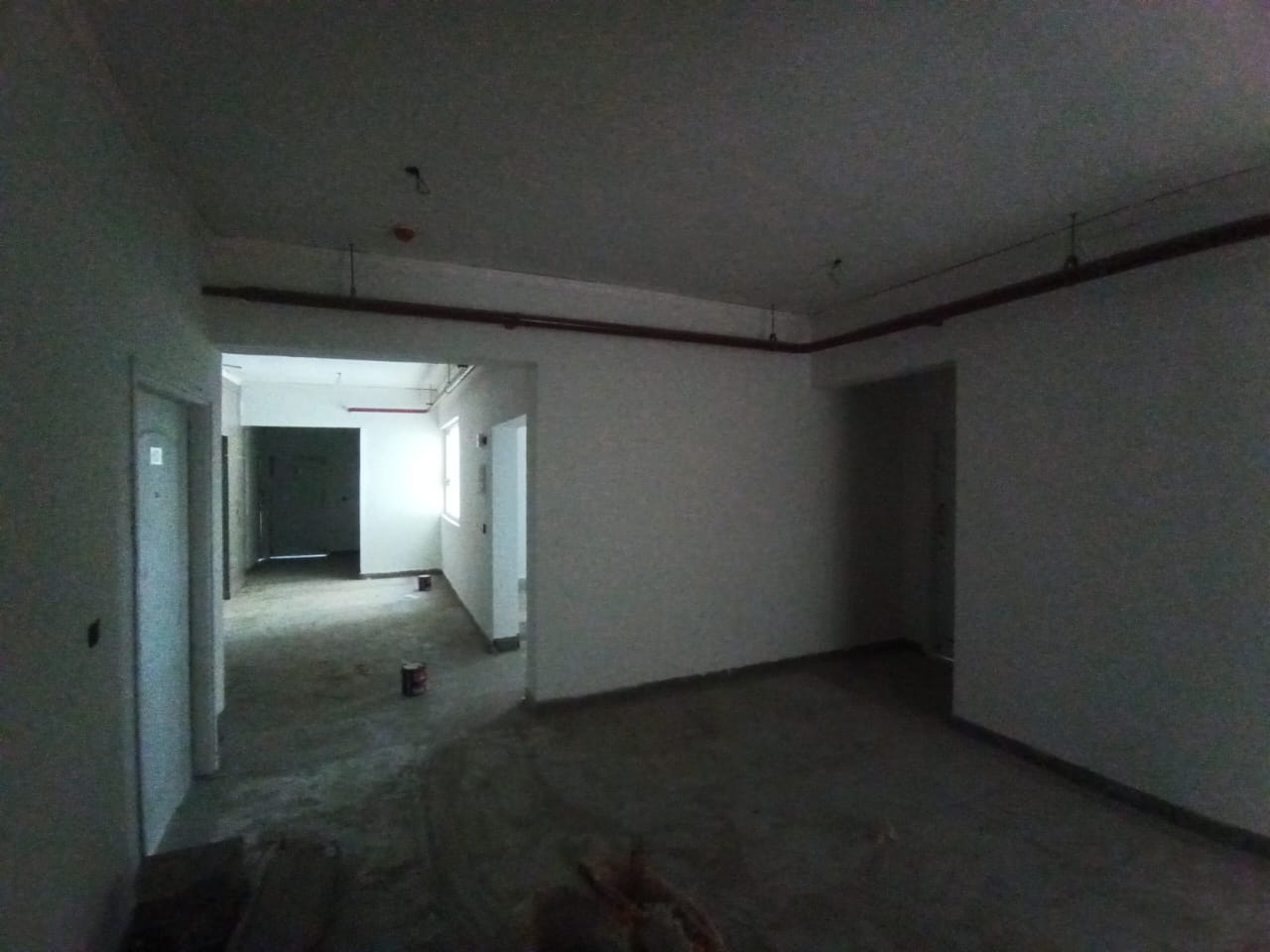

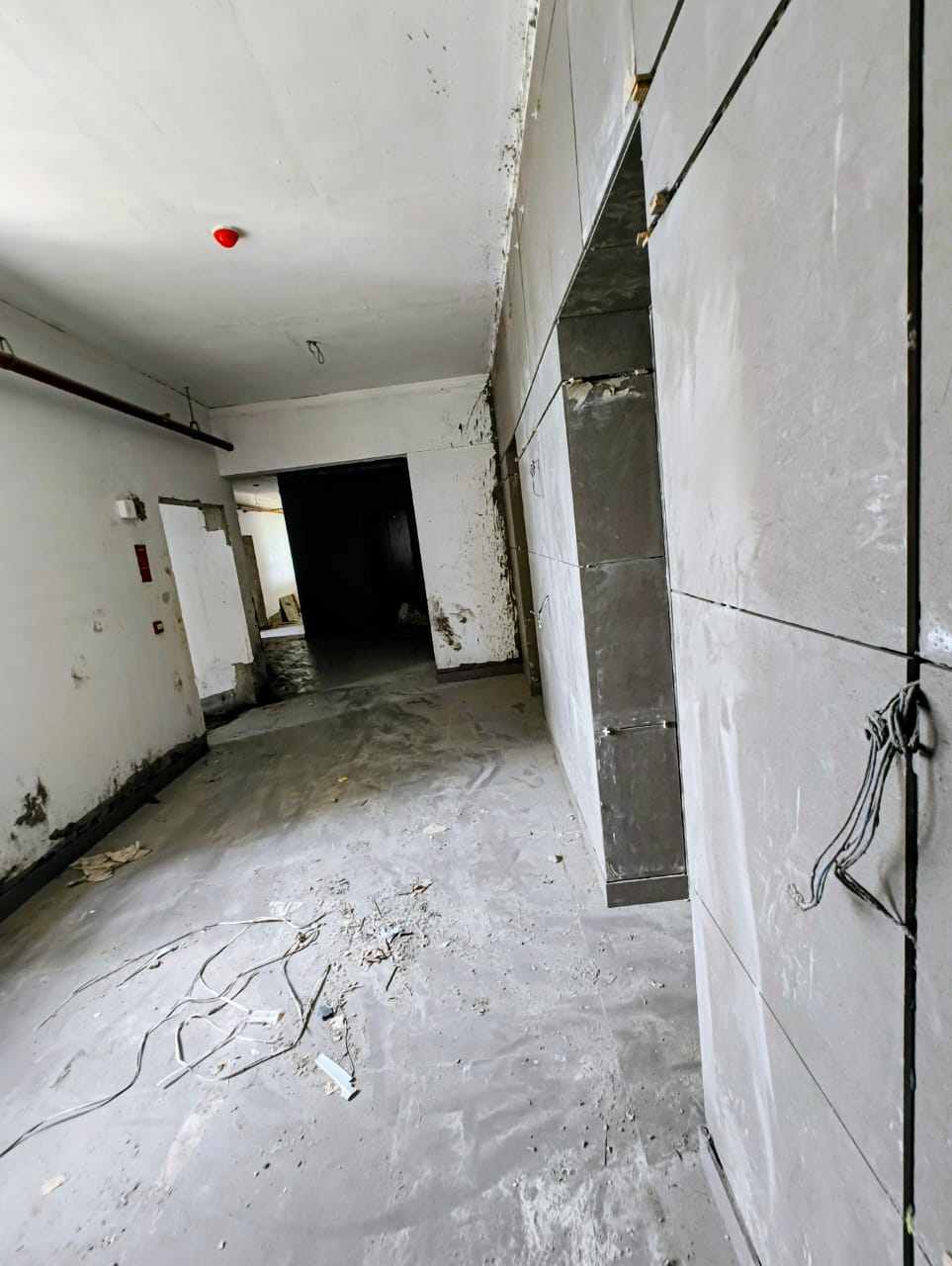

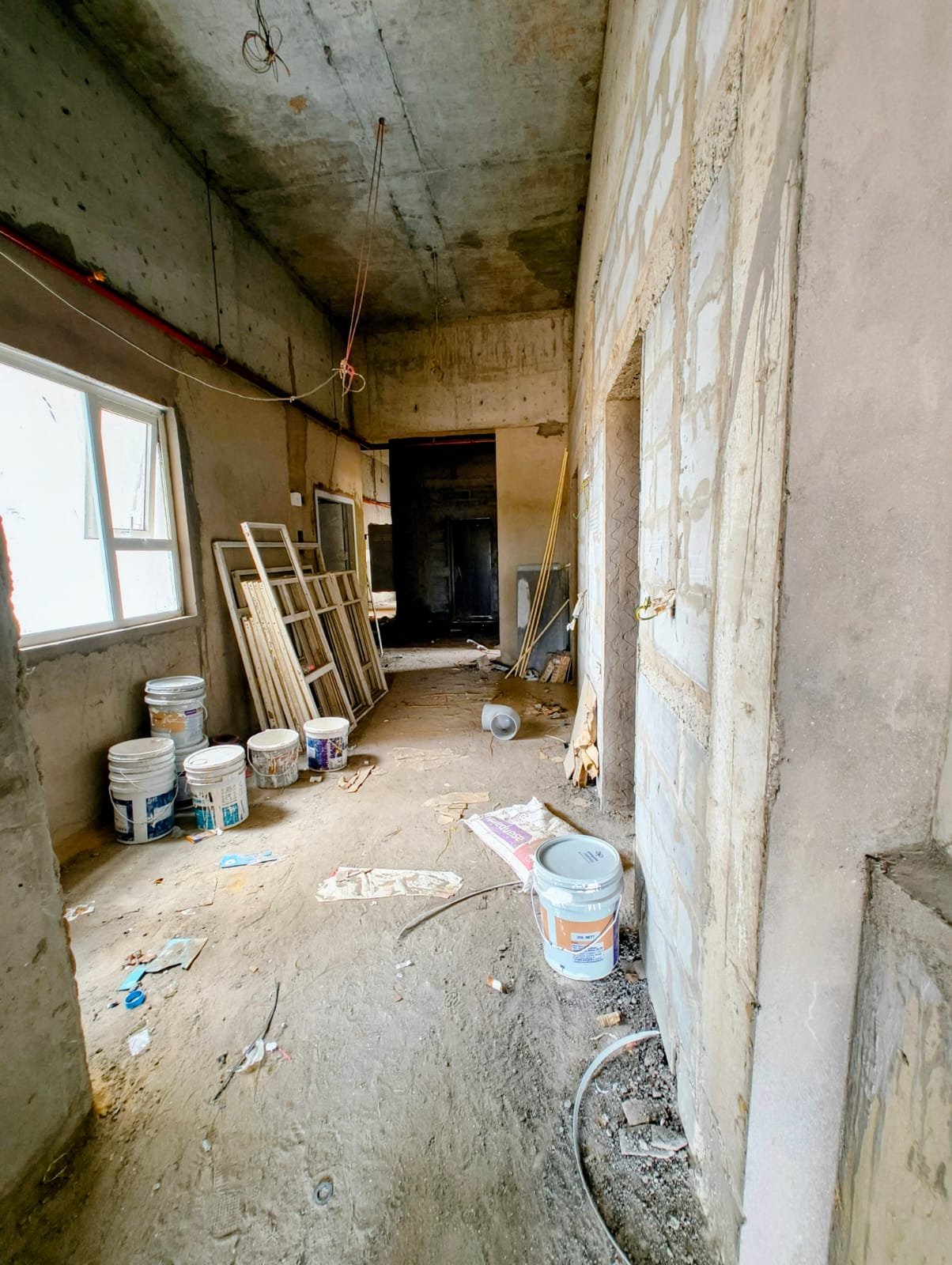

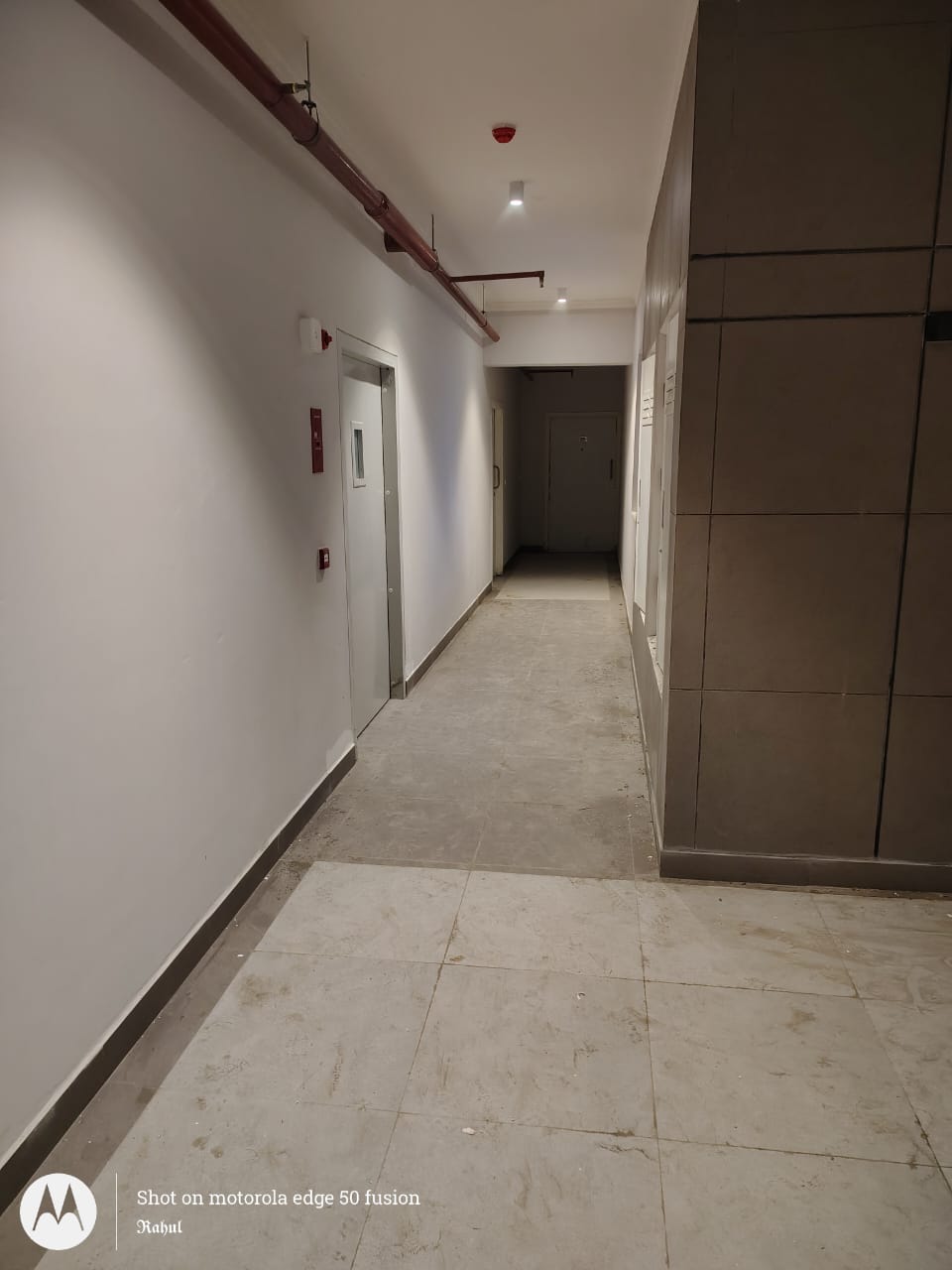

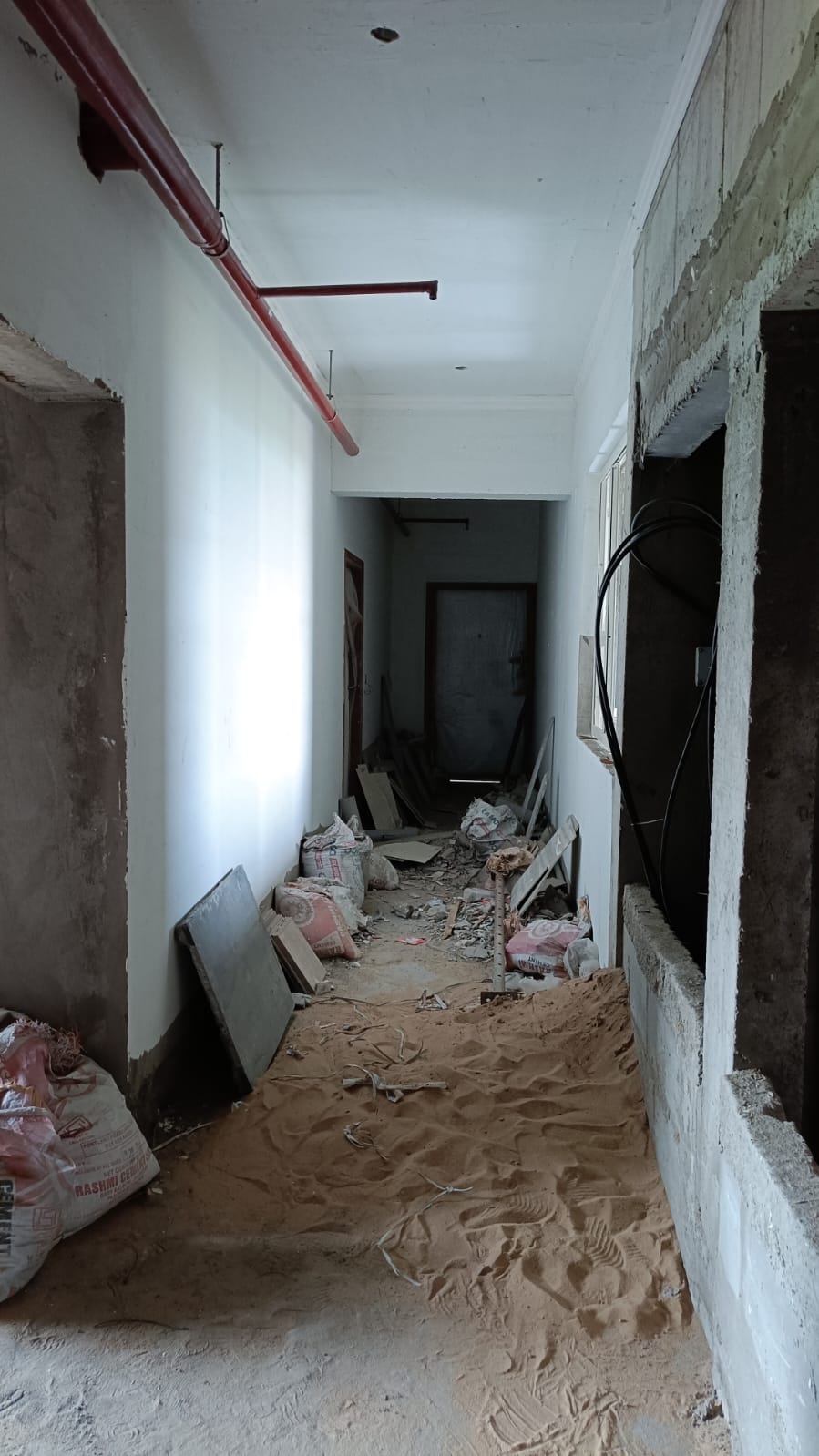

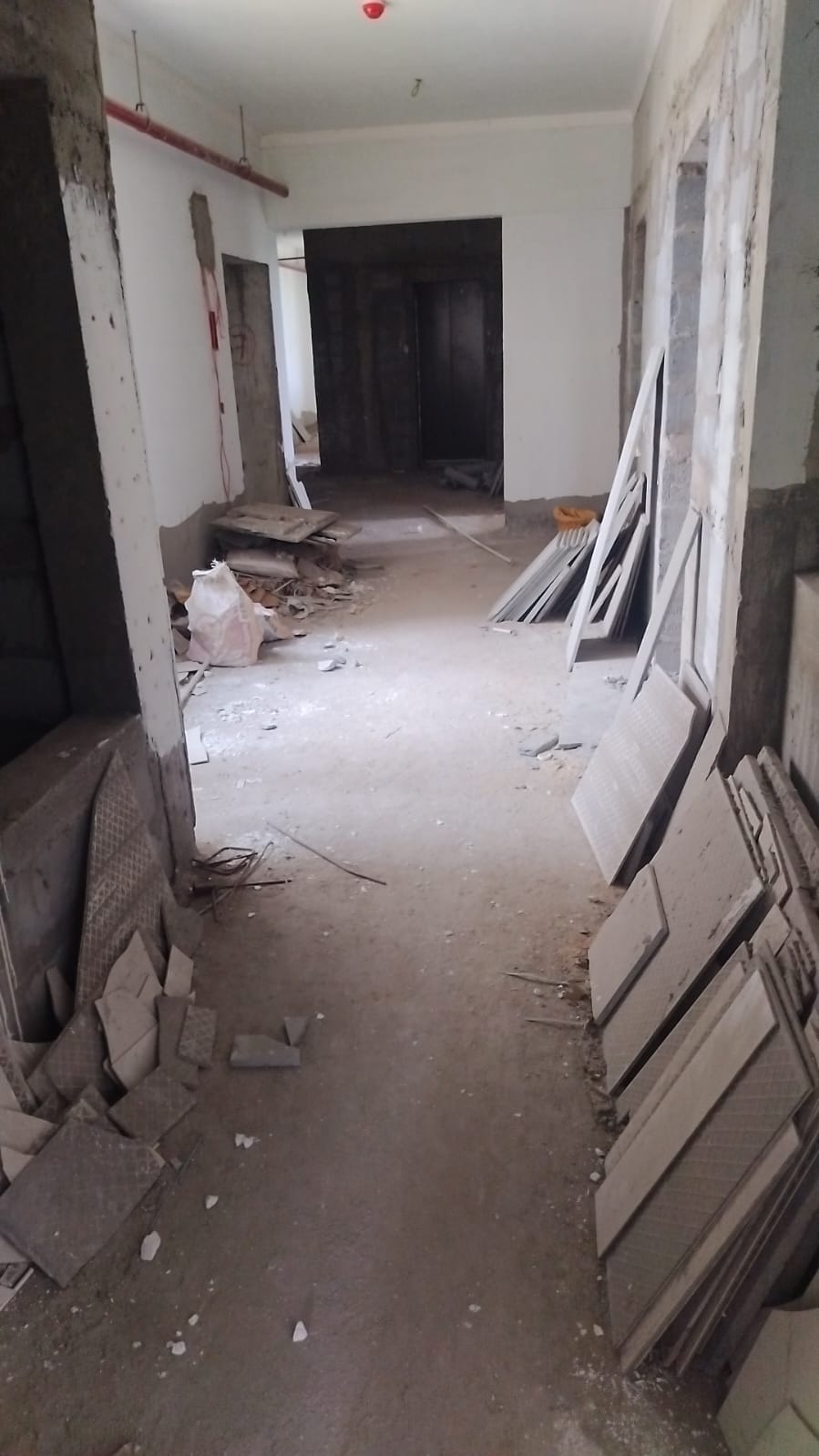

Tower-4 1 Under Construction

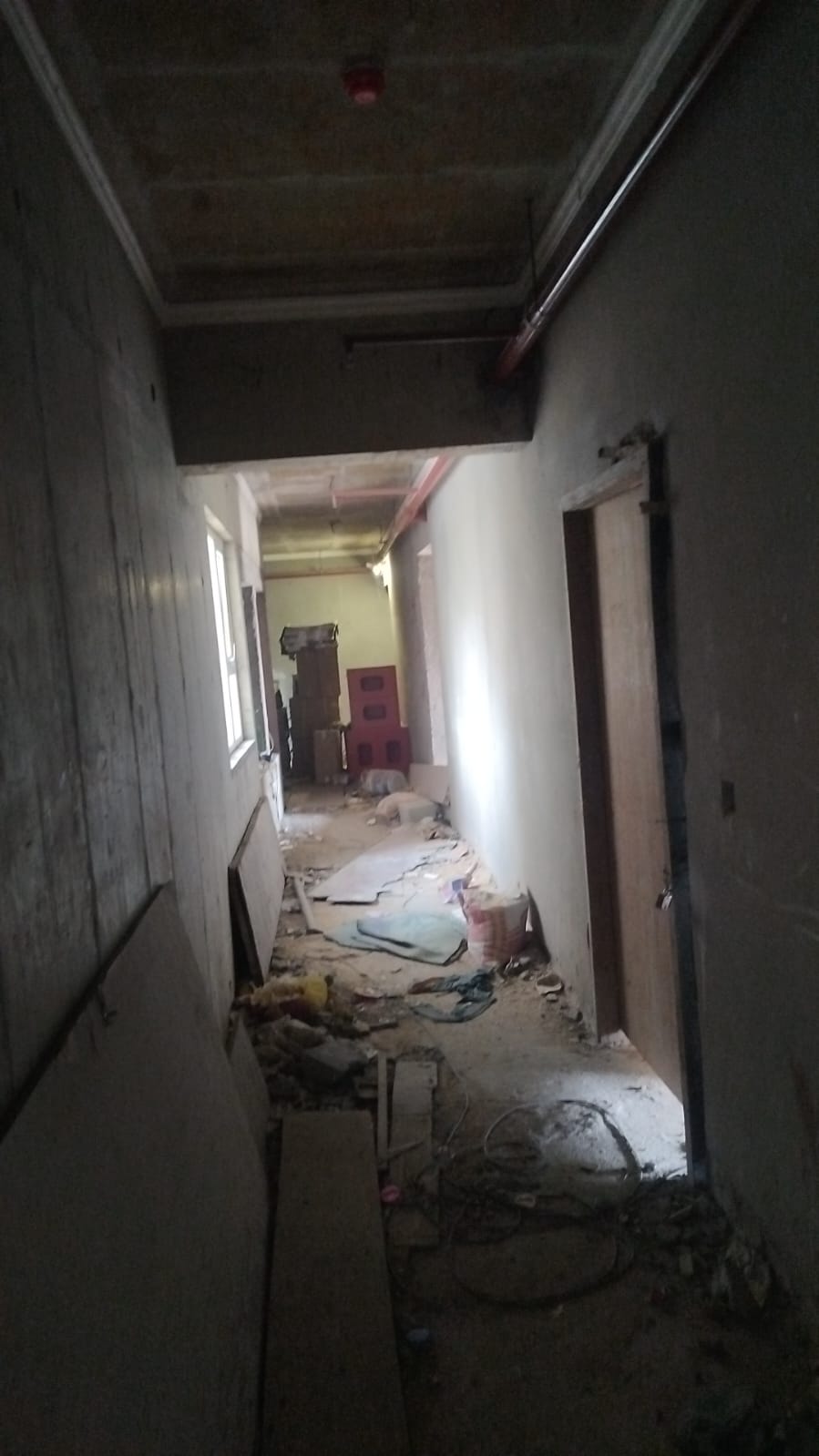

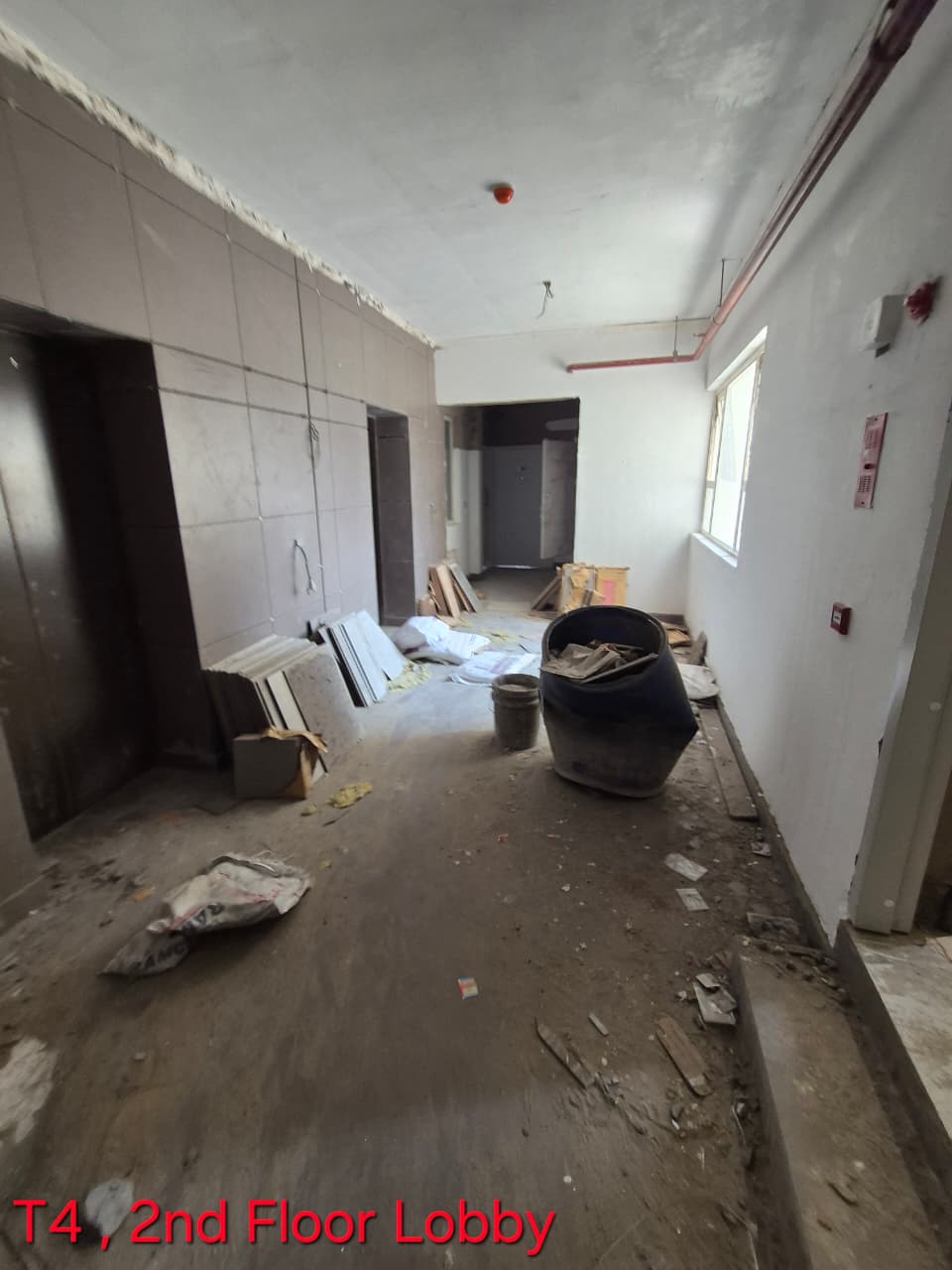

Tower-4 2 Under Construction

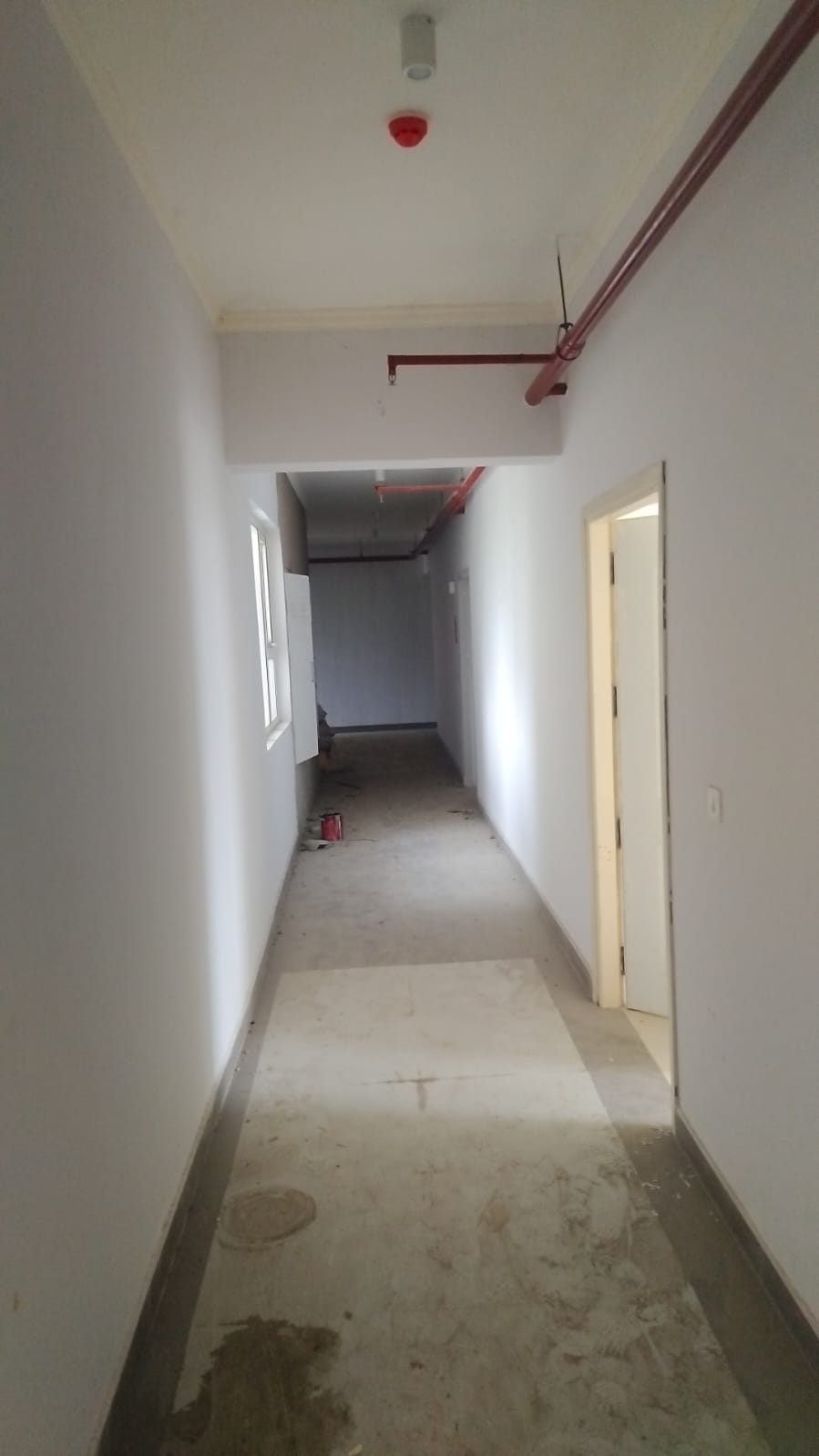

Tower-4 3 Under Construction

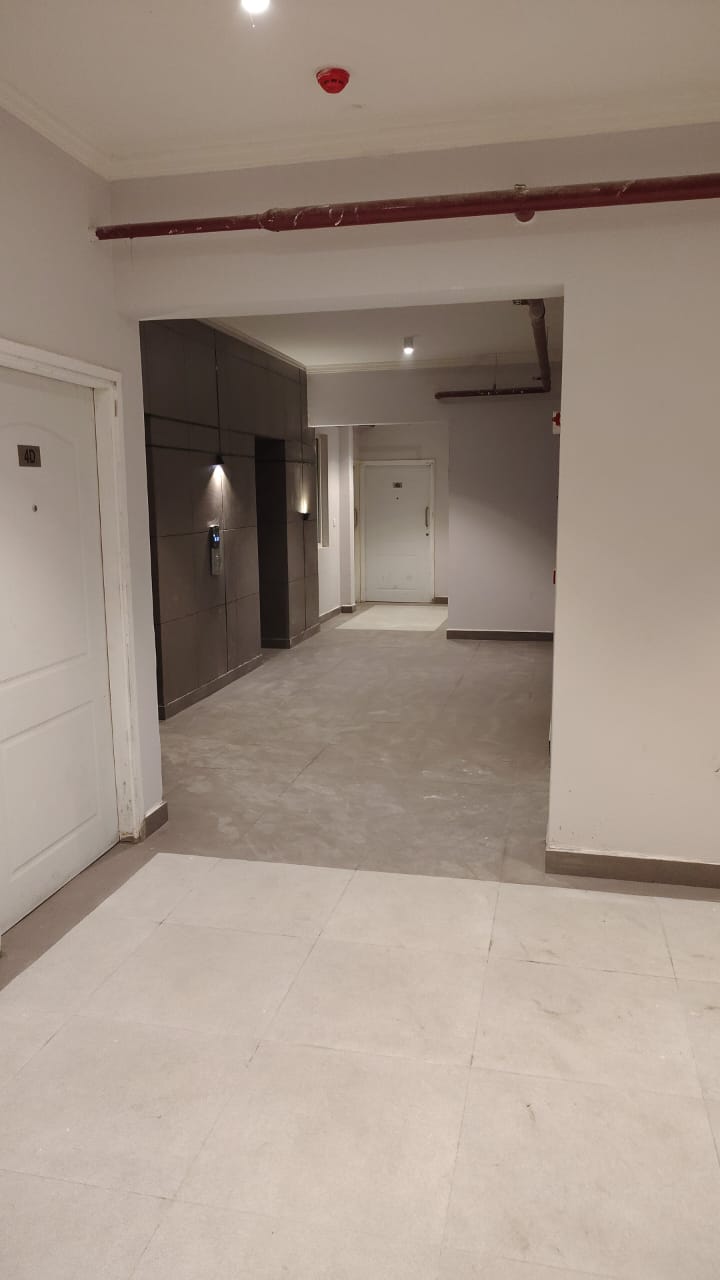

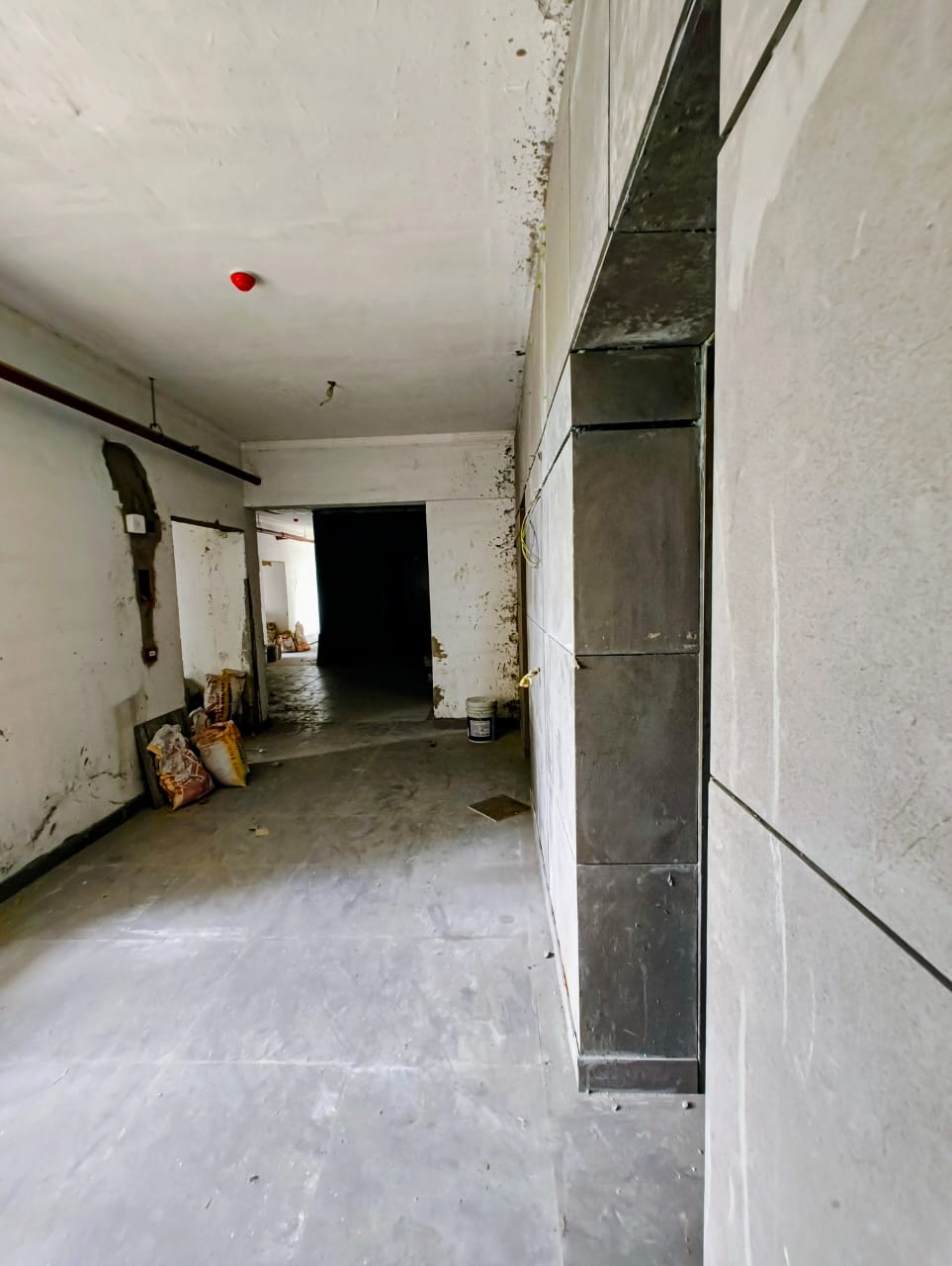

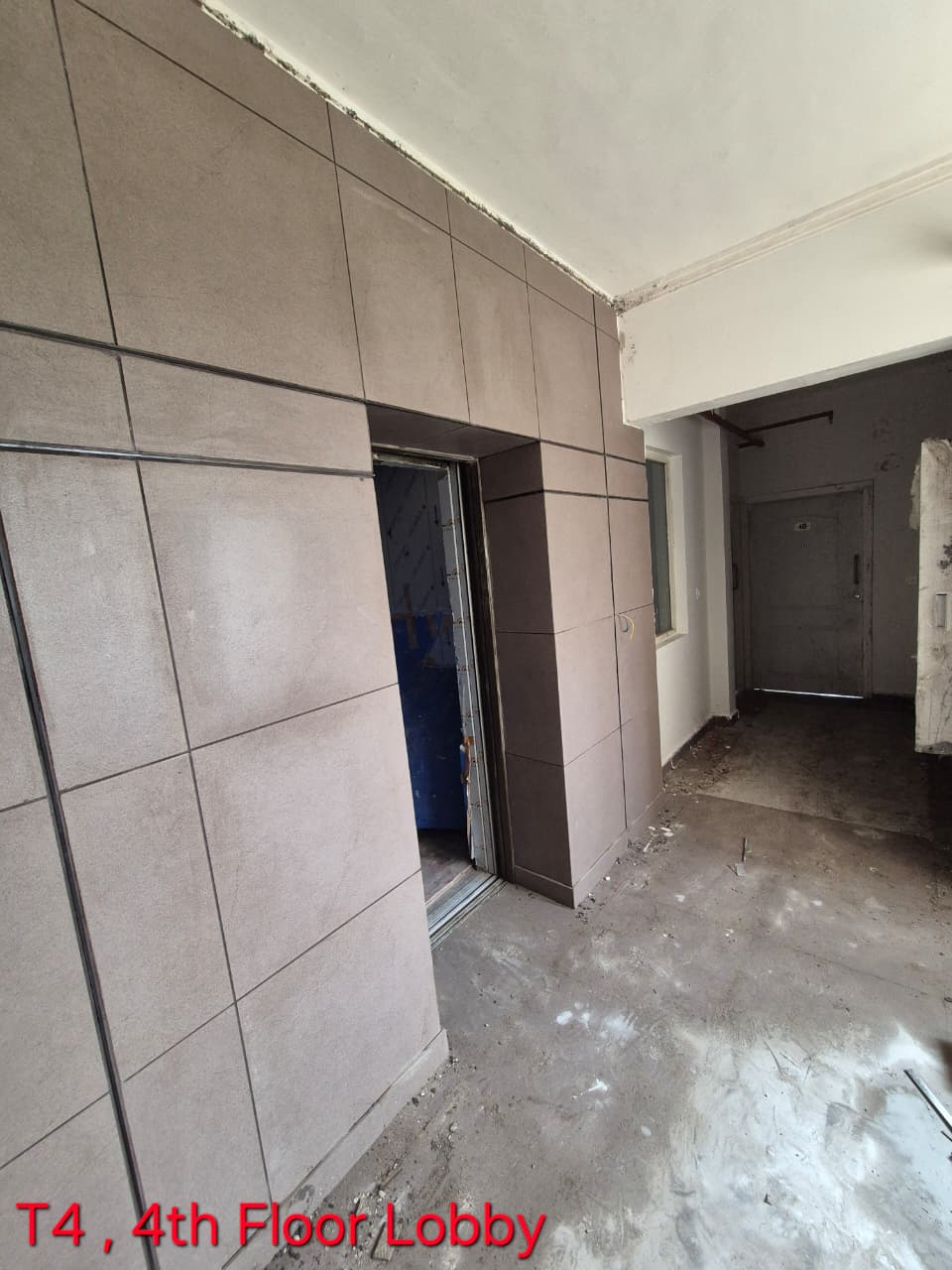

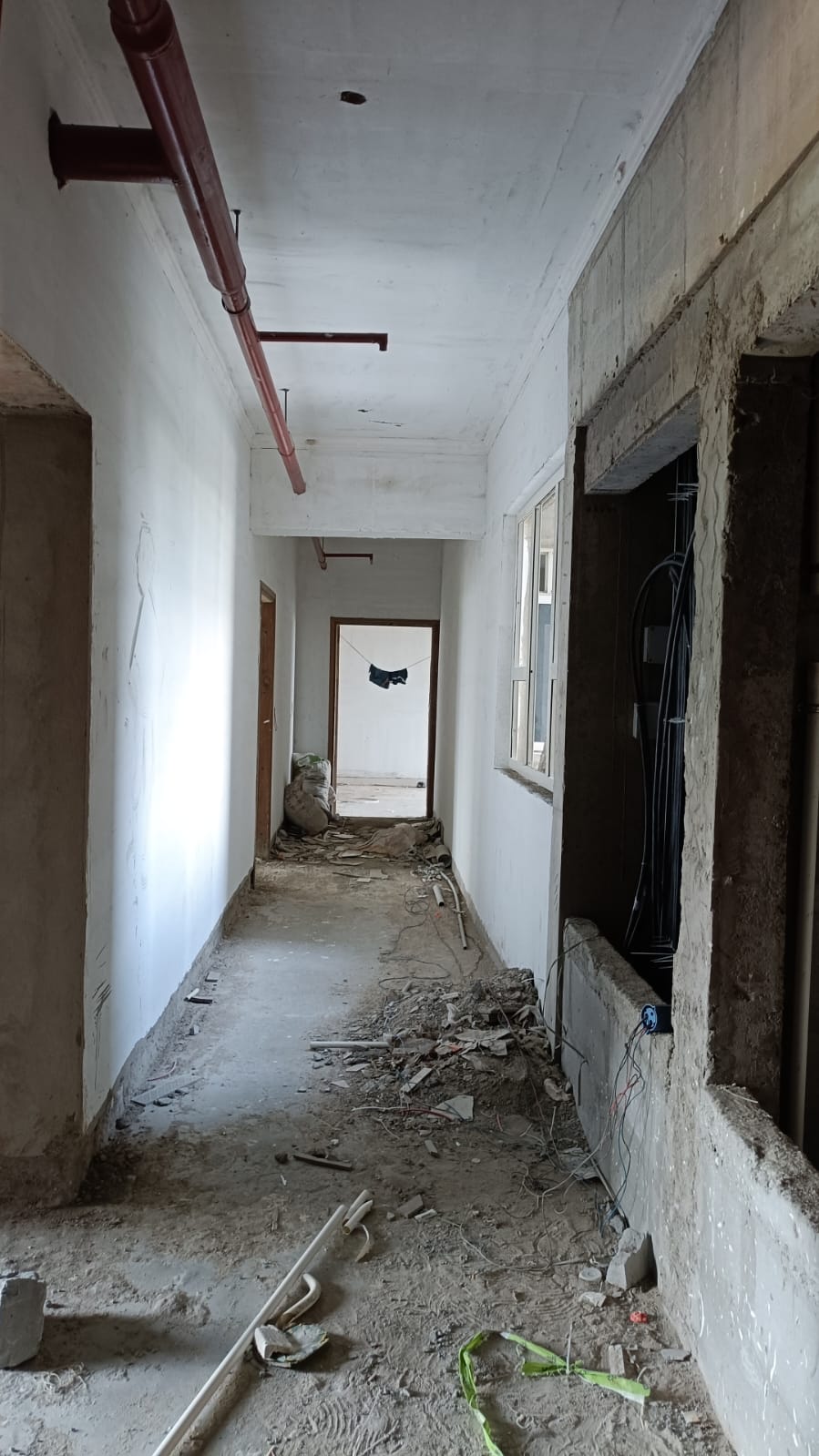

Tower-4 4 Under Construction

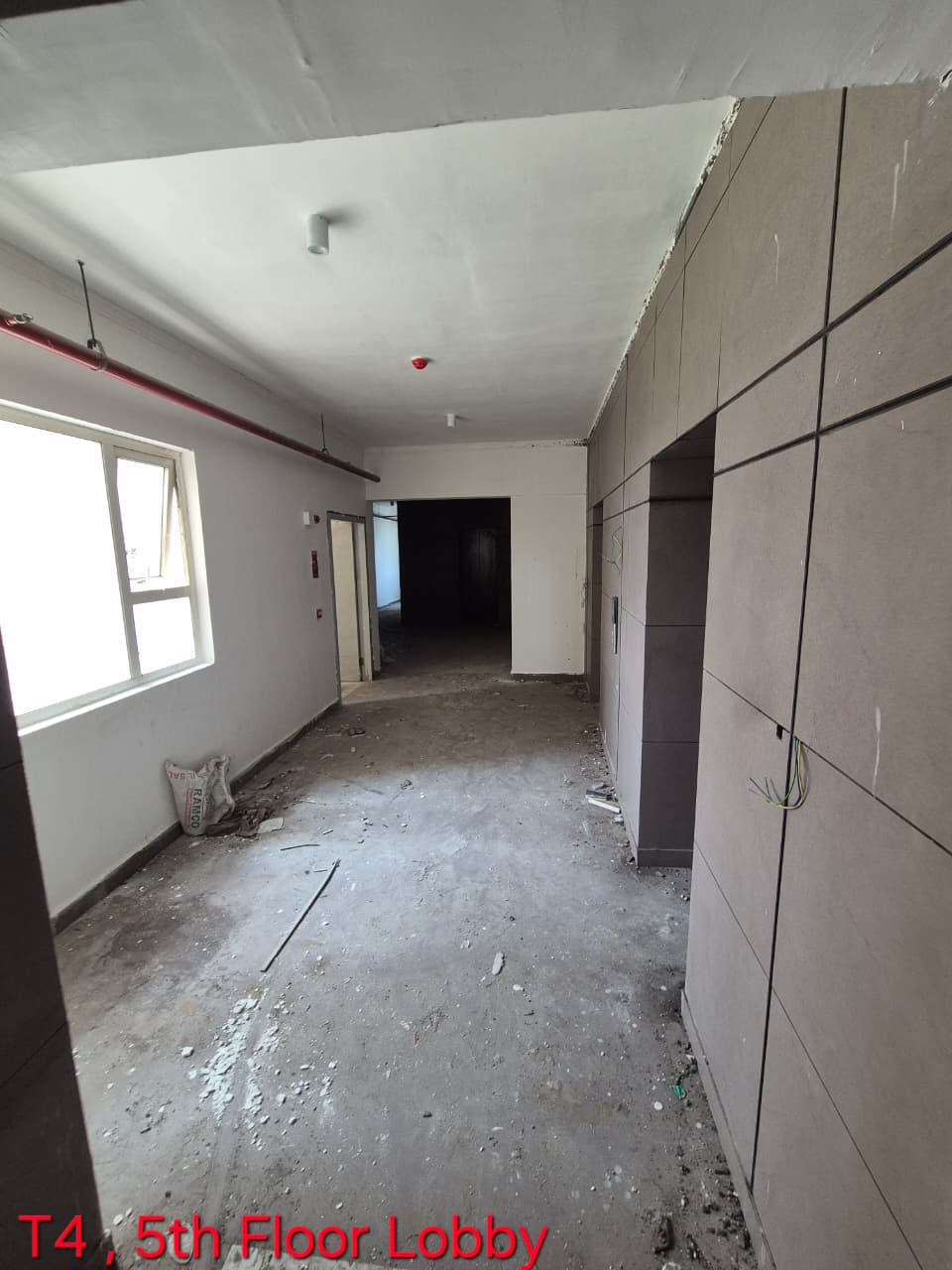

Tower-4 5 Under Construction

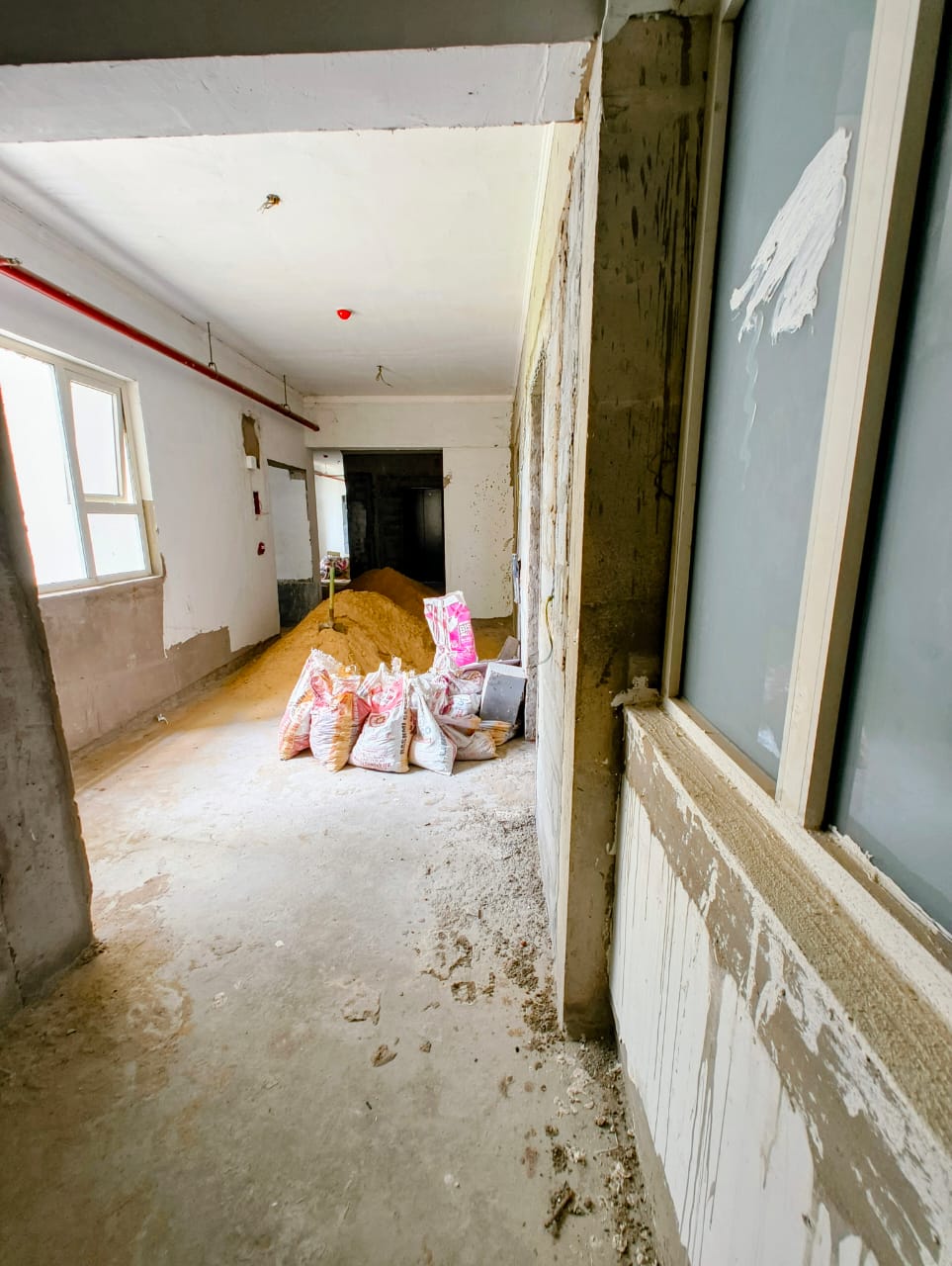

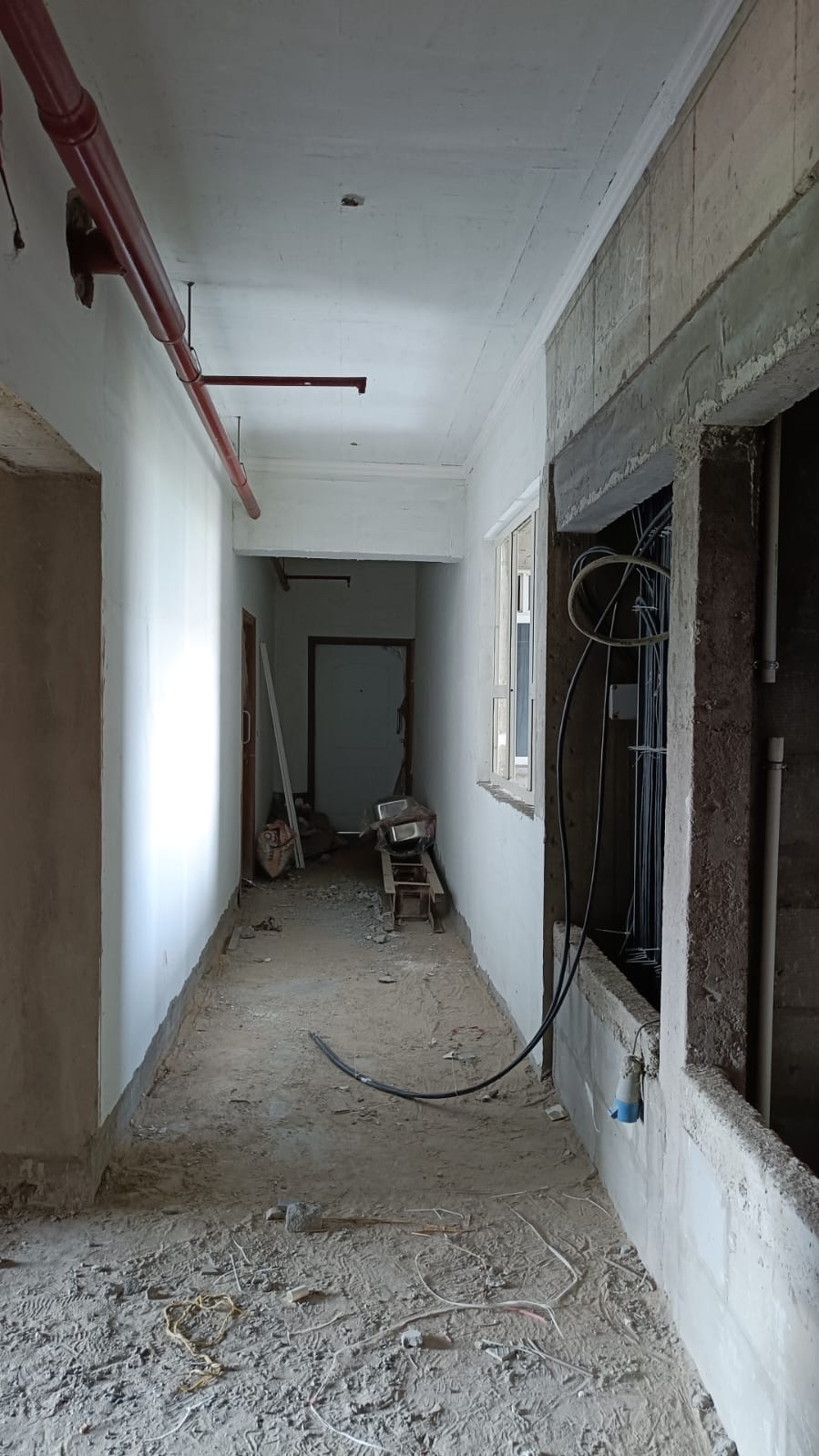

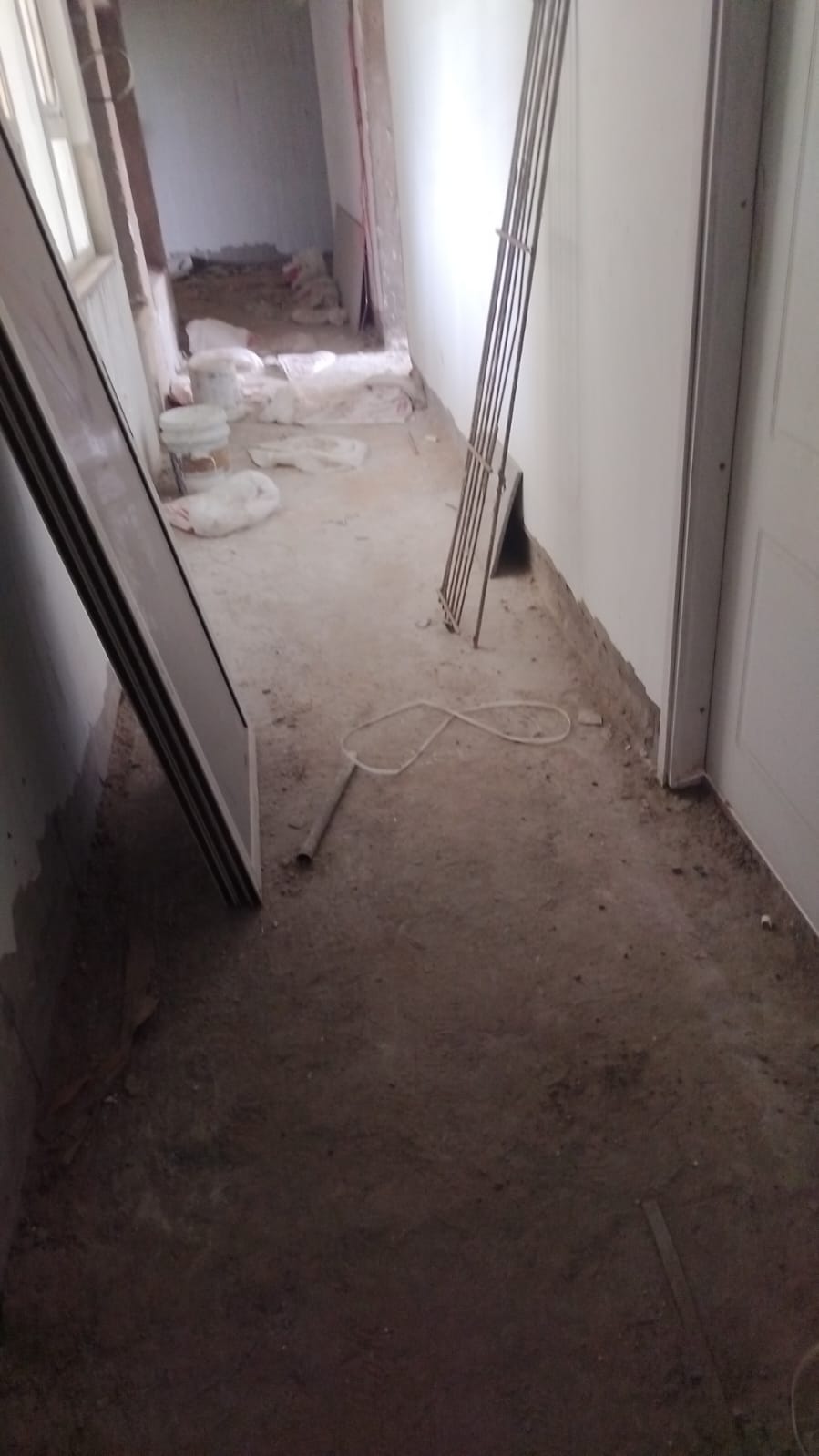

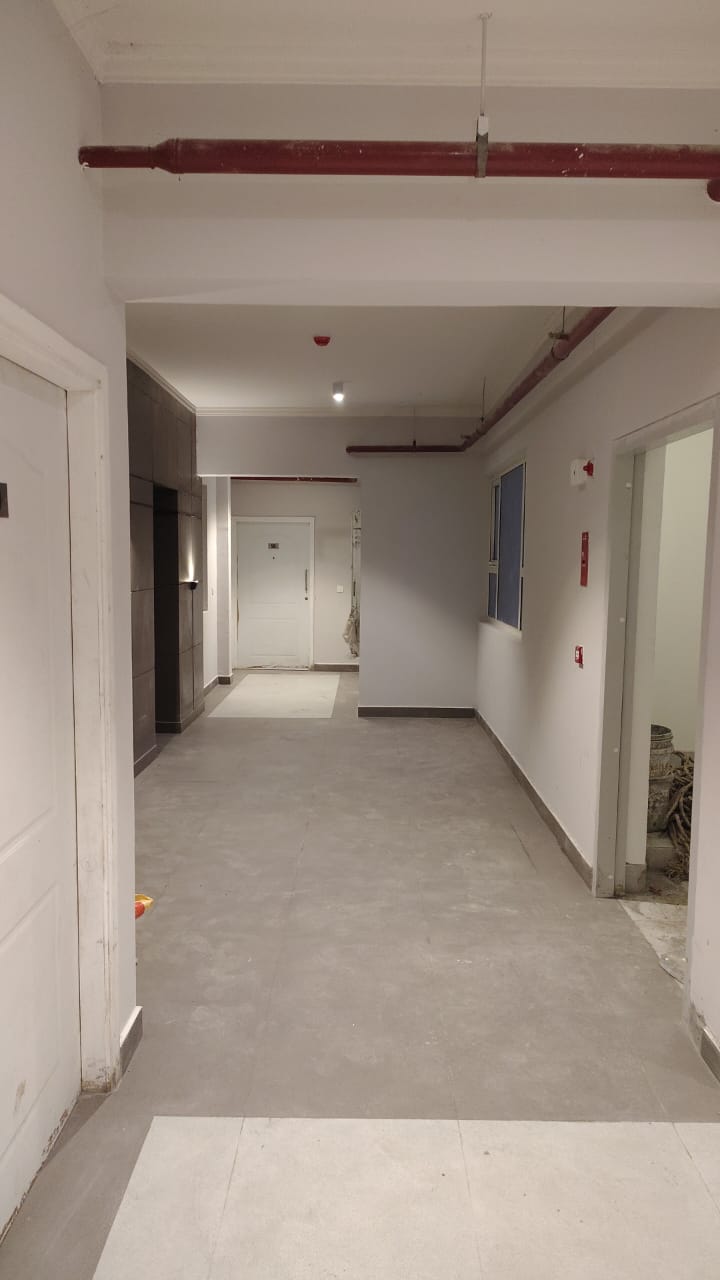

Tower-4 6 Under Construction

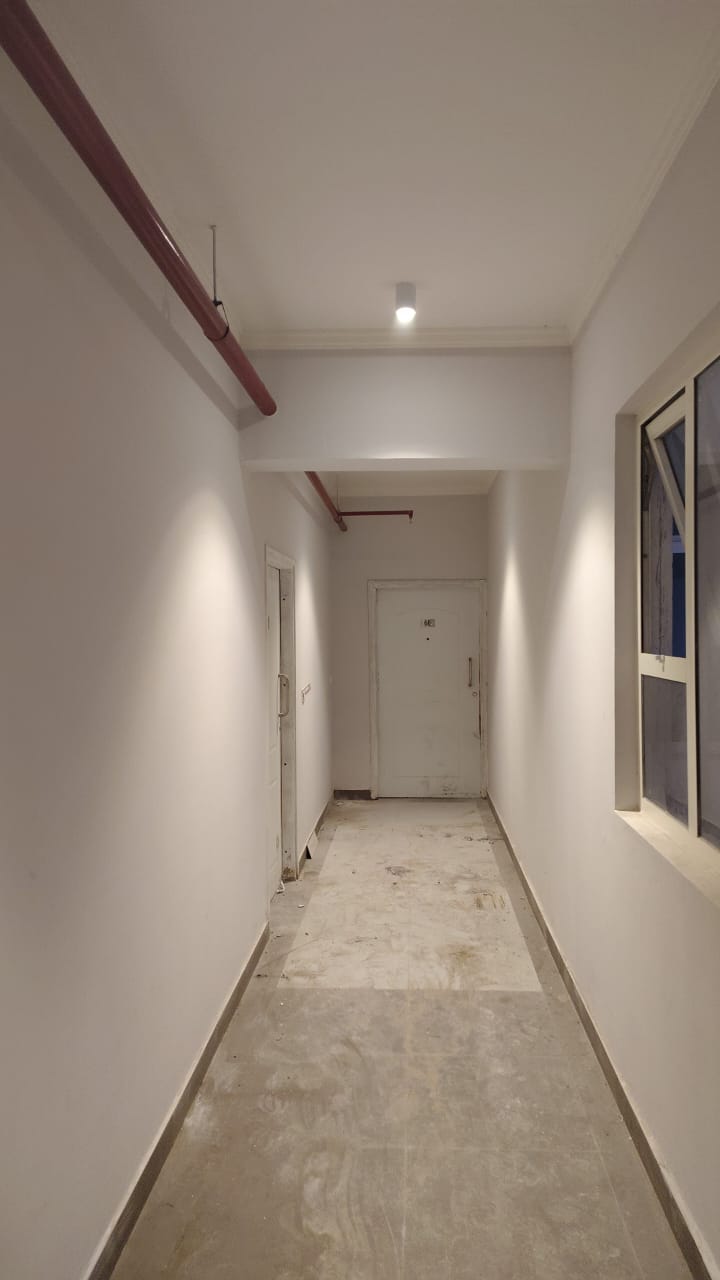

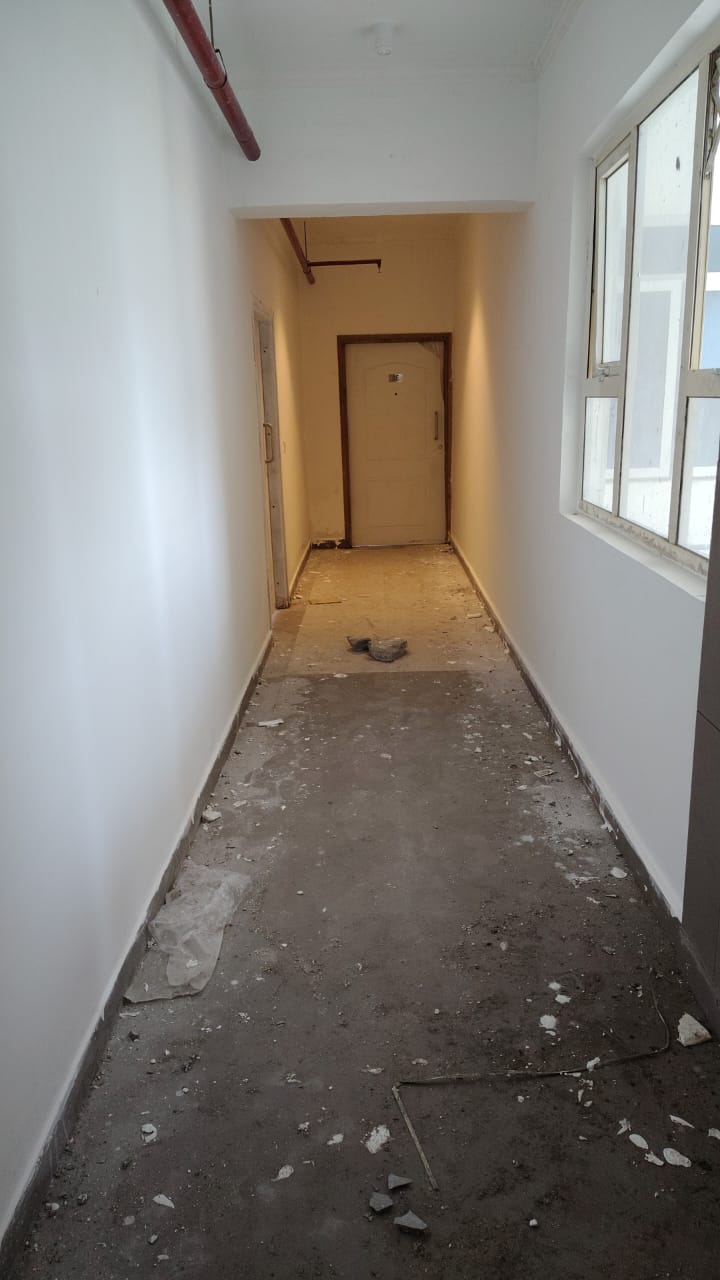

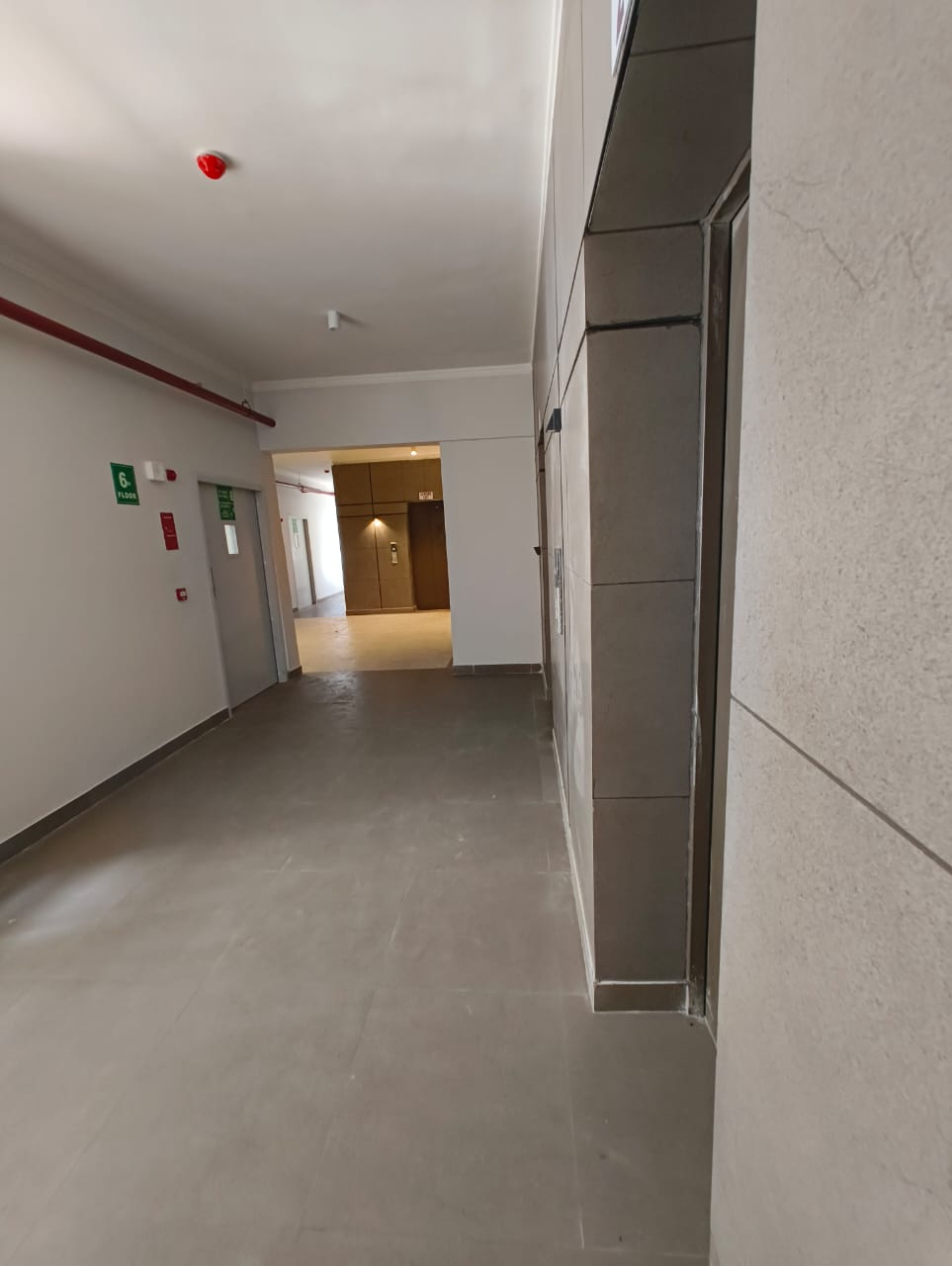

Tower-4 7 Under Construction

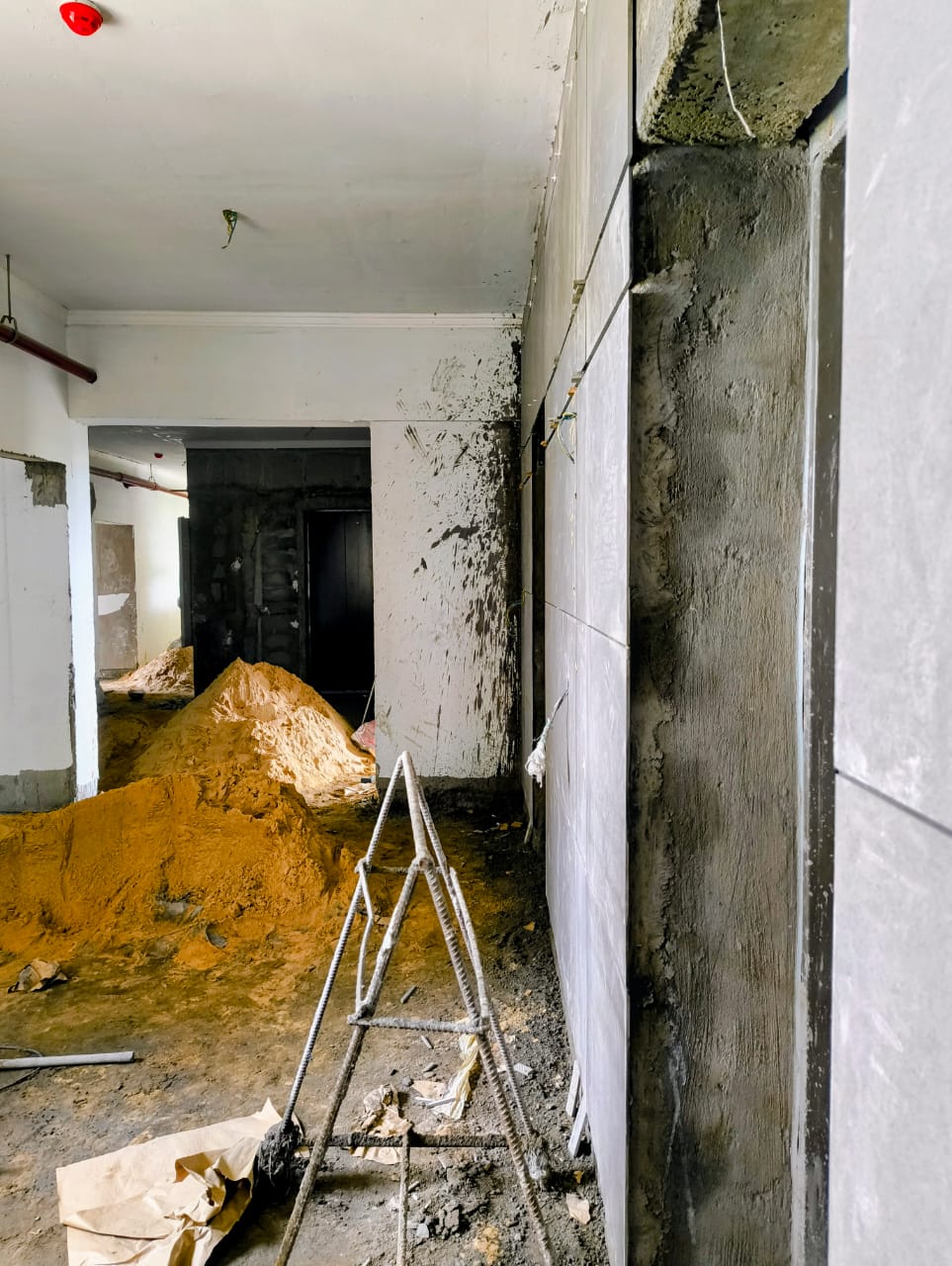

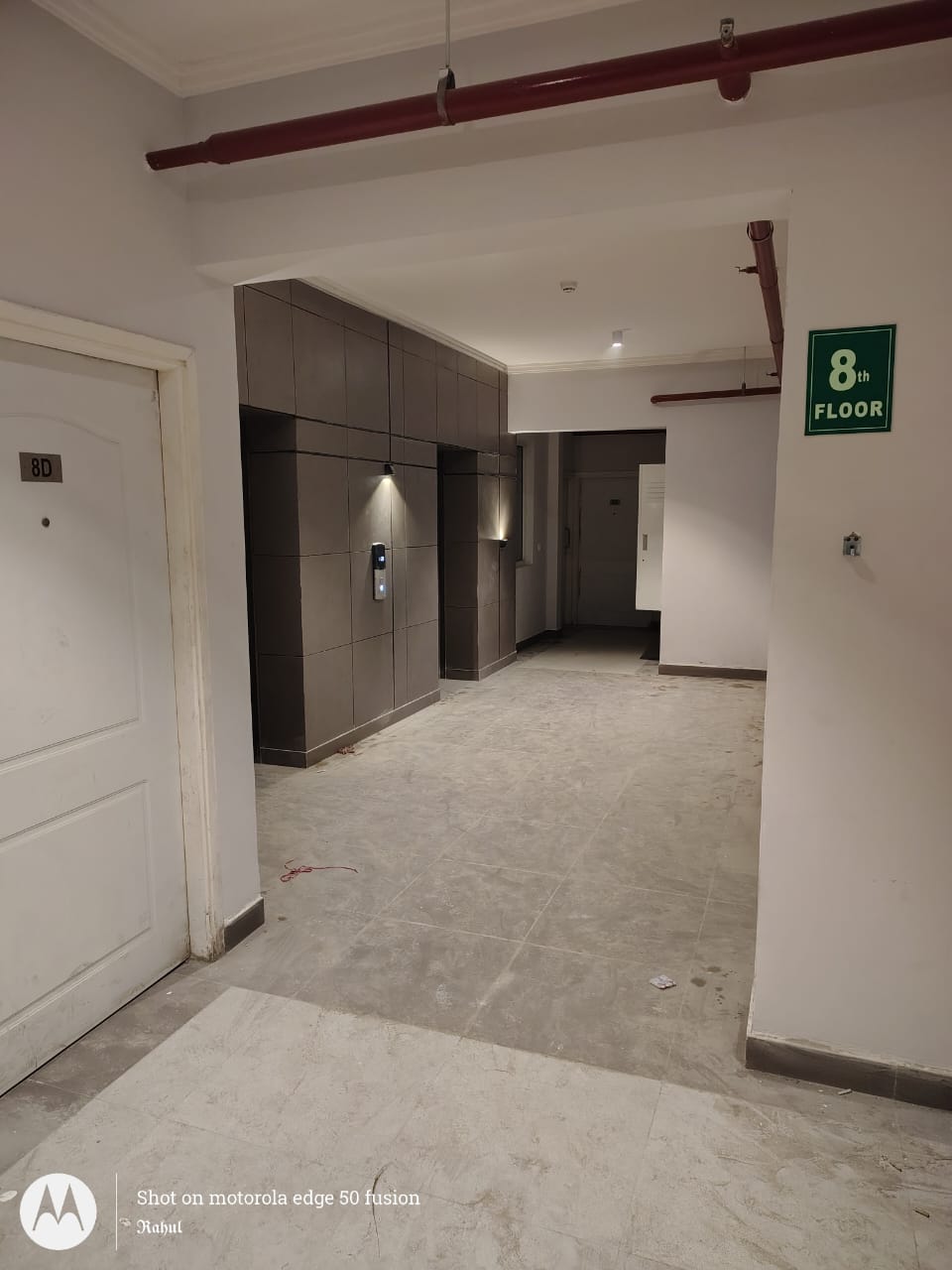

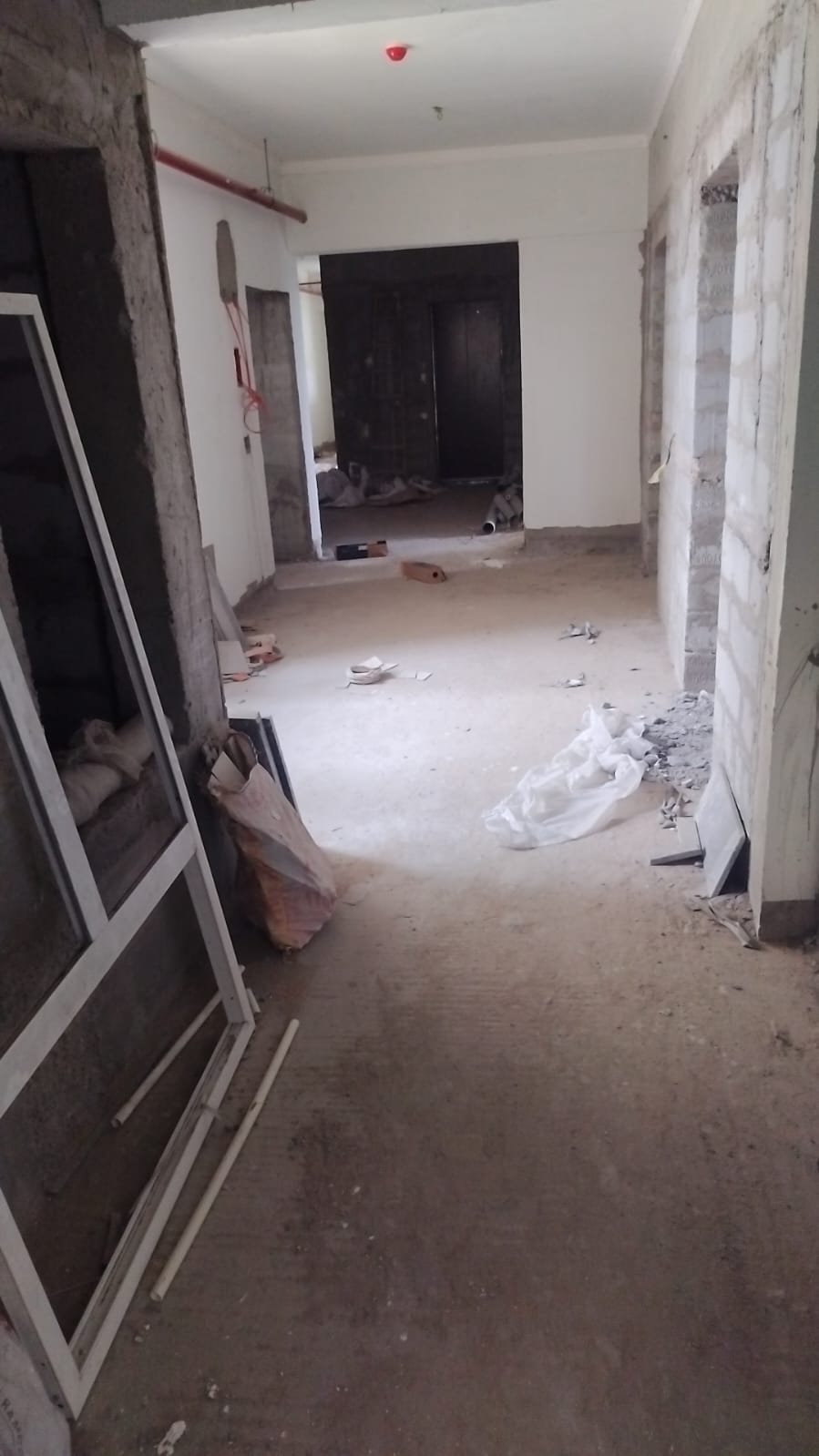

Tower-4 8 Under Construction

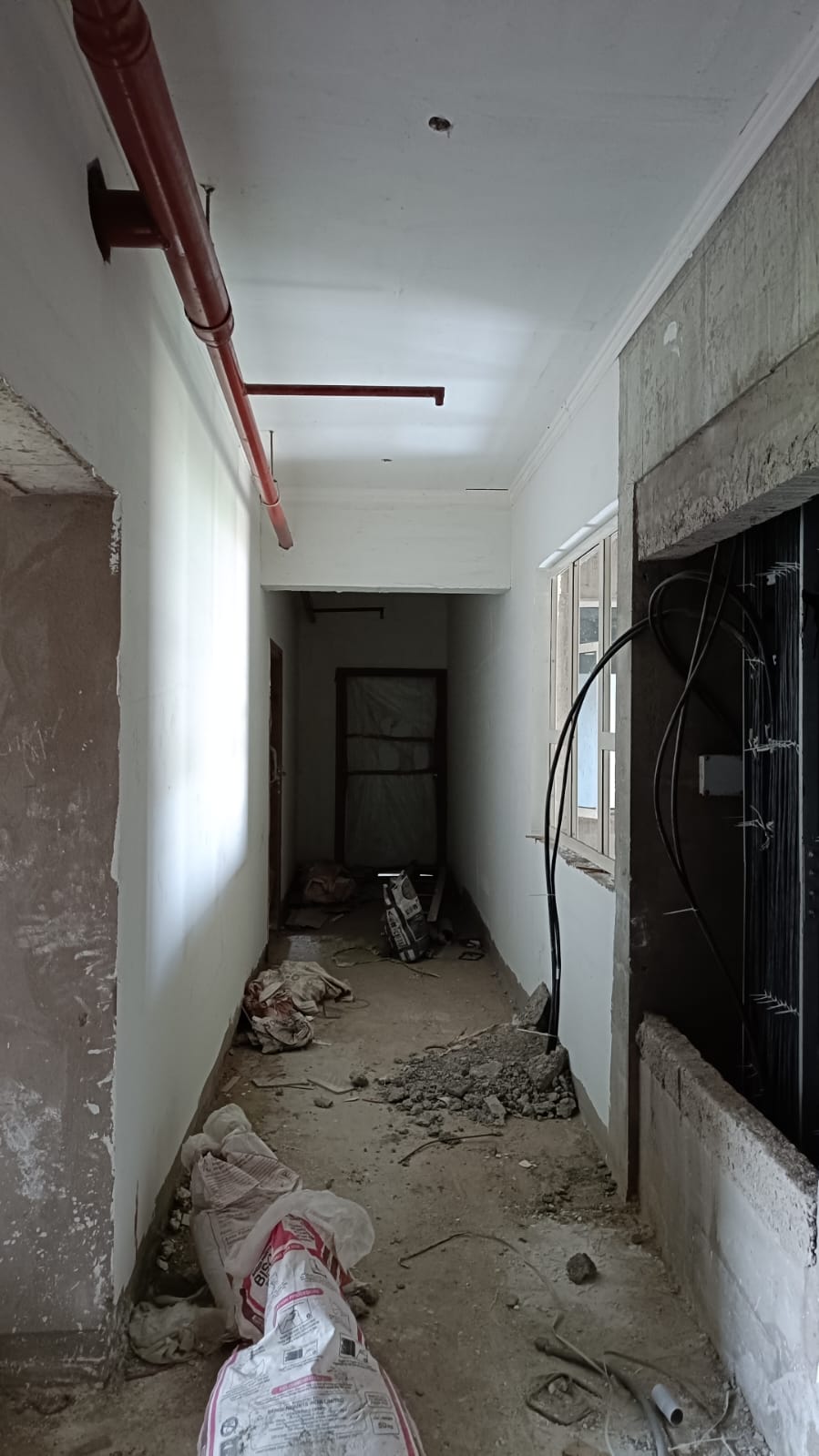

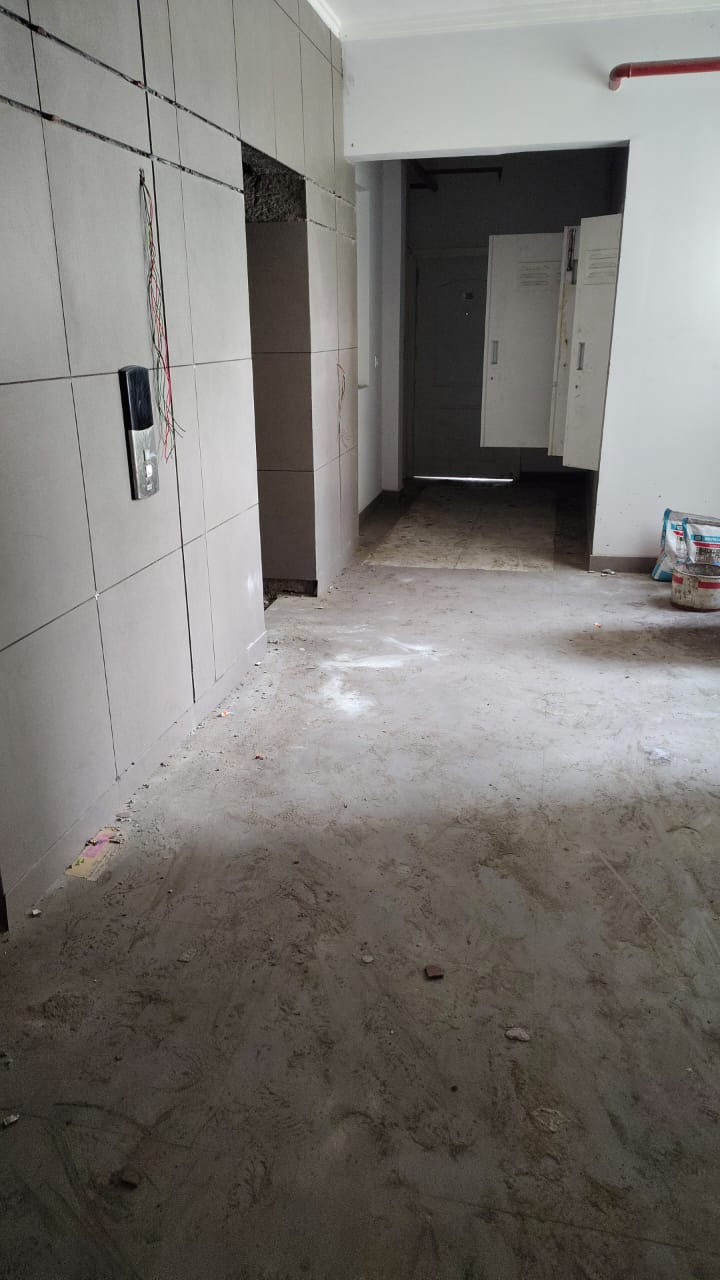

Tower-4 9 Under Construction

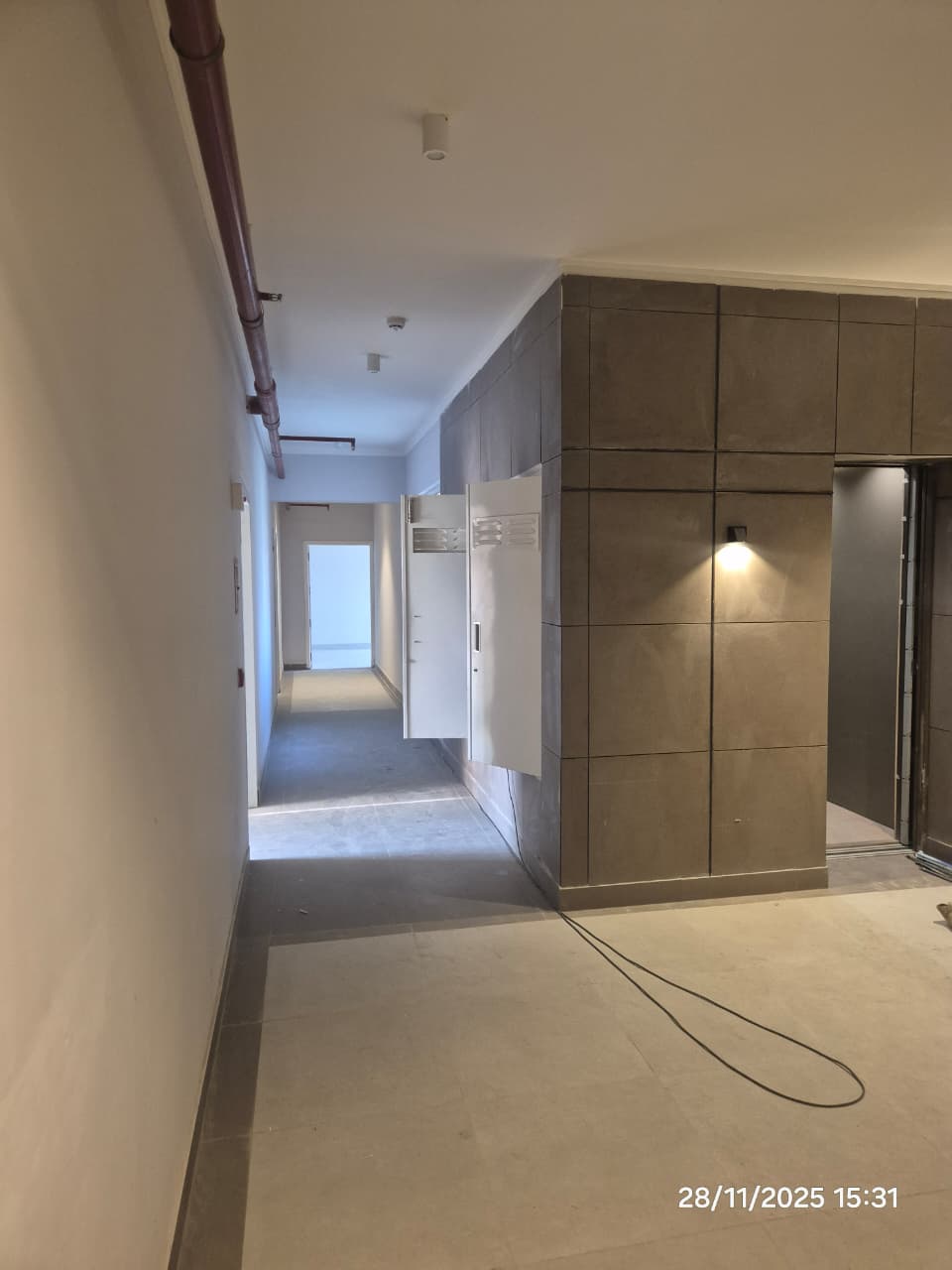

Tower-4 10 Under Construction

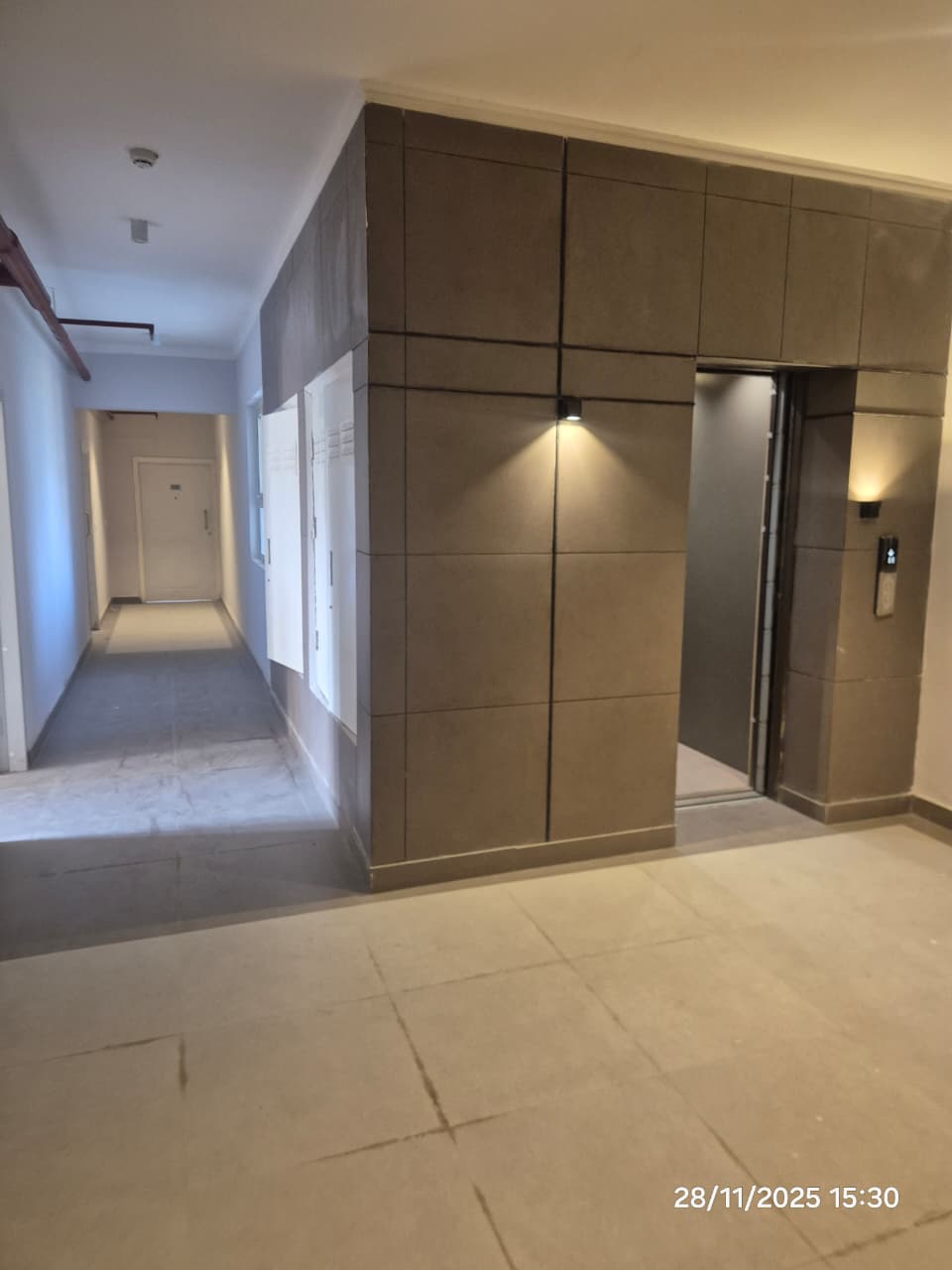

Tower-4 11 Under Construction

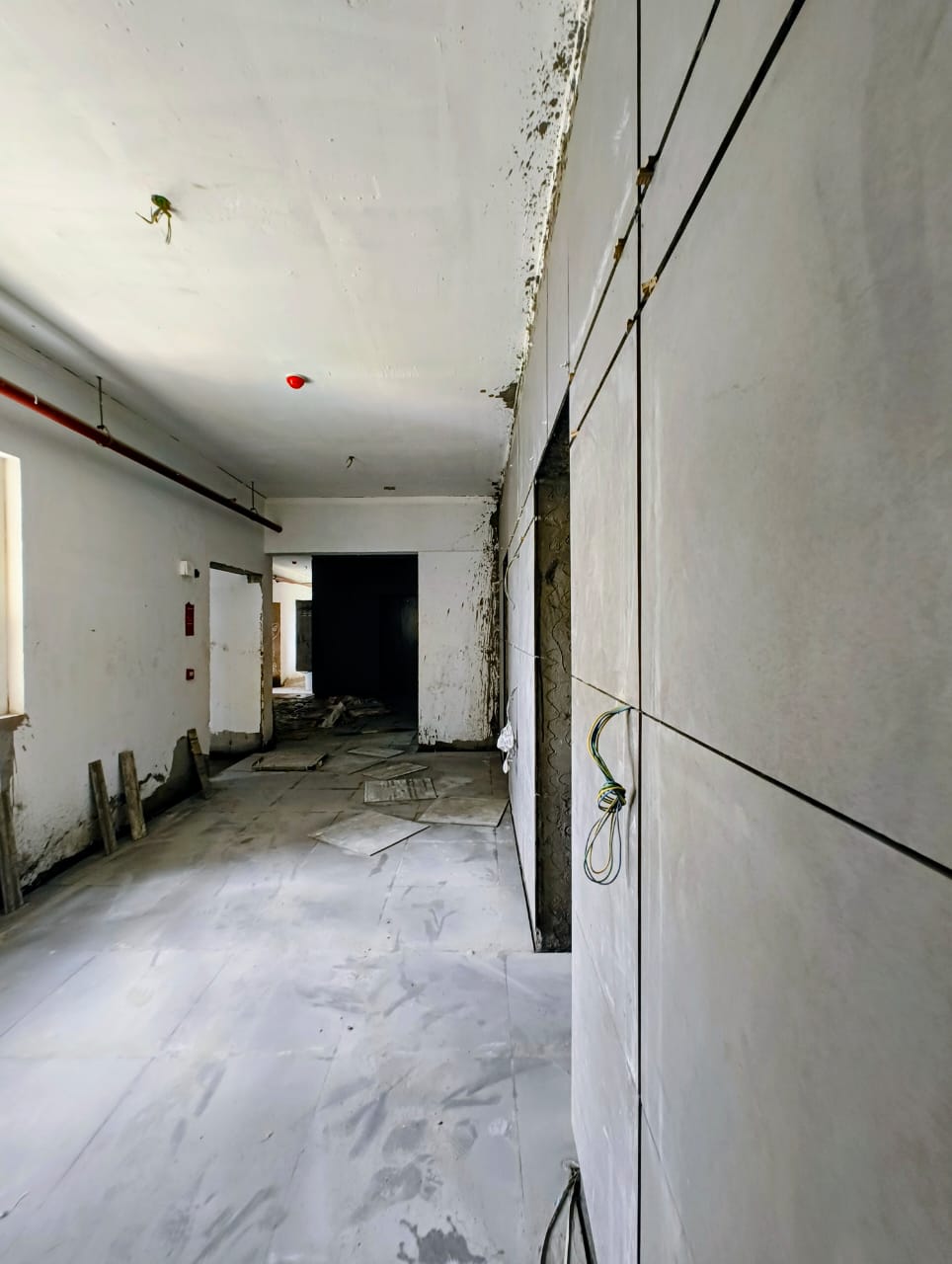

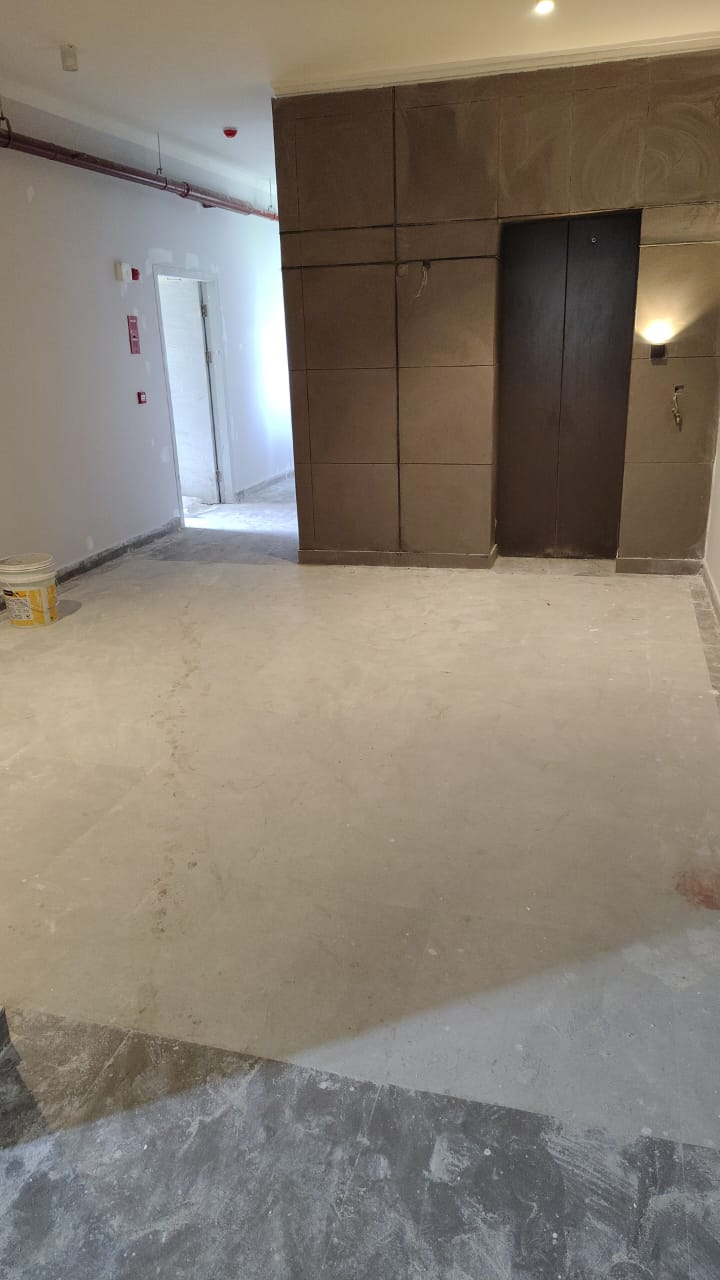

Tower-4 12 Under Construction

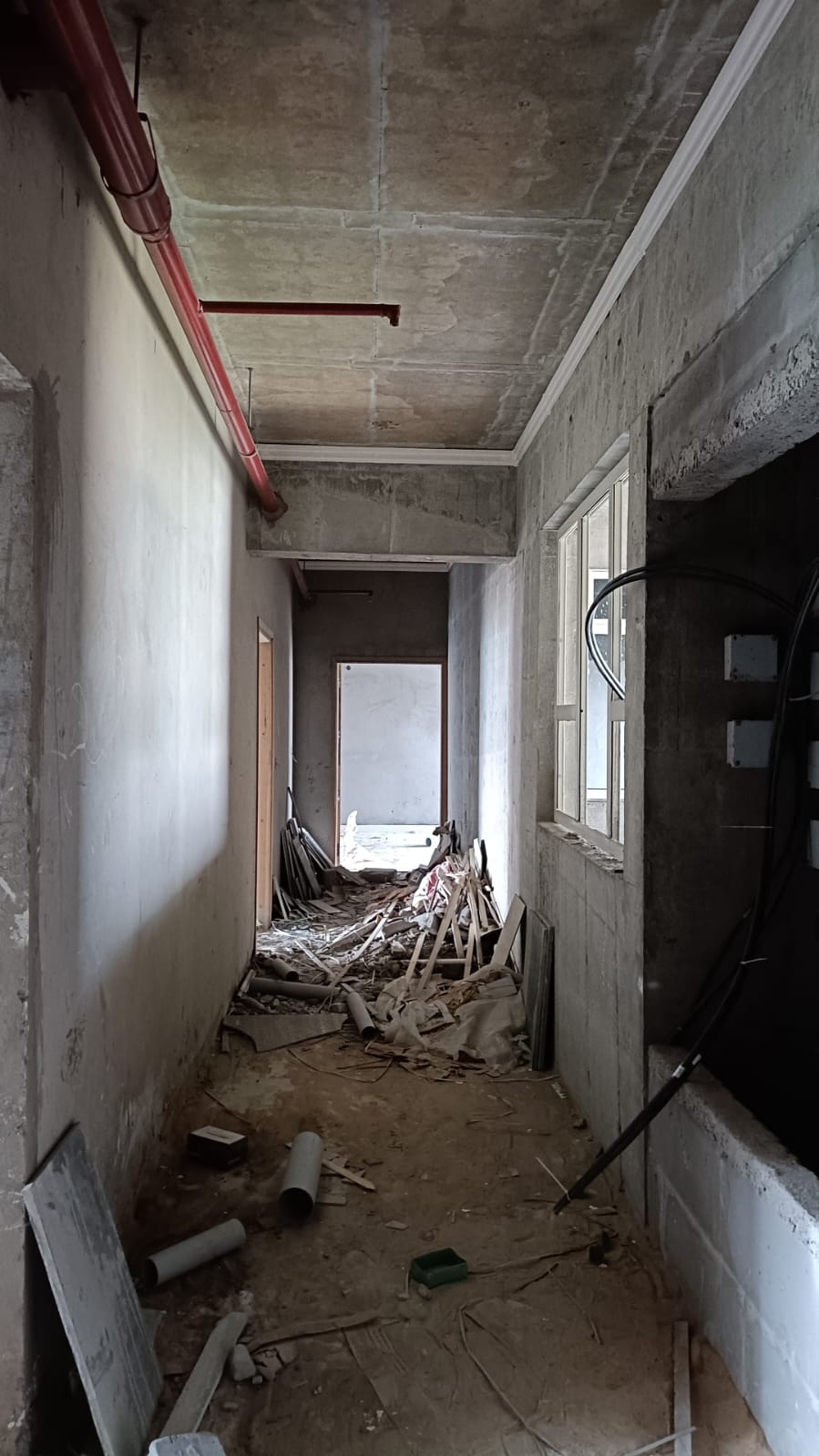

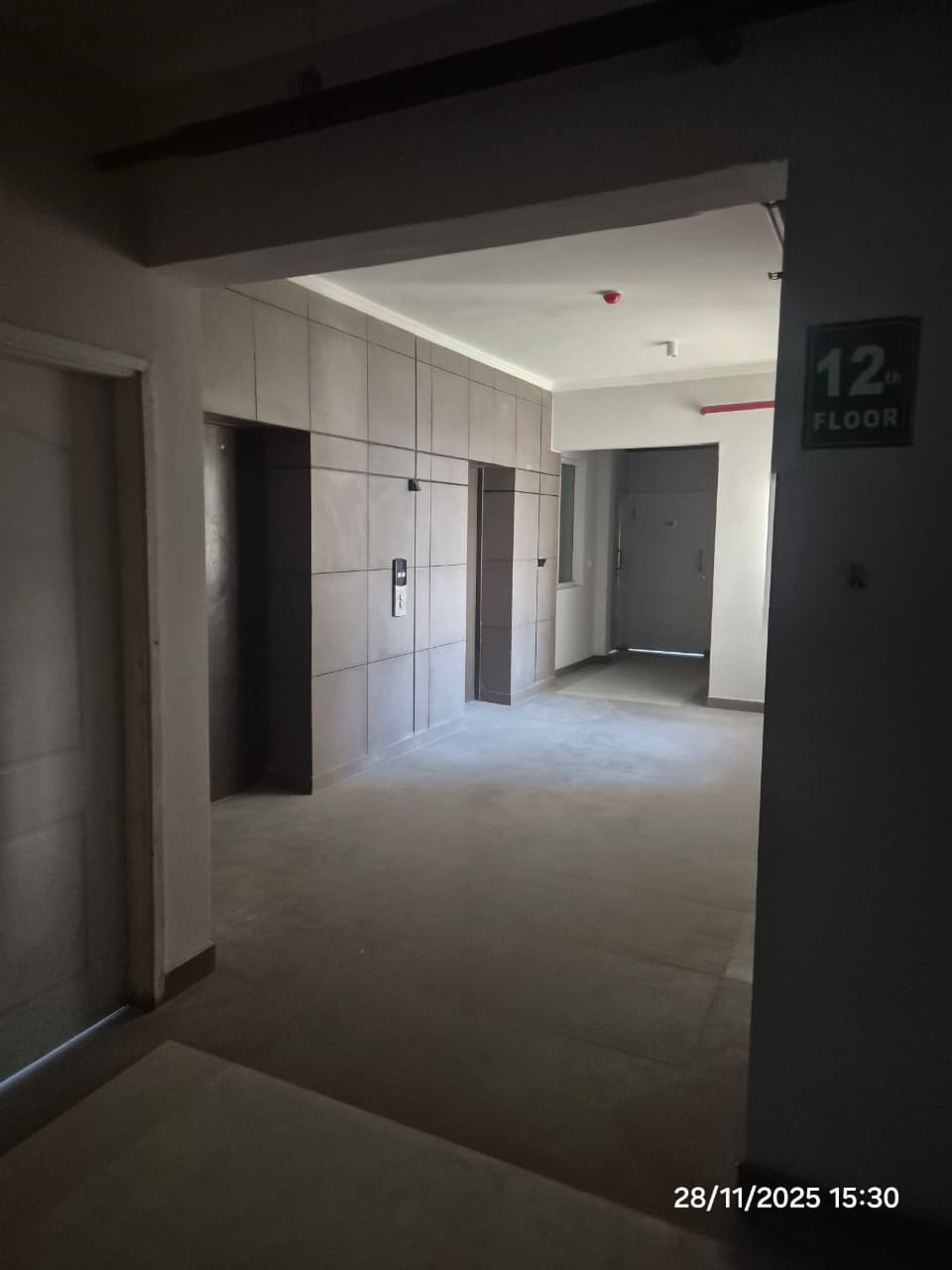

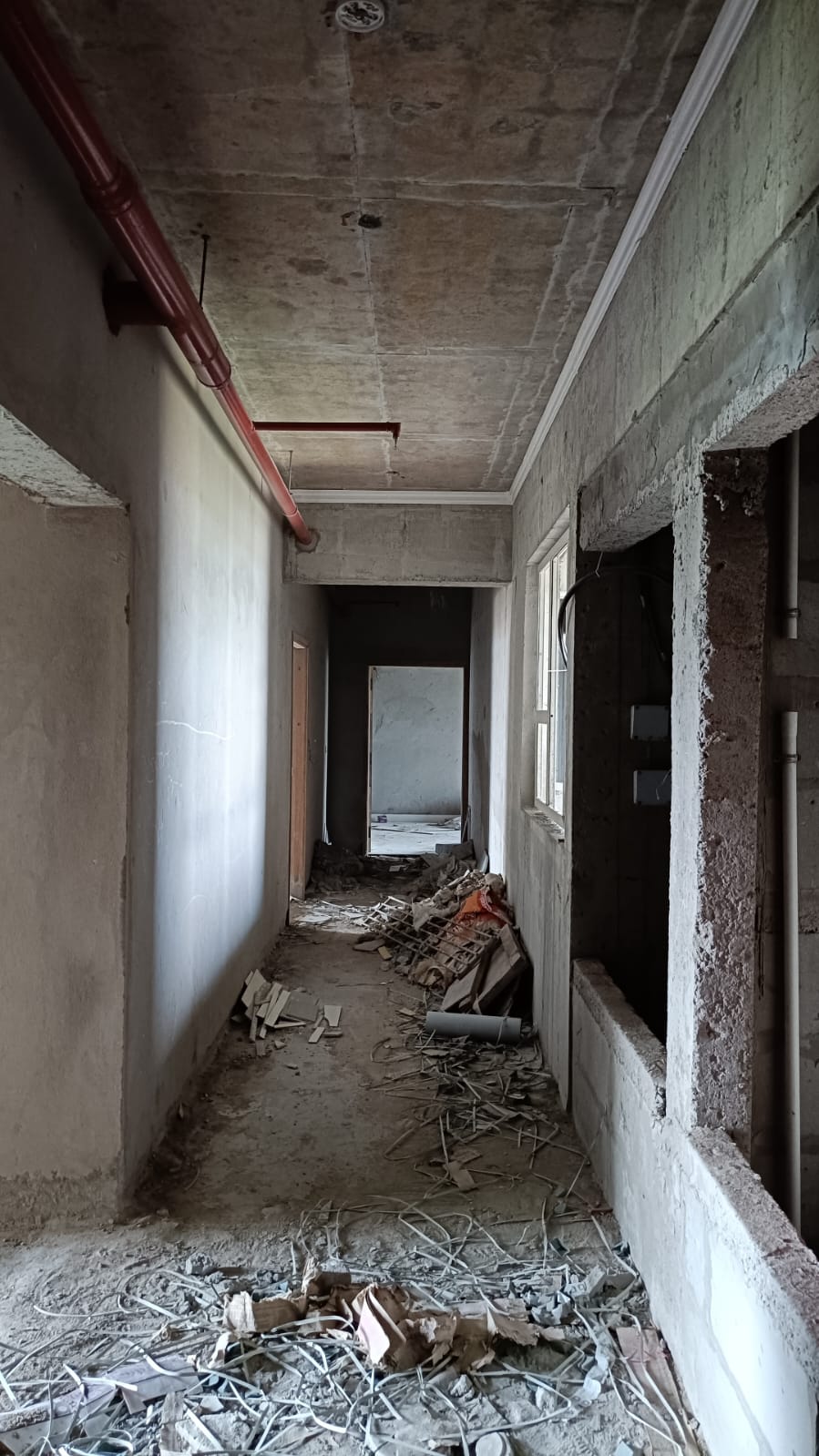

Tower-4 13 Under Construction

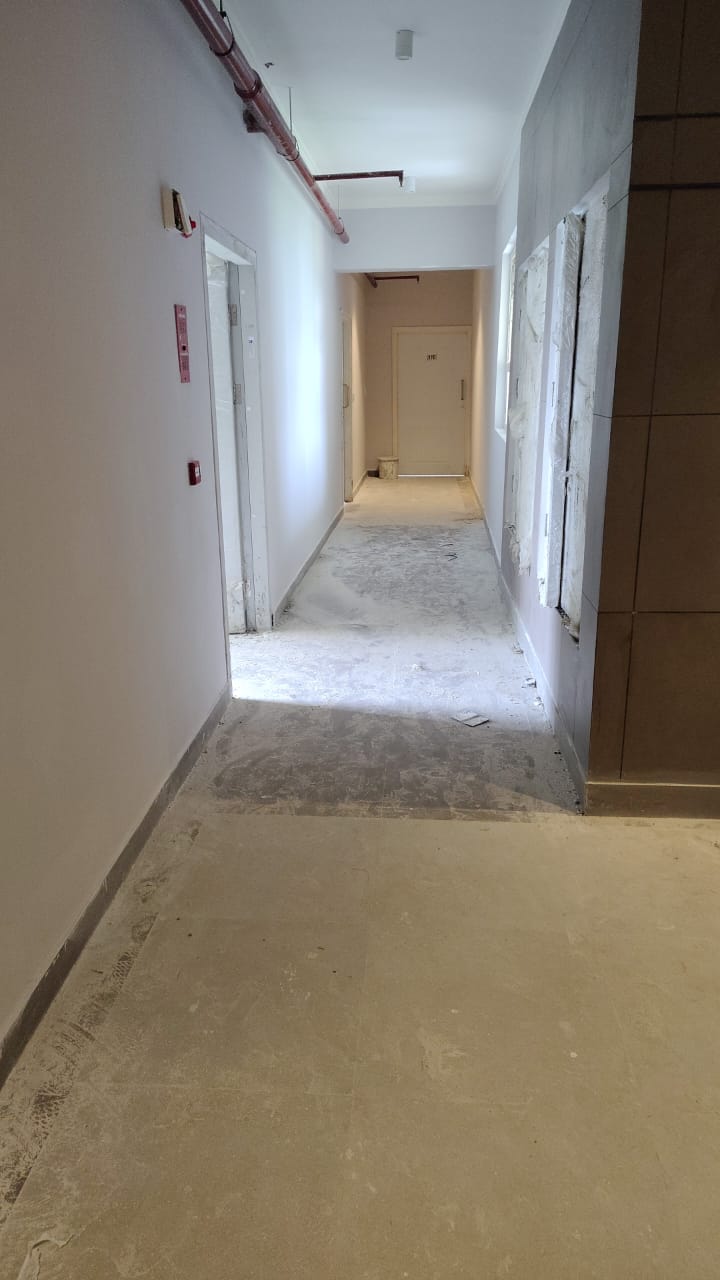

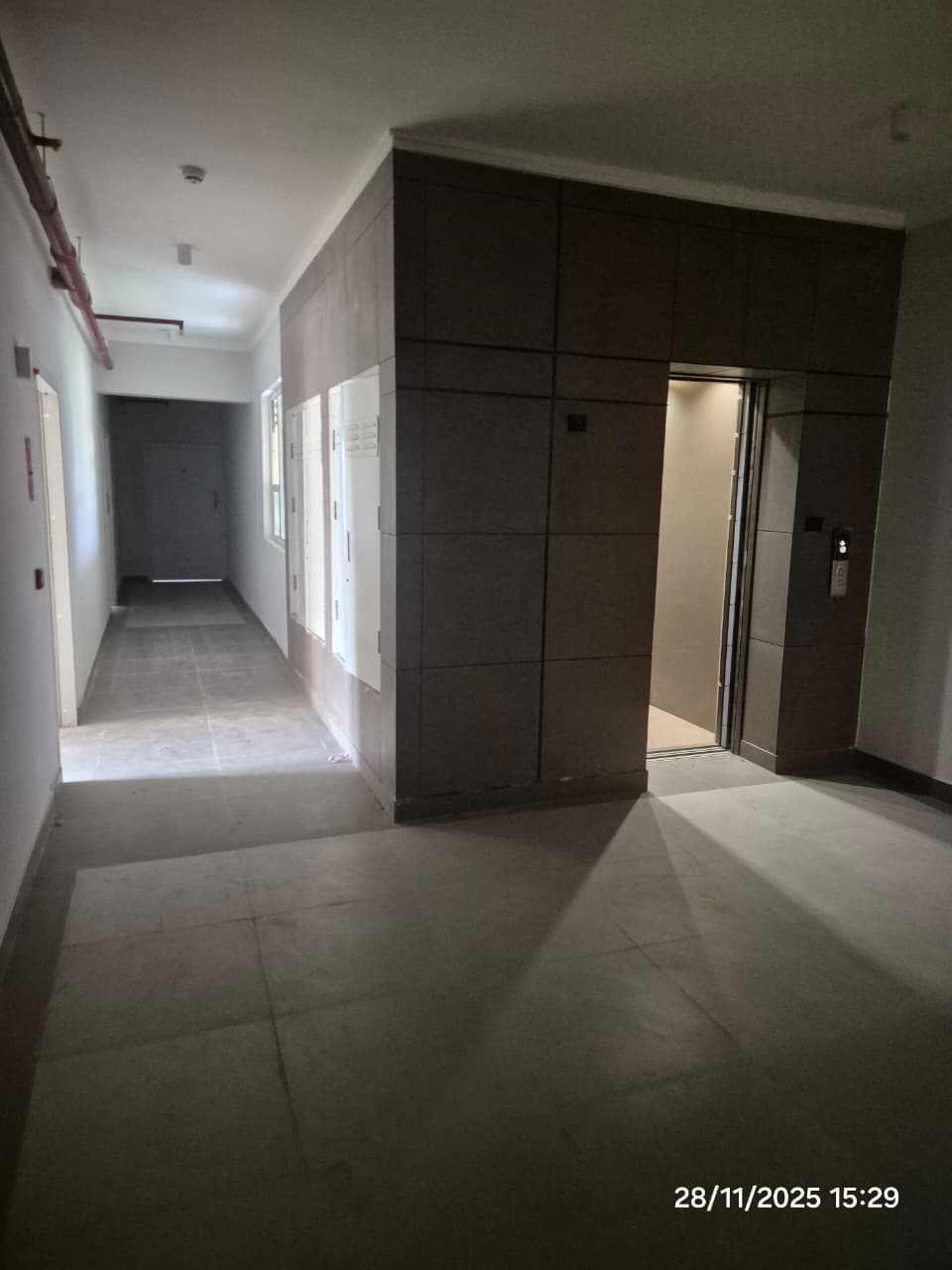

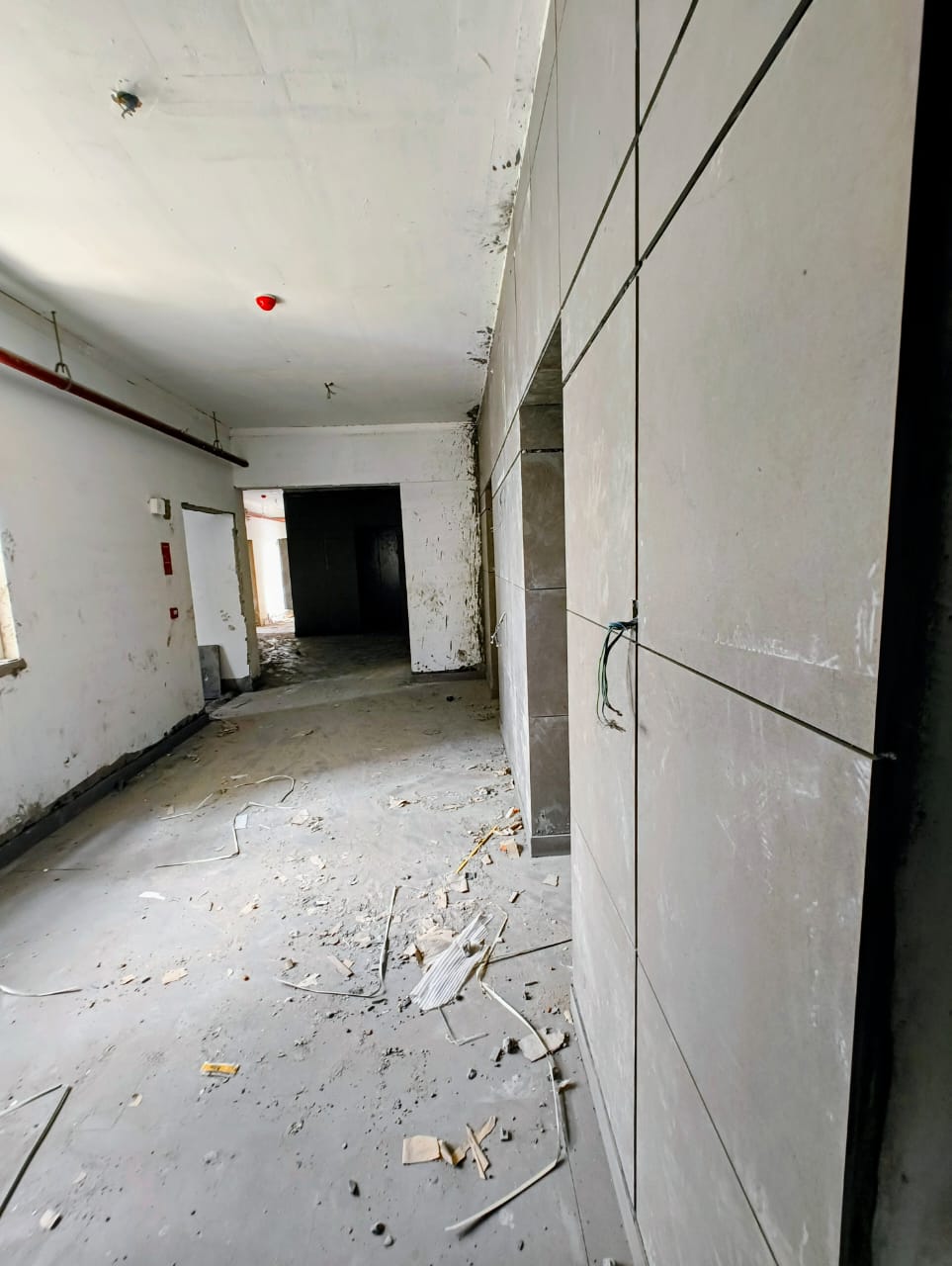

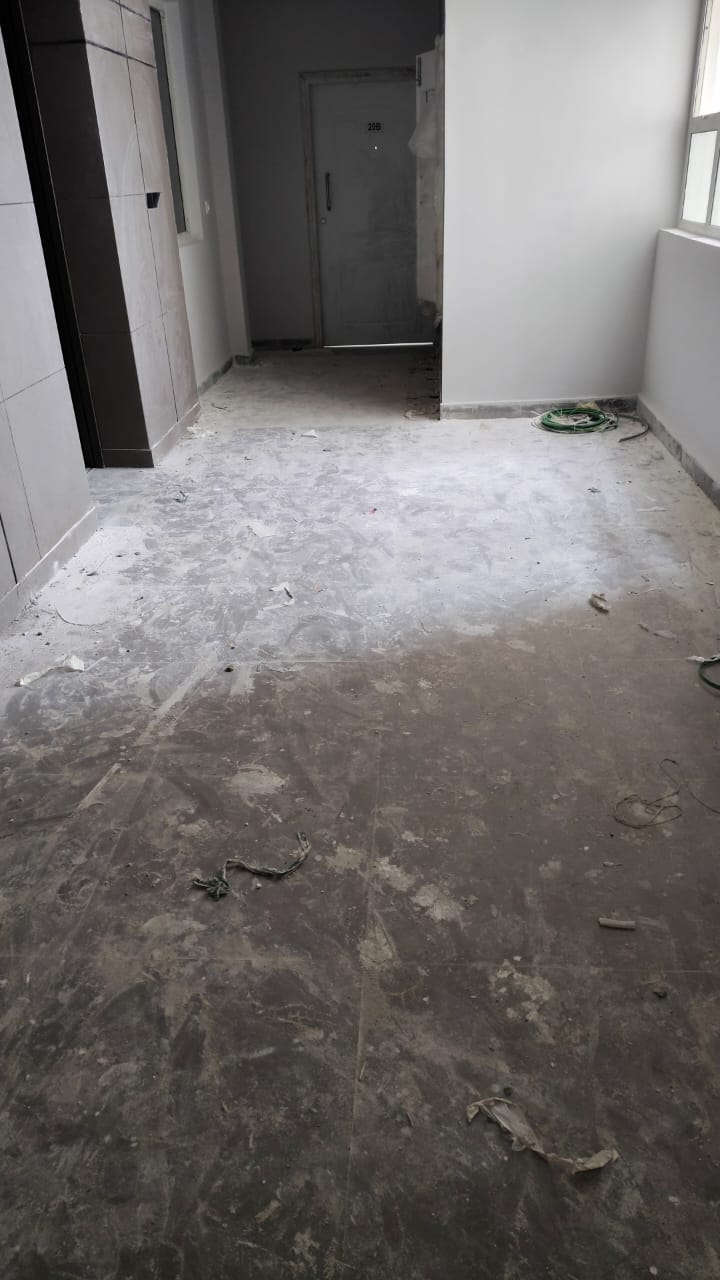

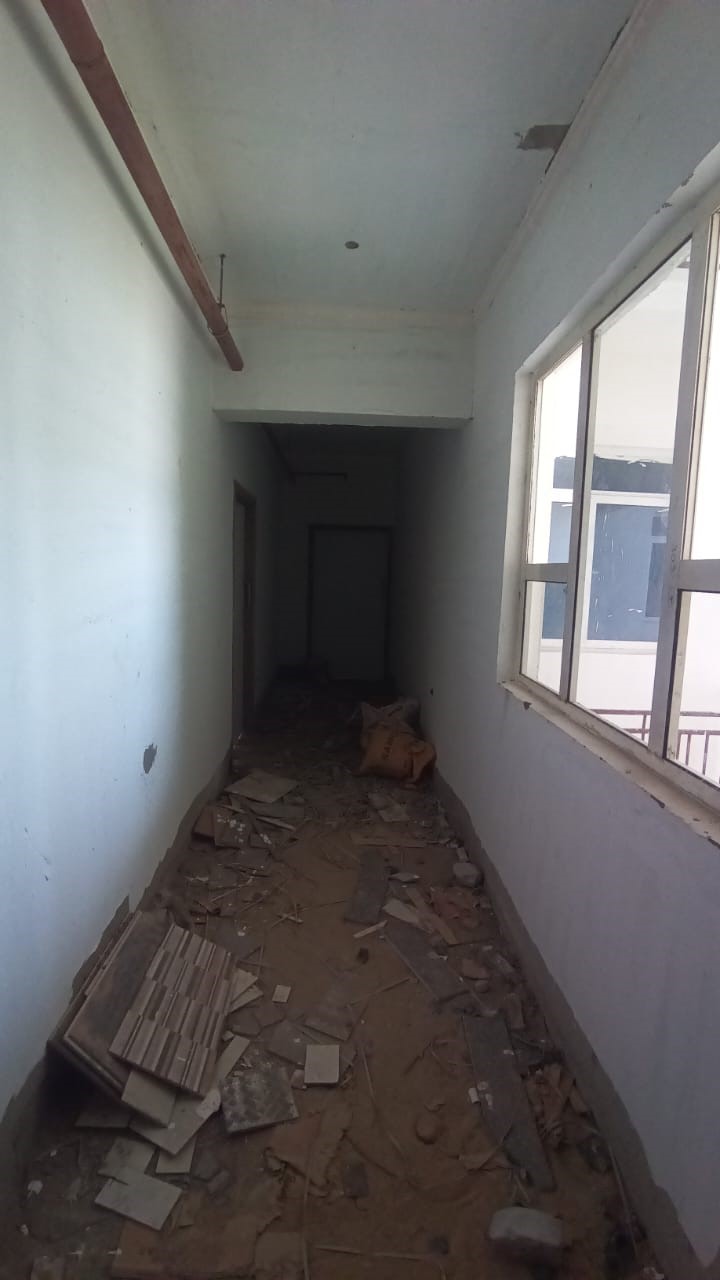

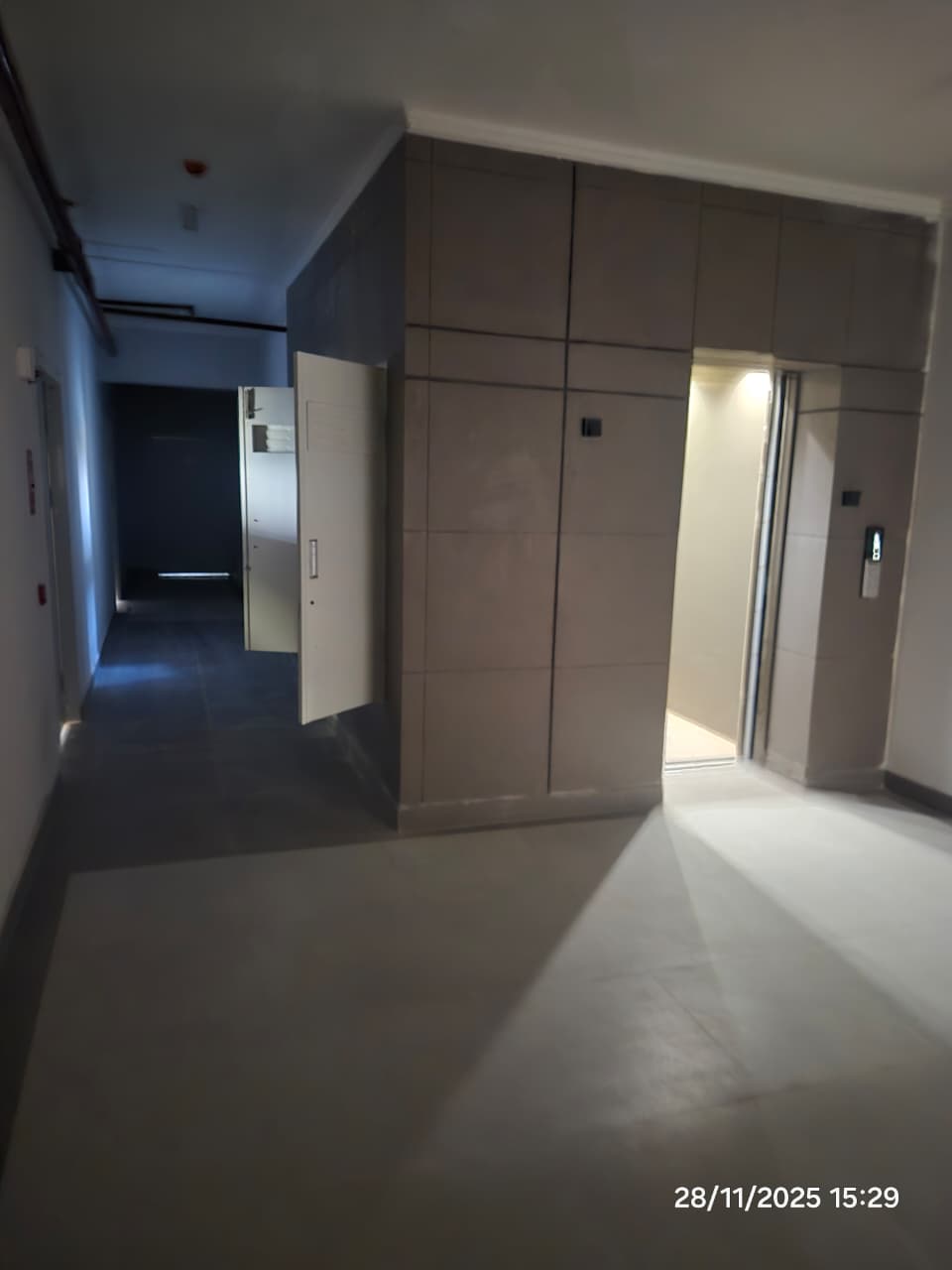

Tower-4 14 Under Construction
Tower-4 15 Under Construction

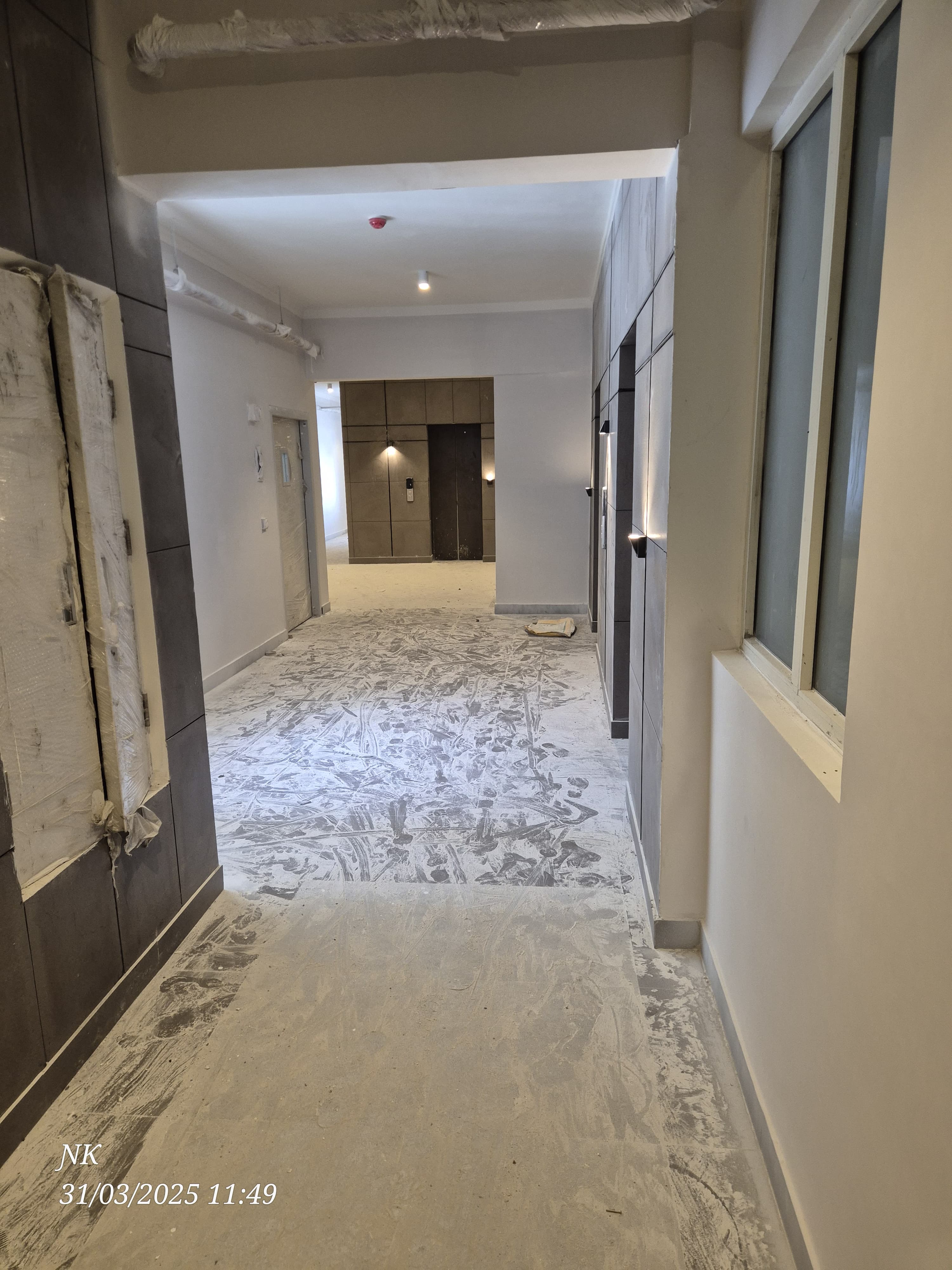

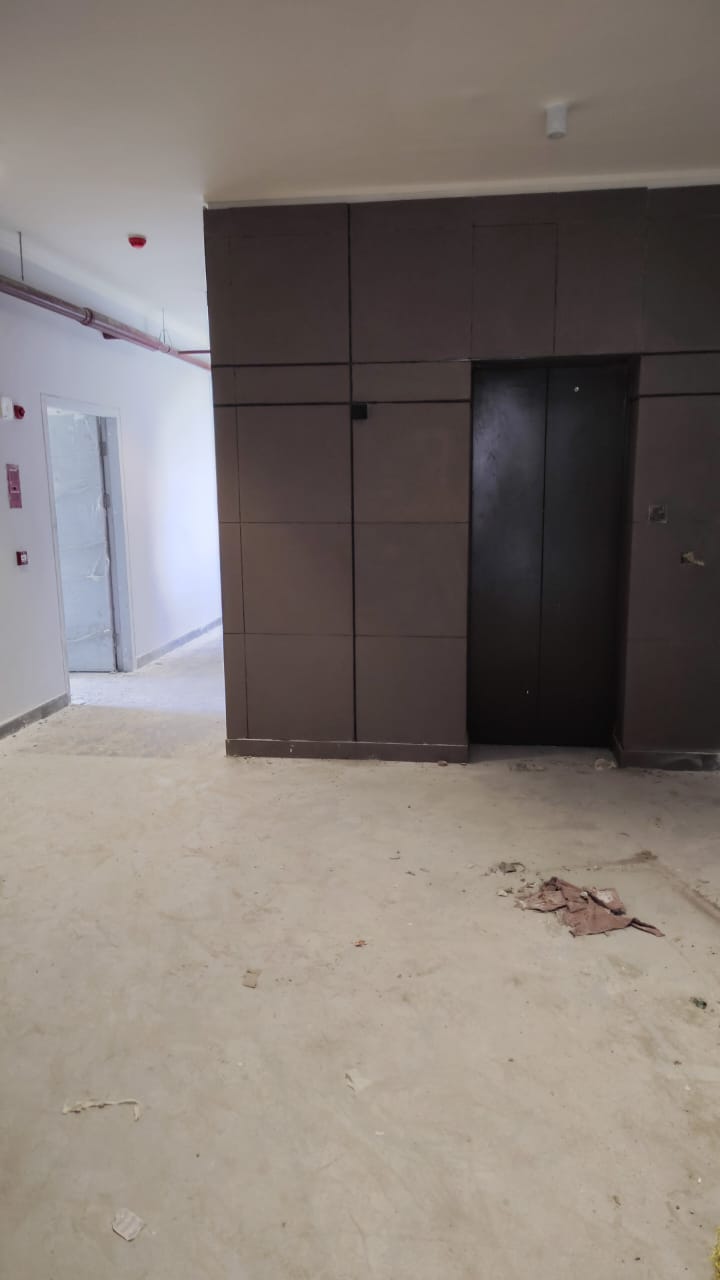

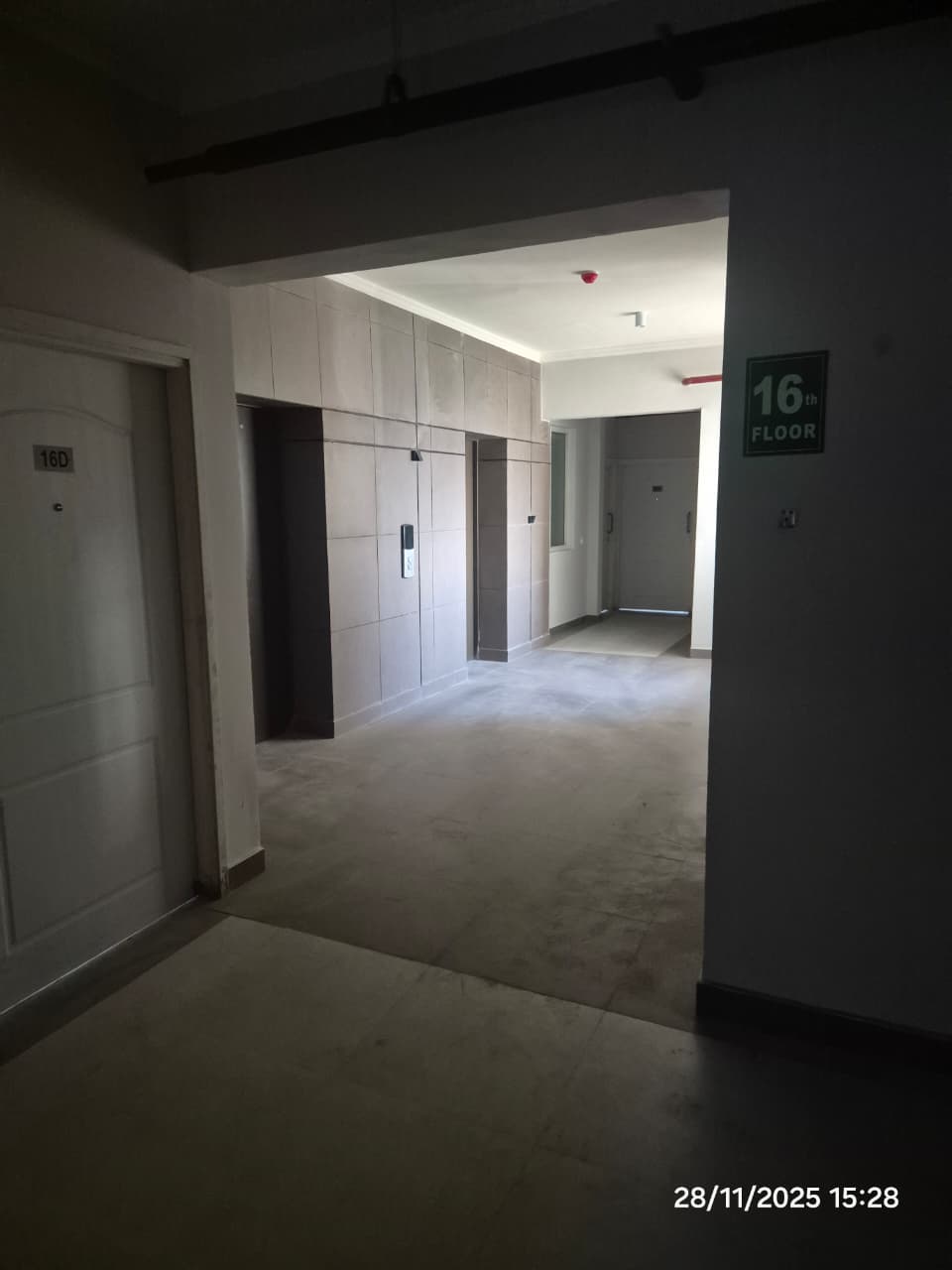

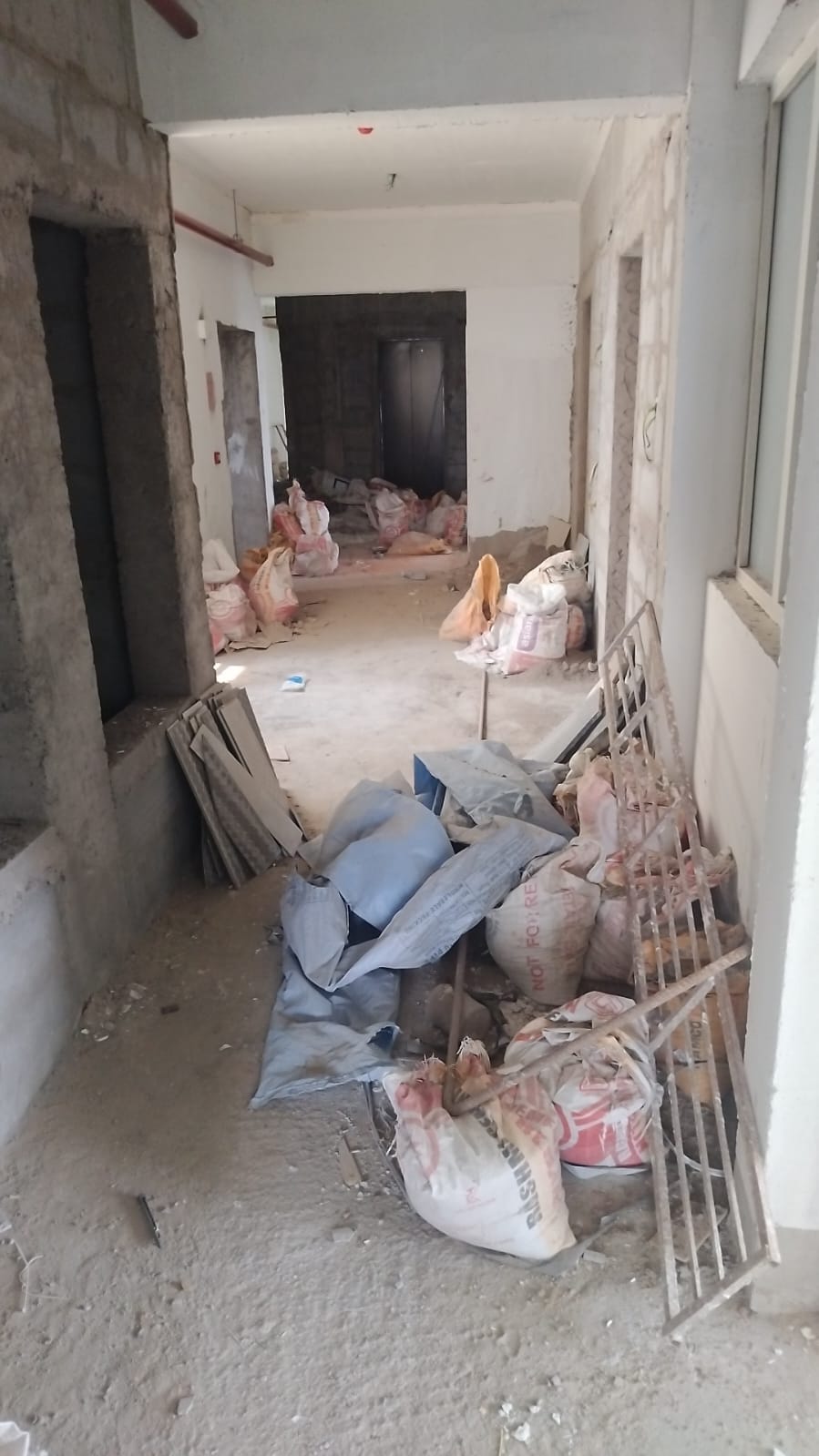

Tower-4 16 Under Construction

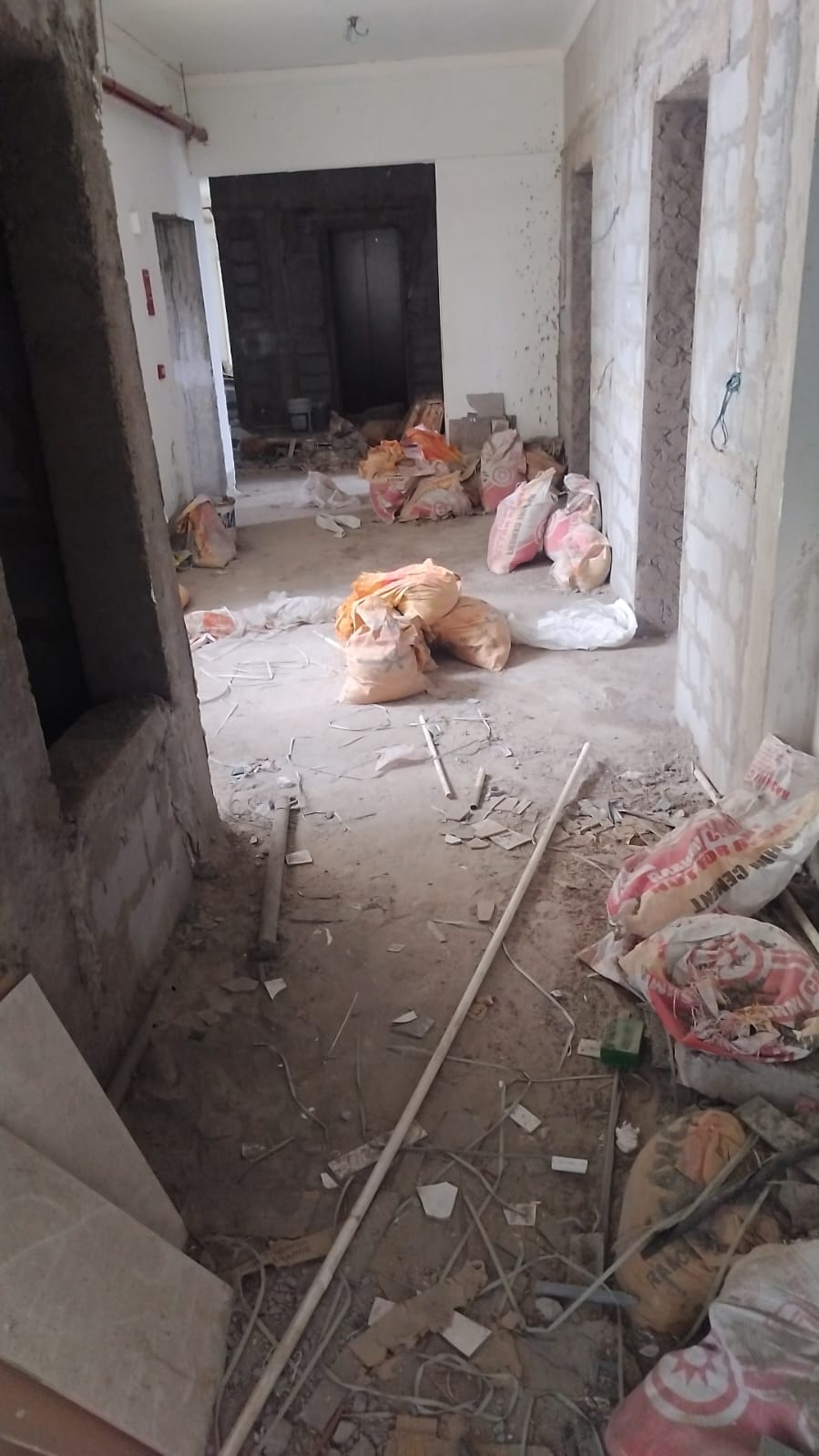

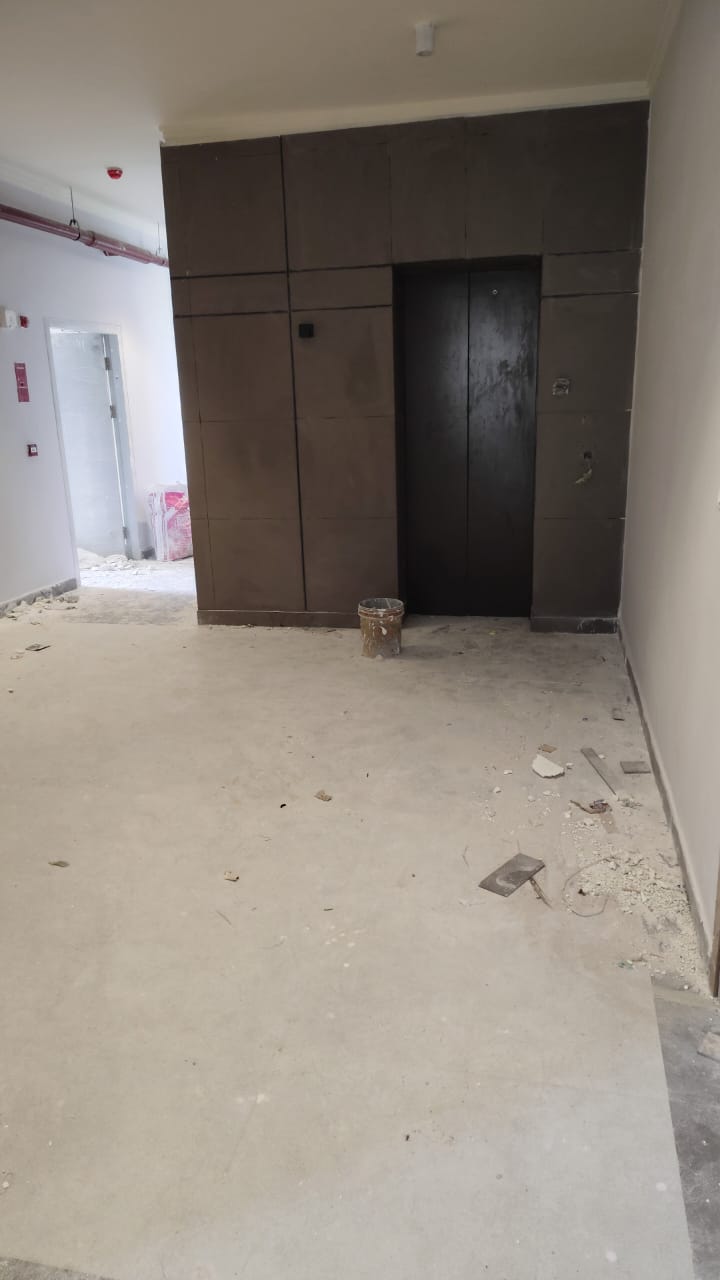

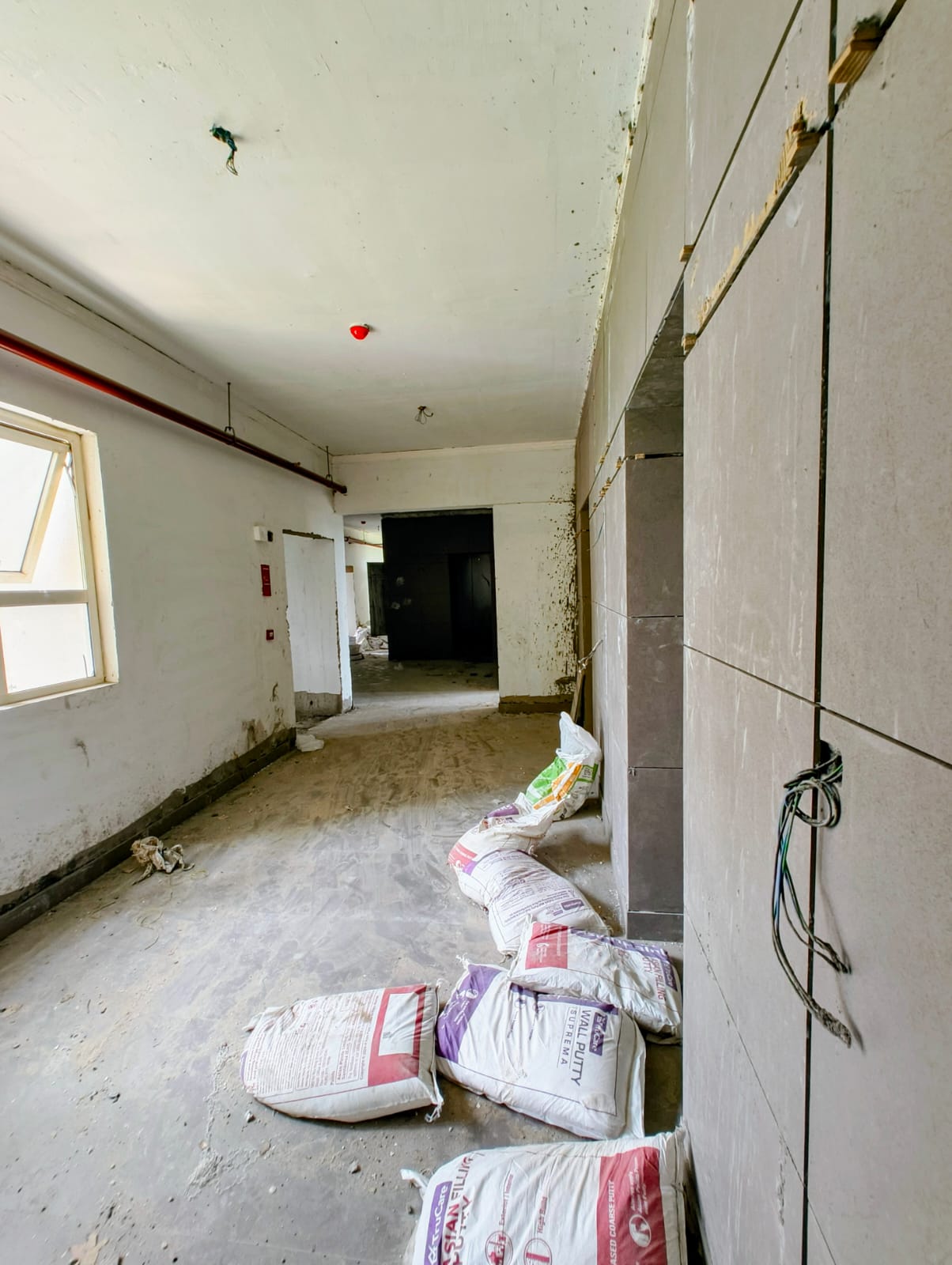

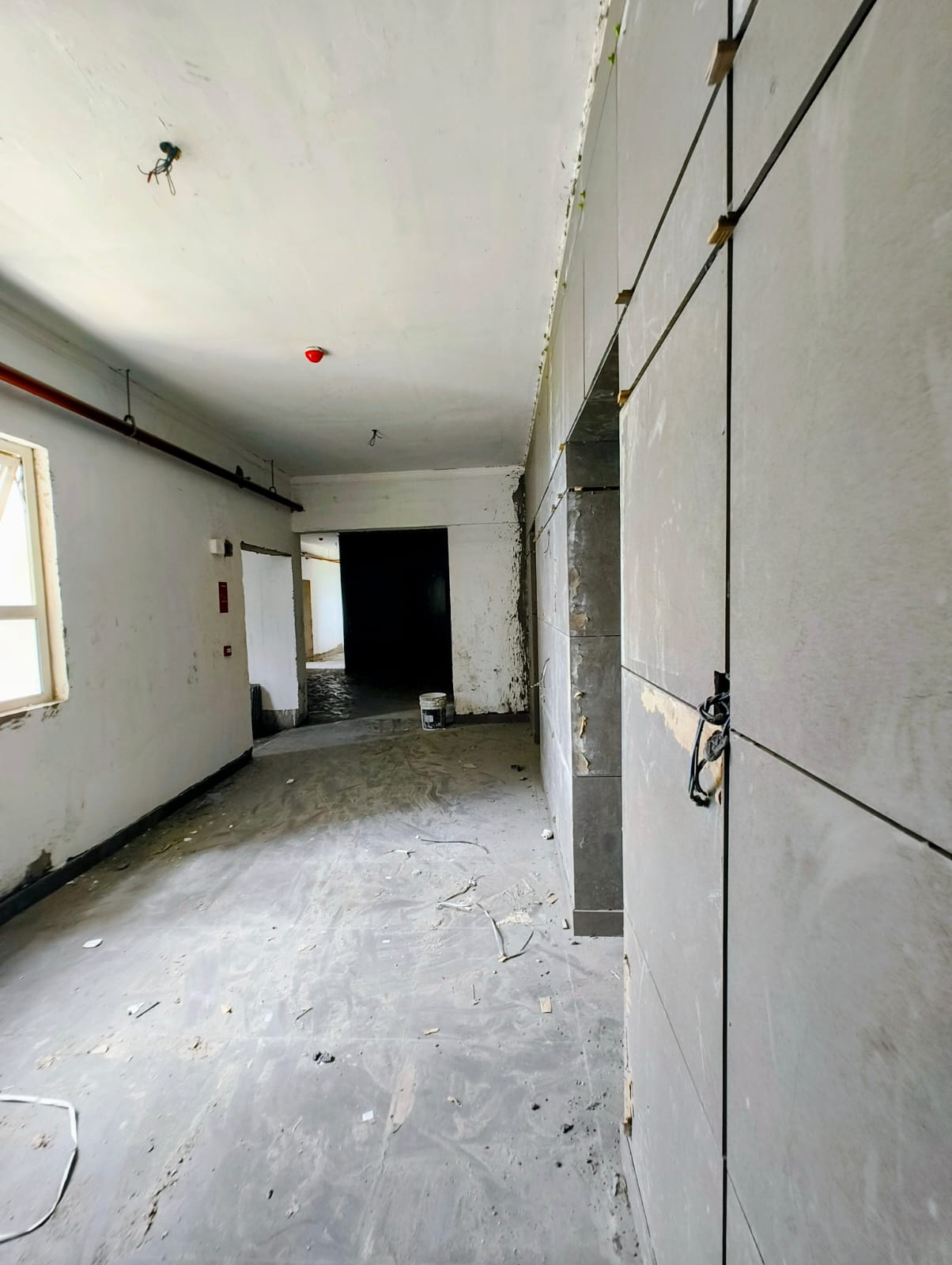

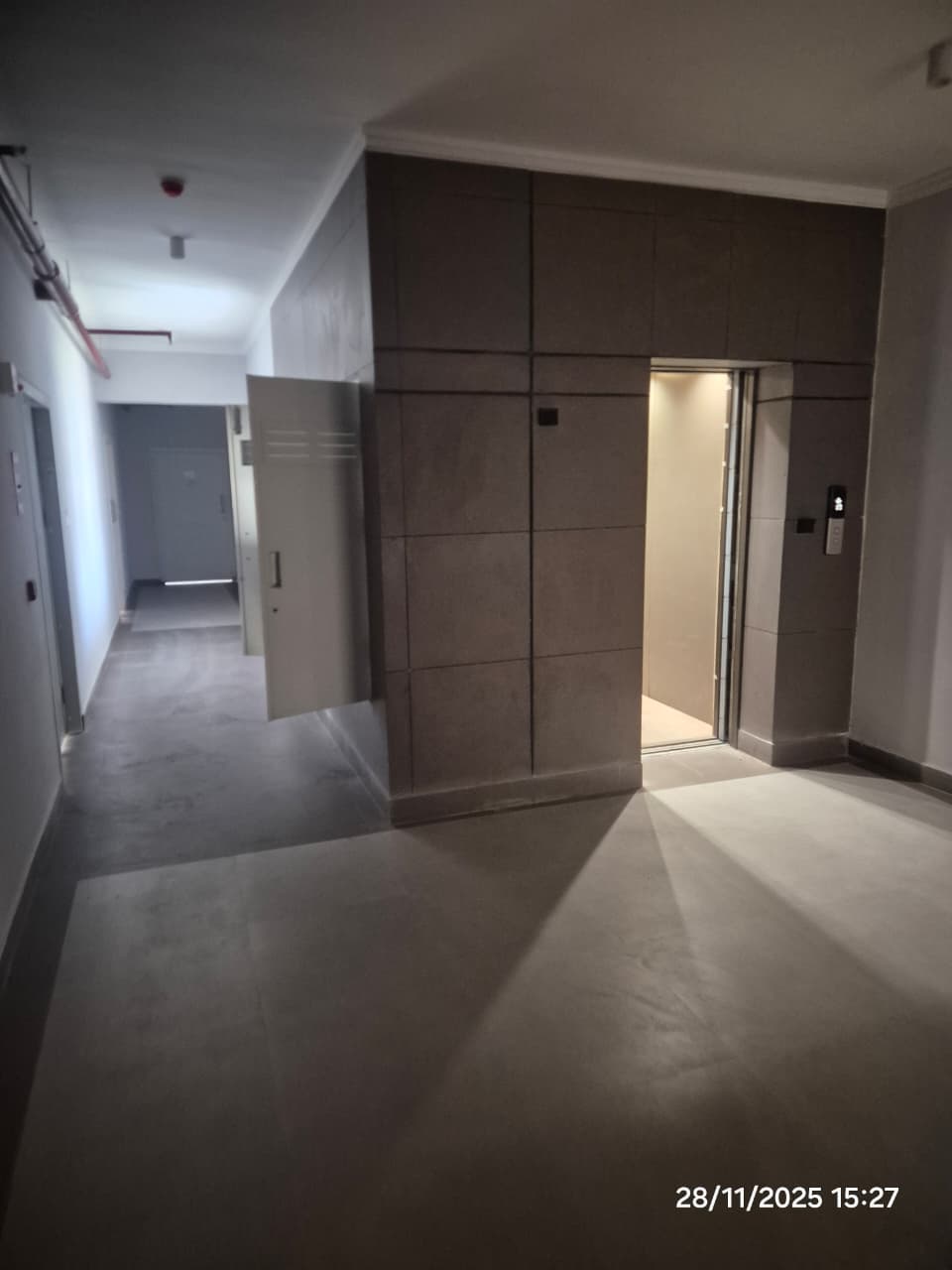

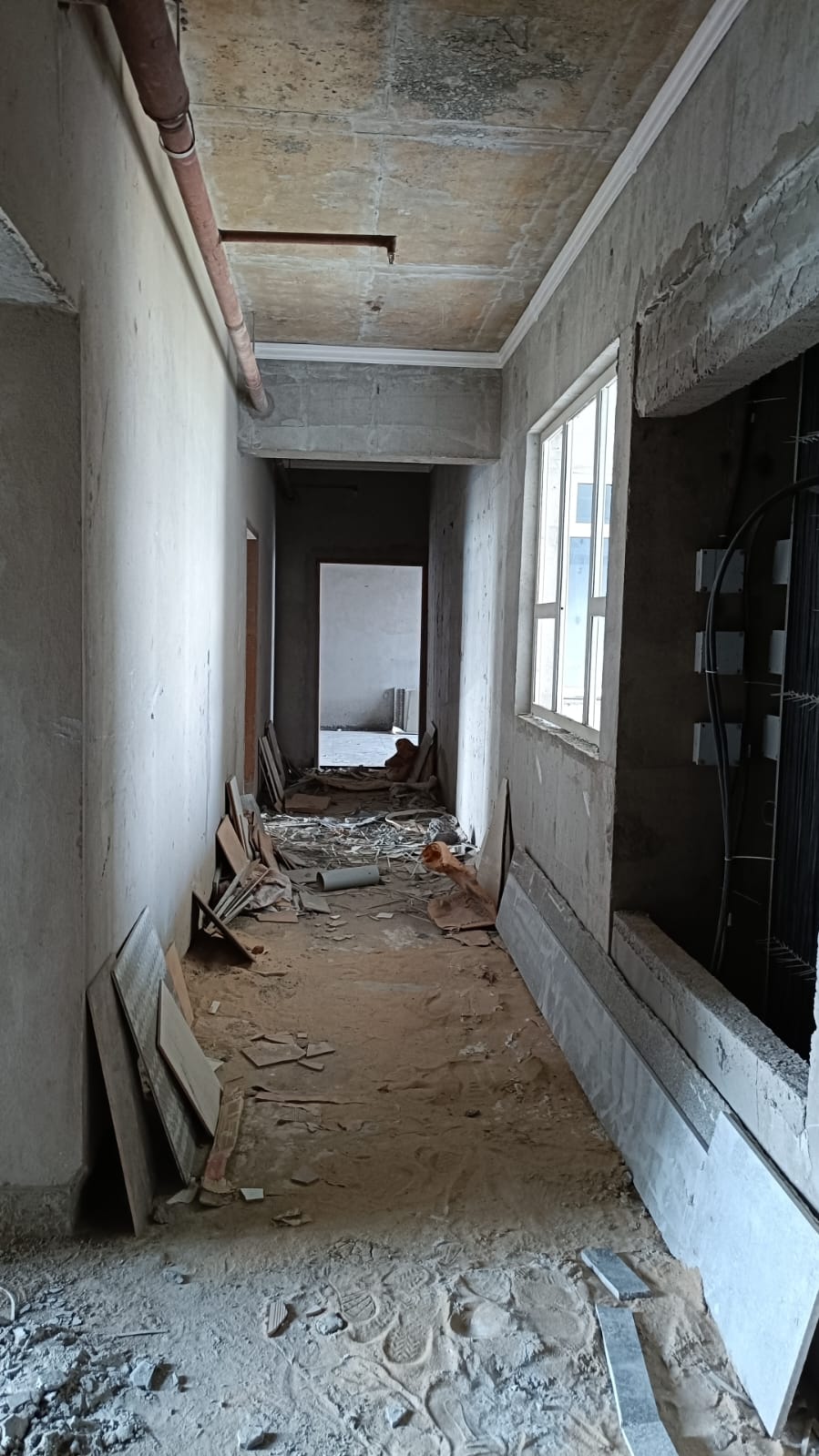

Tower-4 17 Under Construction

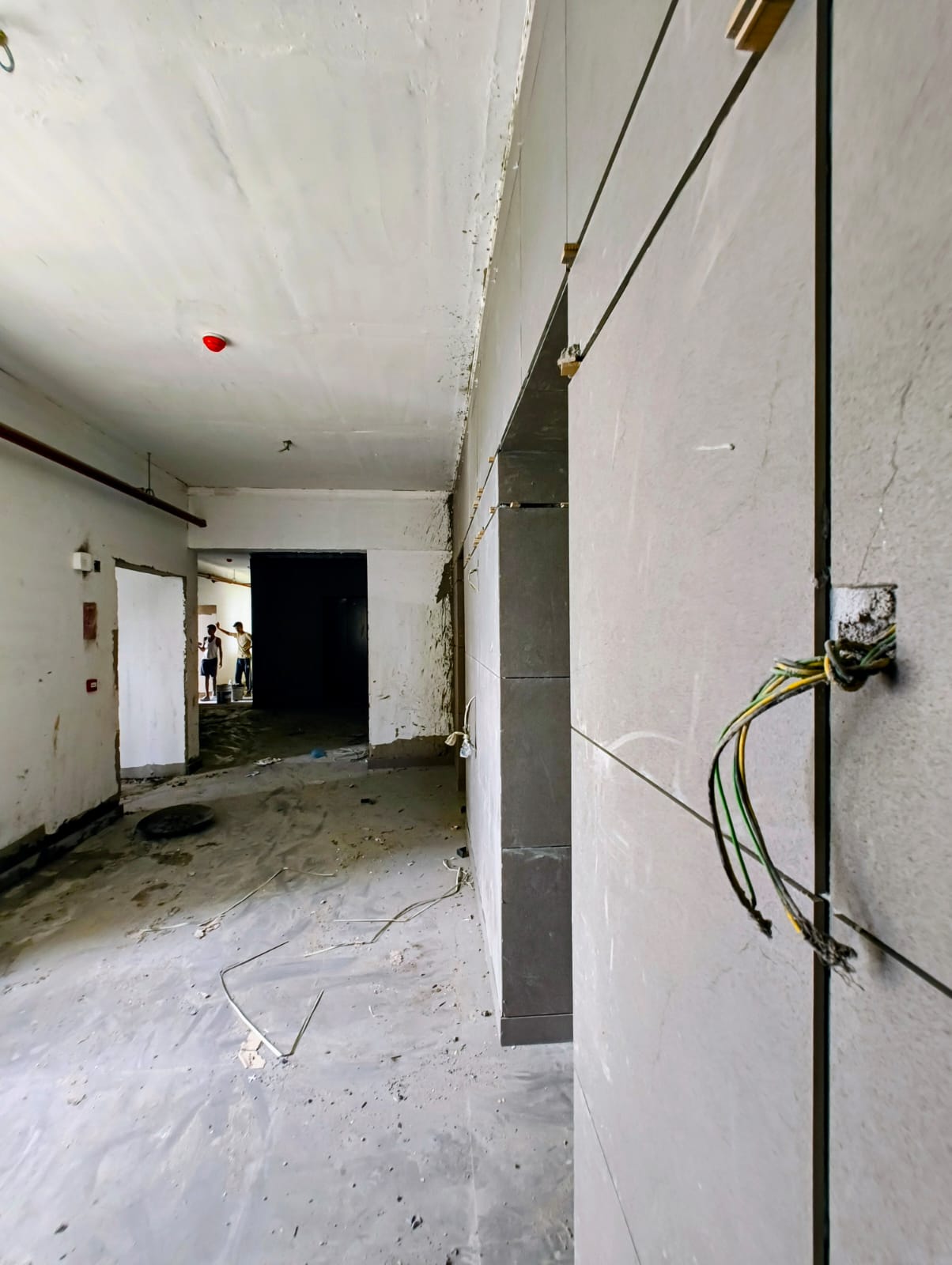

Tower-4 18 Under Construction

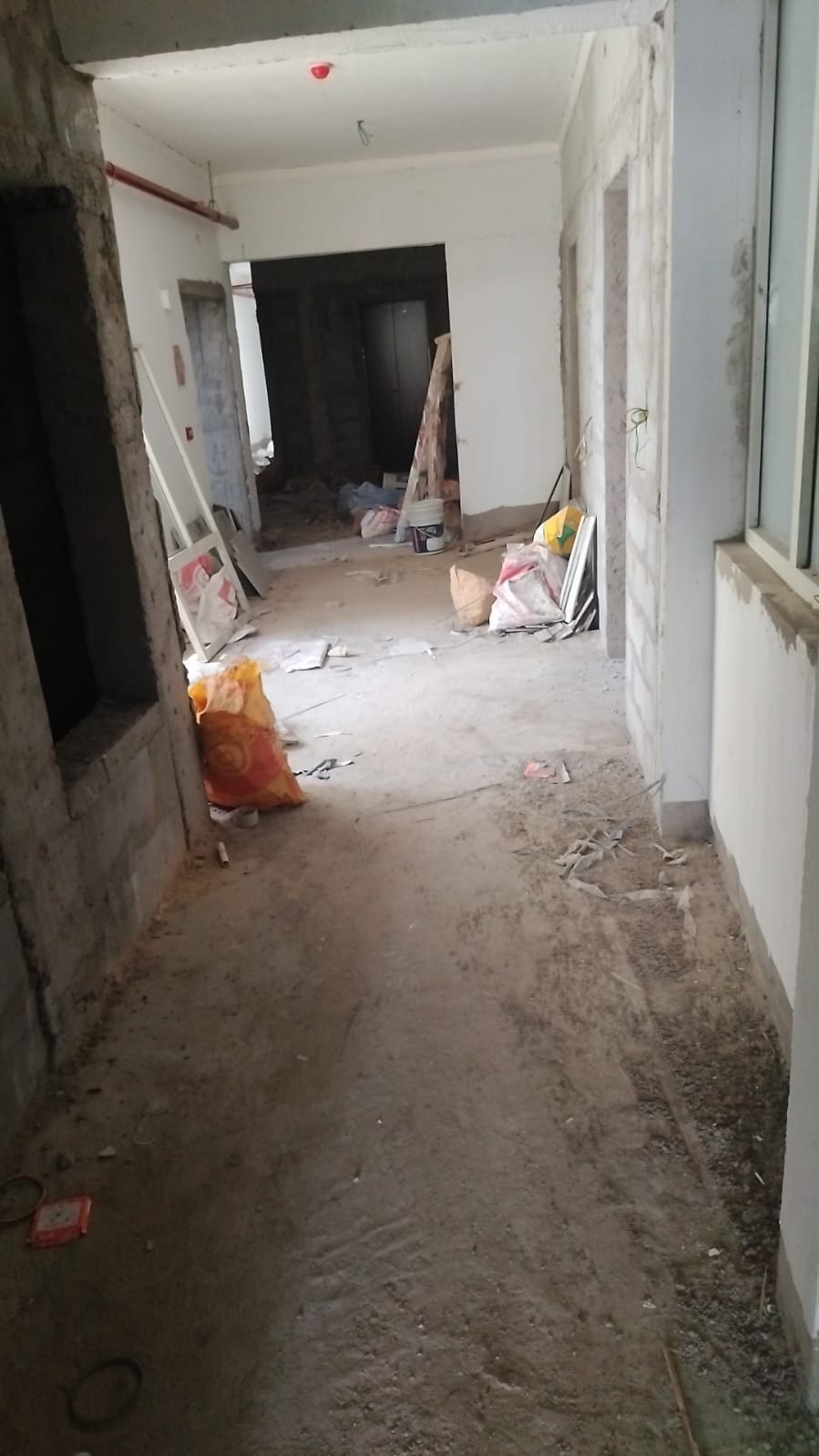

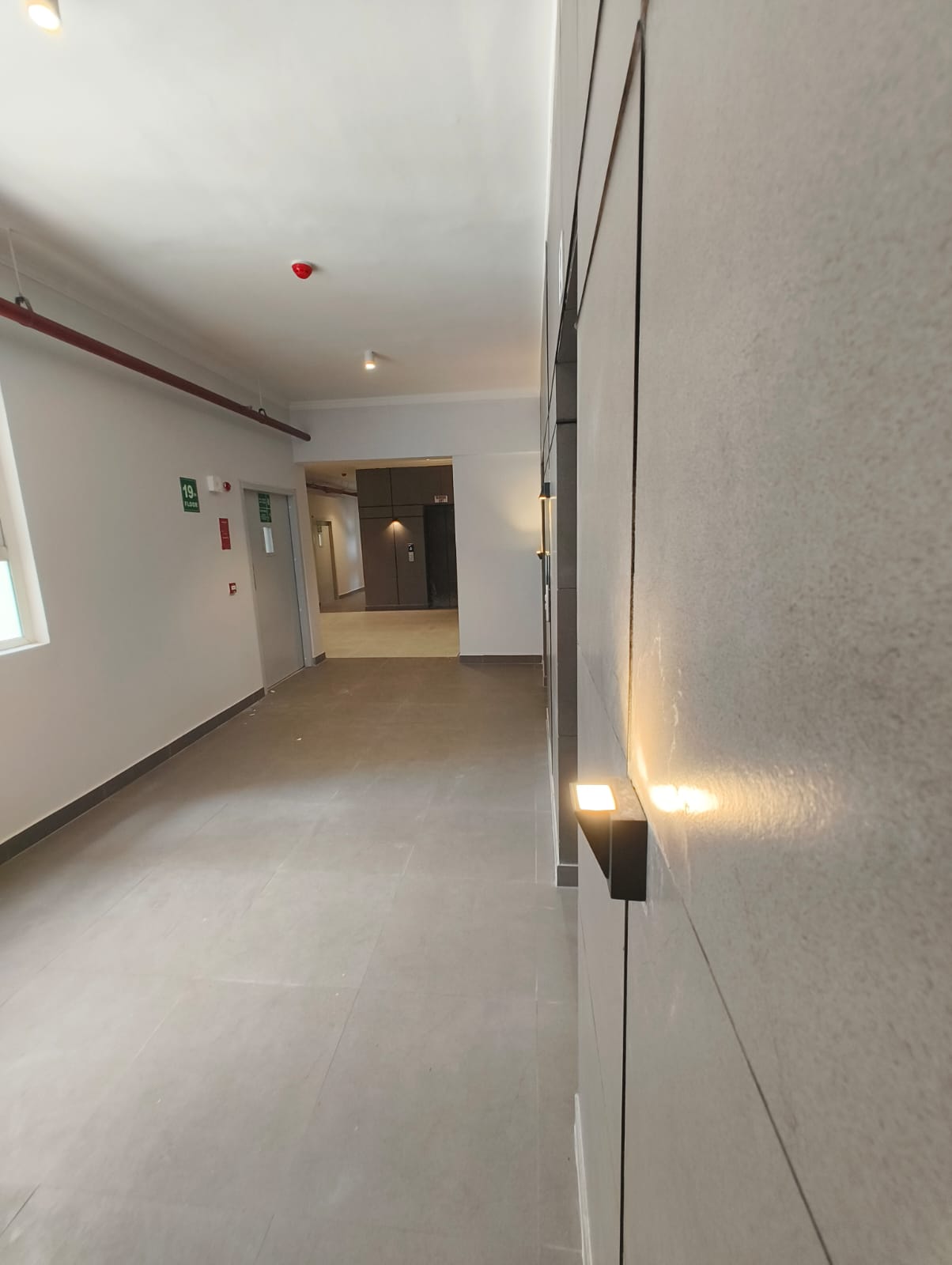

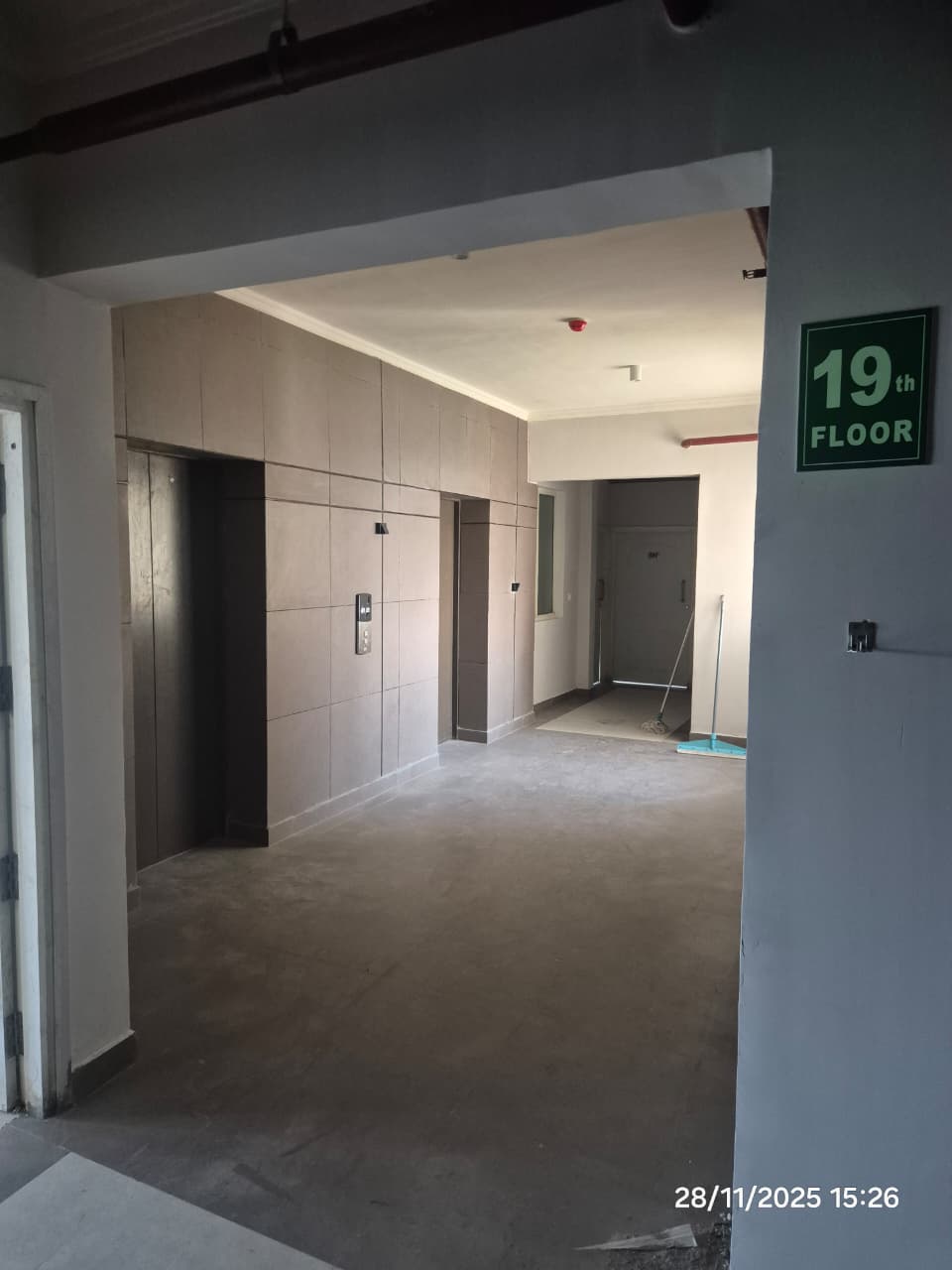

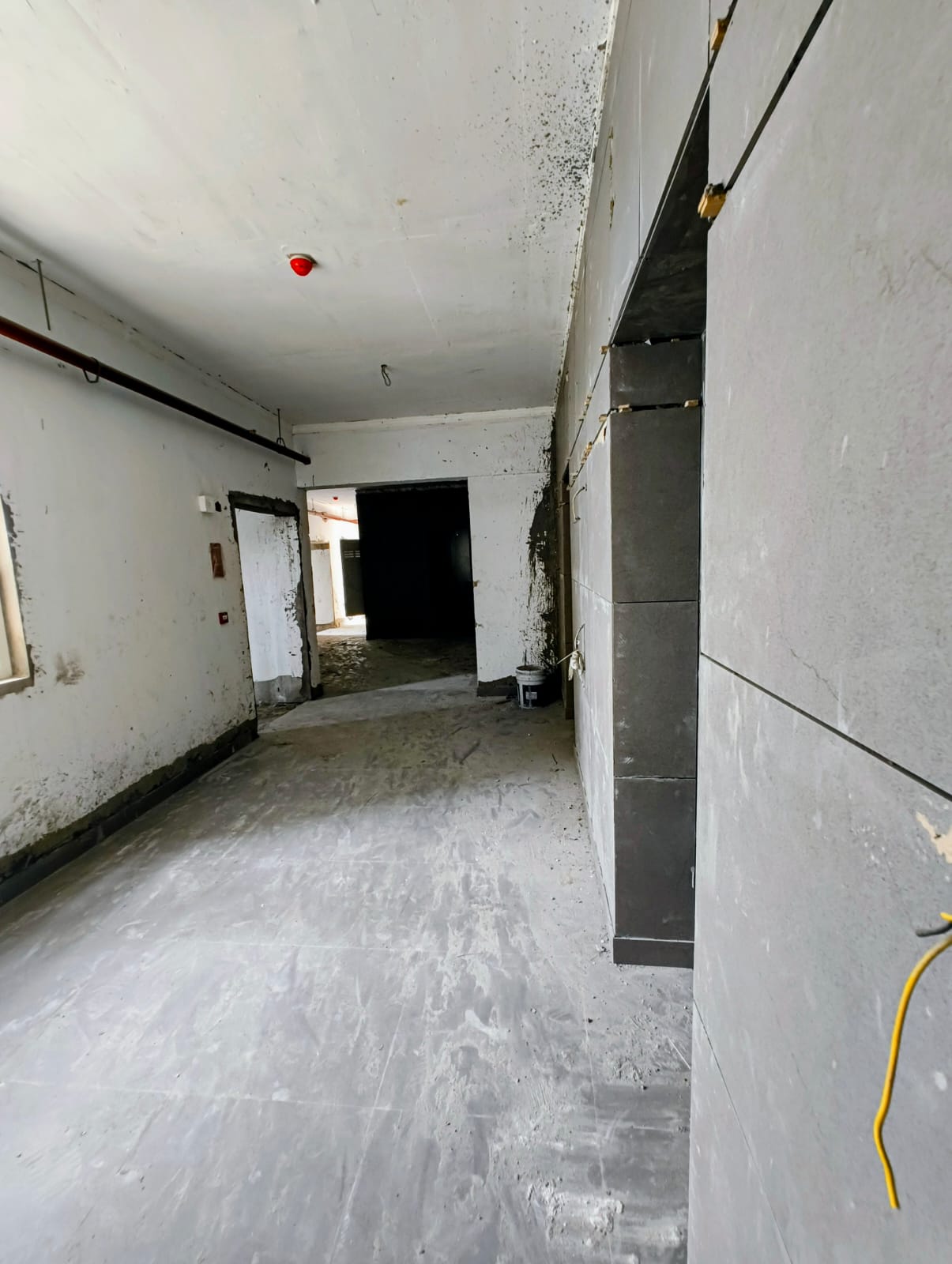

Tower-4 19 Under Construction

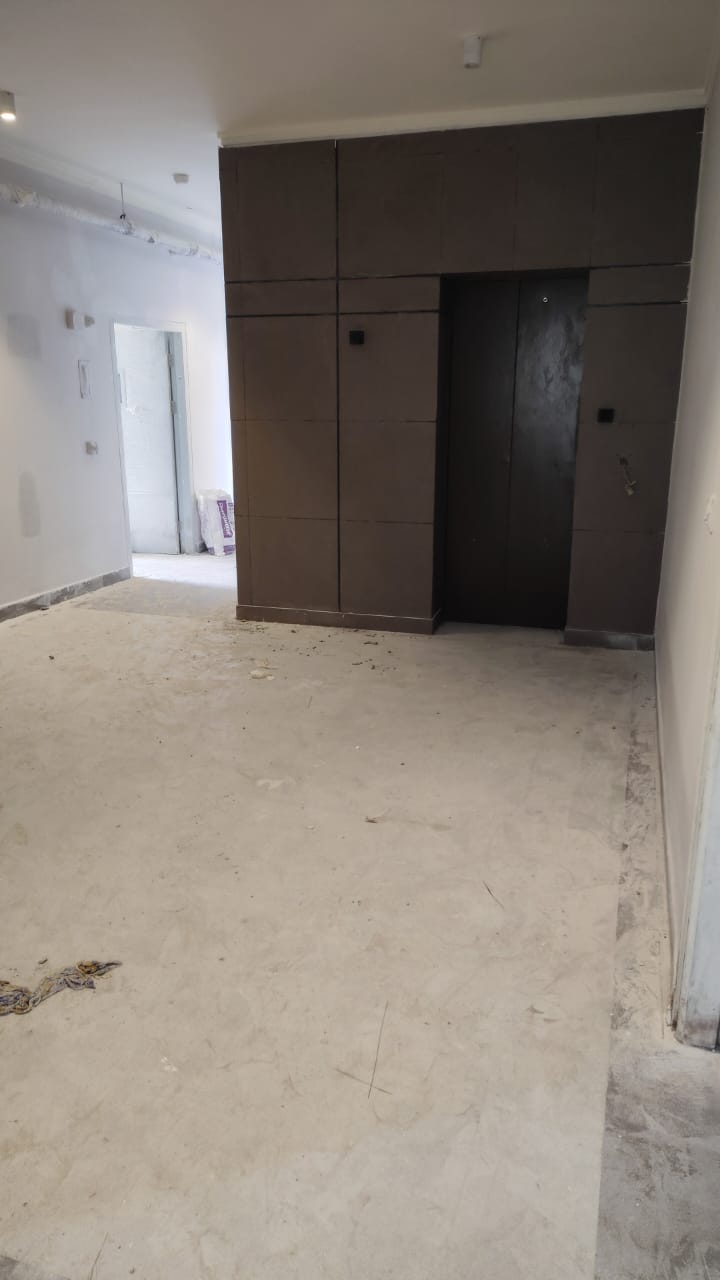

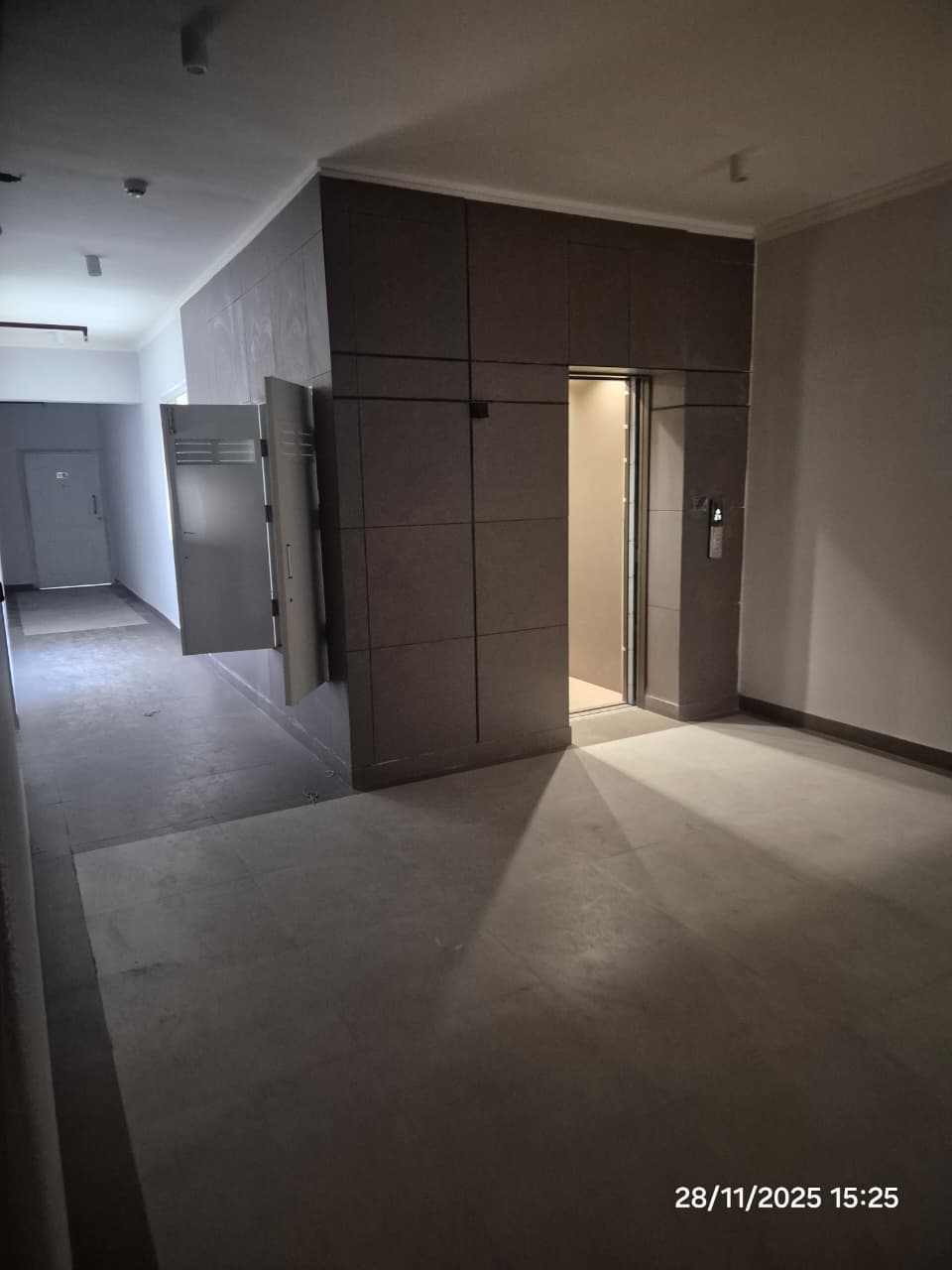

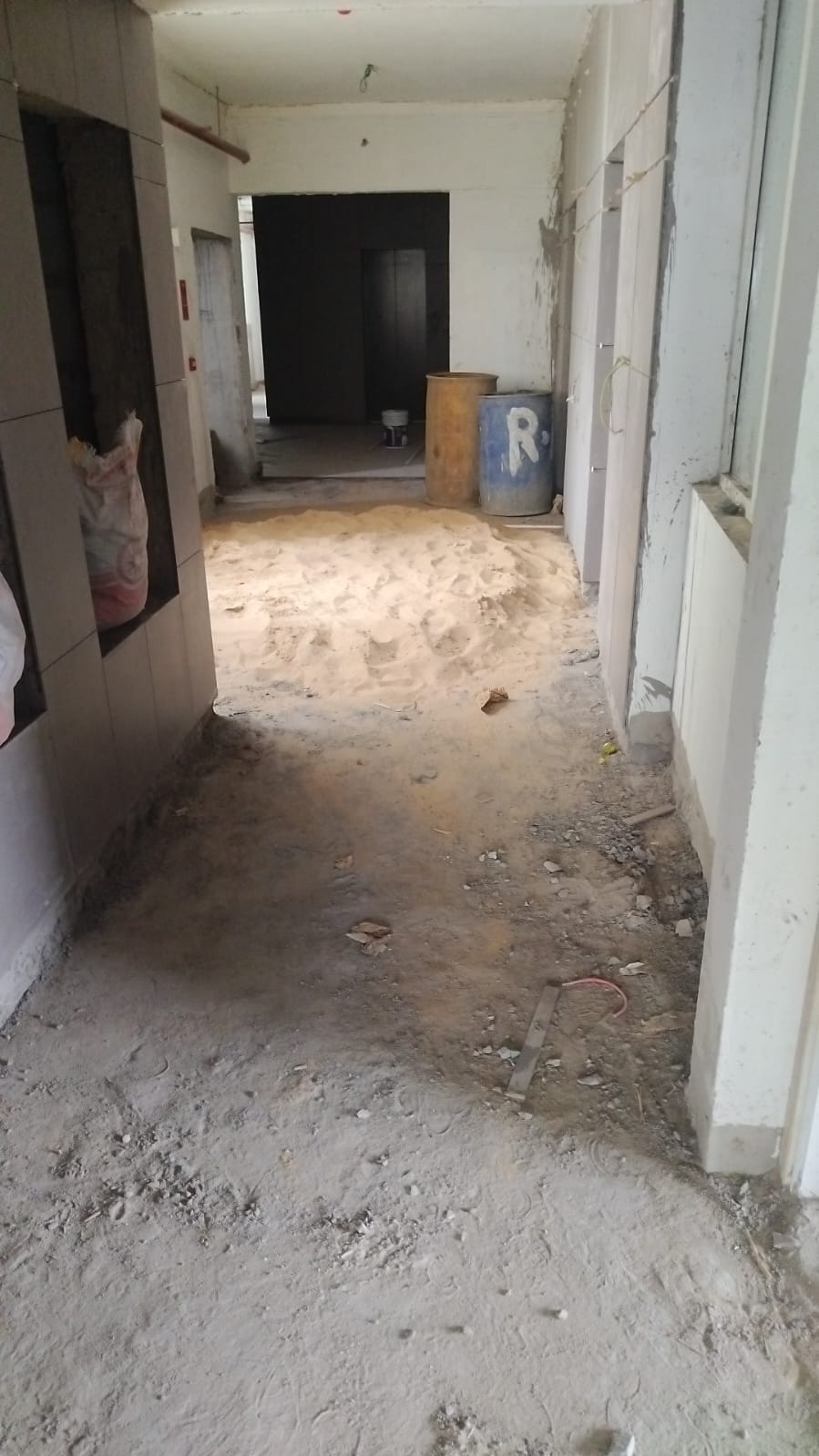

Tower-4 21 Under Construction

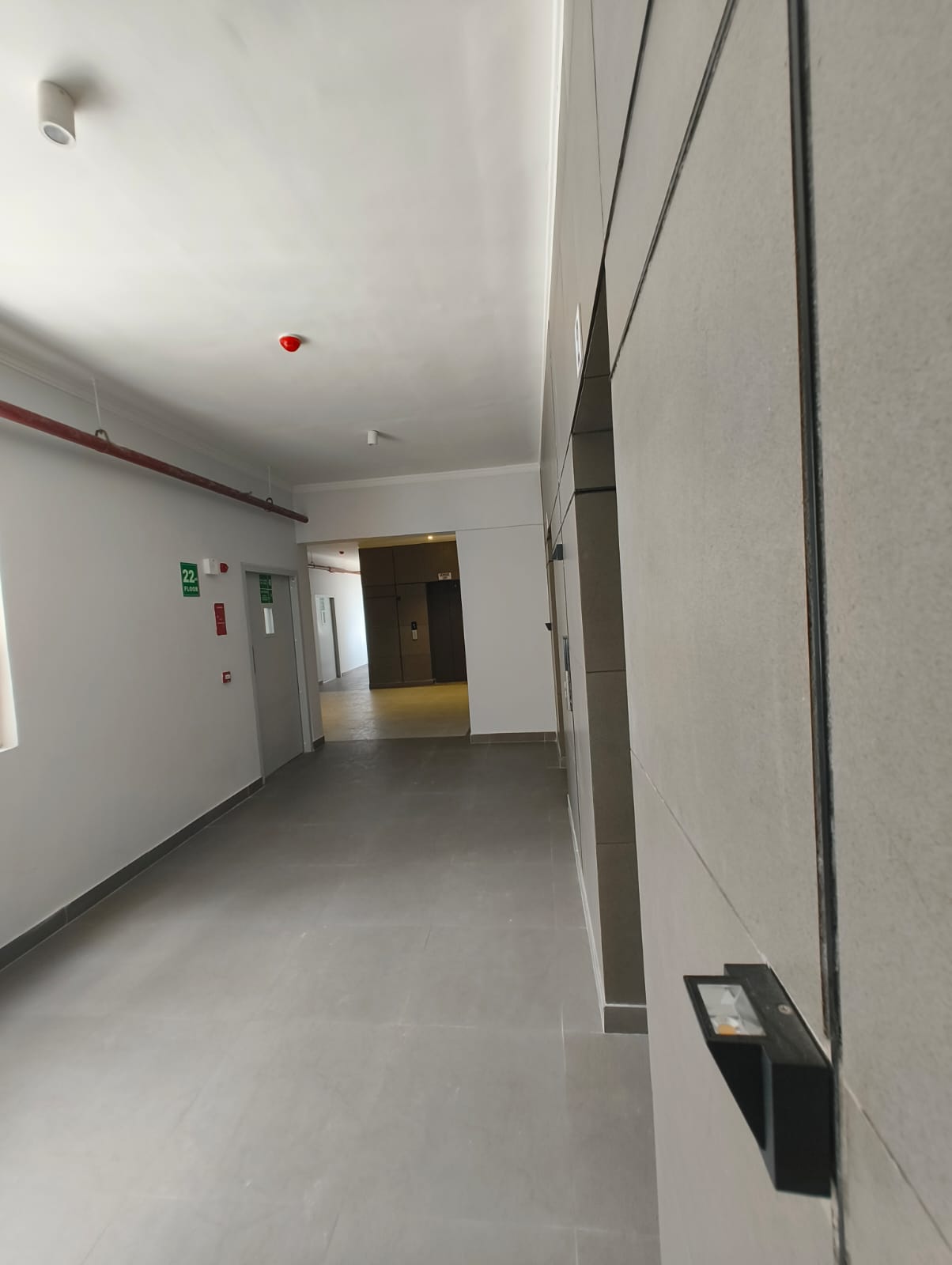

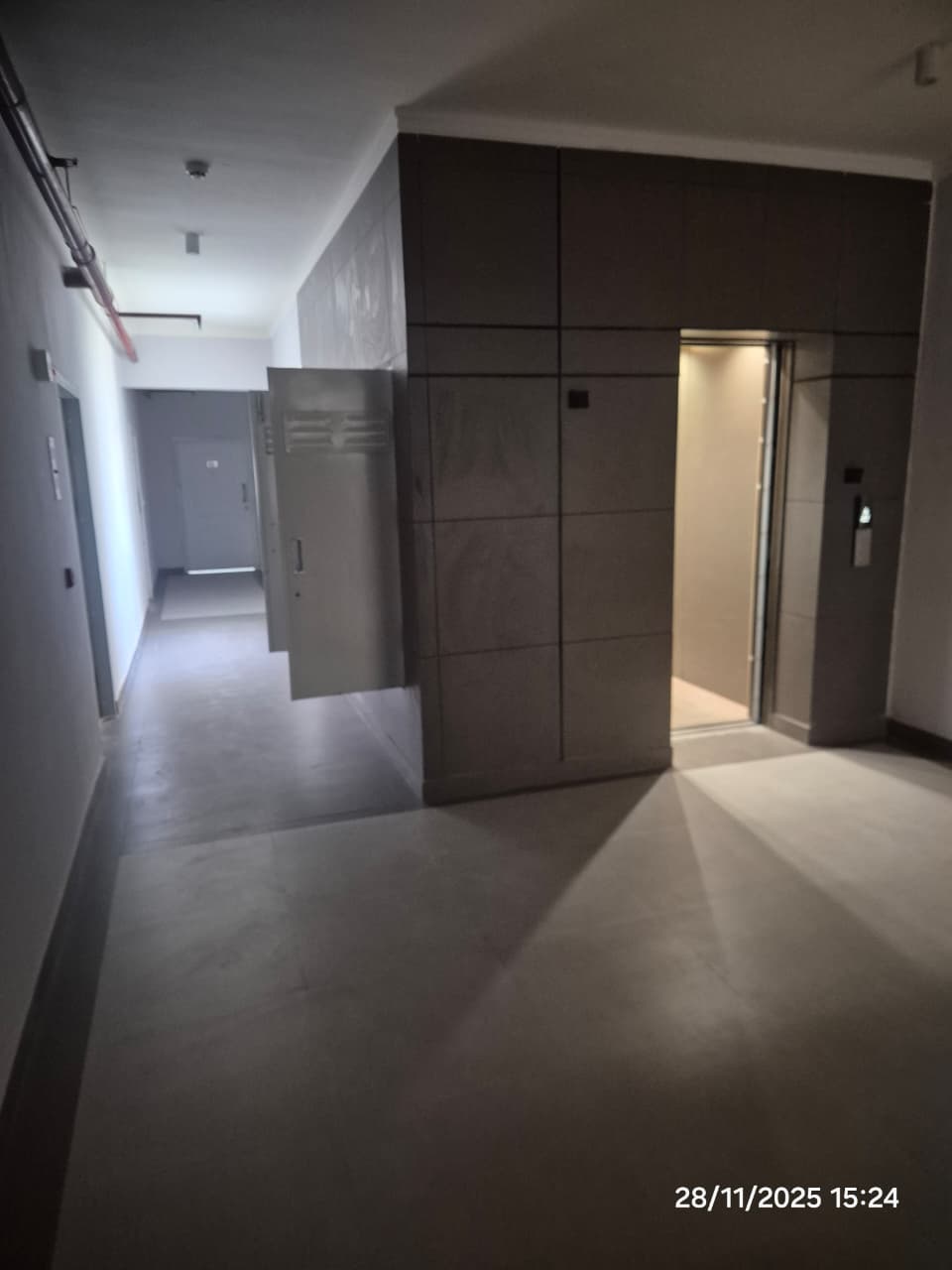

Tower-4 22 Under Construction

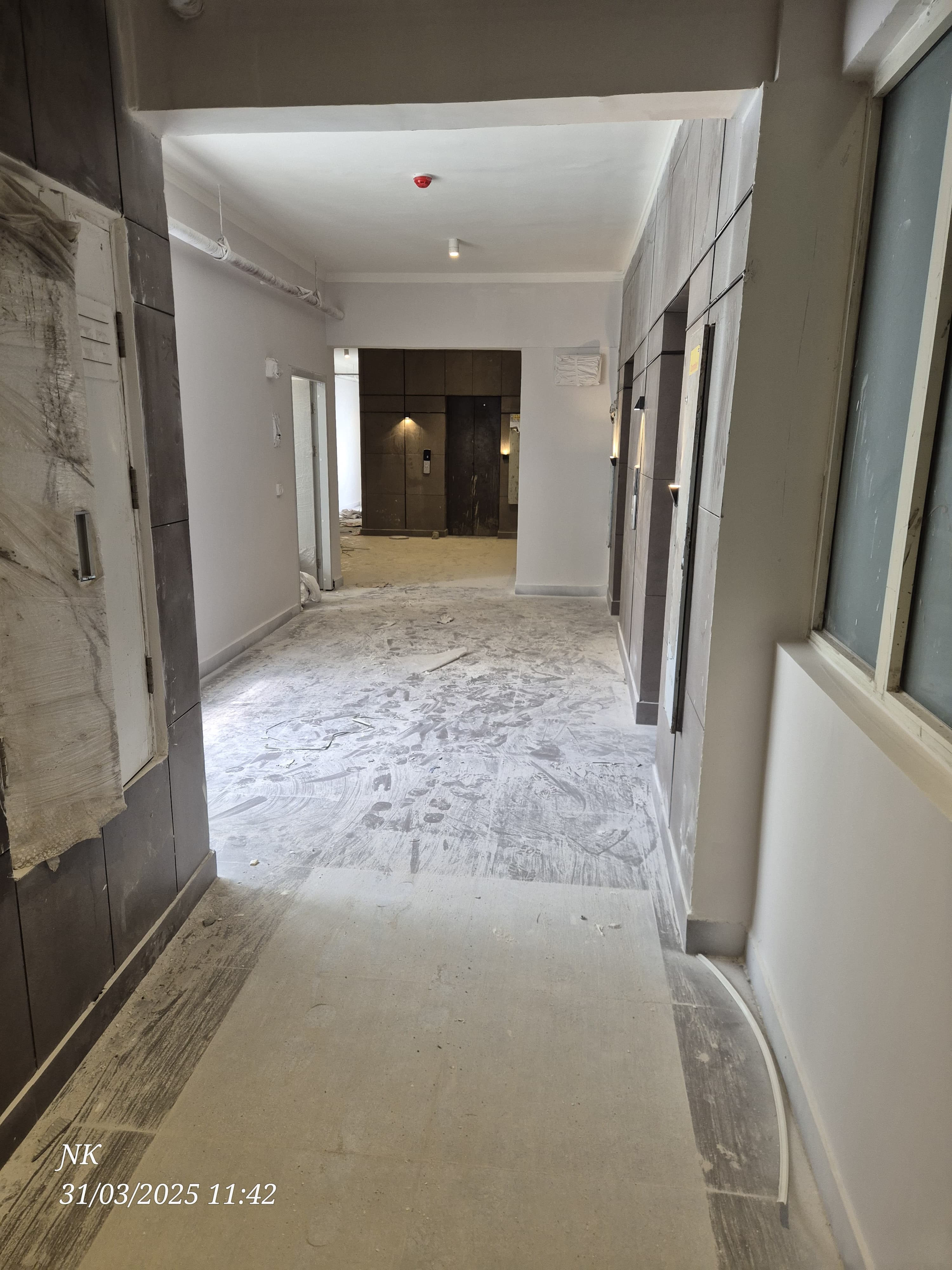

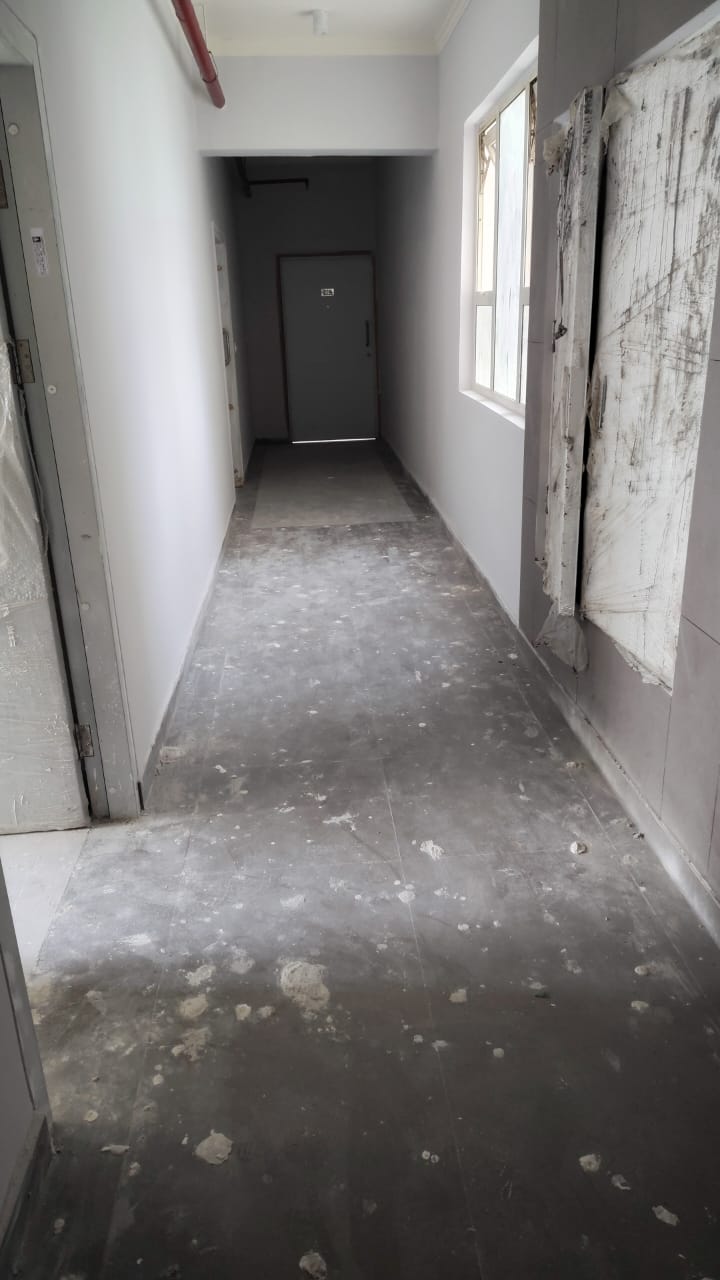

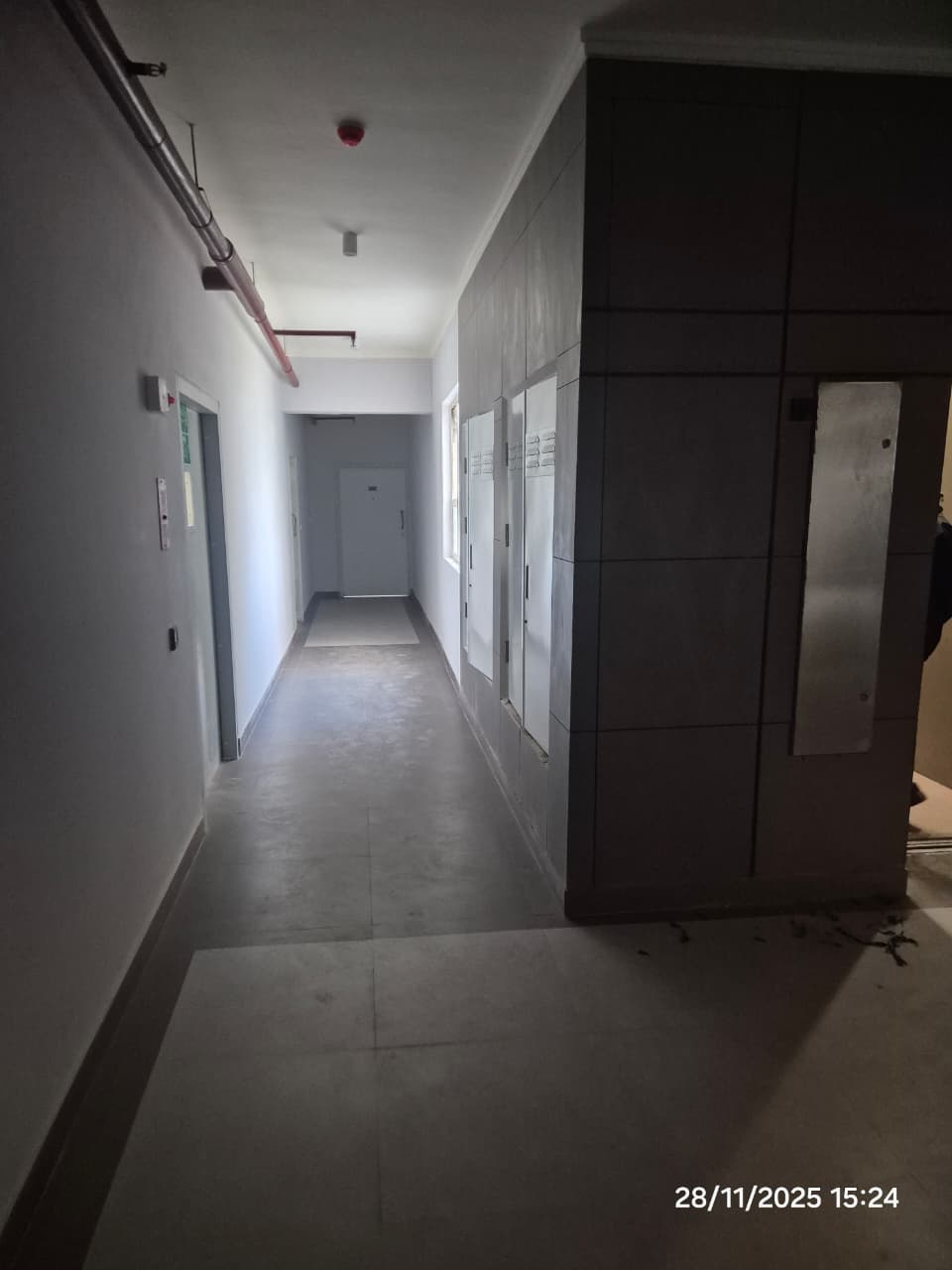

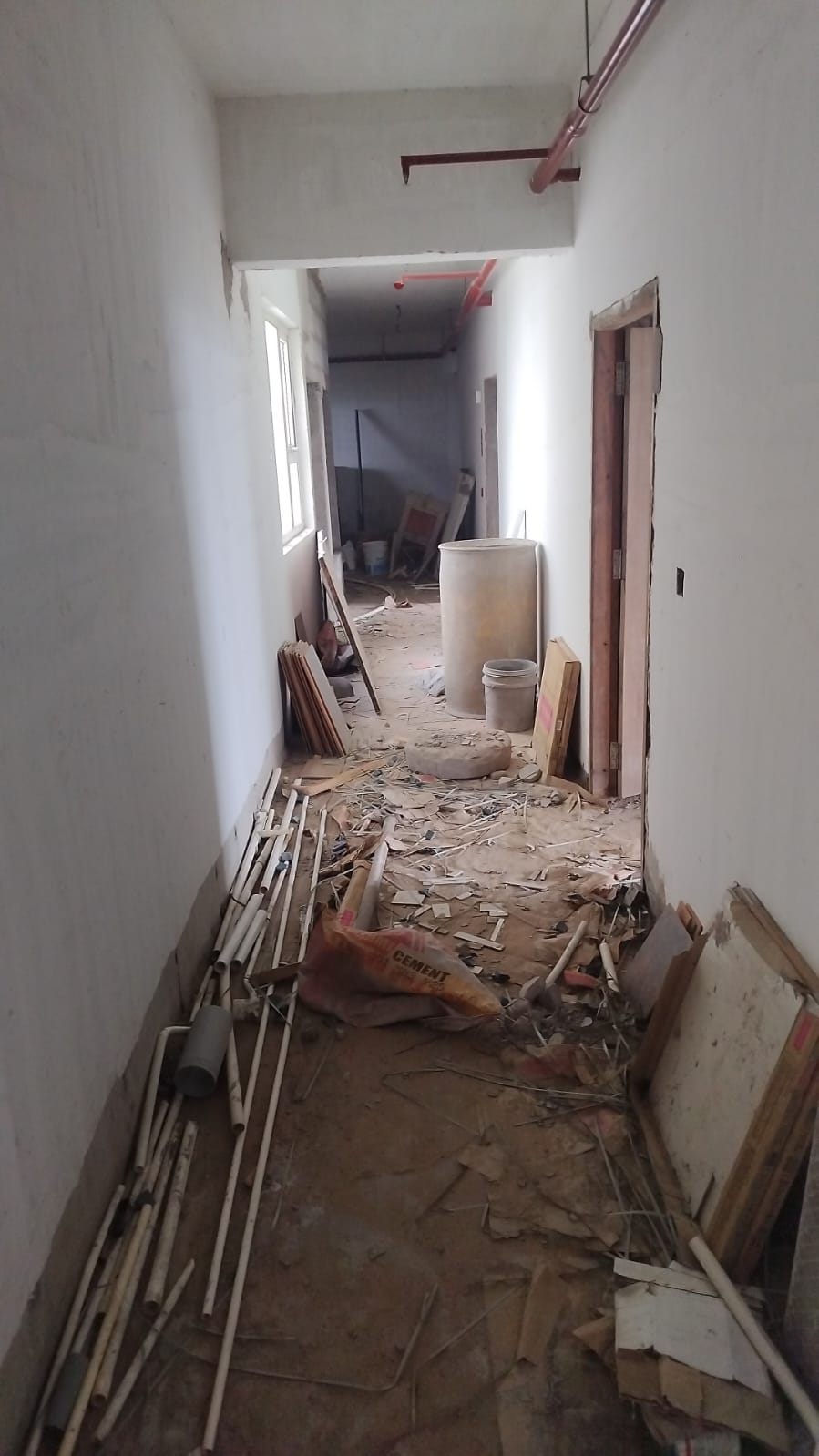

Tower-4 23 Under Construction

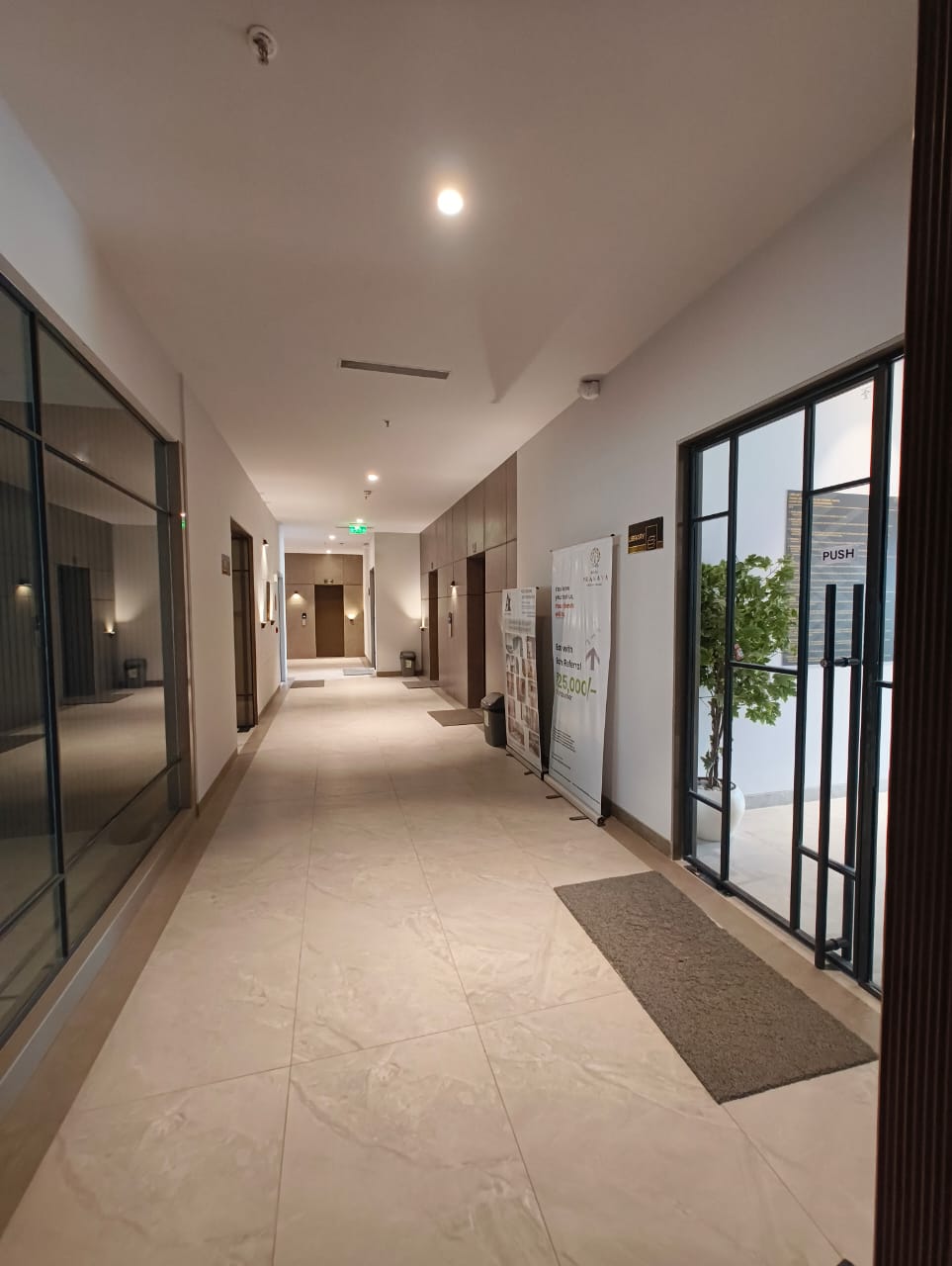

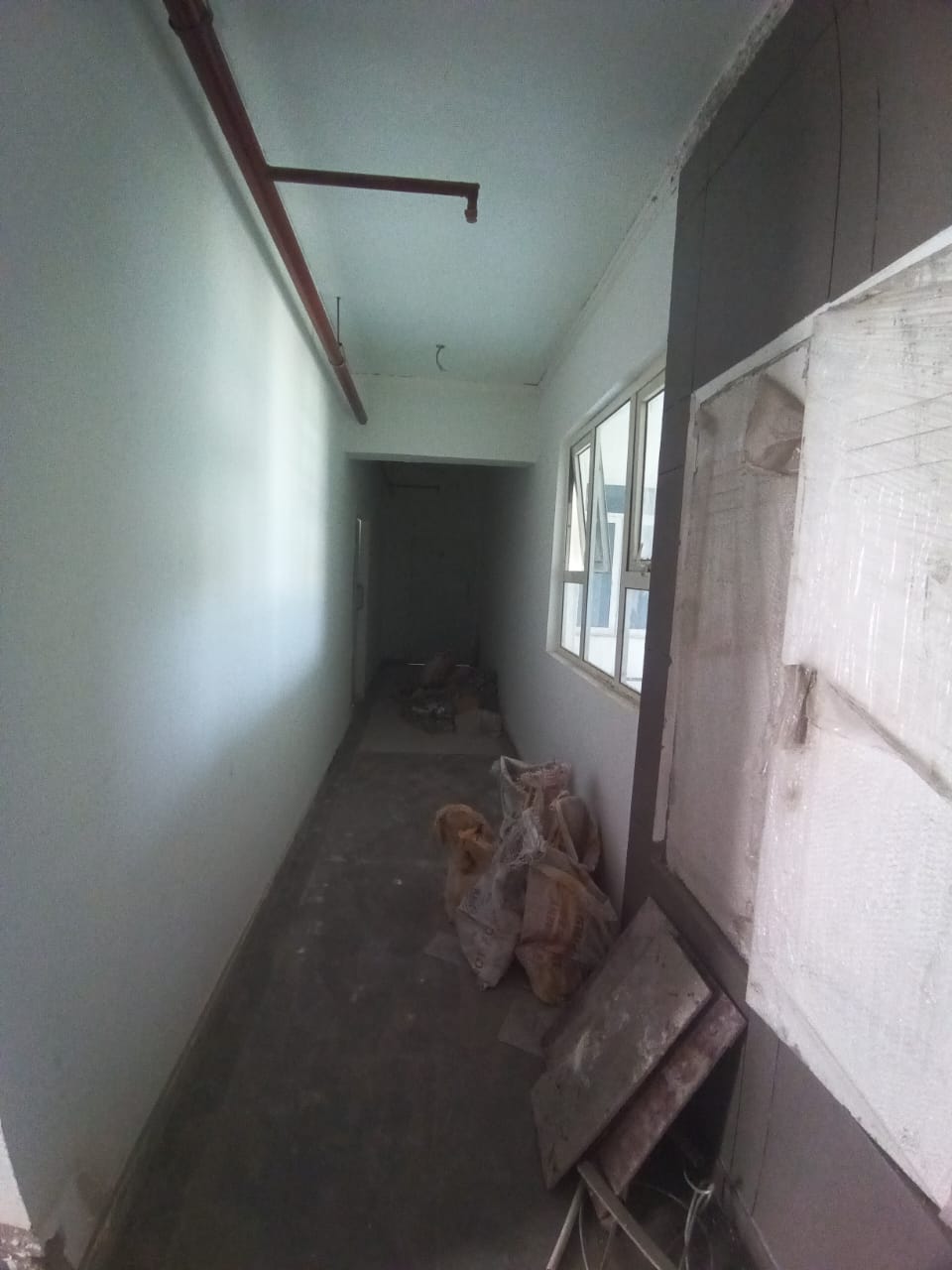

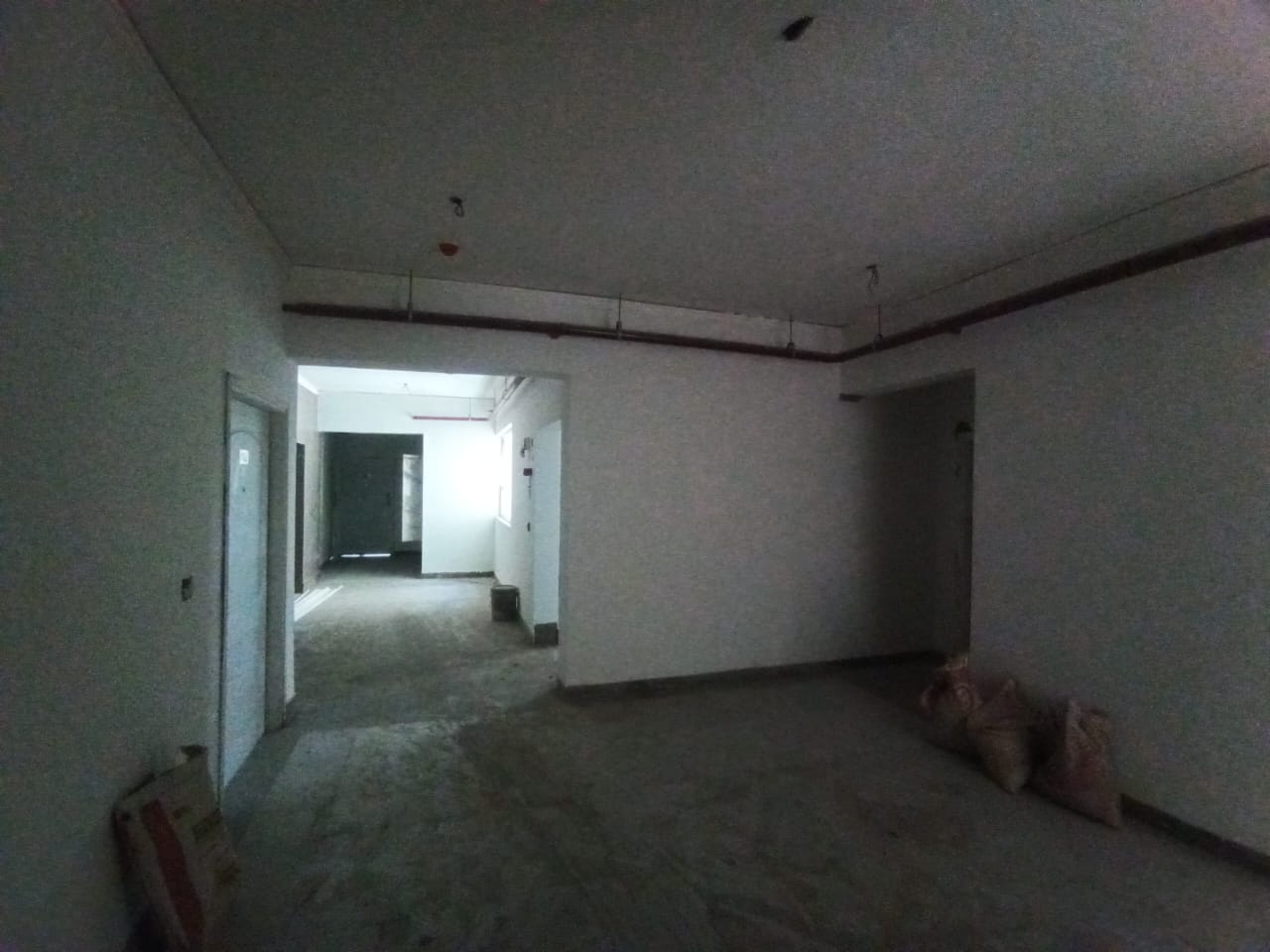

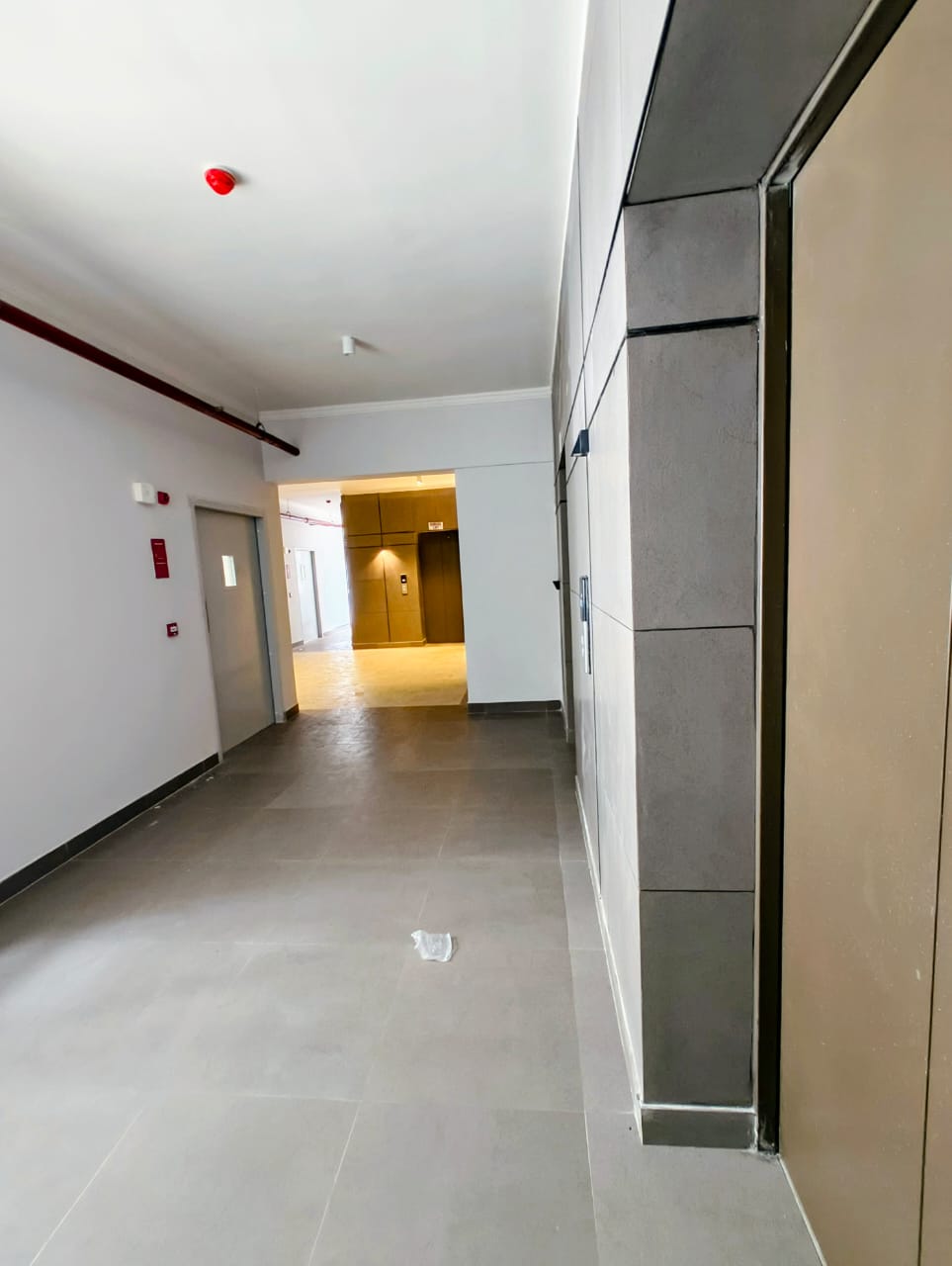

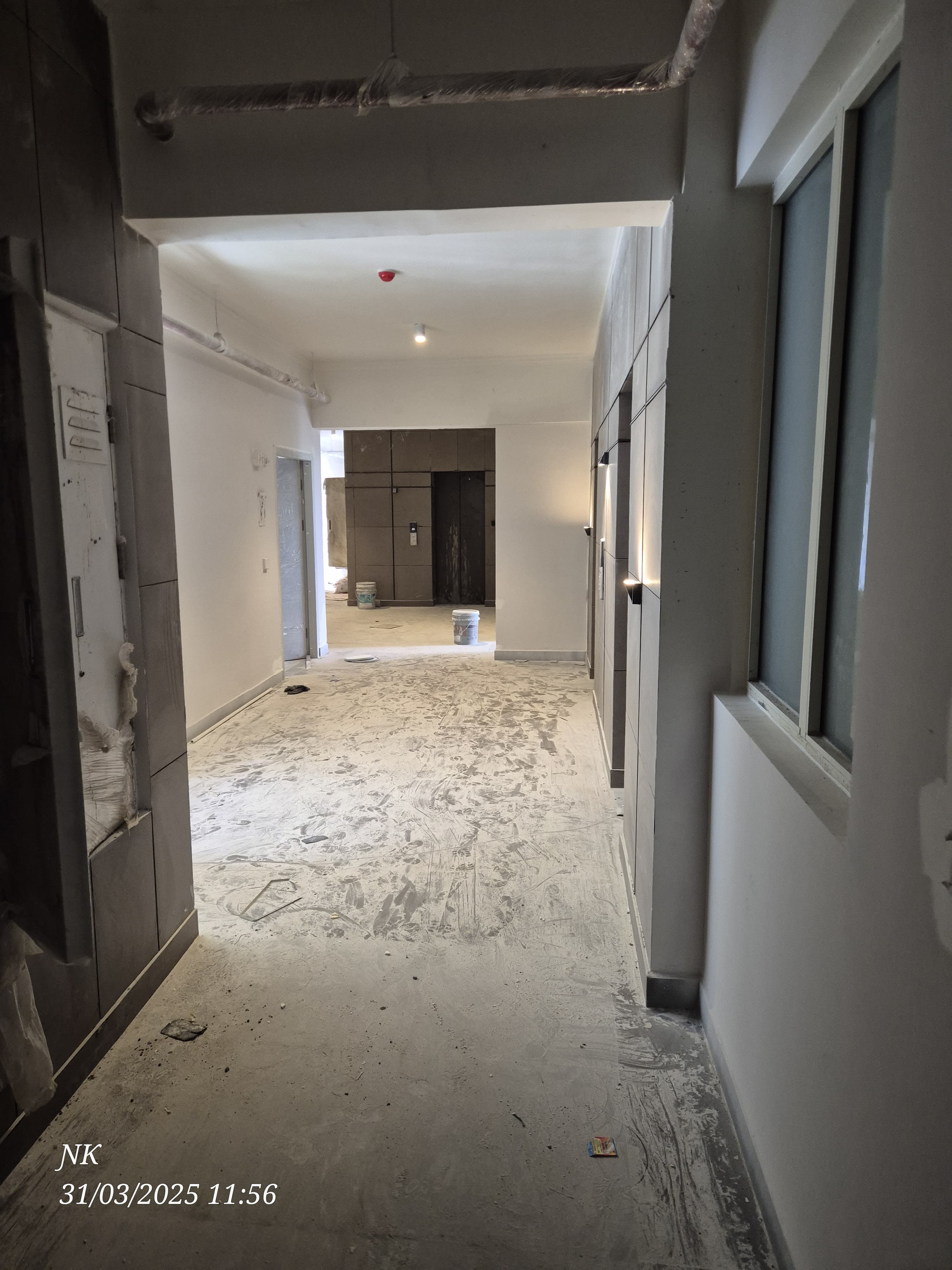

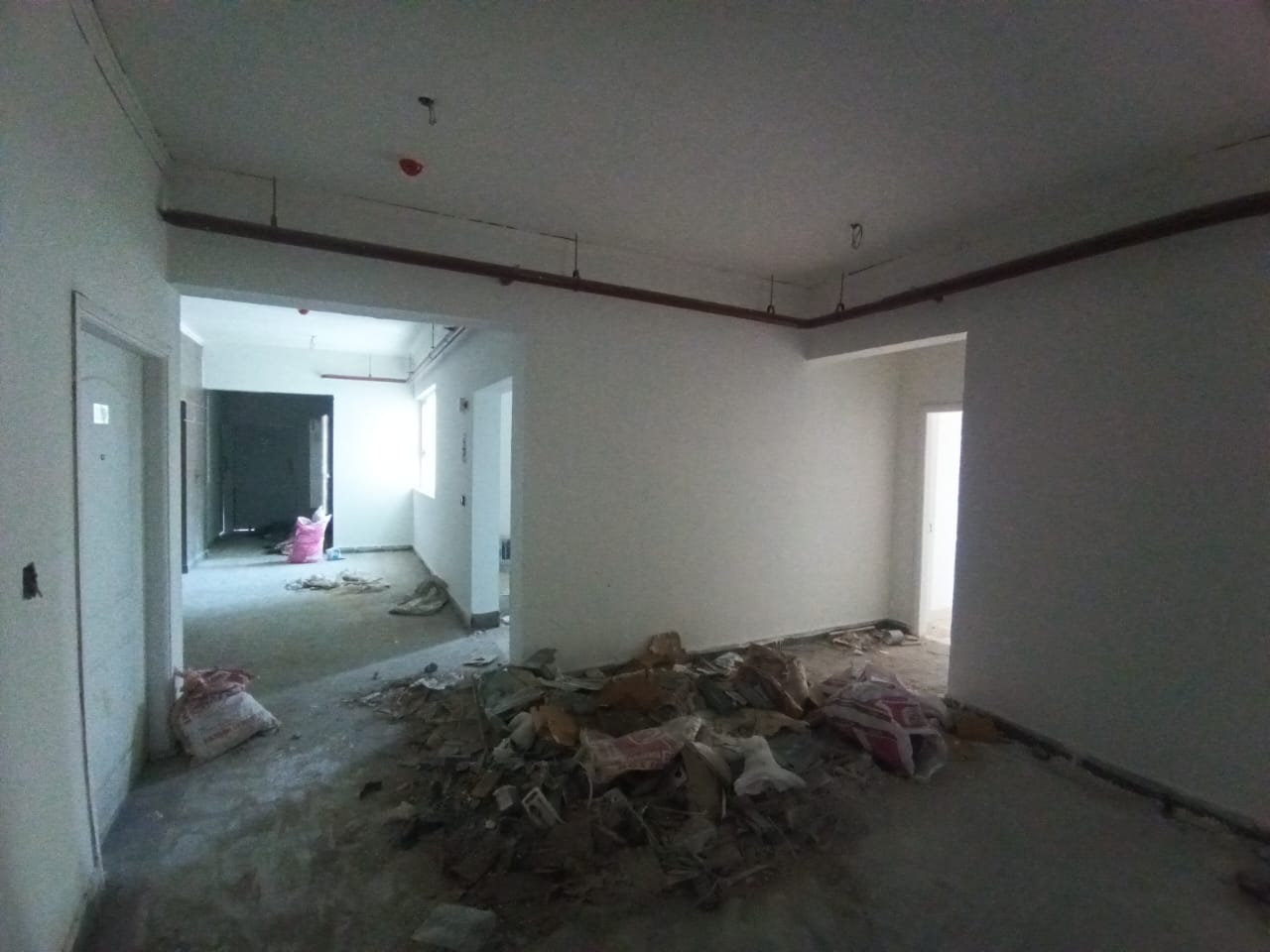

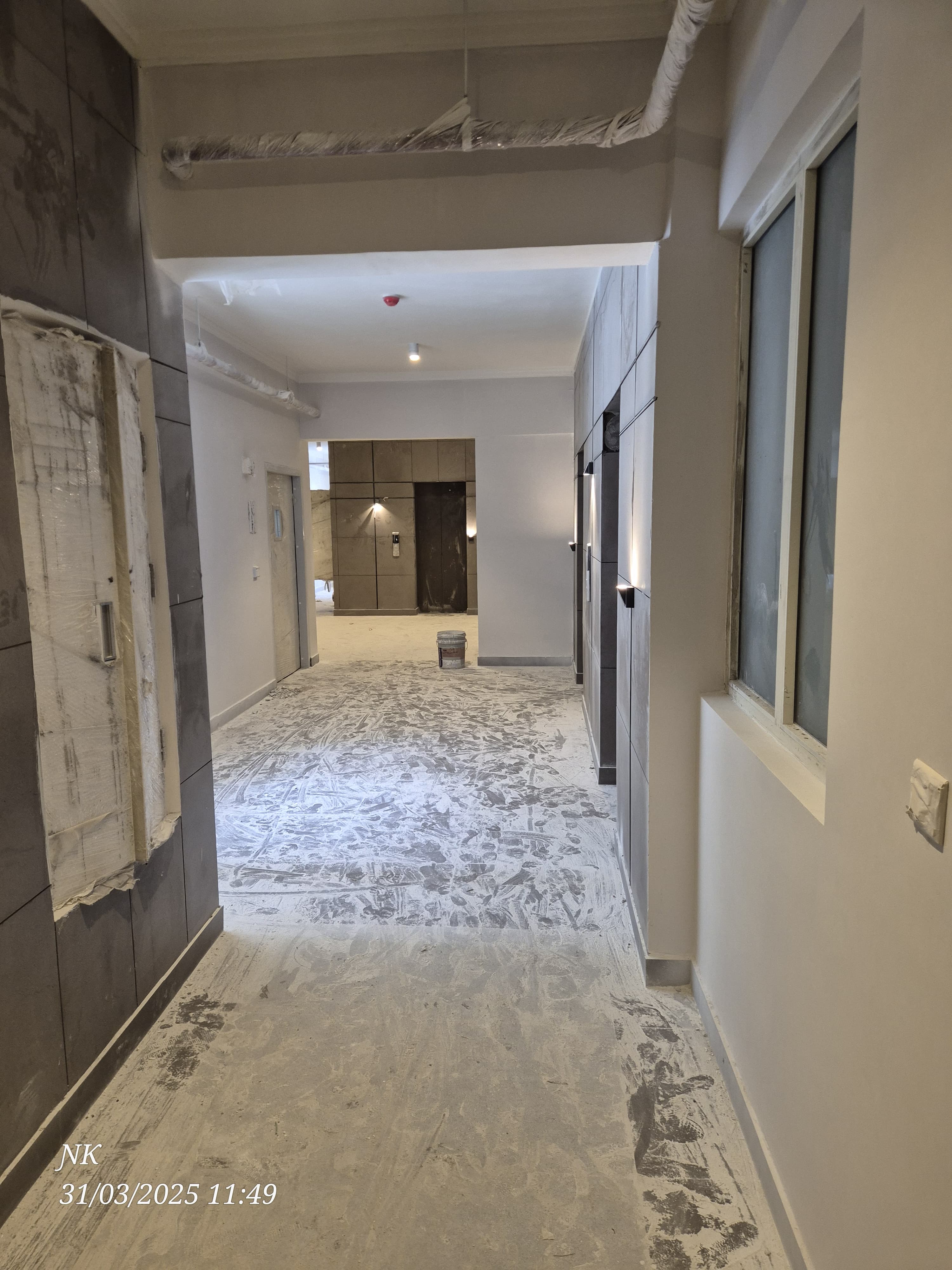

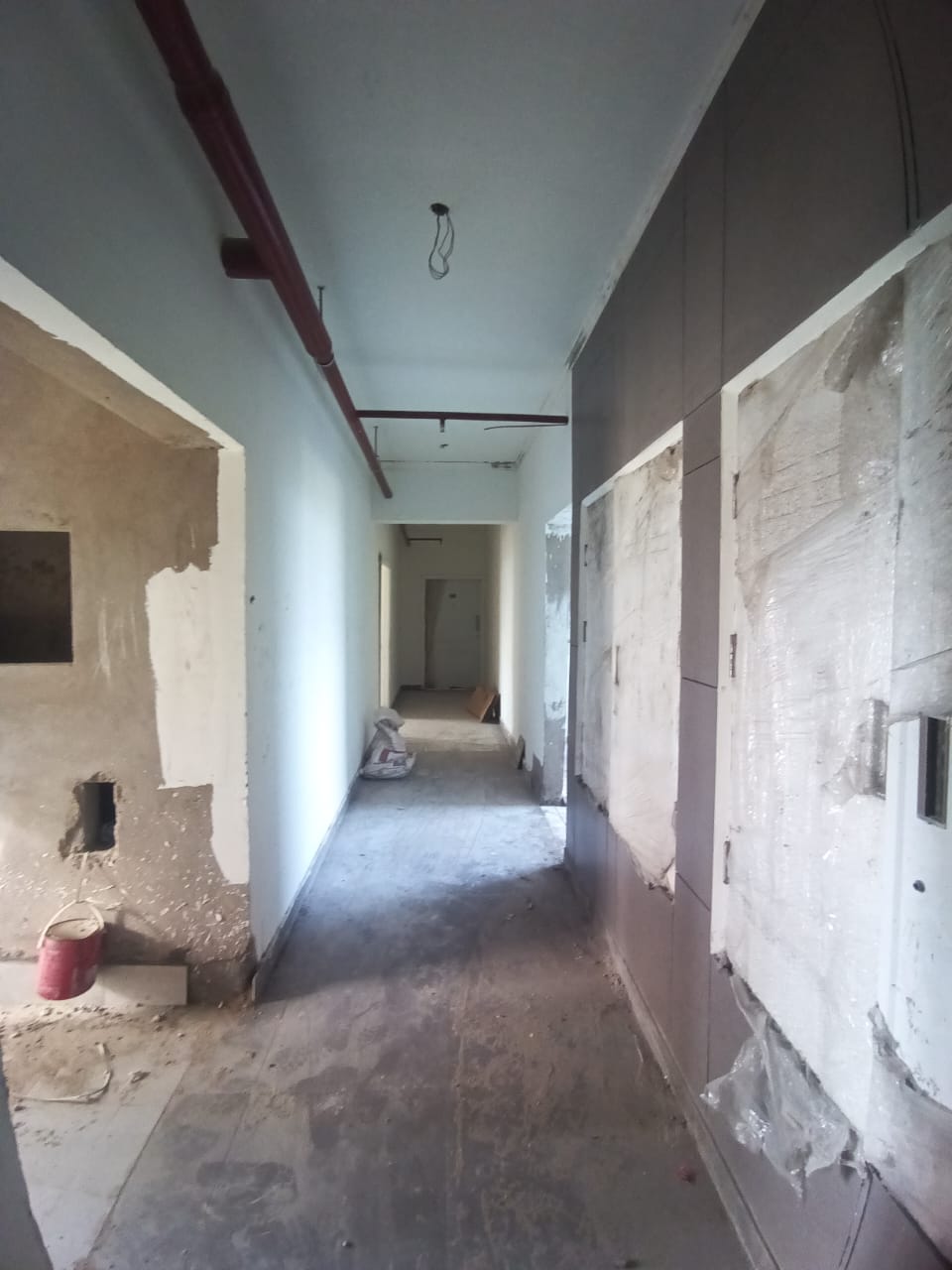

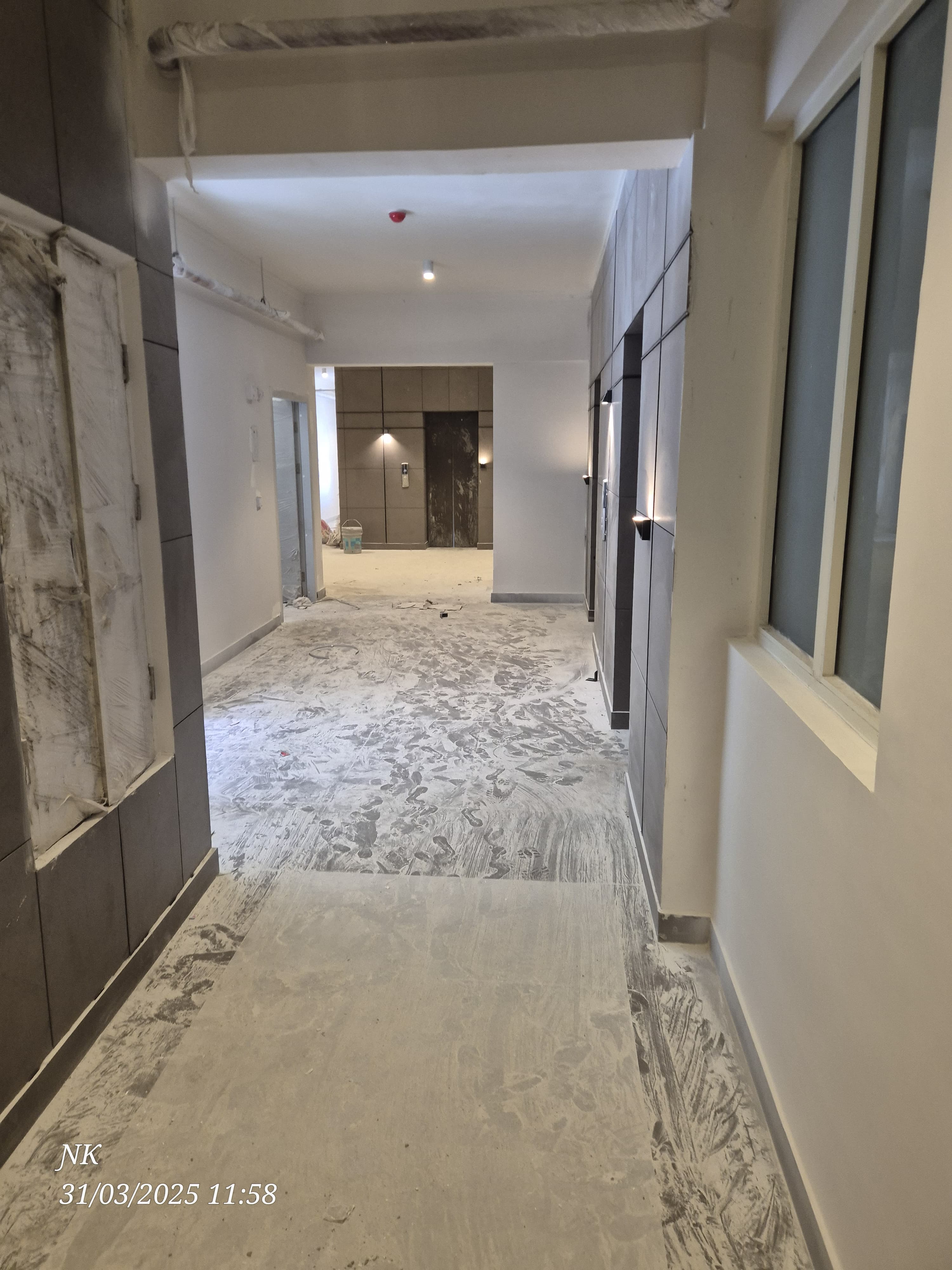

Tower-3 1 Under Construction

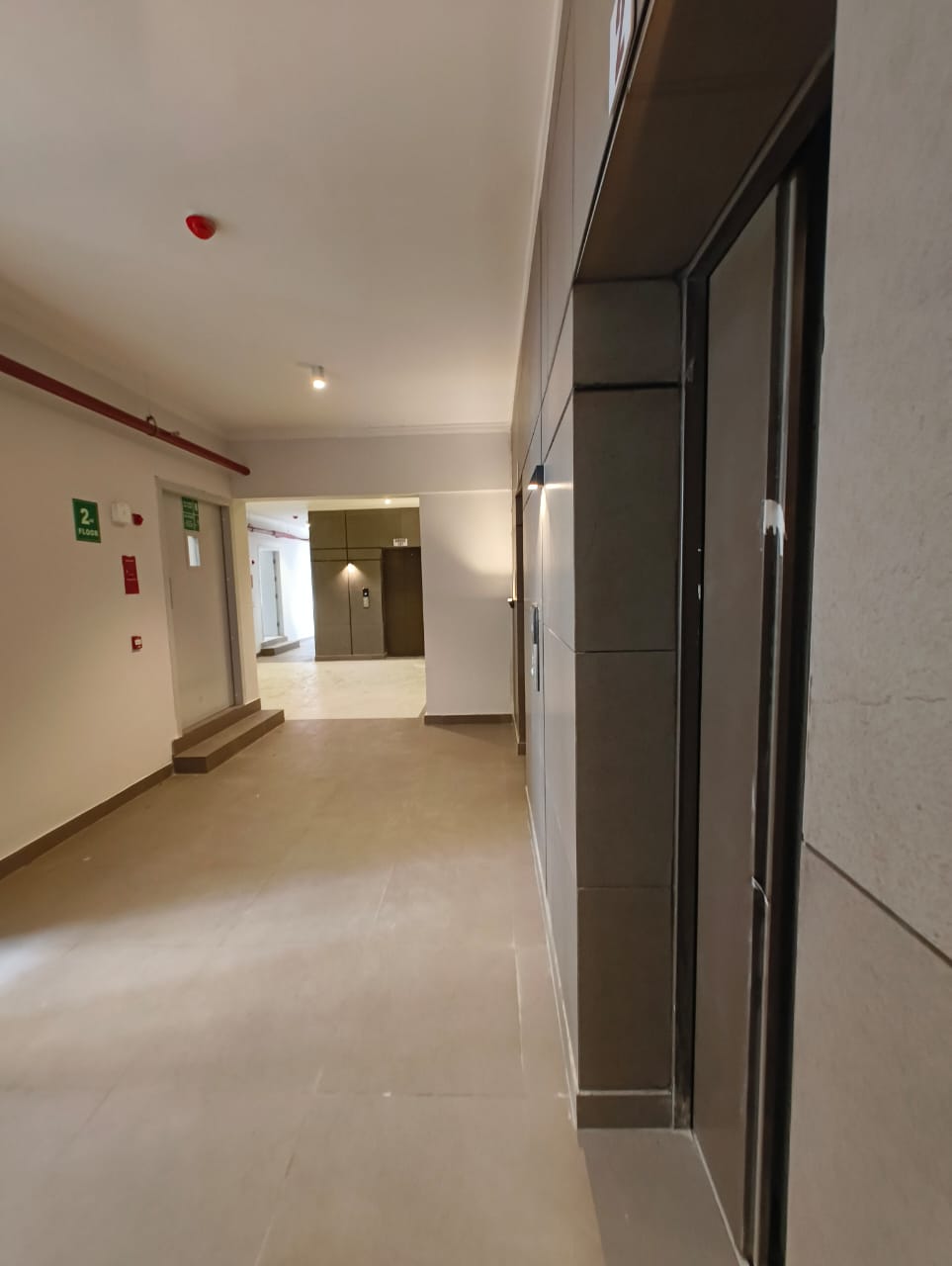

Tower-3 2 Under Construction

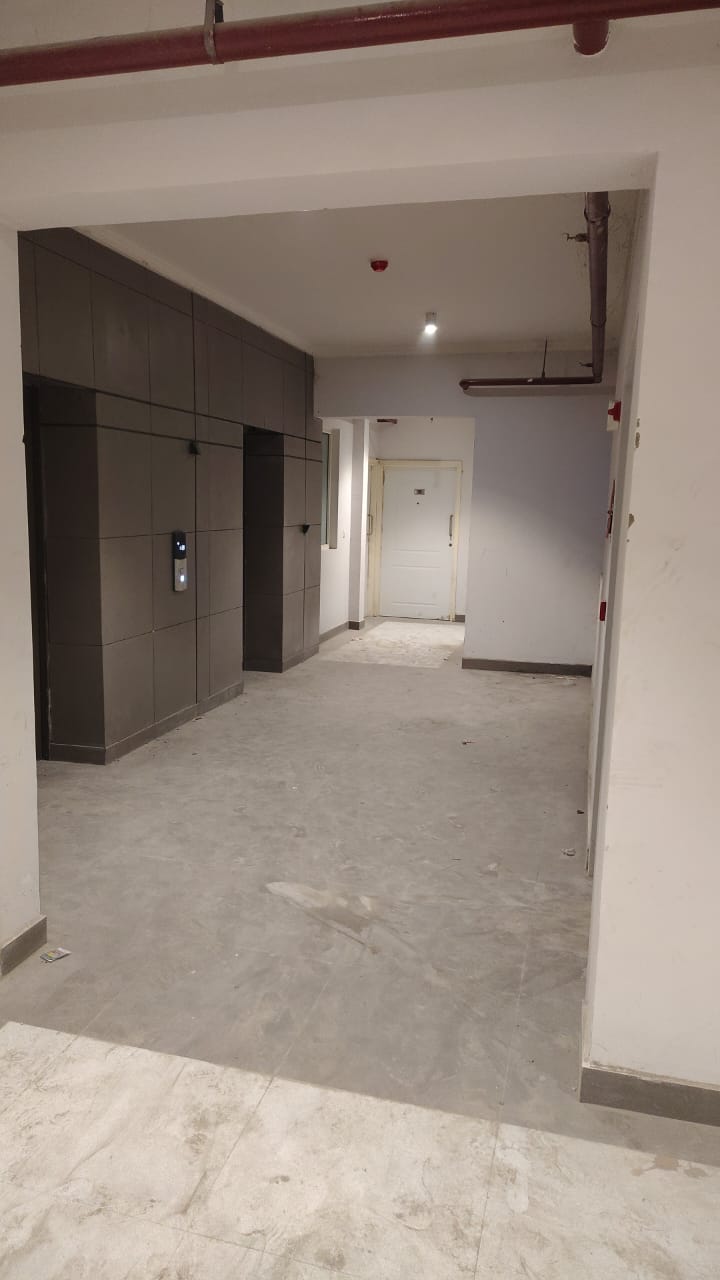

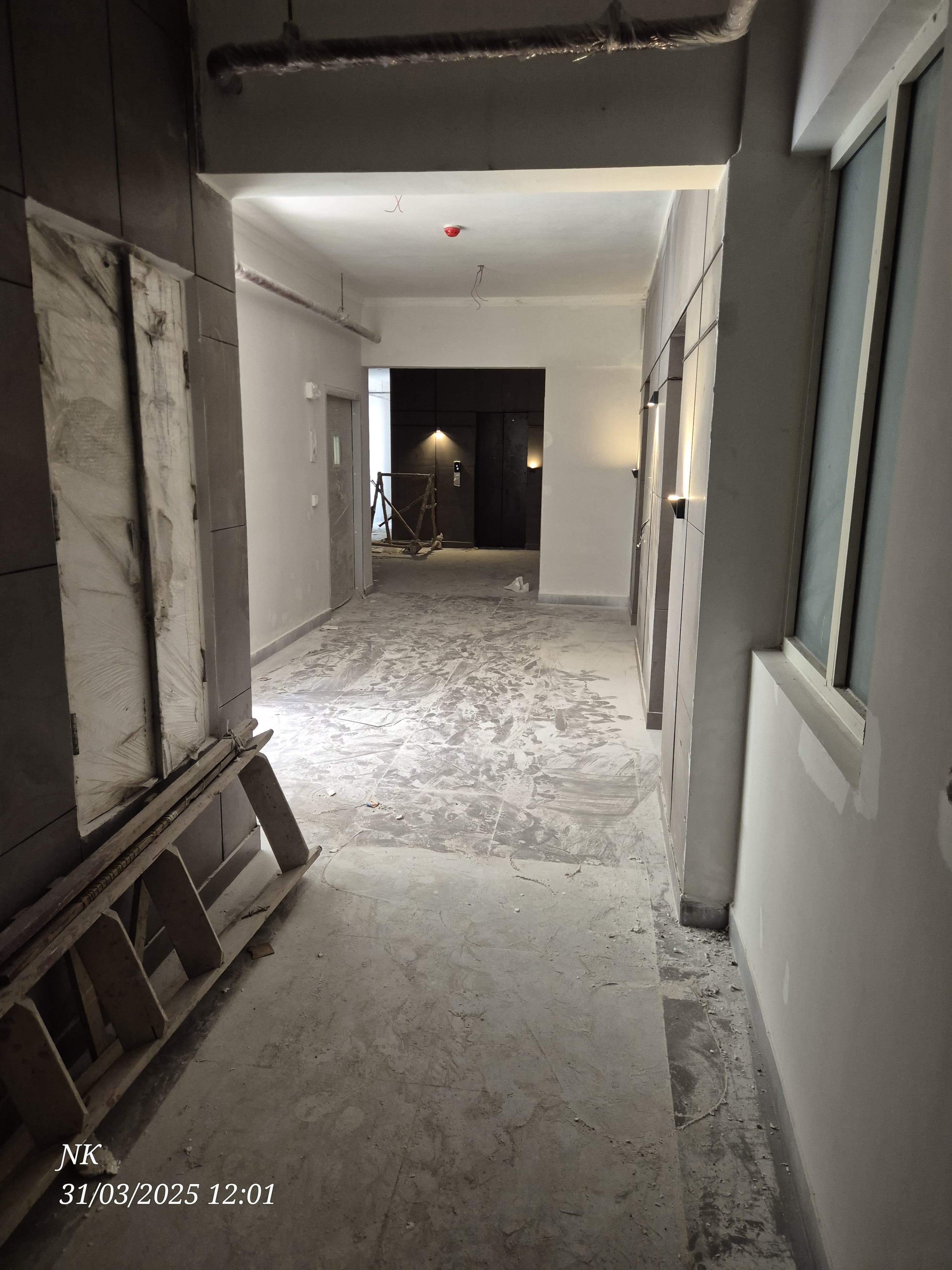

Tower-3 3 Under Construction

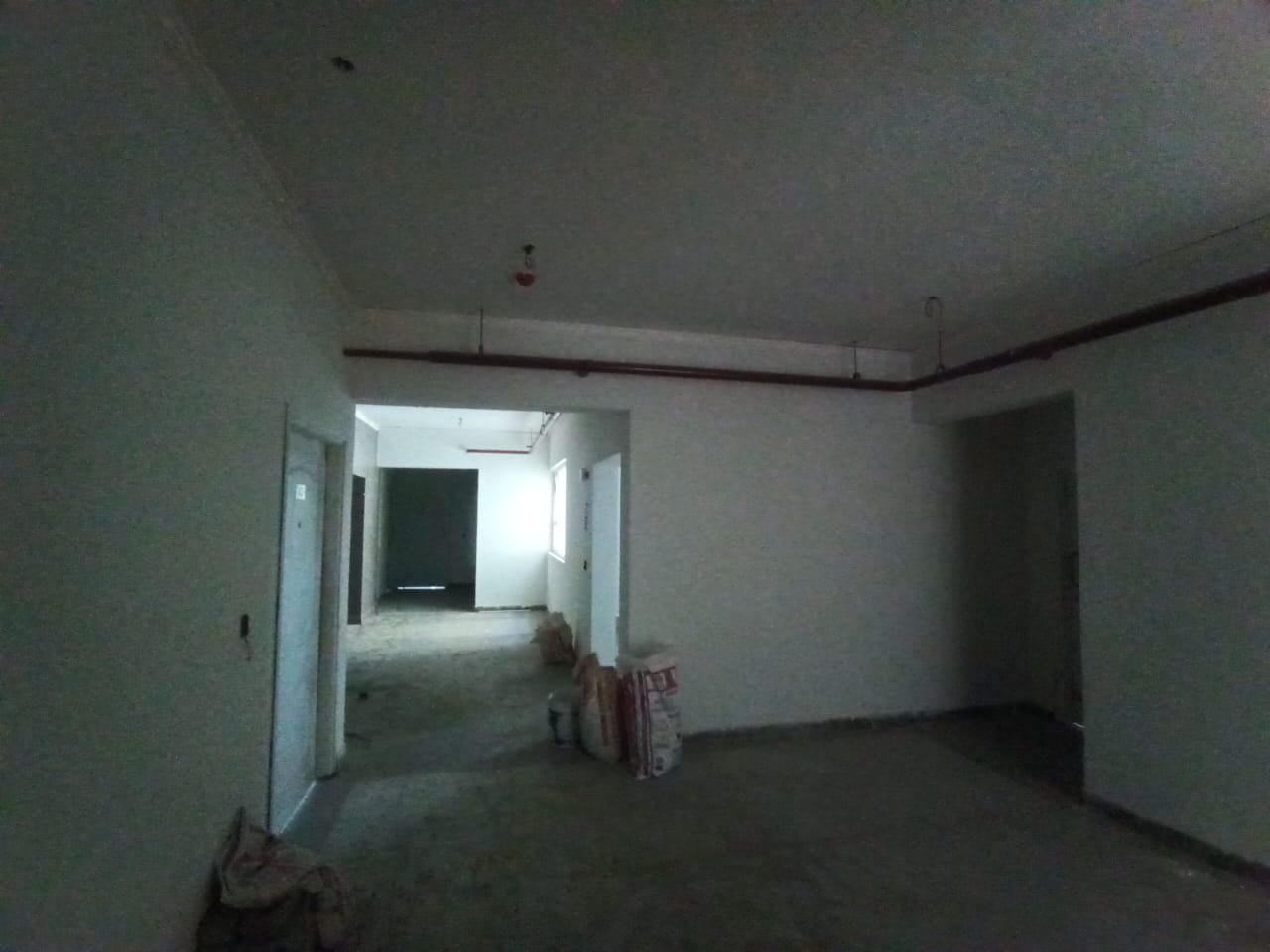

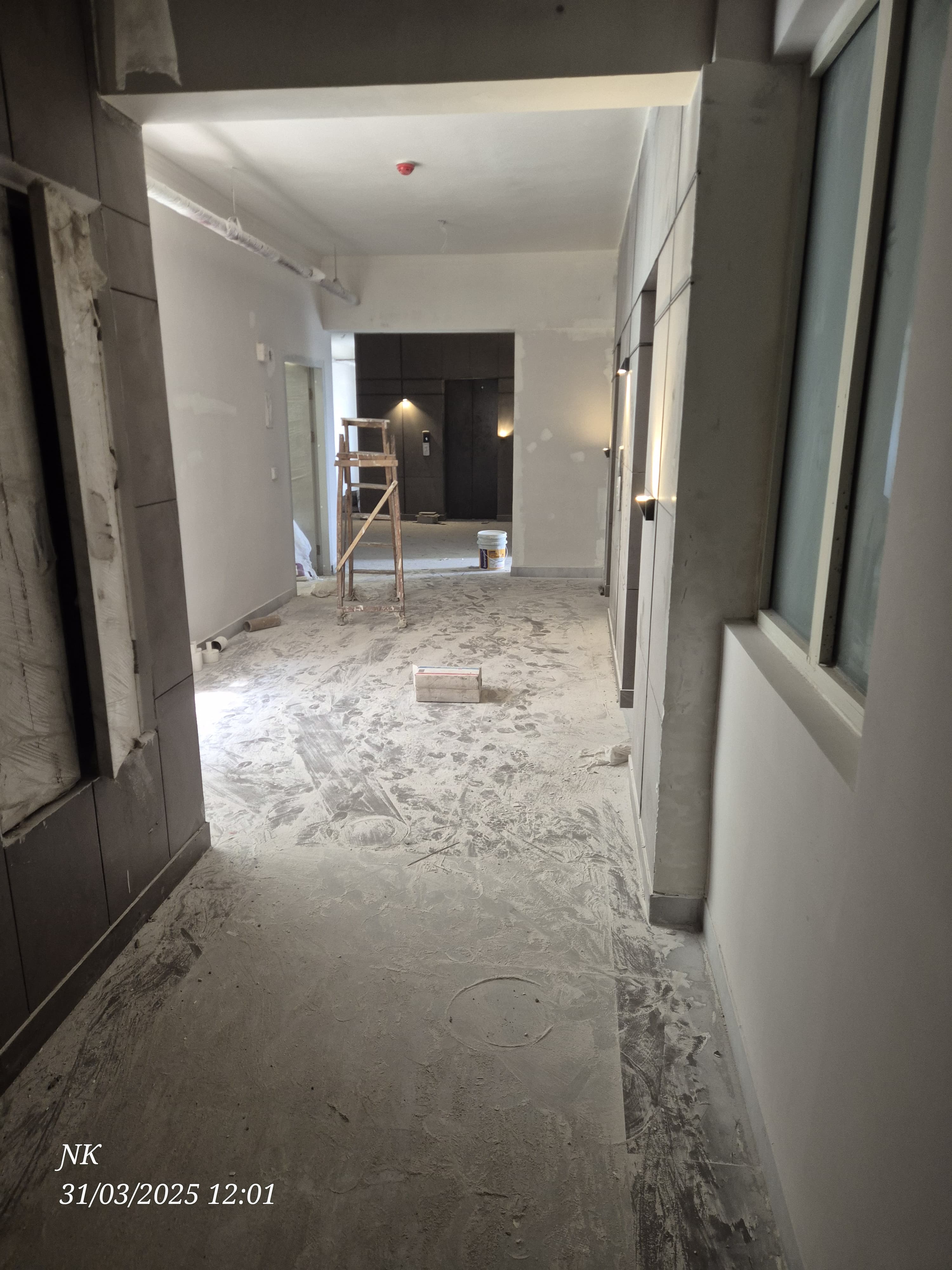

Tower-3 4 Under Construction

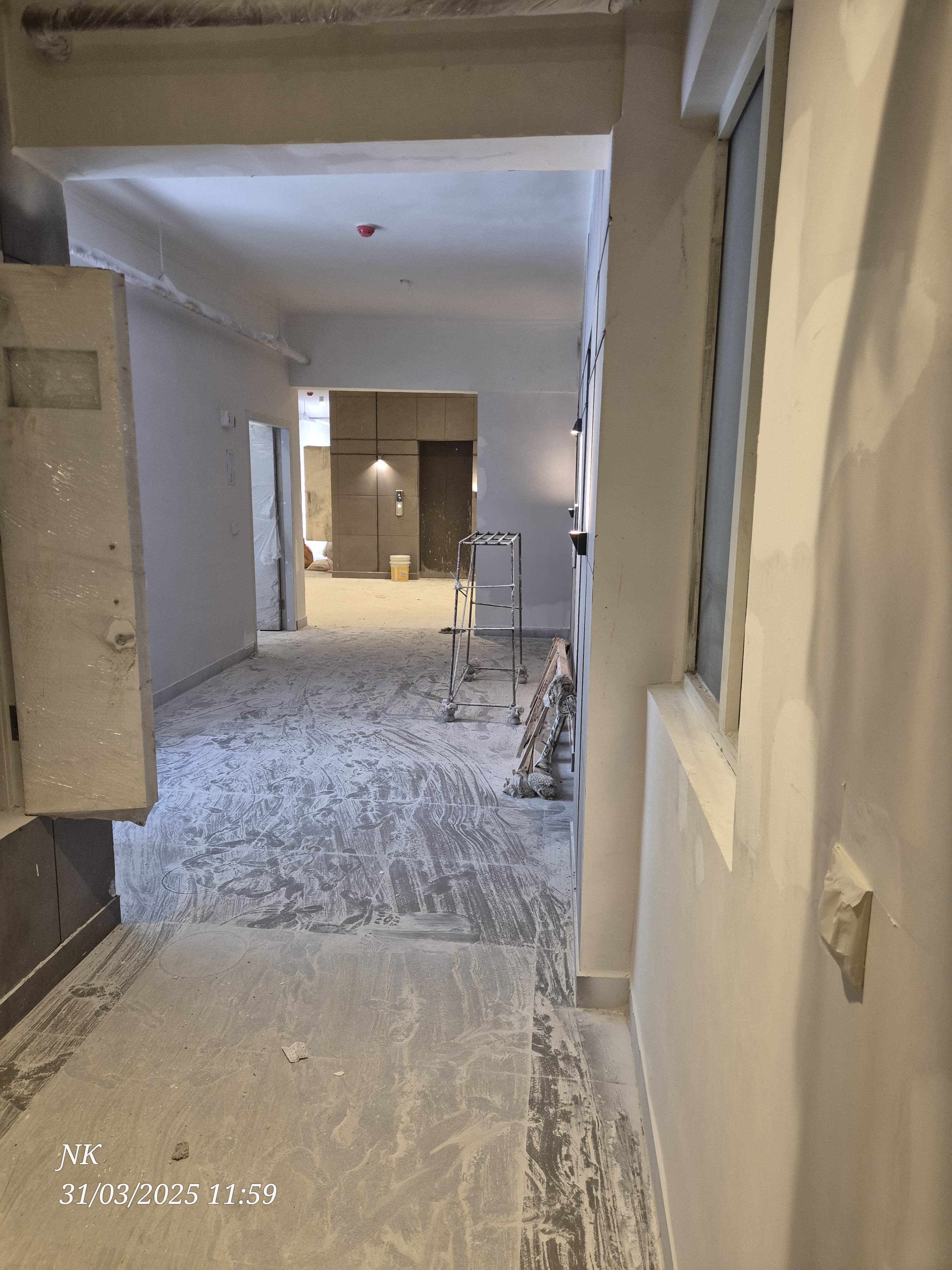

Tower-3 5 Under Construction

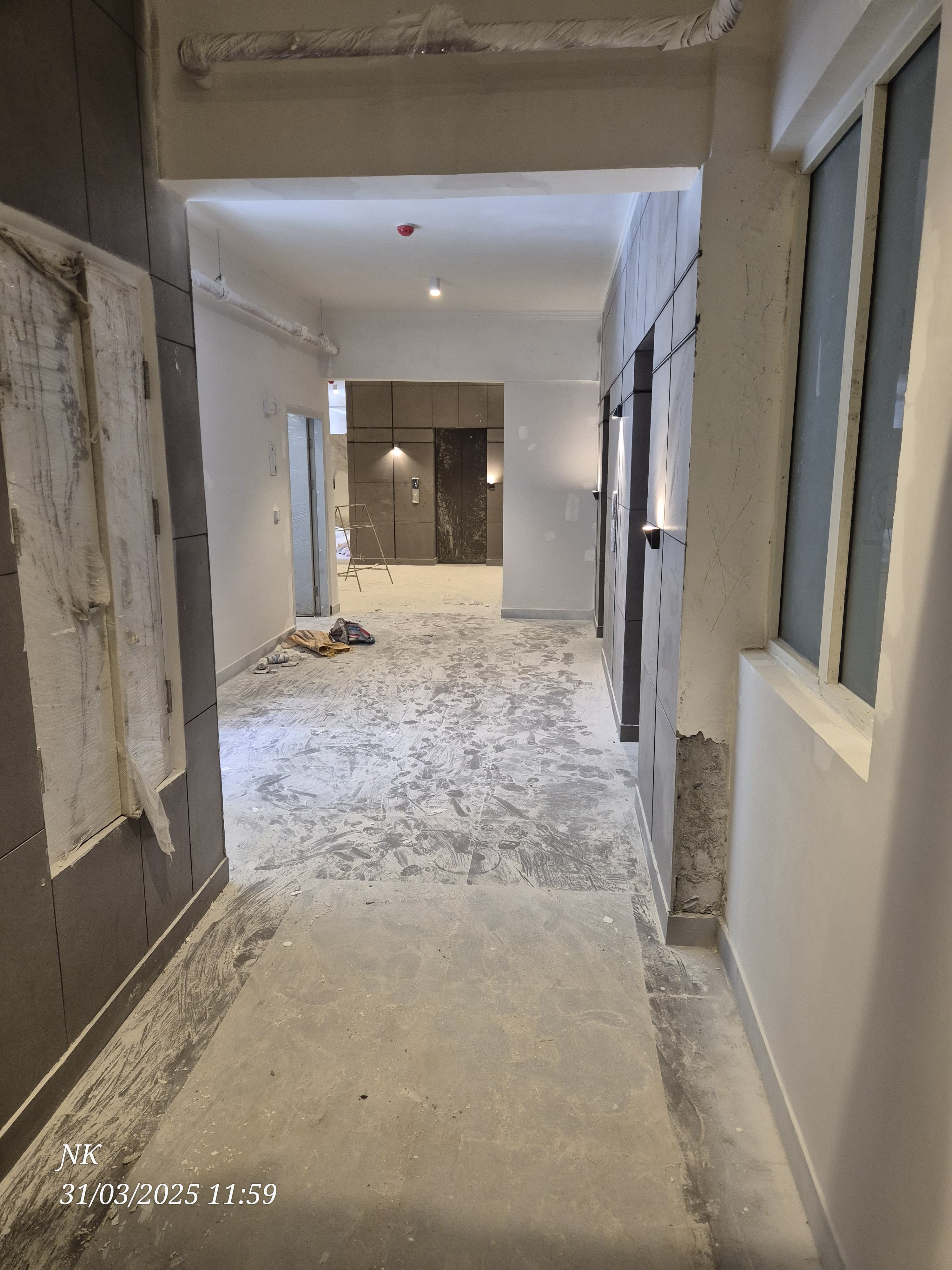

Tower-3 6 Under Construction
Tower-3 7 Under Construction

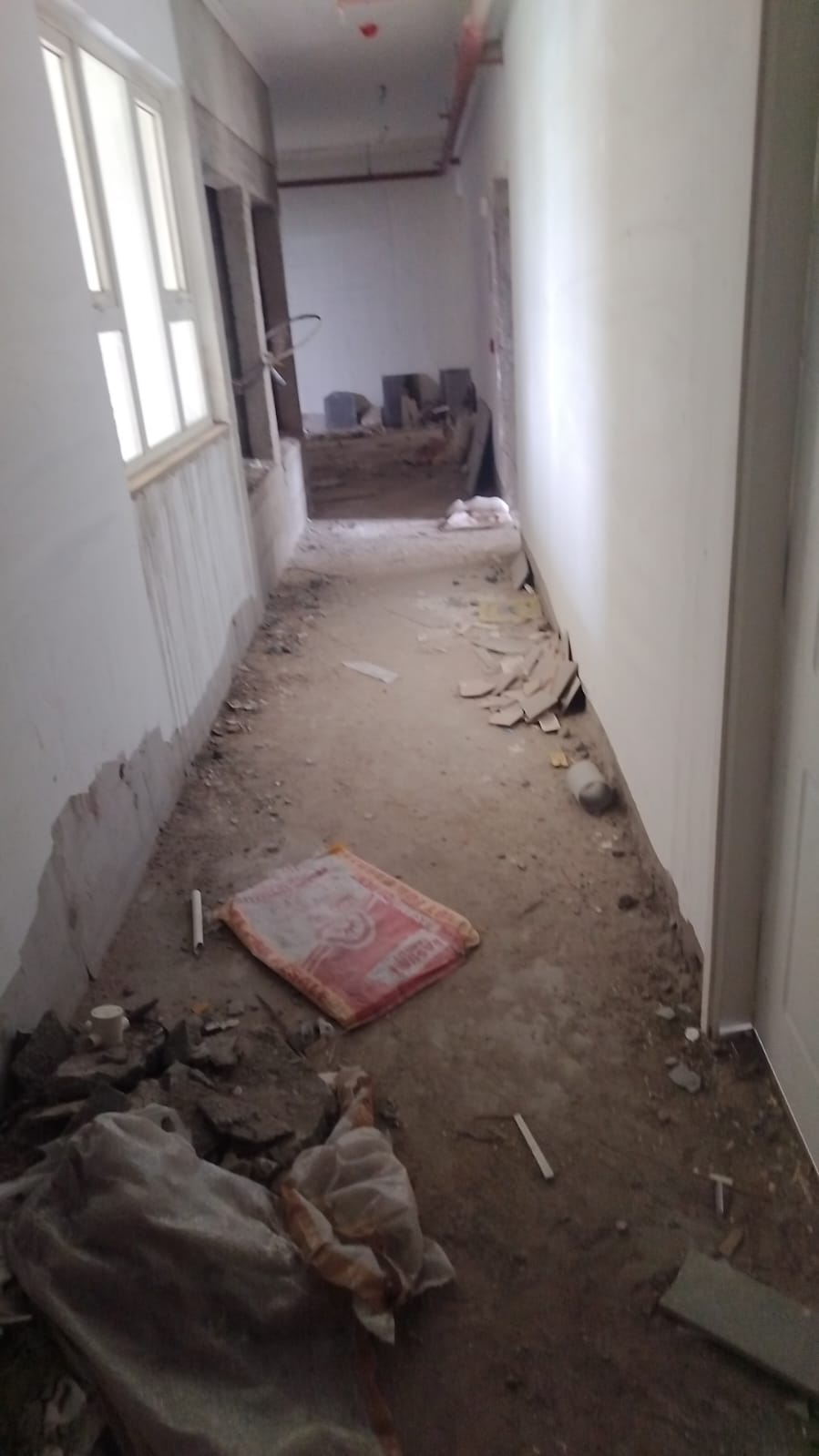

Tower-3 8 Under Construction
Tower-3 9 Under Construction

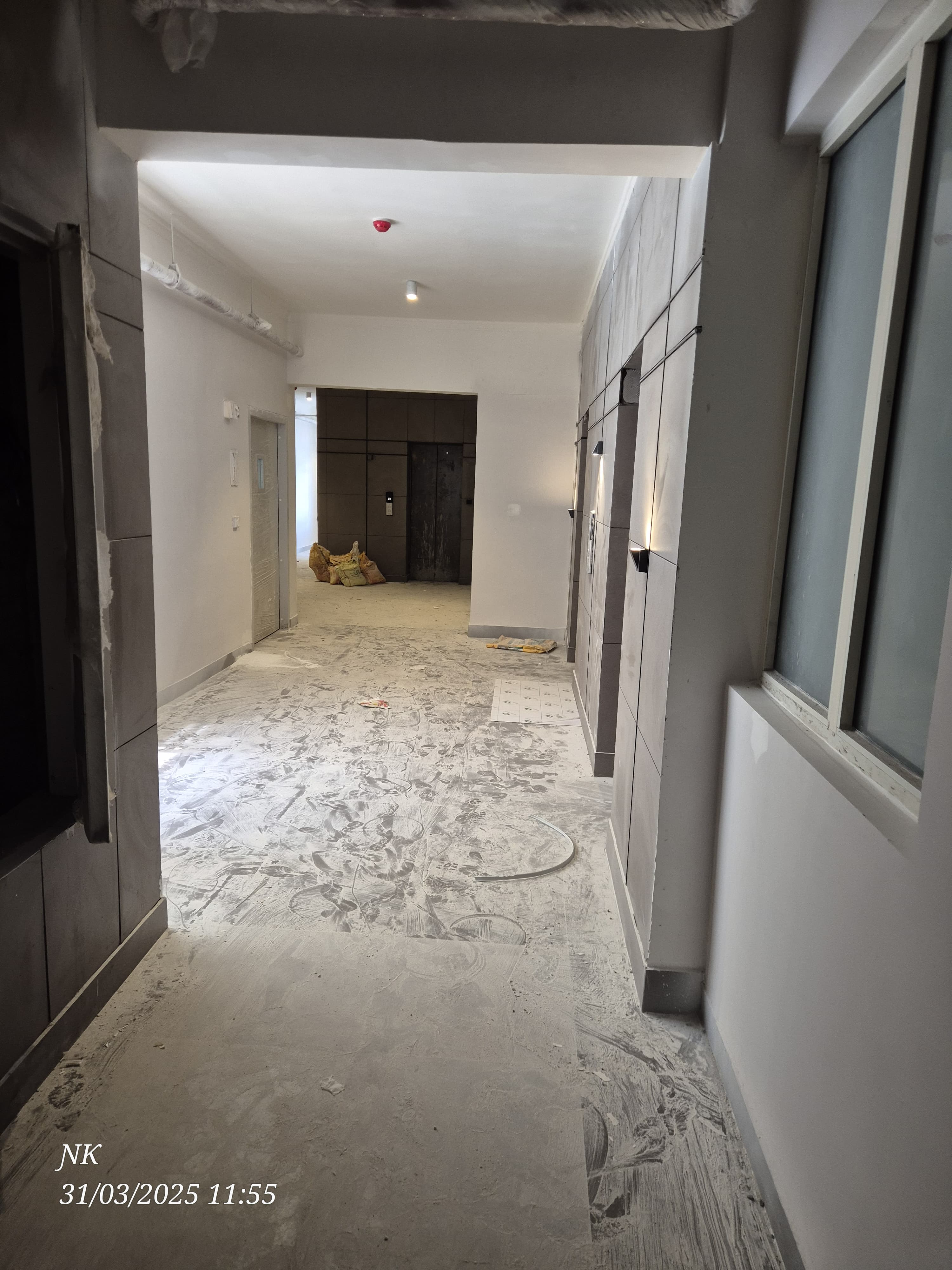

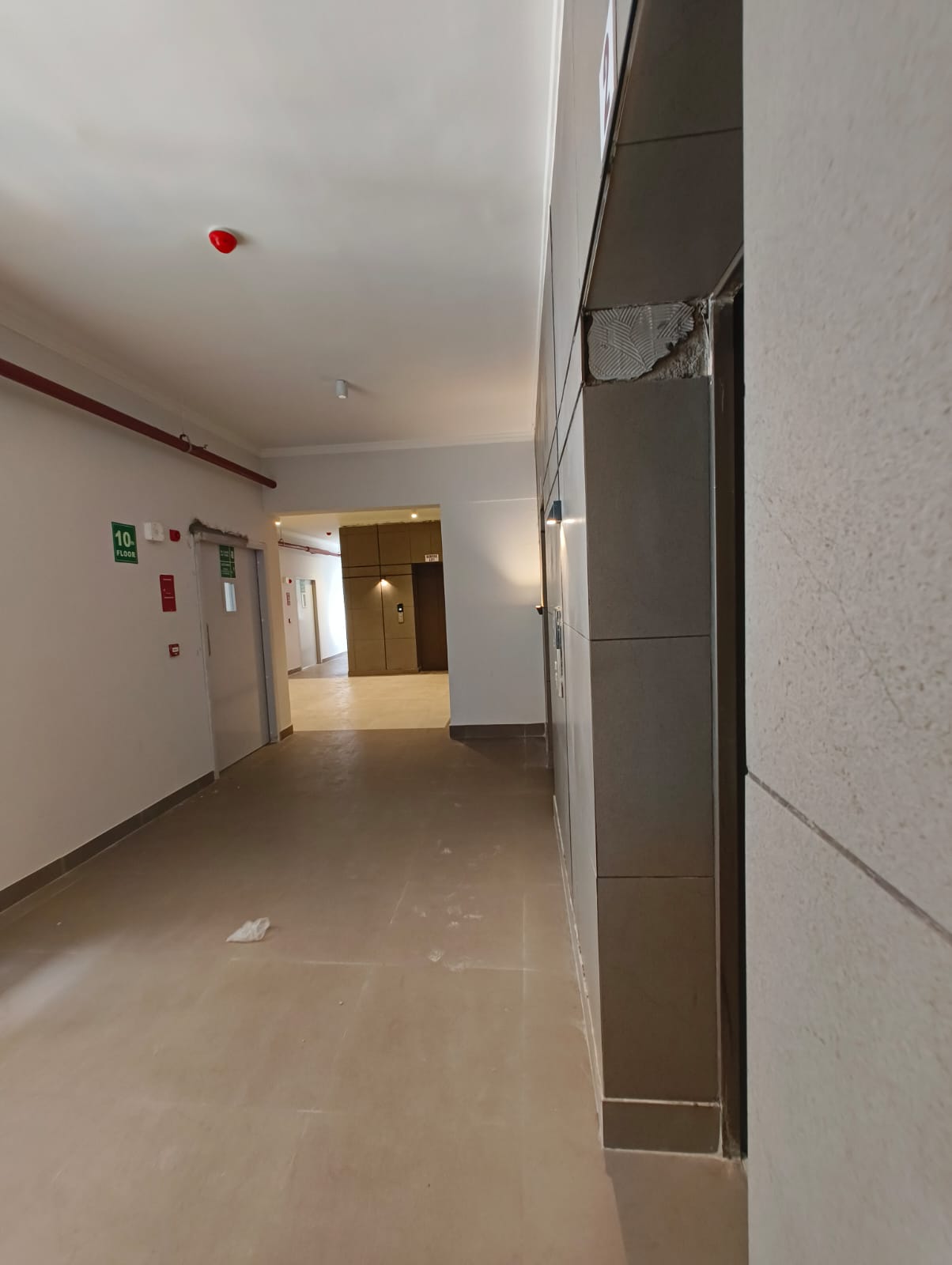

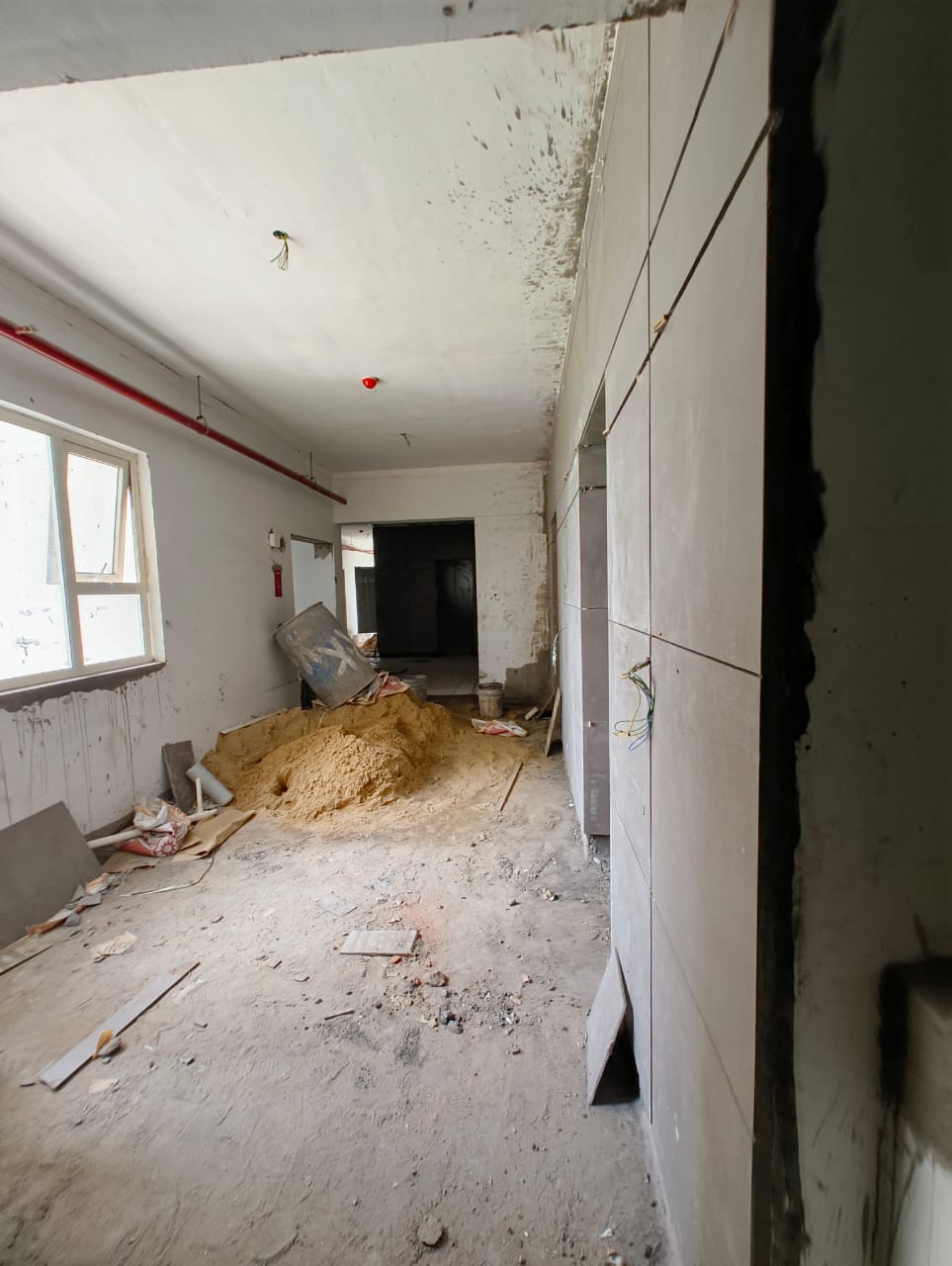

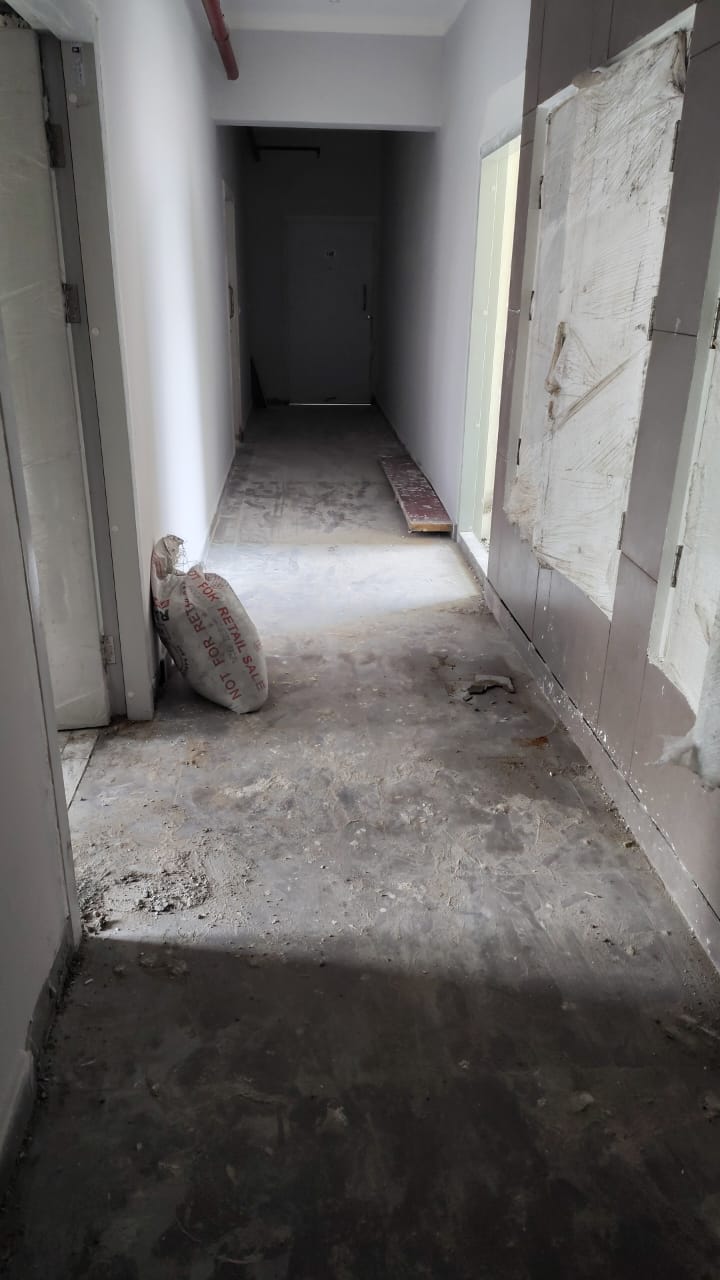

Tower-3 10 Under Construction
Tower-3 11 Under Construction

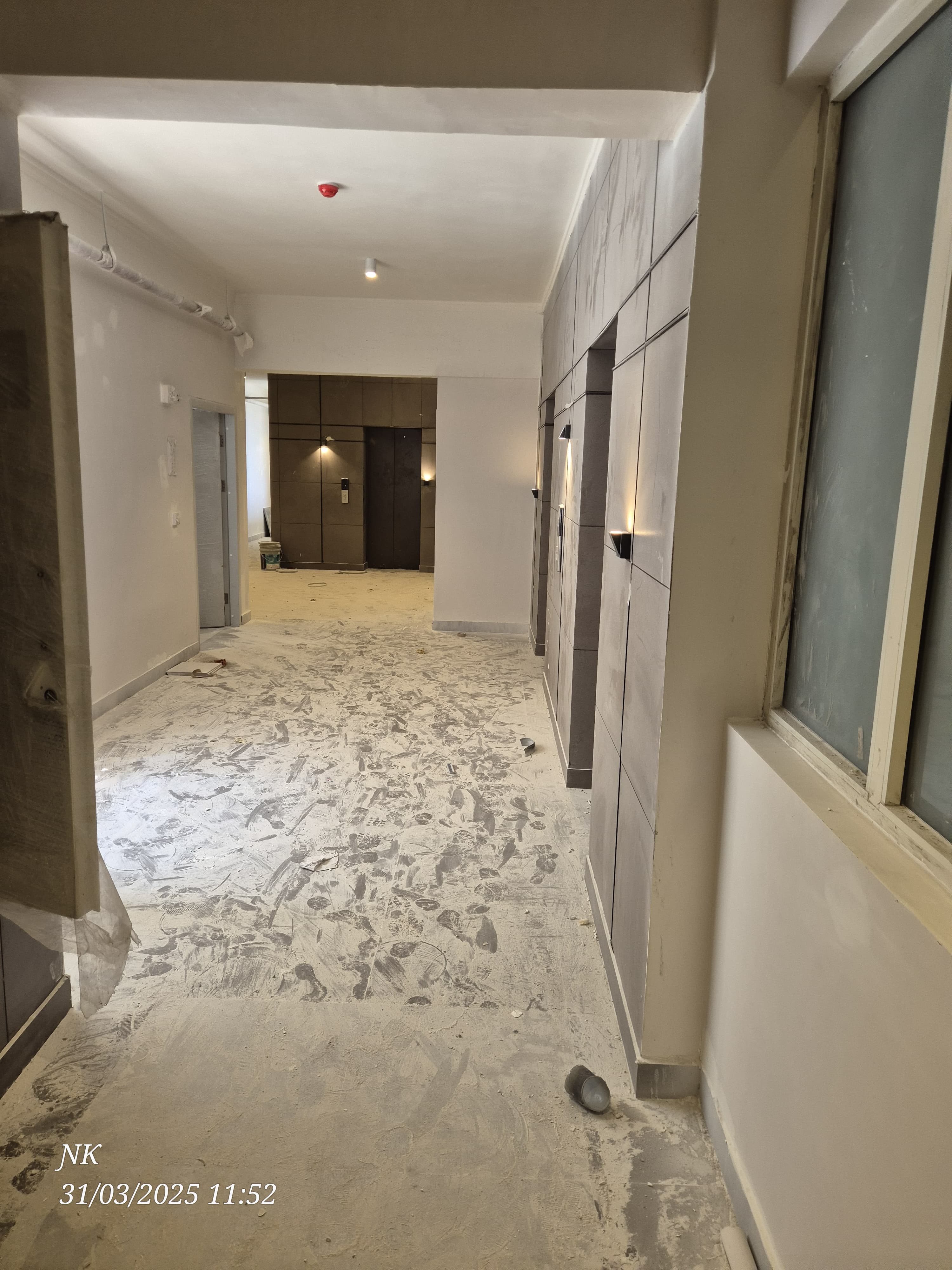

Tower-3 12 Under Construction

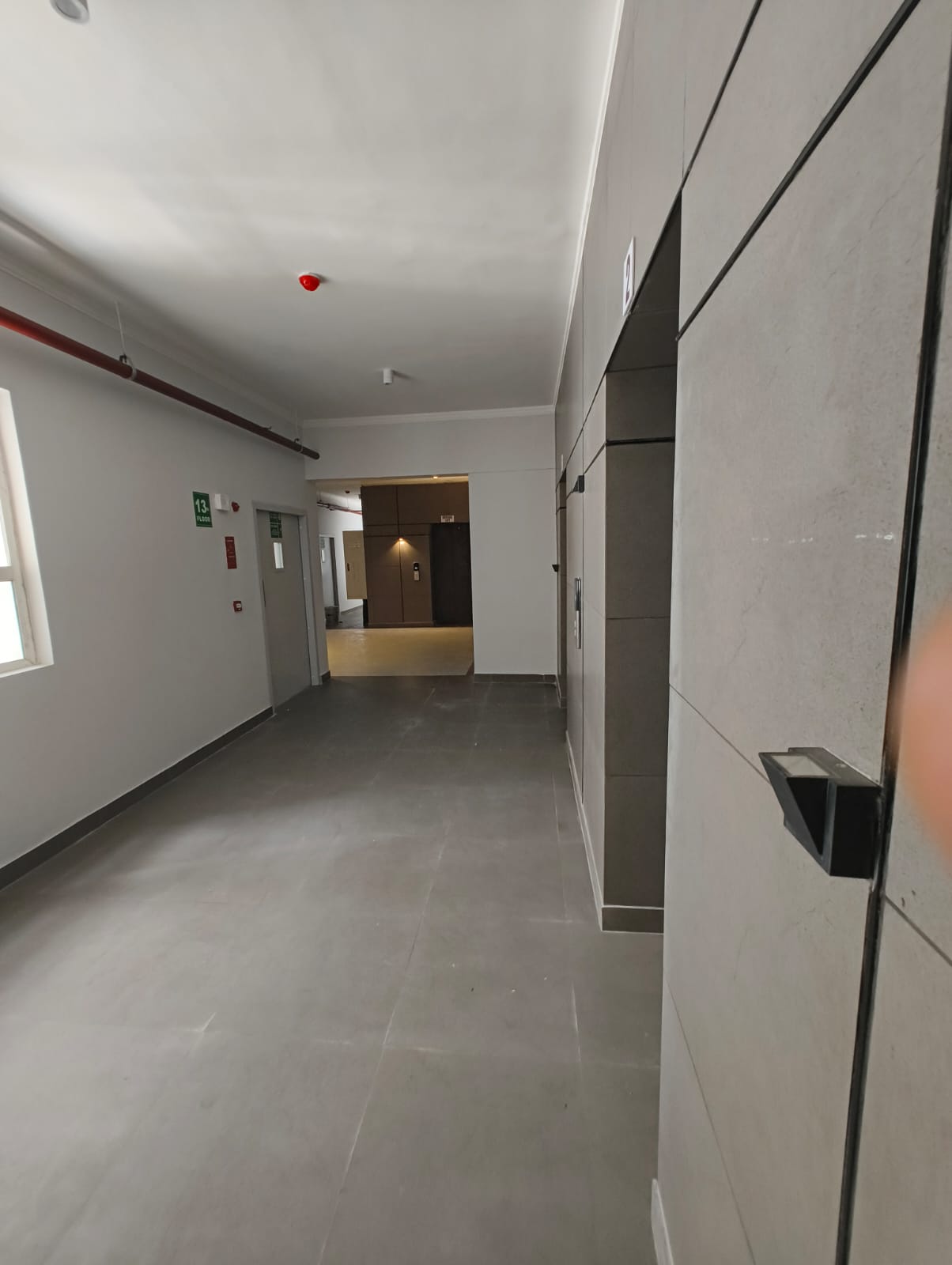

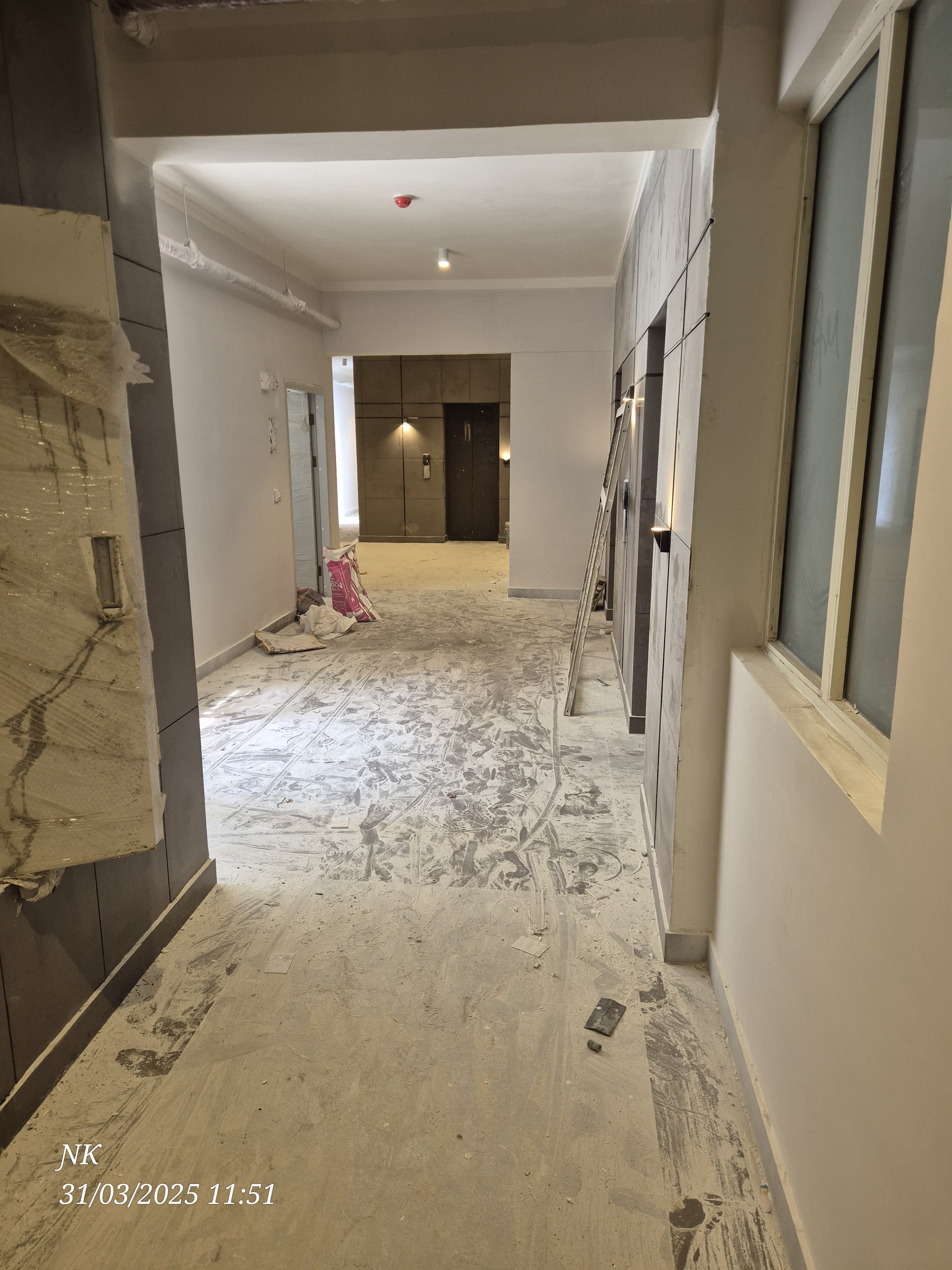

Tower-3 13 Under Construction

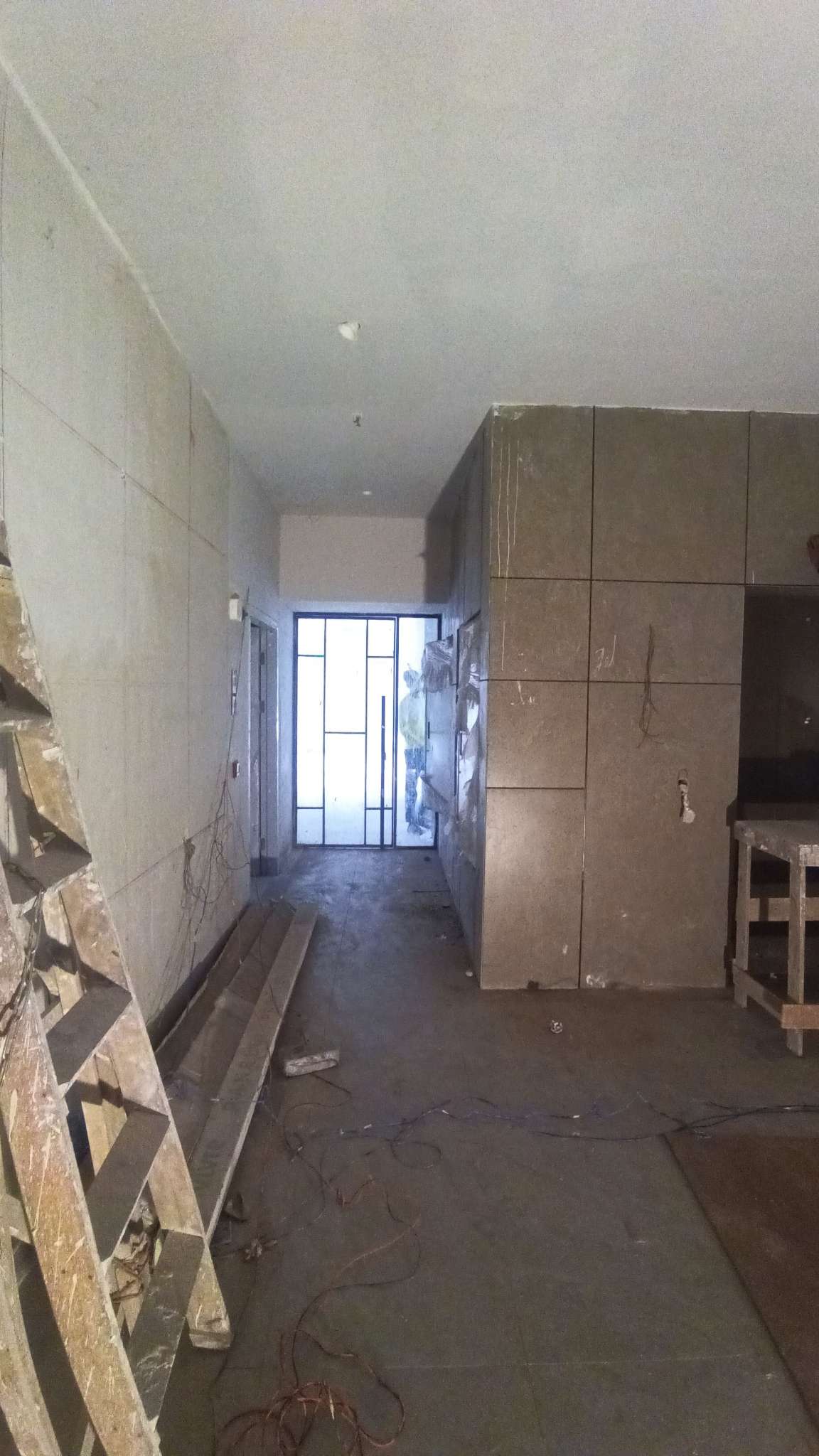

Tower-3 14 Under Construction

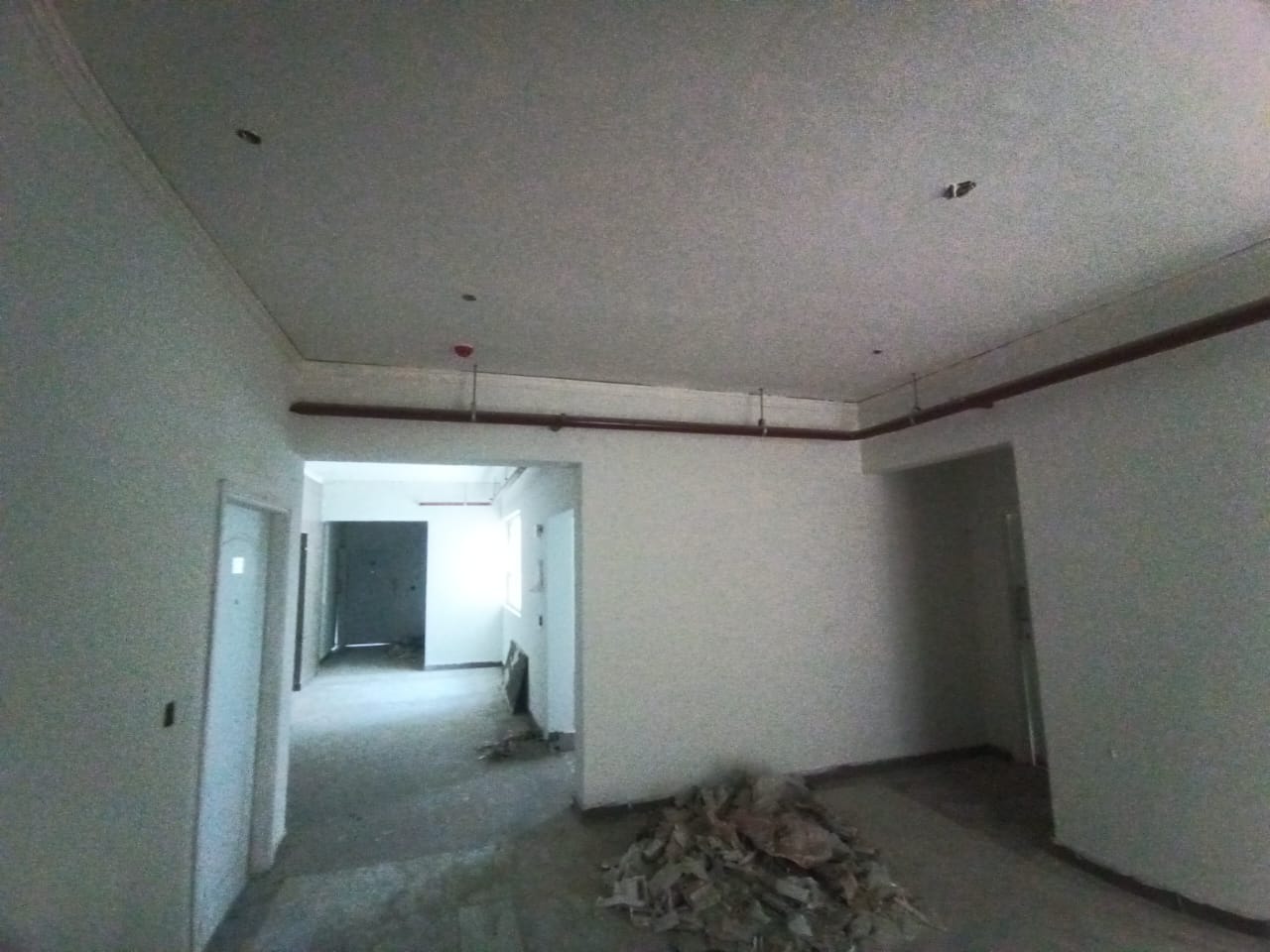

Tower-3 15 Under Construction
Tower-3 16 Under Construction

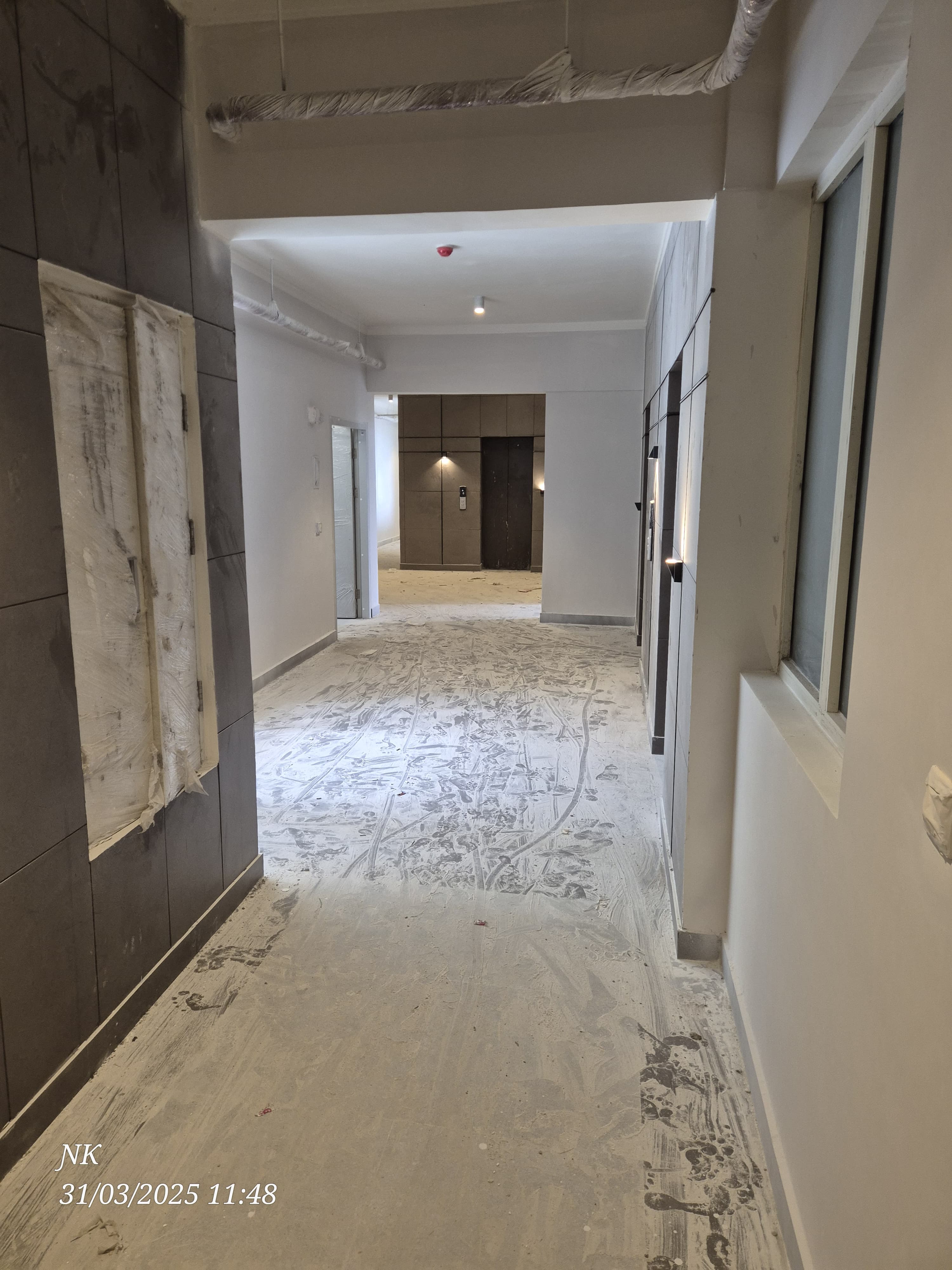

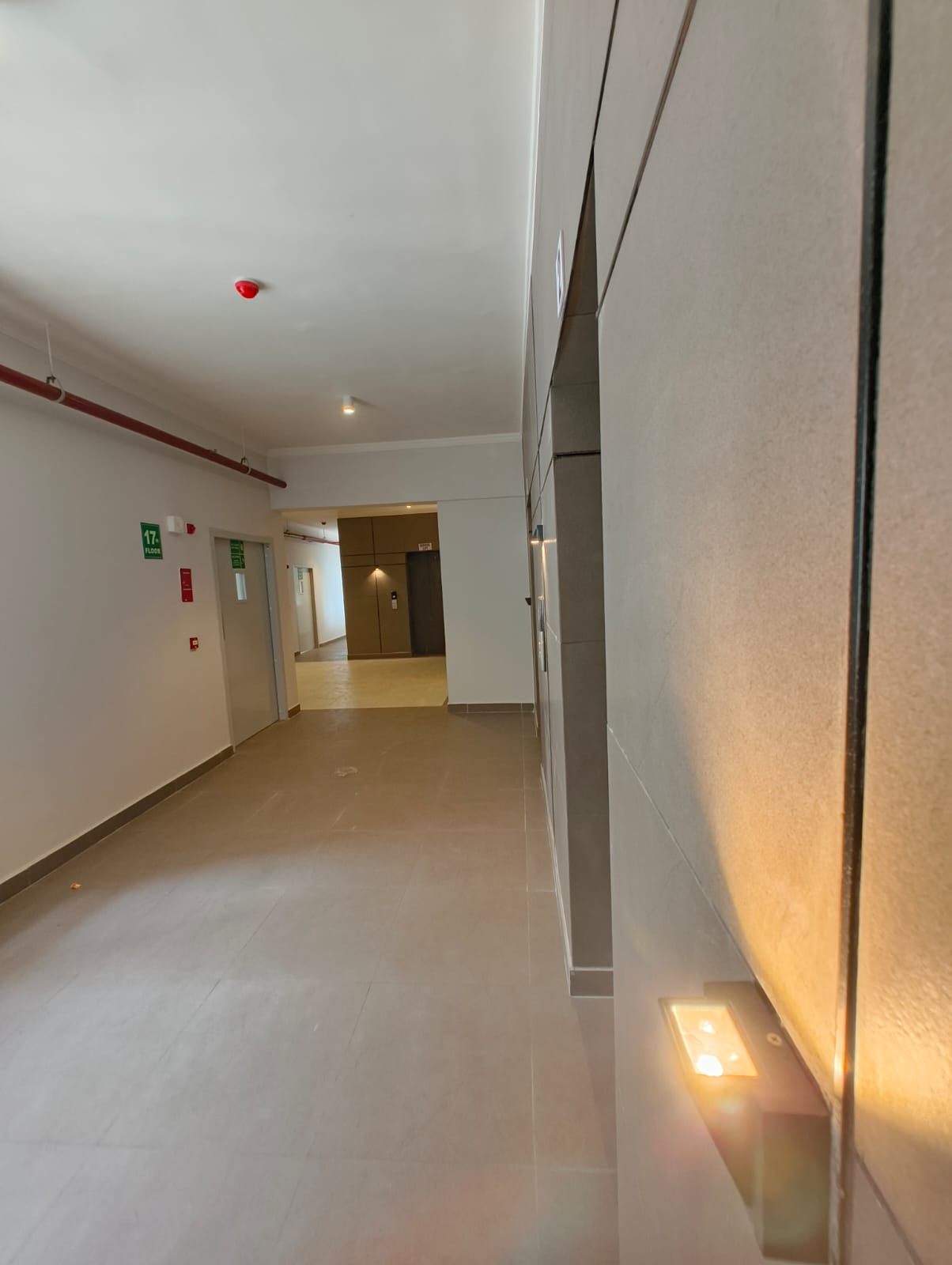

Tower-3 17 Under Construction

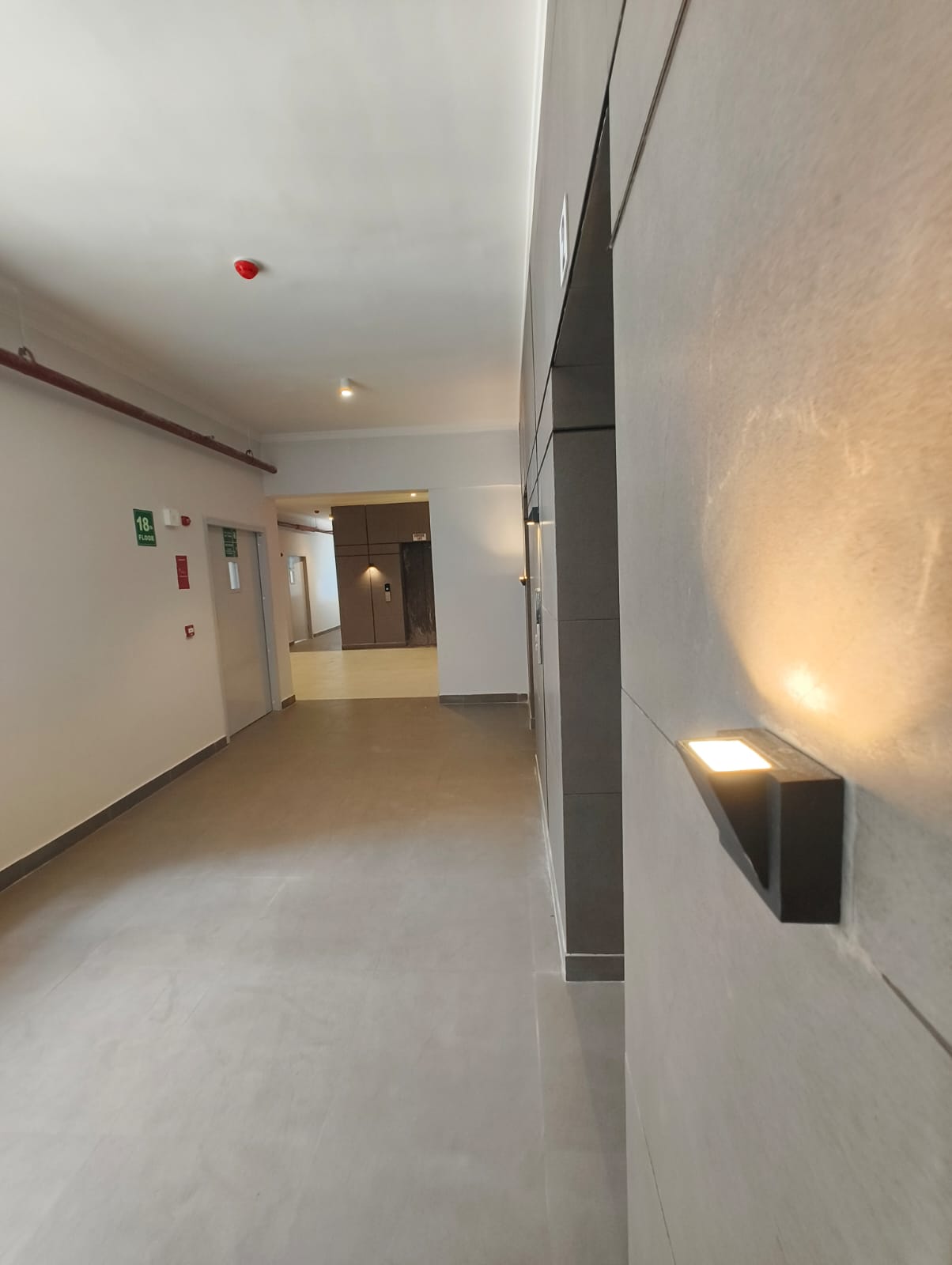

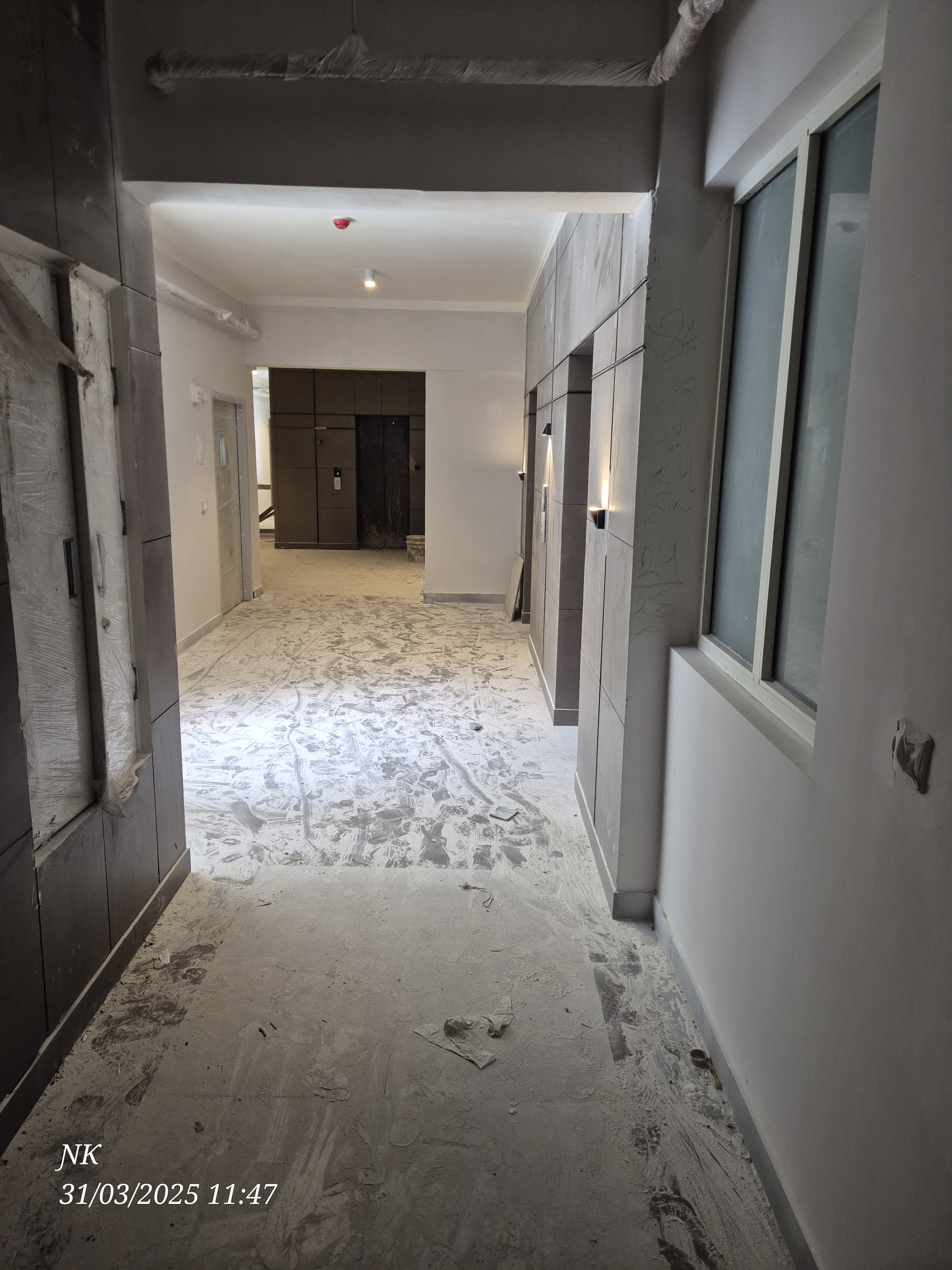

Tower-3 18 Under Construction

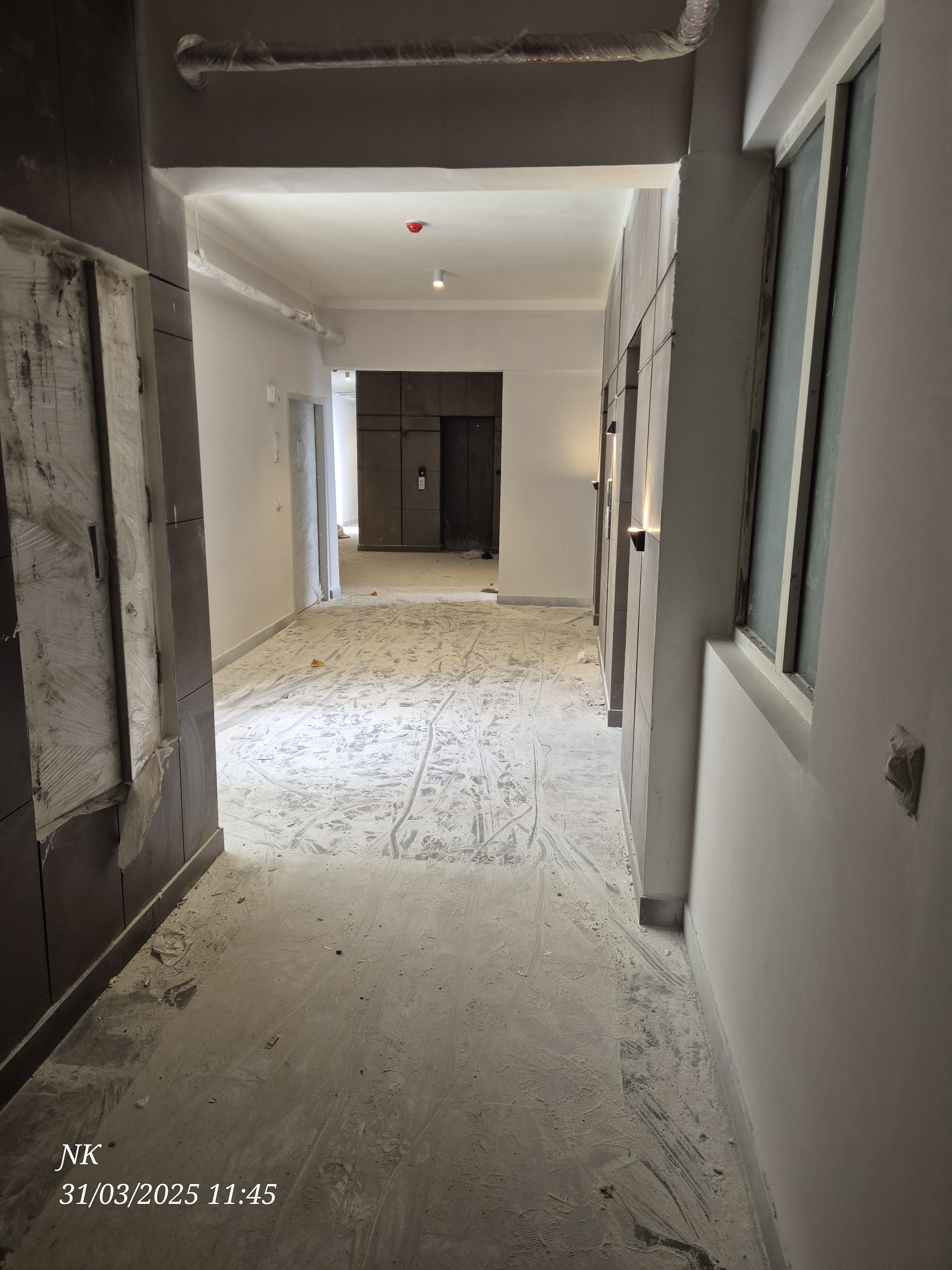

Tower-3 19 Under Construction
Tower-3 20 Under Construction
Tower-3 21 Under Construction

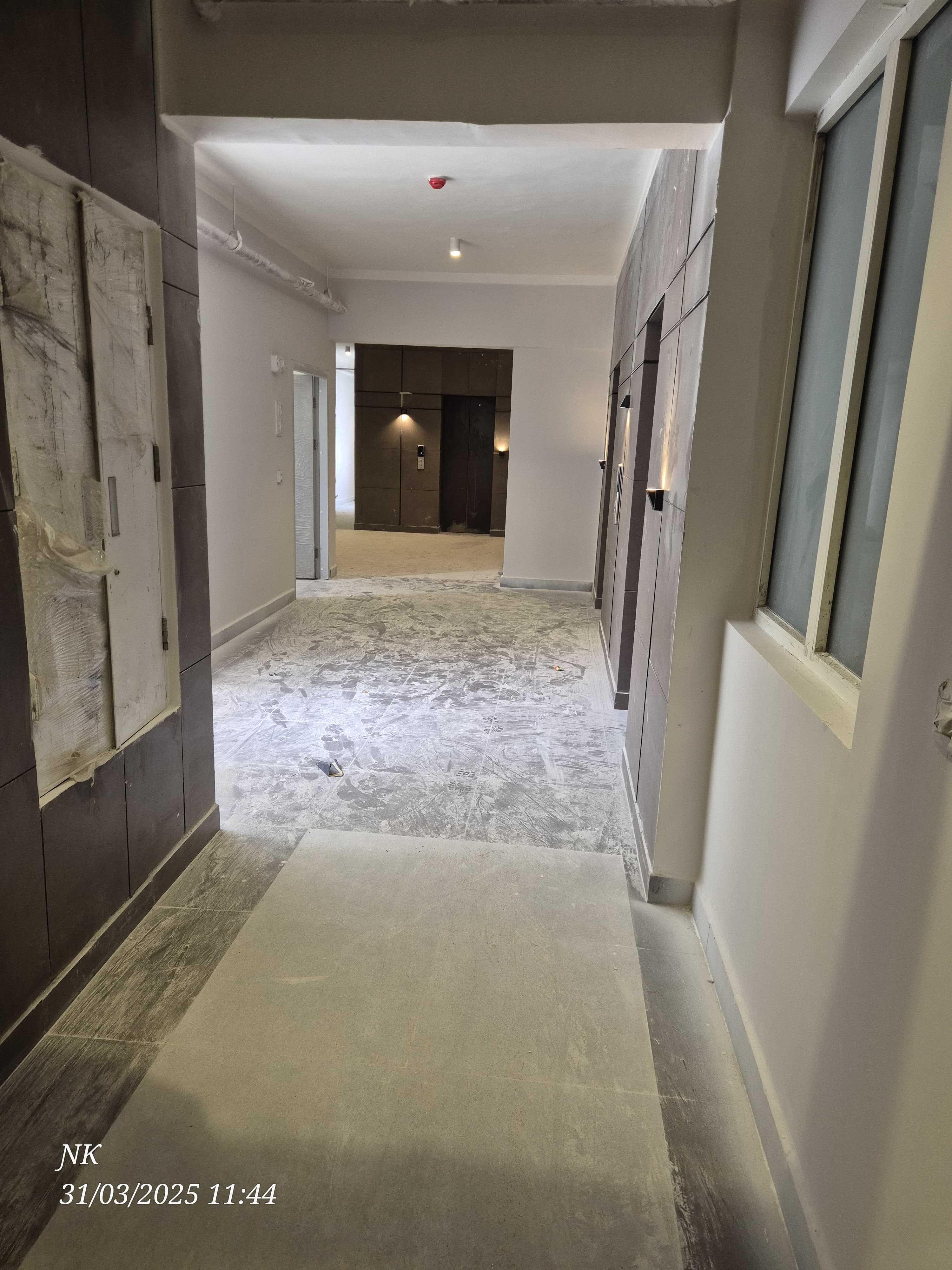

Tower-3 22 Under Construction

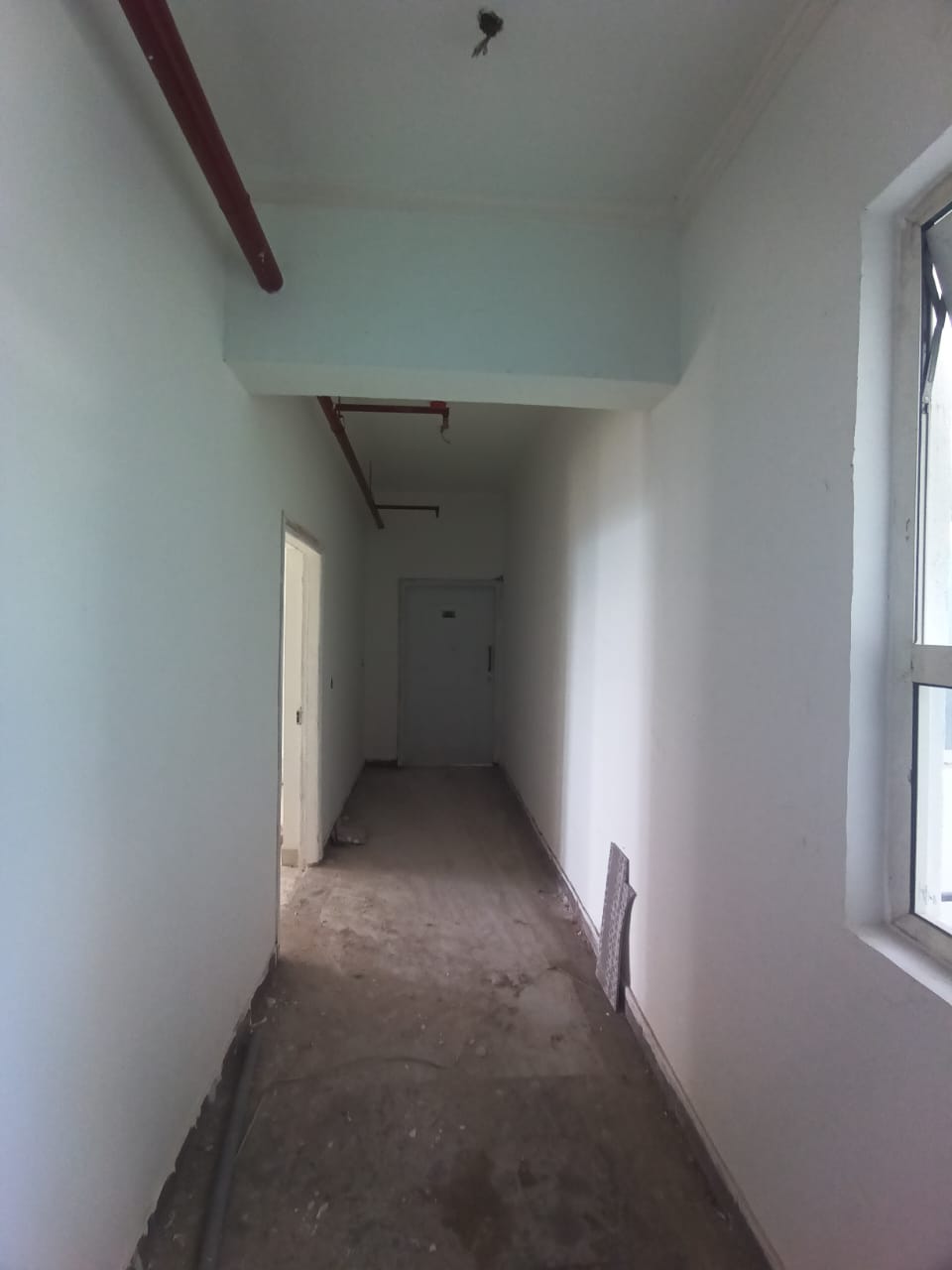

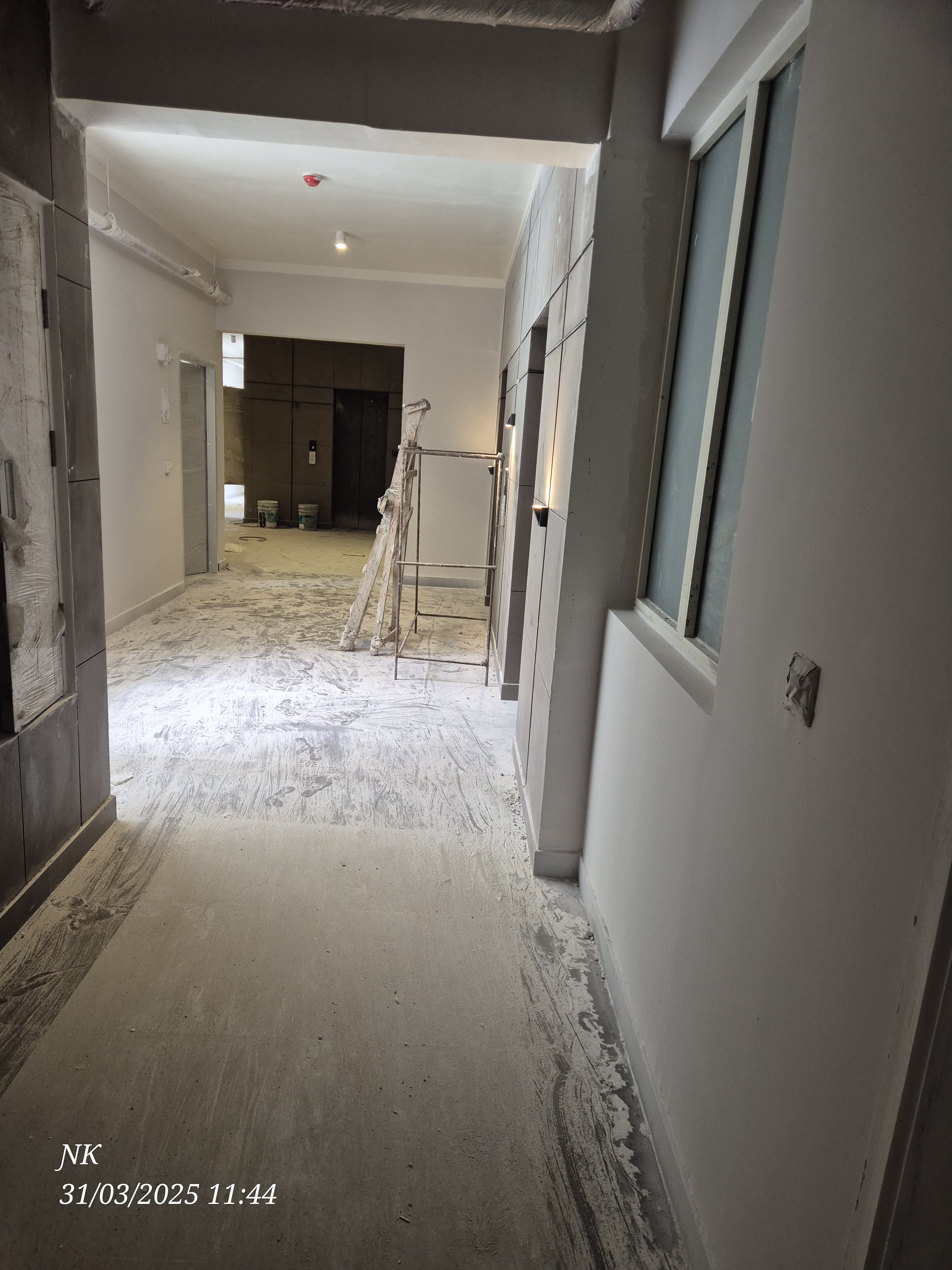

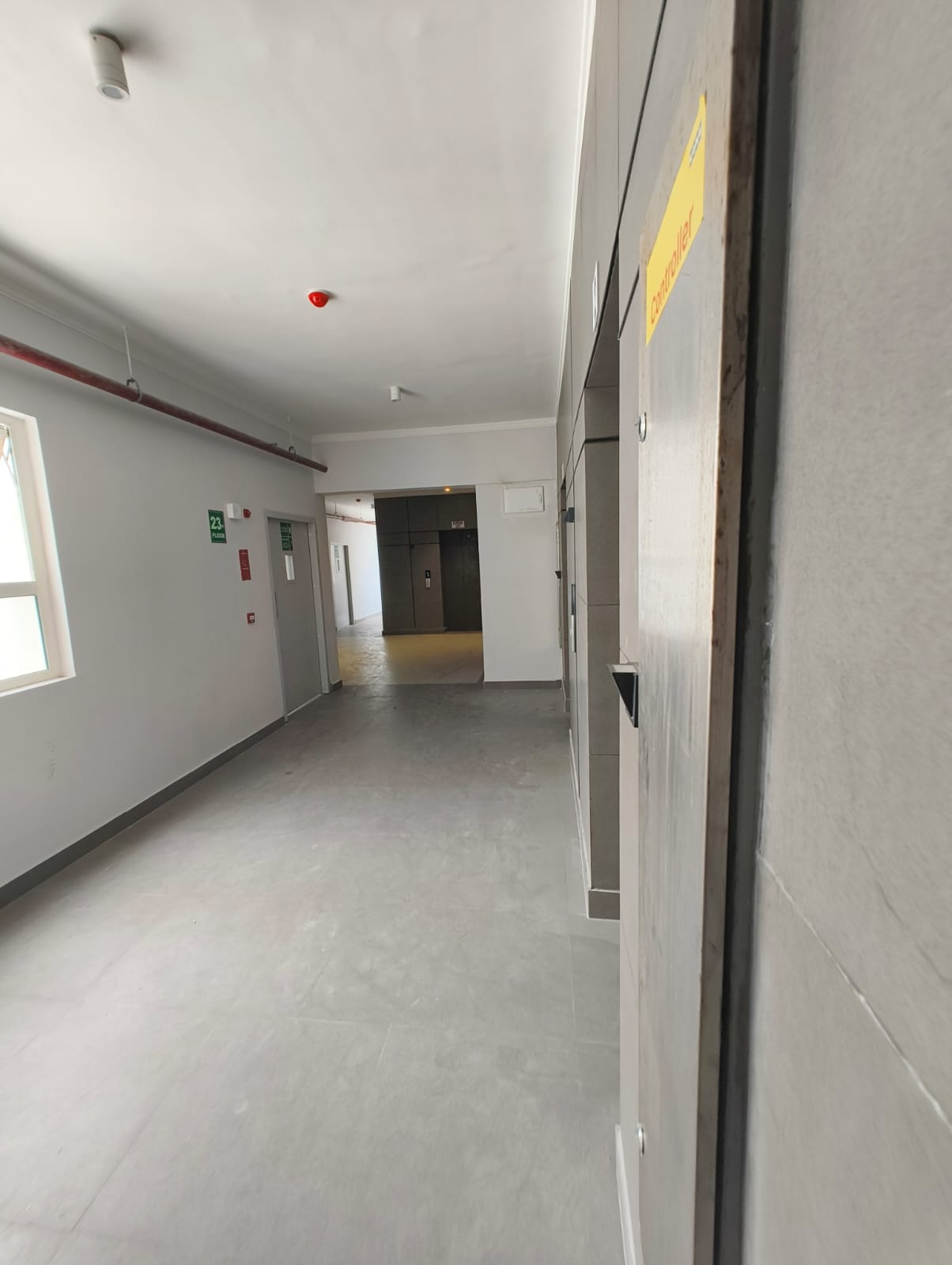

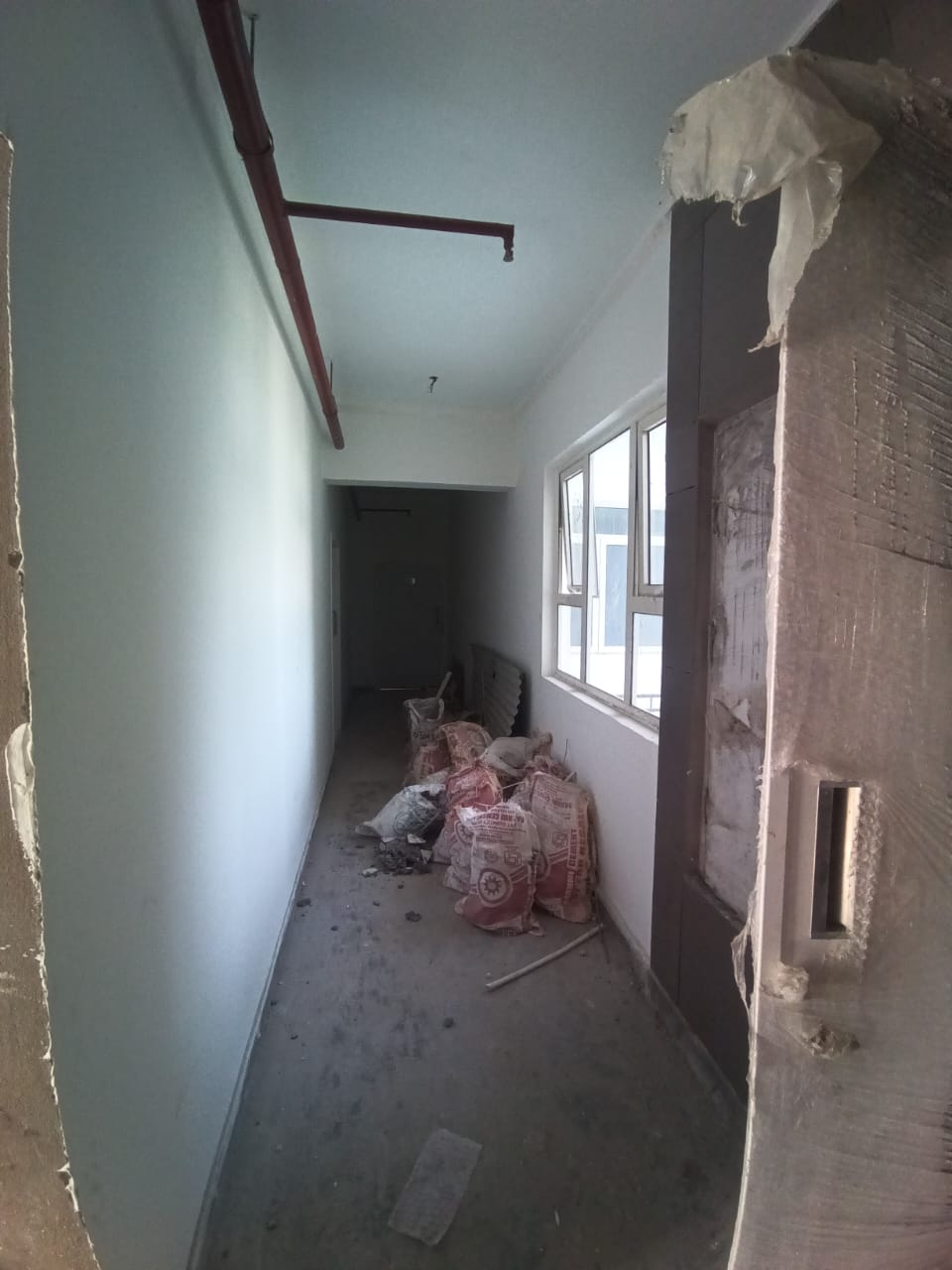

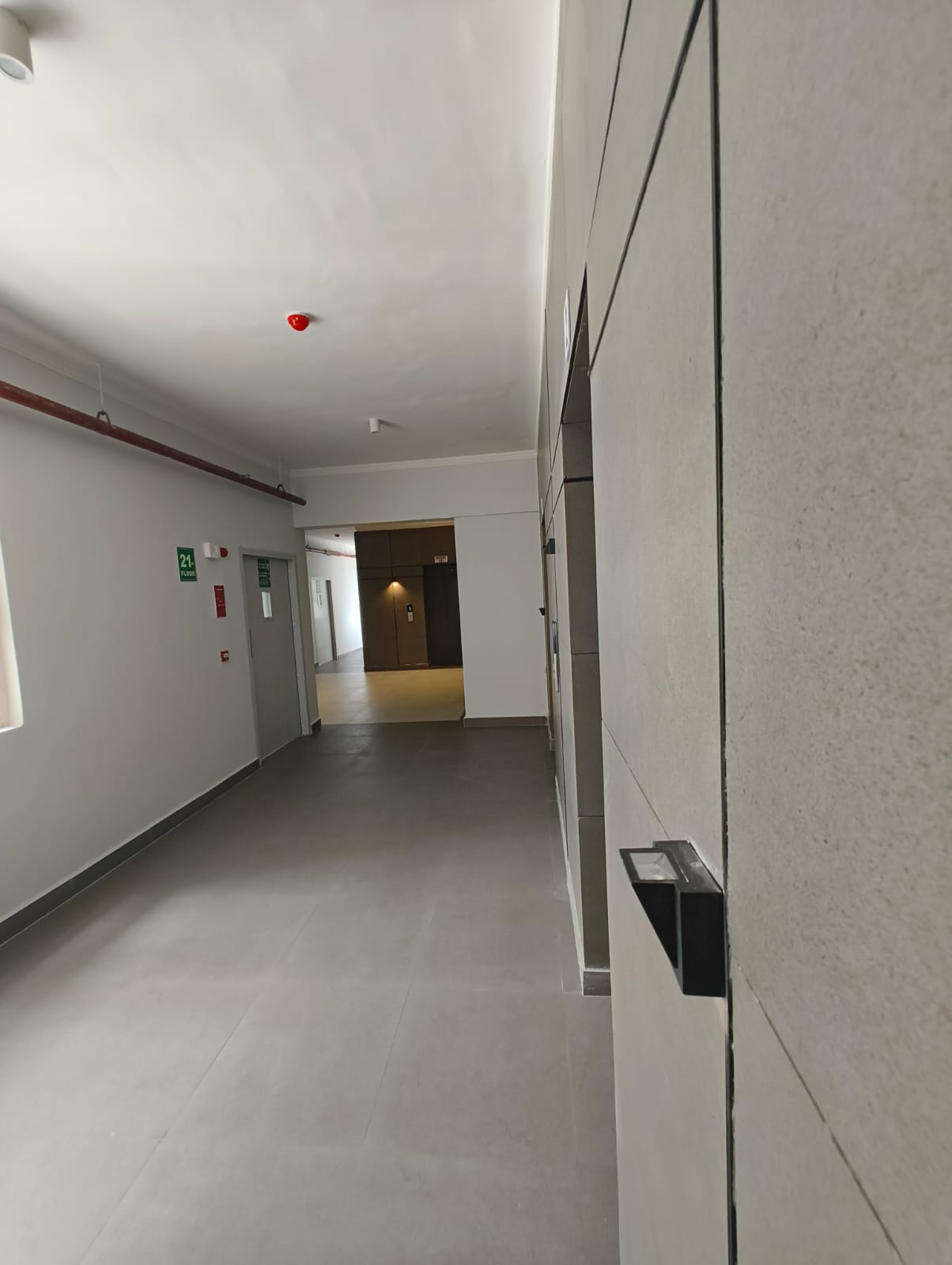

Tower-3 23 Under Construction

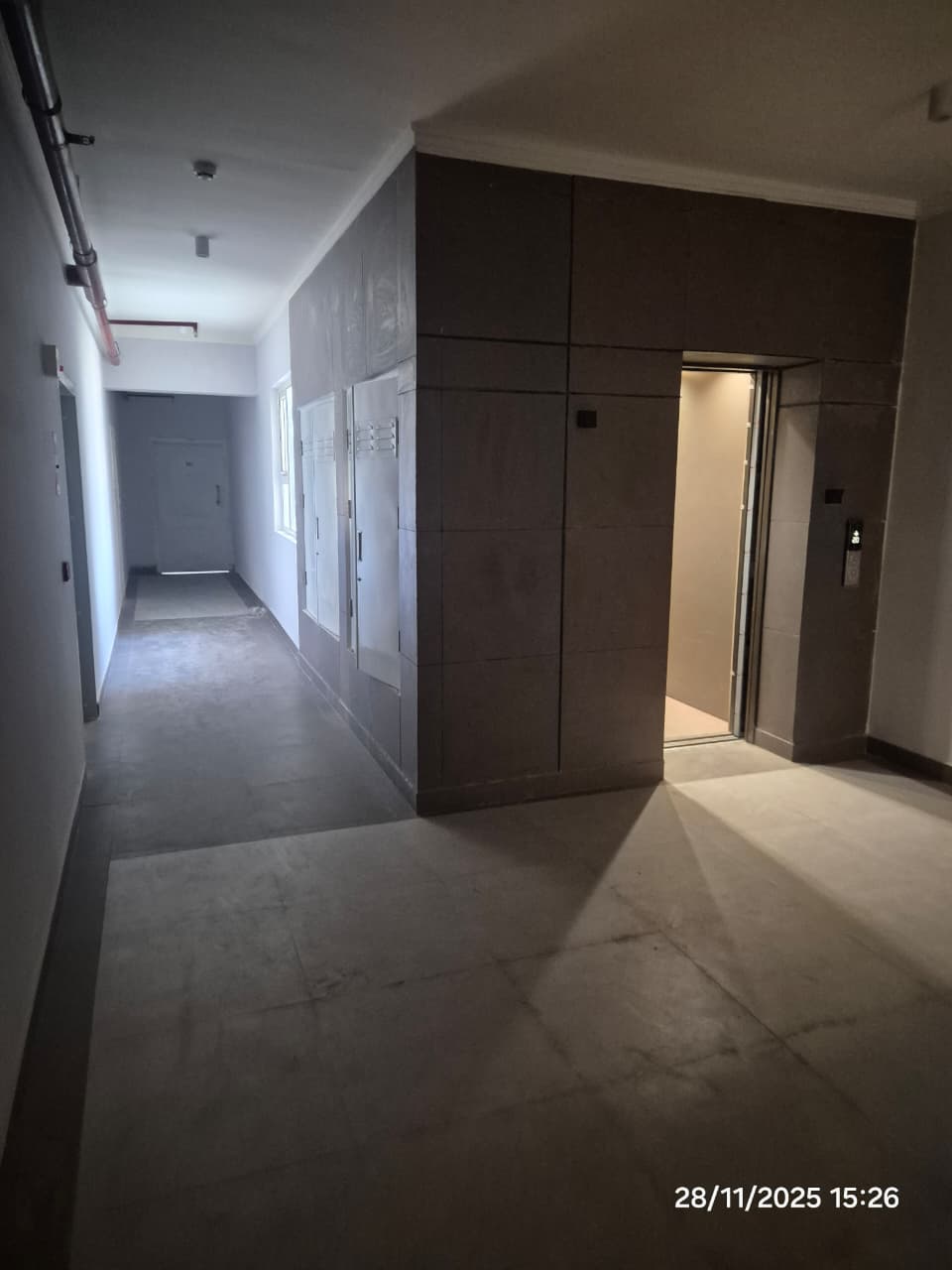

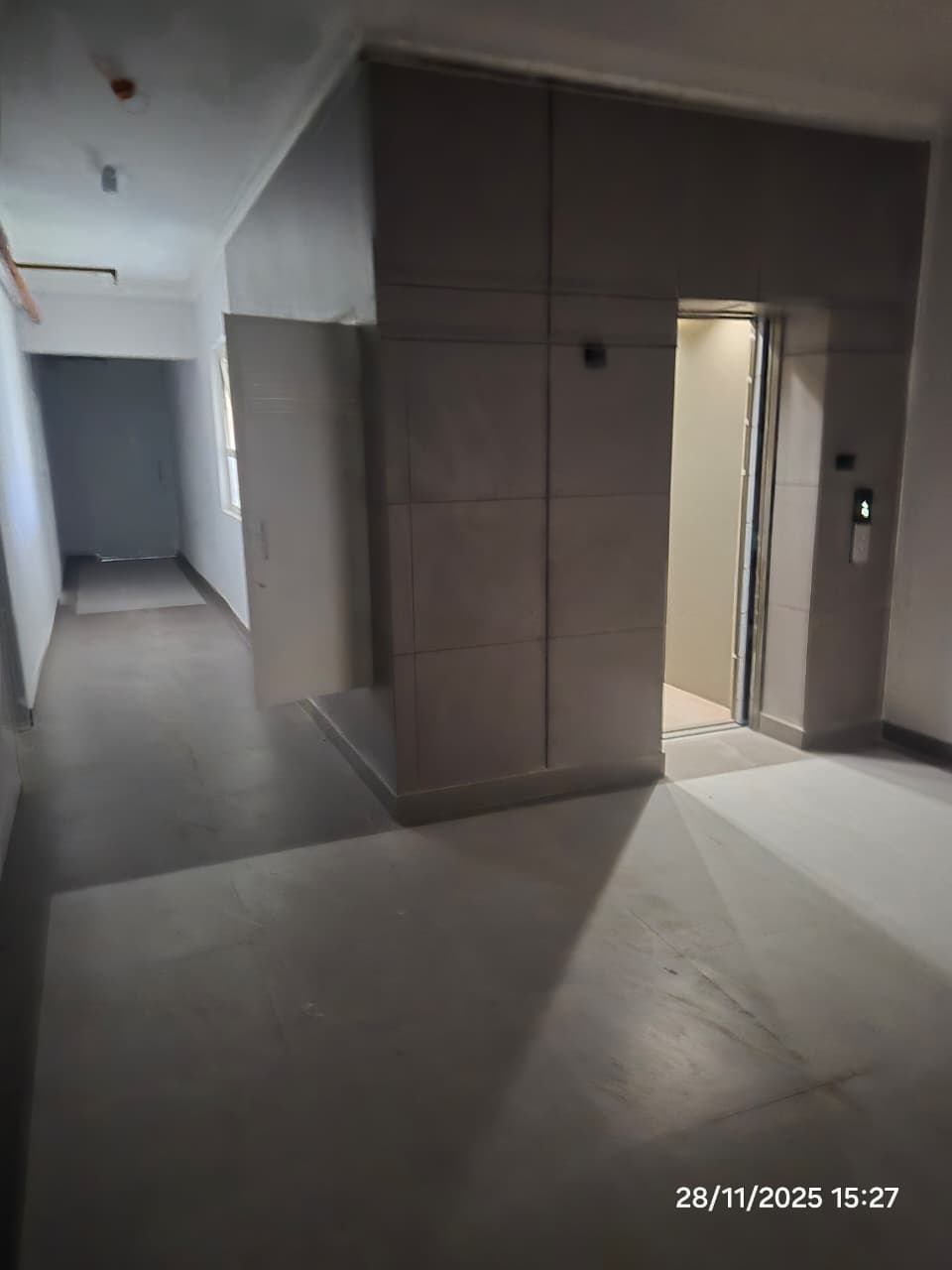

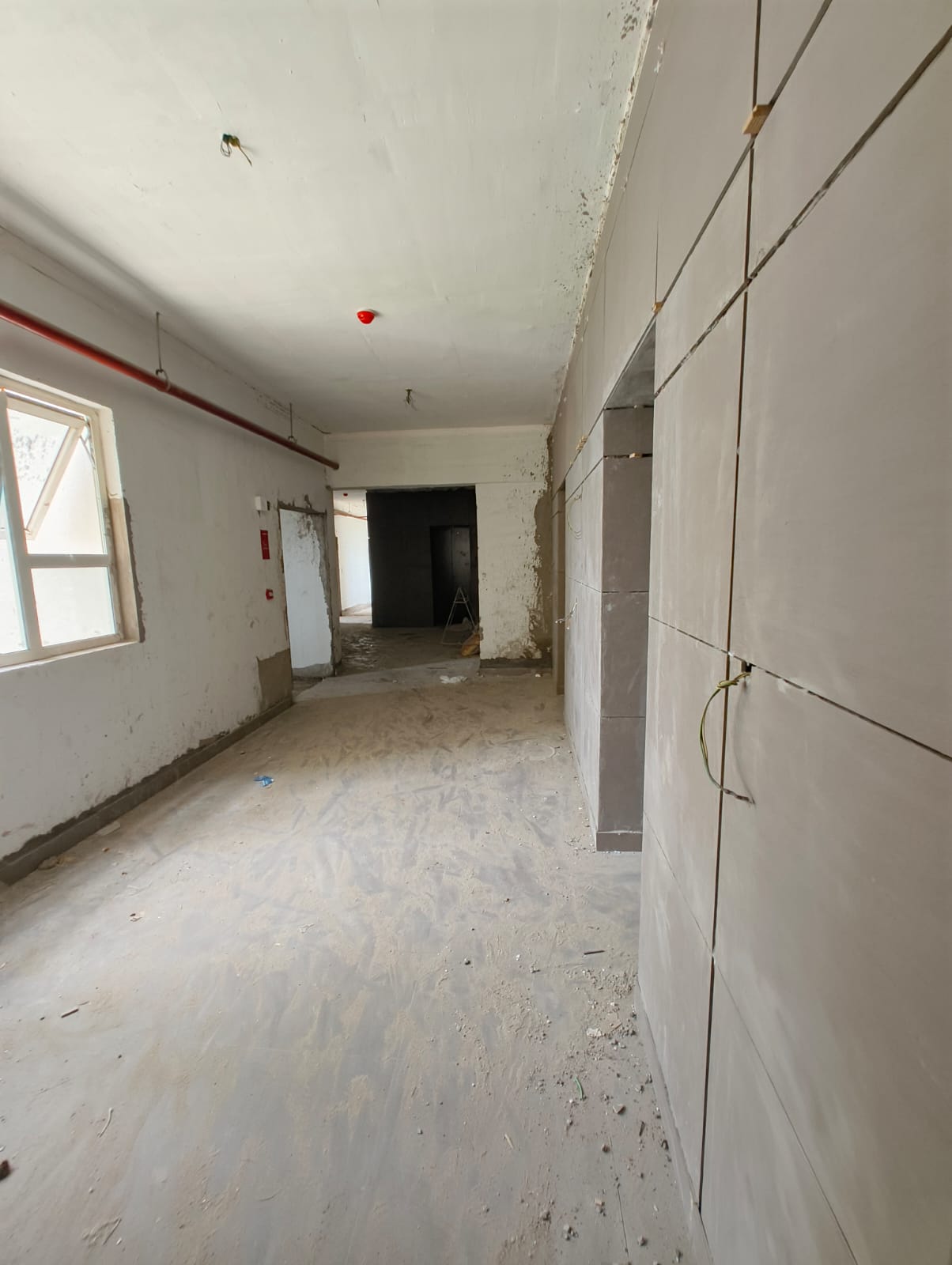

Tower-4 20 Under Construction

Status of Construction of Internal Infrastructure with photographs

Sl No. Title Download

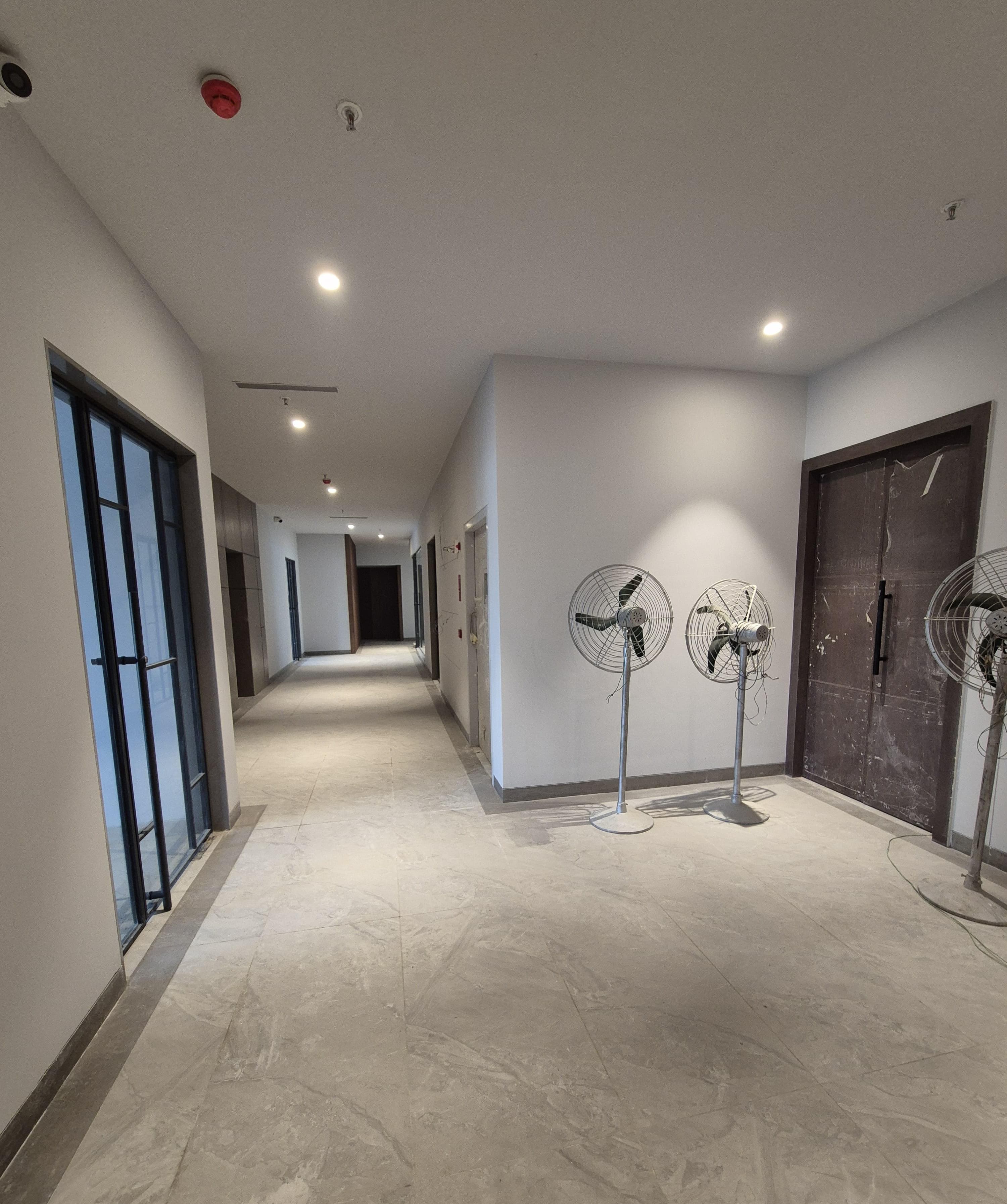

1 Tower-3, Lift Lobby

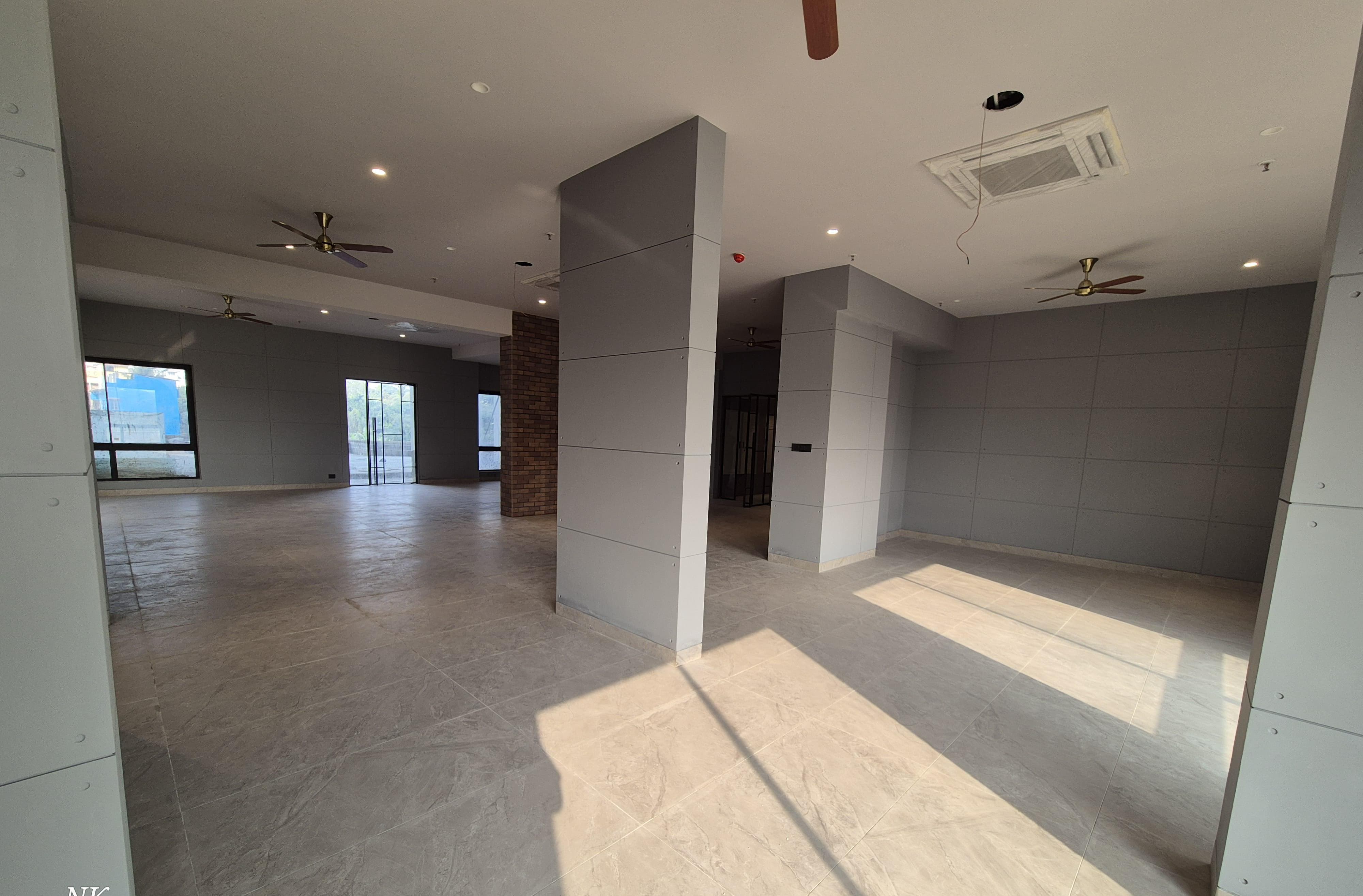

2 Tower-3 Ground Floor - FM Room

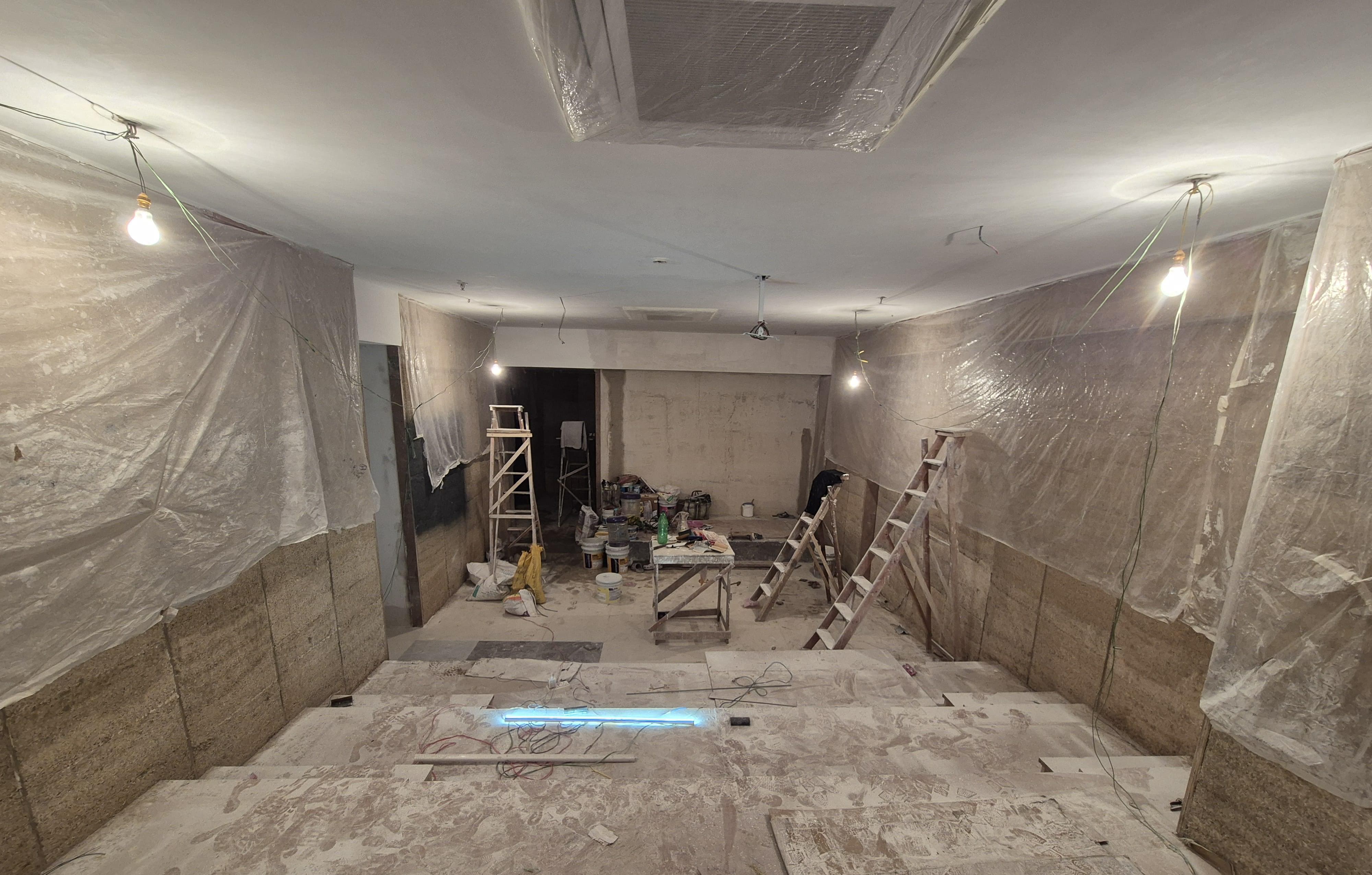

3 Tower-3 AV Room

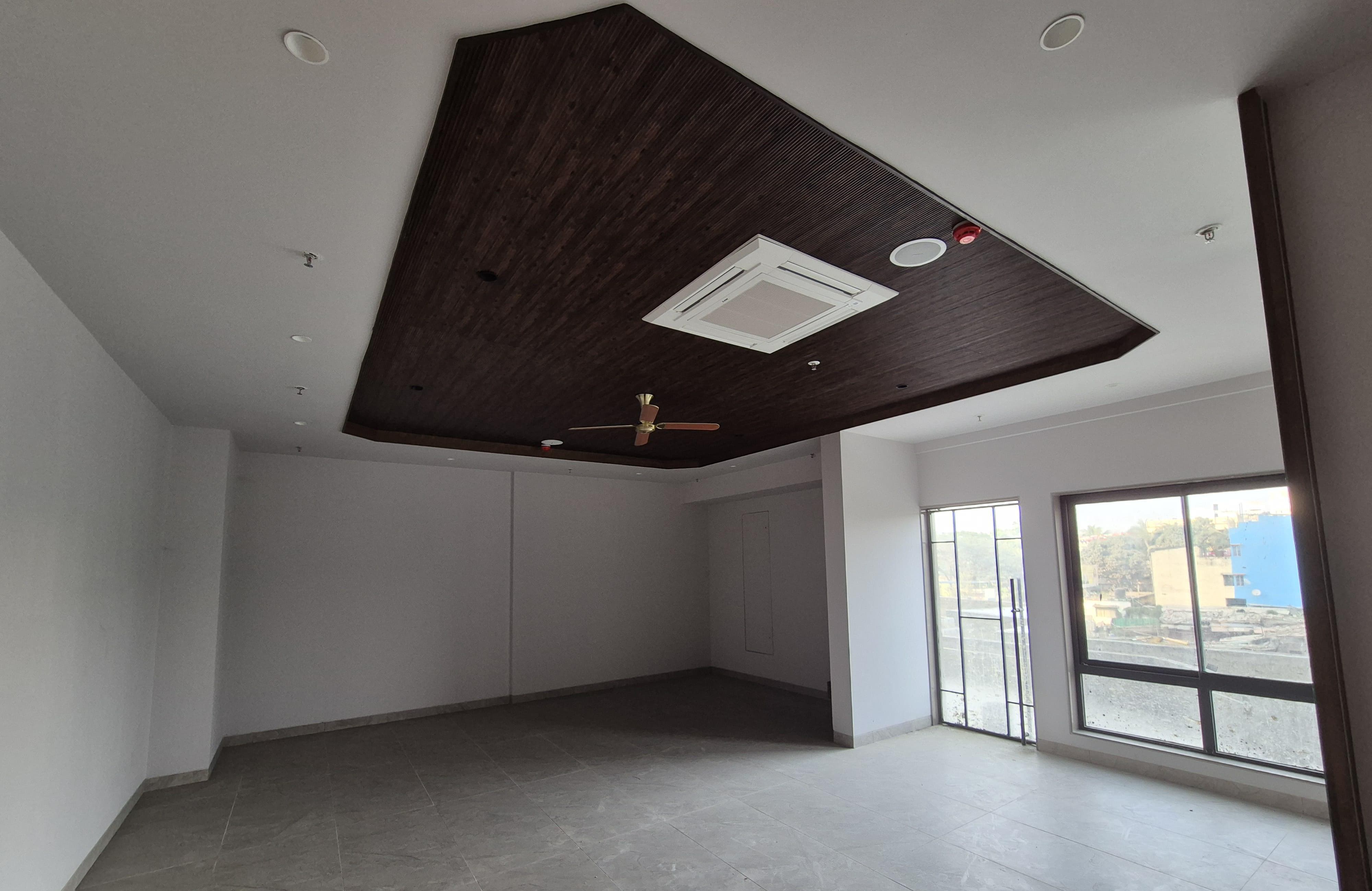

4 Tower-3 1st Floor Yoga Room

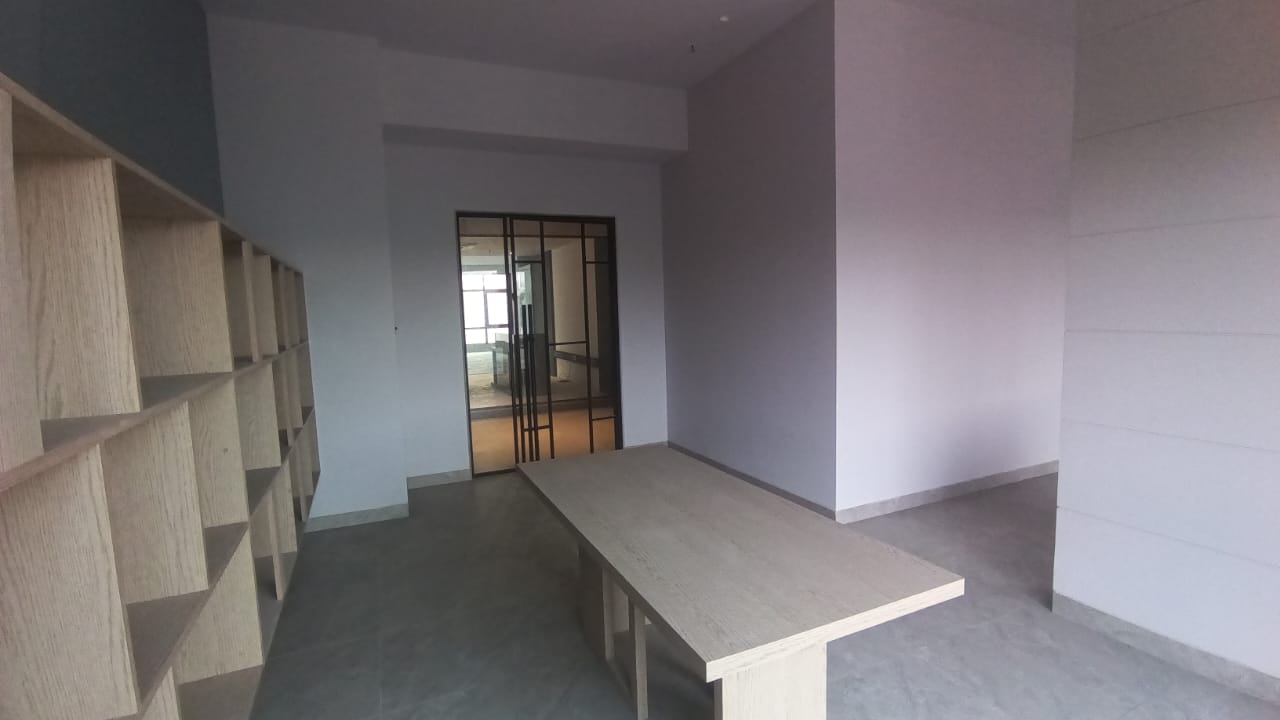

5 Tower-3 1st Floor Library

Status of Construction of Common Areas with photographs

Sl No. Construction Status Description Download
1 Under Construction Tower-3, First Floor AV Room

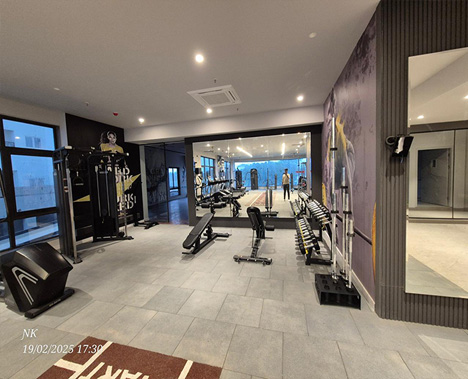

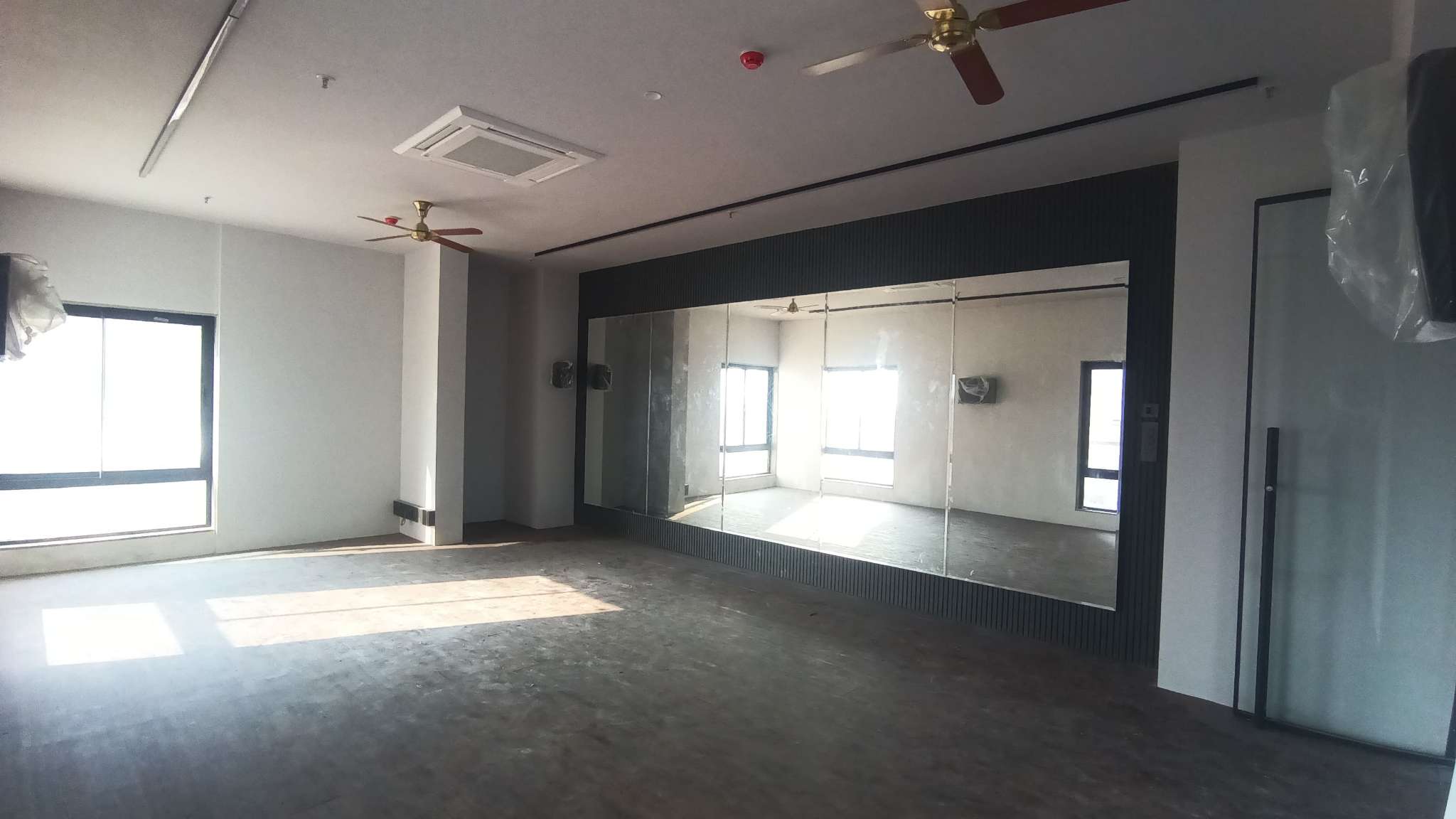

2 Under Construction Tower-3, 1st Floor GYM
3 Under Construction Tower-3, 1st Floor Lift Lobby

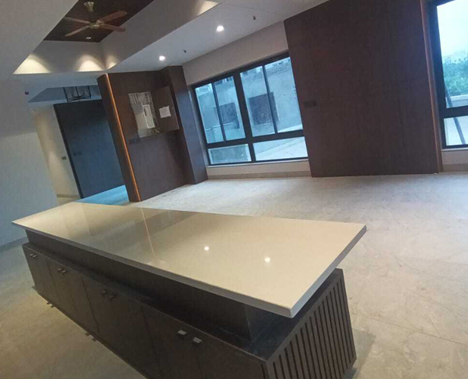

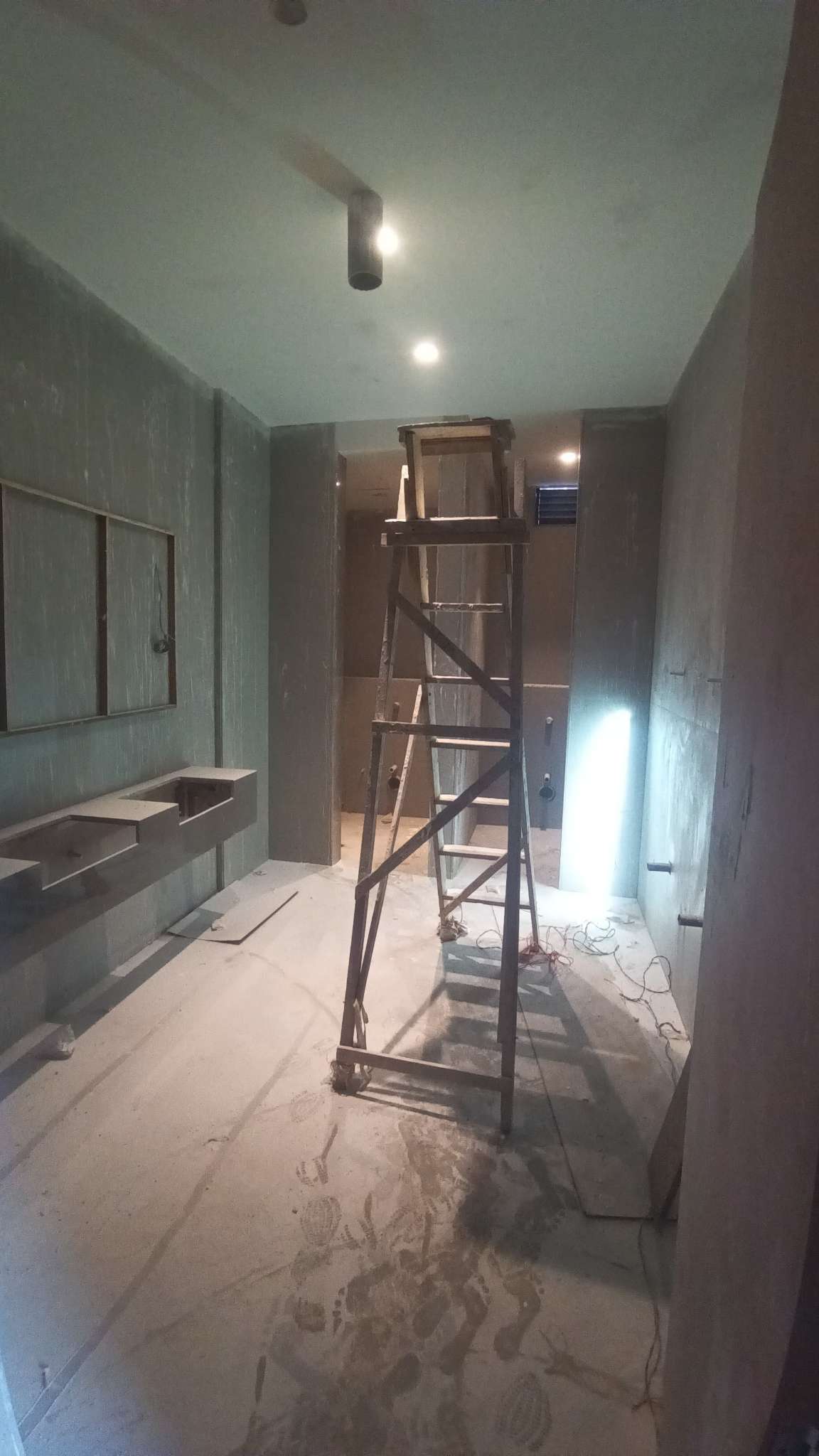

4 Under Construction Tower-3, Ground floor Community Hall

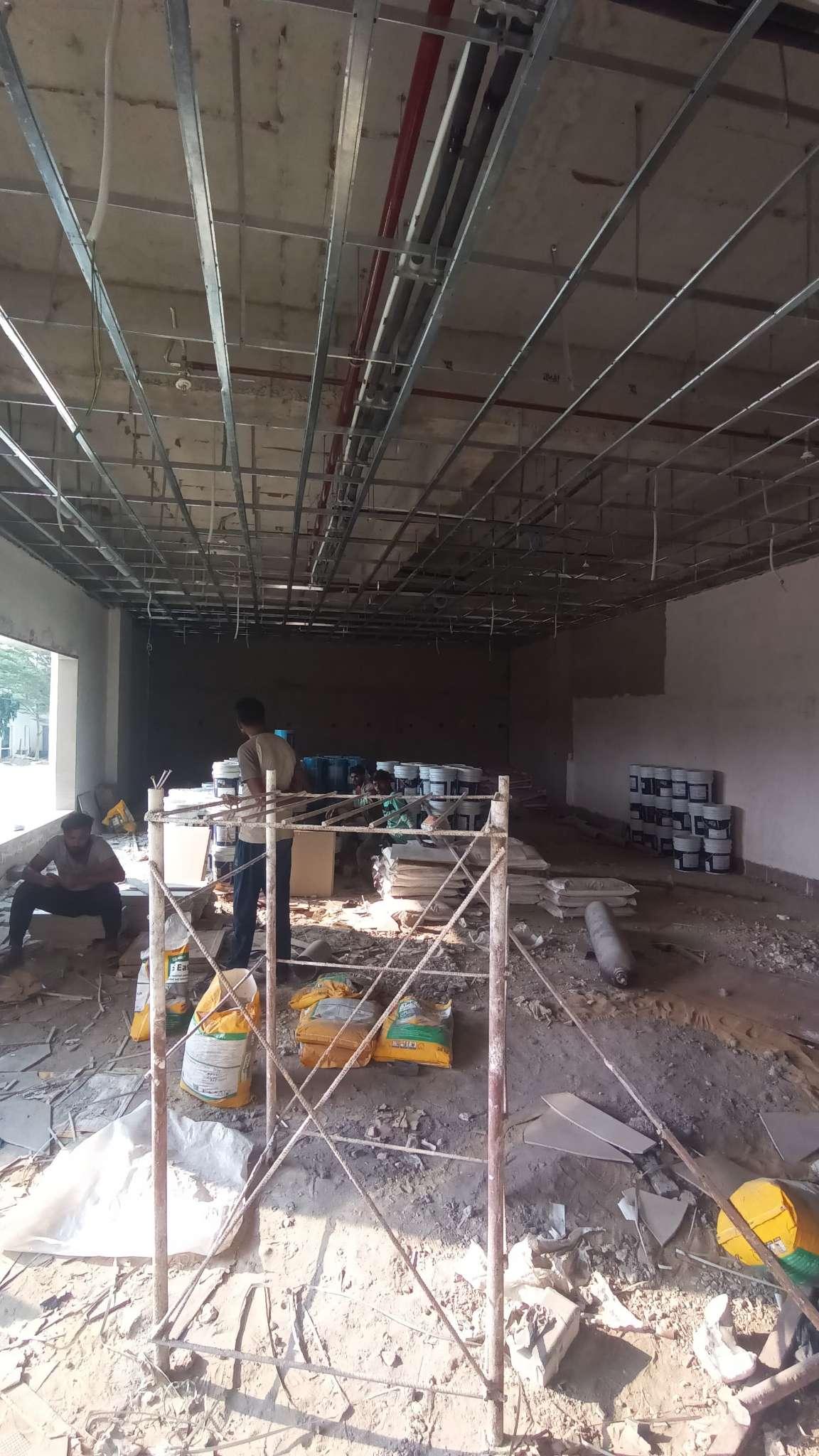

5 Under Construction Tower-4 Ground Floor Kids Room

Approval for NOC

Approved Document Approval Applied Approval Expected Approval Received Modifications Download
Environmental Clearance 28-12-2022 07-07-2023 07-07-2023 Proposed Expansion
Height clearance from Airport Authority of India (if any) 06-01-2022 25-05-2022 25-05-2022 Revalidation
Consent to Establish and Operate 28-07-2023 28-08-2023 28-08-2023 Expansion CTE
Permission from Water and Sewerage department 11-10-2017 22-11-2017 22-11-2017 SWID Permission - 004613
Fire NOC 21-04-2018 21-04-2018 21-04-2018 Fire Safety and Recomendation
